- Before
- Knows the commission has ruled on the issue before. But finding the page in an old order means two days in docket PDFs.
- Now
- Asks the question in plain words and opens each decision at the page and paragraph. The commission's own orders are marked first. Keeps the answer and drafts the position.
An ice storm recovery filing and the eight decisions that shaped its position
Early this year an ice storm cut power to 412,000 of the utility's customers. Restoration cost $412.6M, and $61.3M of that was mutual-assistance crews from other utilities. The utility must file for recovery with its state commission. Here is one morning, 32 days before the filing is due, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0132 days to file
One question, scoped to the filing

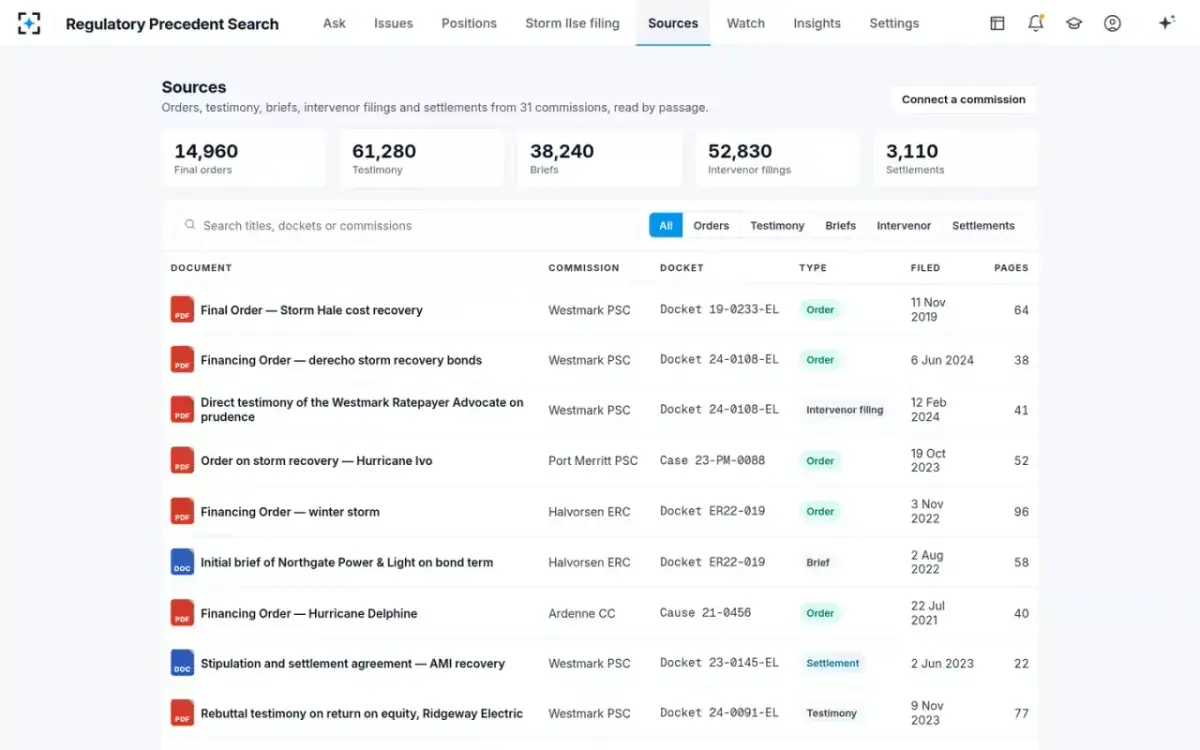

Senior regulatory counselCounsel asks in plain words: “How have regulators treated storm cost recovery?” The scope comes from the storm filing. It covers major-storm restoration cost at the utility's own commission plus 6 peer commissions. It includes decisions since 2017 on balances over $40M, and only final orders and approved settlements. Beside the answer, the agents' run is shown step by step. They searched 170,420 documents from 31 commissions and found 2,318 passages on storm cost. They kept 41 final orders and settlements, 8 of them in the peer set.
Scope: storm cost, own commission plus 6 peers, final orders and settlements only.
- 0238 seconds later

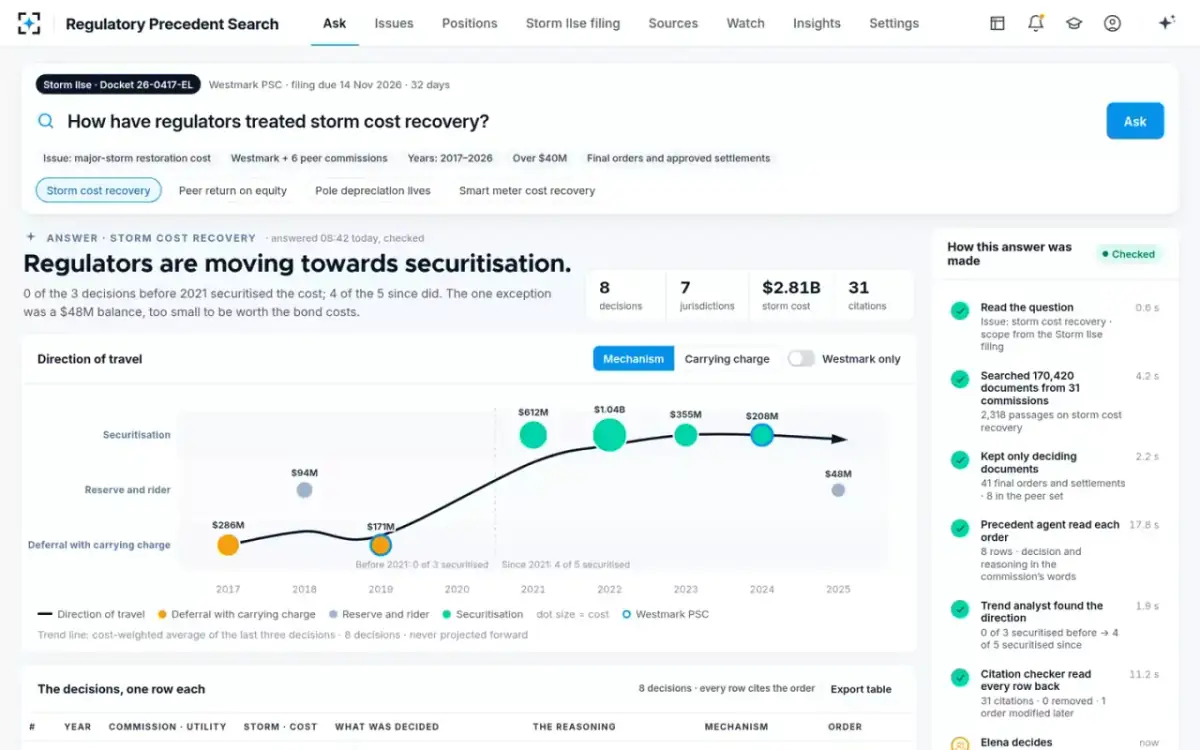

The direction of travel, with the count behind it
Trend analystThe answer leads with a verdict: regulators are moving toward securitization, paying for the storm with bonds that customers repay over time. None of the 3 decisions before 2021 securitized the cost, and 4 of the 5 since did. The chart plots each decision in three lanes: deferral with a carrying charge, reserve and rider, and securitization. Dot size shows storm cost, $2.81B across 8 decisions in 7 jurisdictions. A switch shows the carrying charge customers pay instead. It was a 7.4% full return in 2017 and 4.1% cost of debt in the commission's own 2019 order. Bond rates since 2021 have been 2.1% to 5.1%.
“The one exception was a $48M balance, too small to be worth the bond costs.” Trend line: not projected forward.
- 03The table

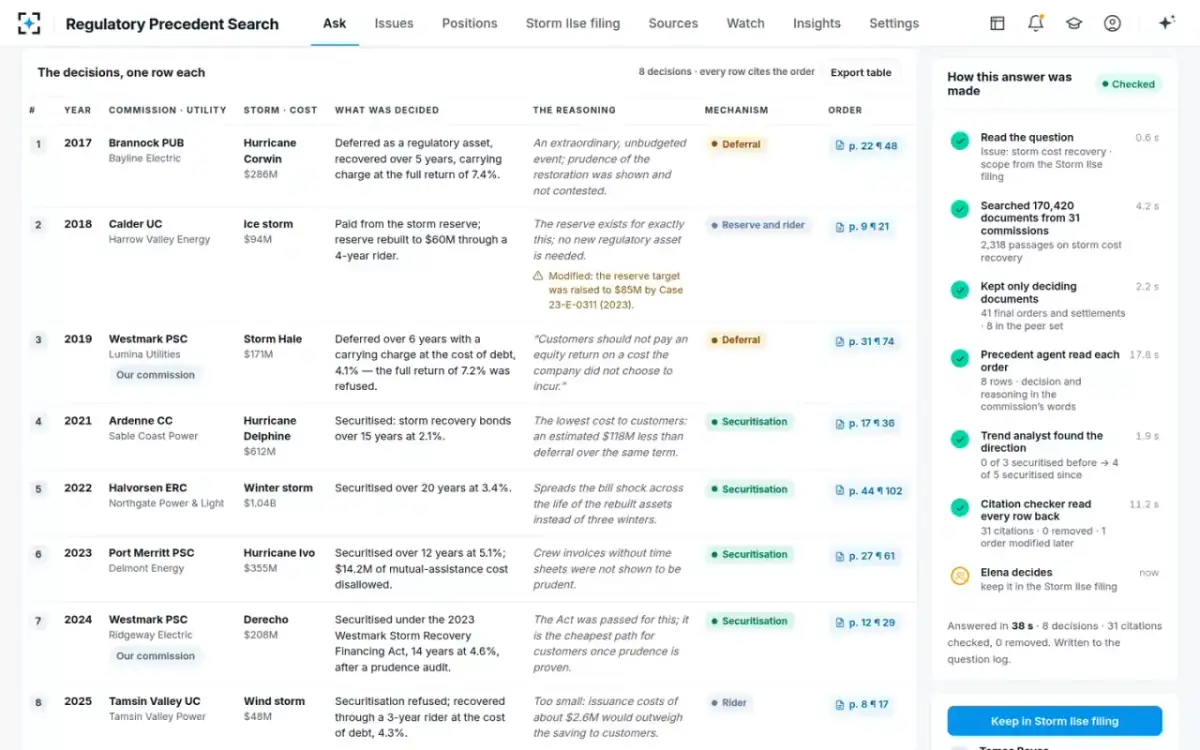

Eight decisions, one row each, in the commission's words
Precedent agentEach row gives the year, commission and utility, the storm and its cost, and what was decided. It also gives the reasoning and the mechanism, with a link to the order at the page and paragraph. In row 6, a peer commission securitized a hurricane balance over 12 years at 5.1%. It also disallowed $14.2M of mutual-assistance cost. Row 2 carries a flag. A later order raised another peer's storm reserve target to $85M.
Citation checker: “31 citations · 0 removed · 1 order modified later”
- 04One click

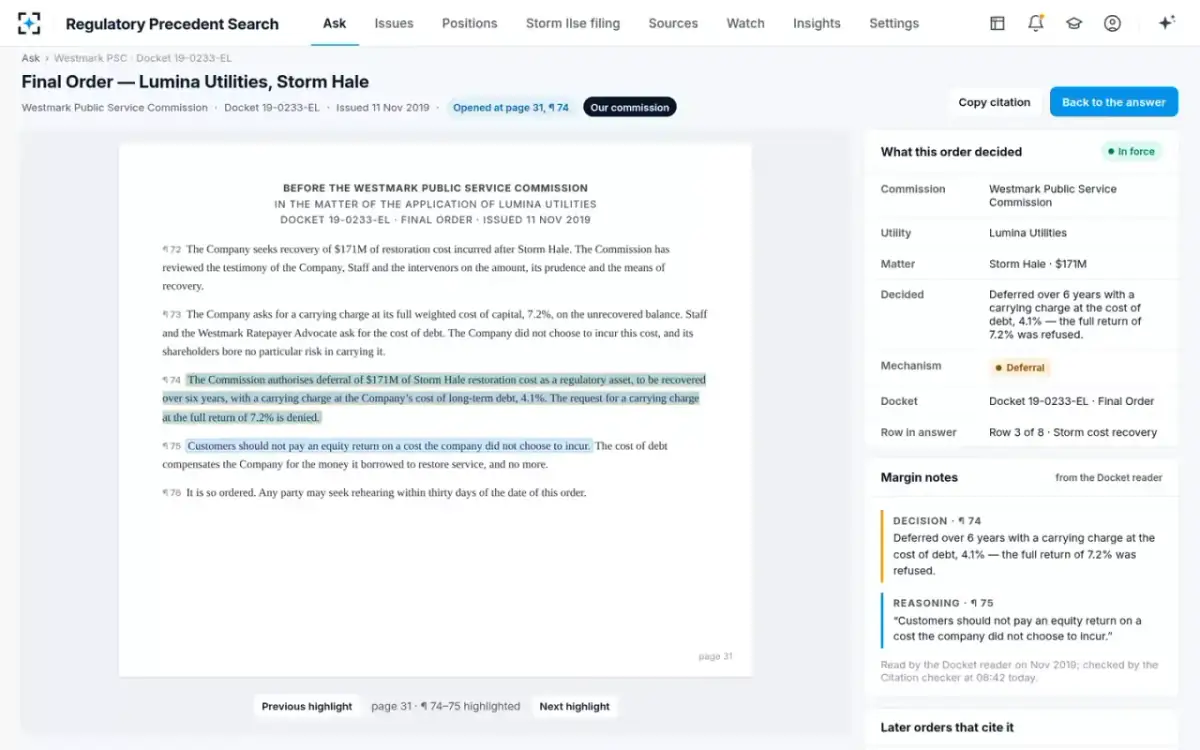

Row 3 opens the commission's own 2019 order at ¶ 74
Senior regulatory counselCounsel opens the utility's own earlier storm order at page 31, with the deciding paragraphs highlighted. The commission deferred $171M over six years at the cost of long-term debt, 4.1%. It denied the full return of 7.2%. The margin notes repeat the decision and the reasoning. The order shows as still in force, and a copy-citation button gives the full cite.
¶ 75: “Customers should not pay an equity return on a cost the company did not choose to incur.”
- 05What it means
Three positions for the storm filing, each from a row
Precedent agentFirst, lead with securitization under the state's 2023 storm financing act. The same commission financed another utility's $208M balance from a derecho, a fast-moving line of windstorms, this way in 2024 (row 7). It did so after a prudence audit, a check that the costs were reasonable. Second, do not ask for a full return on the interim balance. Ask for the cost of debt until the bonds are issued (row 3). Third, attach time sheets for all $61.3M of mutual-assistance crews (row 6).
From row 3: “Our own 2019 order refused it and allowed the cost of debt, 4.1%. Ask for the cost of debt until the bonds are issued.”
- 06Before the intervenors file
Who argued what on storm cost, and how often it won
Position mapperArguments from 61 filings in 8 storm dockets are grouped by point. The consumer advocate asked for a prudence audit before any financing order, and that was adopted 3 of 5 times. Staff argued that replaced equipment belongs in rate base, the investment the utility earns a return on, instead of the storm balance. That won 4 of 4. Utilities argued for a full return on any carried balance, and won 1 of 3. Each argument can be marked “Expect in this docket”.
“8 arguments from 61 filings in 8 storm dockets · adopted means the order adopts it in words”
- 0709:14

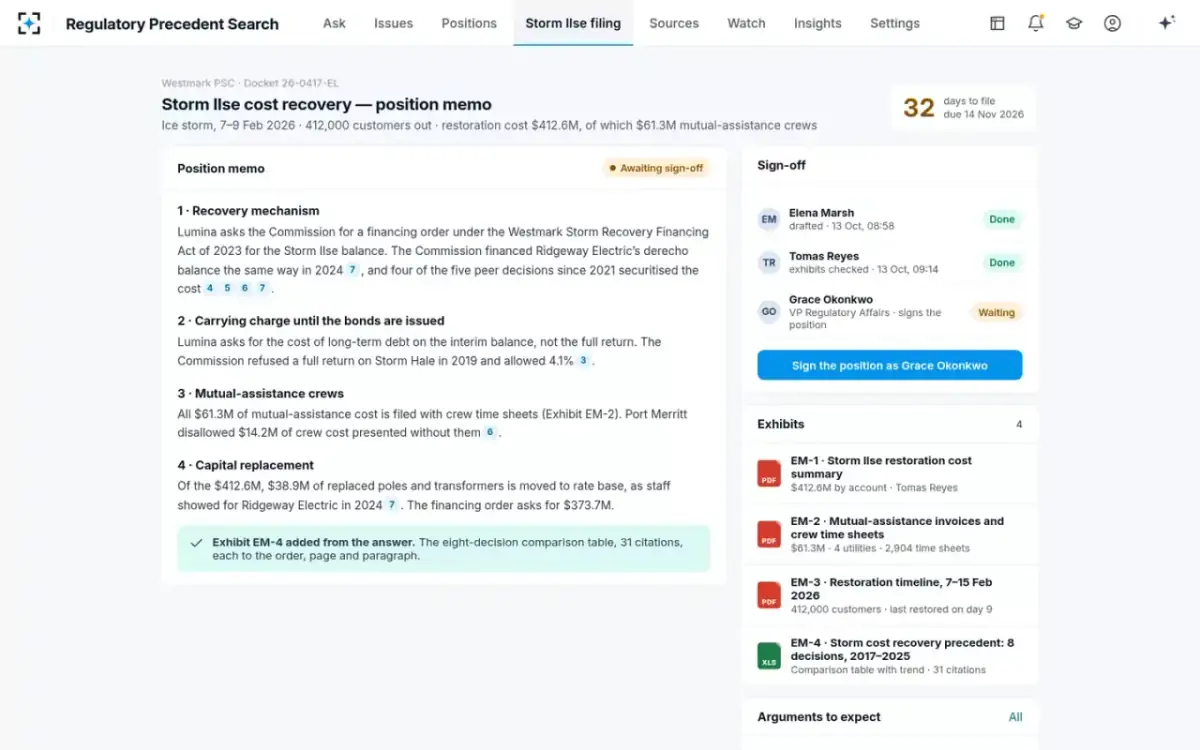

The position memo, cited sentence by sentence
Regulatory analystThe memo states four positions. The first is a financing order under the state storm recovery financing act. The second is the cost of long-term debt until the bonds are issued. The third files all $61.3M of crew cost with time sheets as an exhibit. The fourth moves $38.9M of replaced poles and transformers to rate base, so the financing order asks for $373.7M. Counsel drafted it at 08:58 and the analyst checked the exhibits at 09:14. The precedent exhibit, 8 decisions with 31 citations, sits beside the other three.
“Exhibit added from the answer. The eight-decision comparison table, 31 citations, each to the order, page and paragraph.”
- 08Sign-off

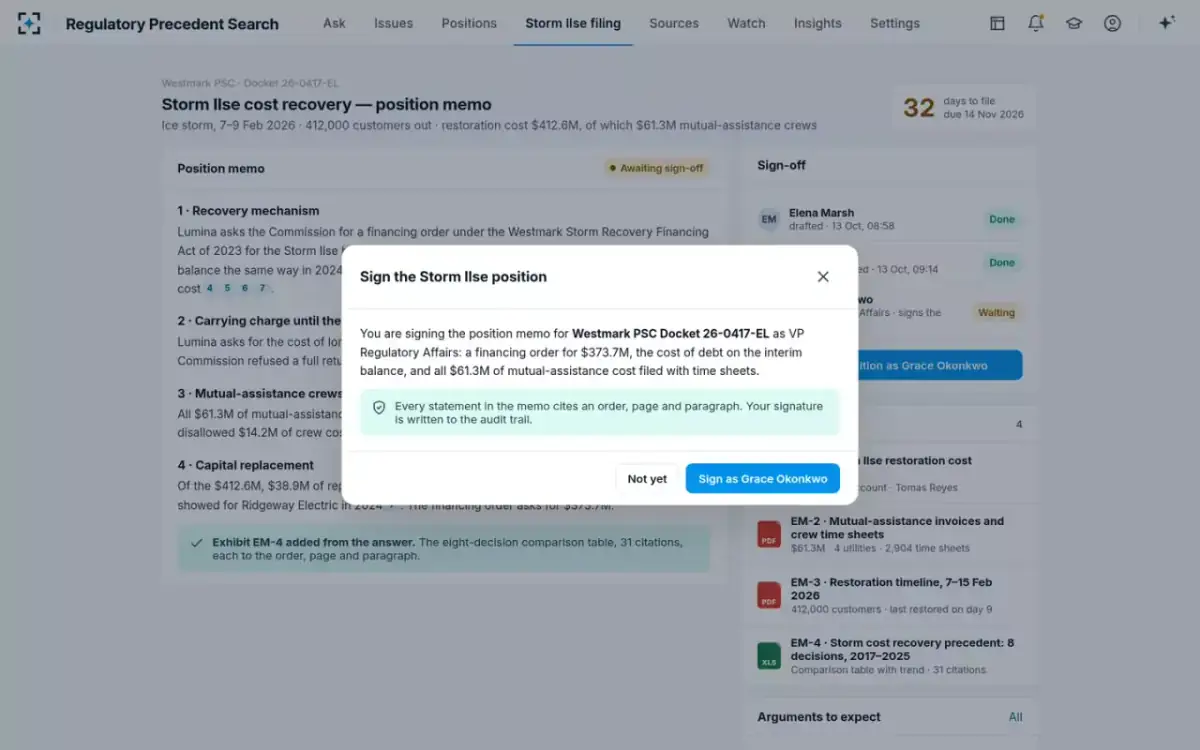

The VP signs the position that goes into the filing
VP of regulatory affairsThe VP opens the sign-off for the storm docket. It asks for a financing order for $373.7M and the cost of debt on the interim balance. All $61.3M of mutual-assistance cost is filed with time sheets. When the VP signs, the signature is written to the audit trail.
“Each statement in the memo cites an order, page and paragraph.”
- 09Overnight
The day a peer commission rules again, the team knows
Docket watchDocket watch runs over each night’s new filings. In the morning it shows a new peer order securitizing another utility's storm balance over 15 years. Its note reads “added to the peer set, the trend would read 5 of the last 6”. It also shows a rulemaking at the utility's own commission on storm reserve levels. Comments are due six days after the storm filing.
Each match says why it matched. A document the watcher may not open is not shown.
