- Before

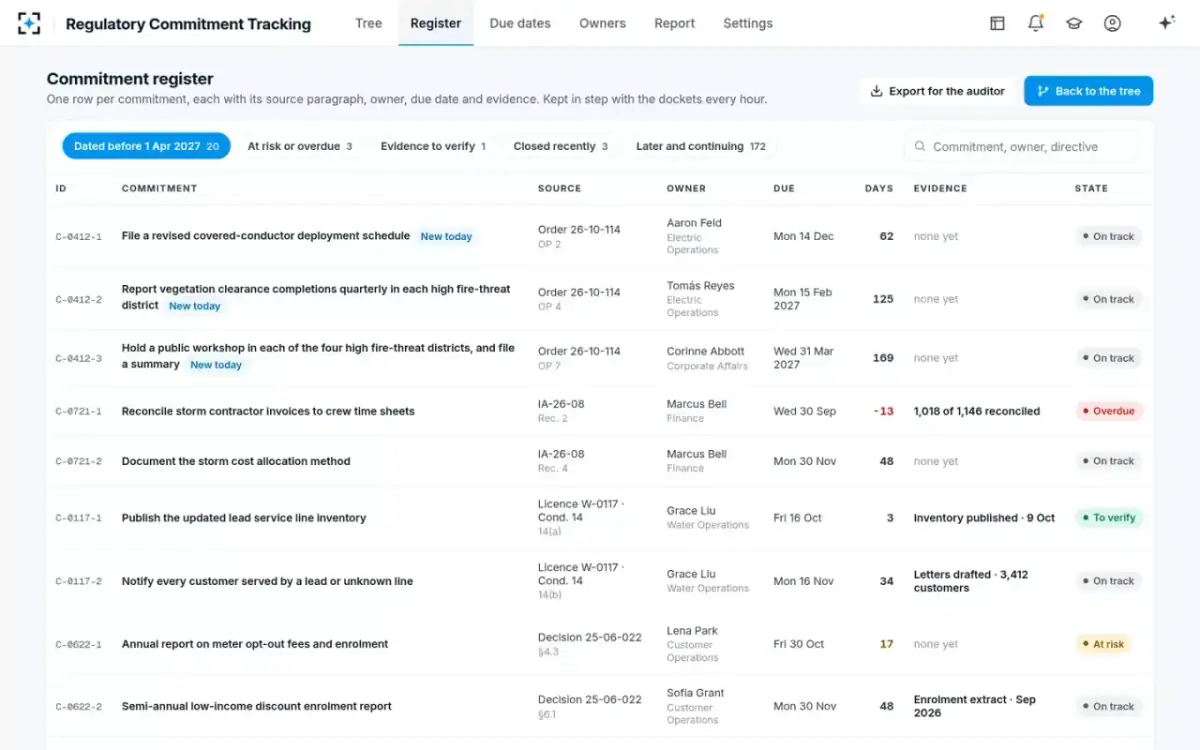

- Owns 186 open commitments from 41 directives. Reads and retypes each order by hand, though only three sentences in a 38-page order bind the utility.
- Now
- Gets the binding paragraphs quoted, with an owner and a date proposed for each. Accepts them, checks the evidence and signs each close.
A wildfire plan order and the three commitments it created
One Tuesday the state utilities commission approves the utility’s Wildfire Mitigation Plan update, with conditions. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

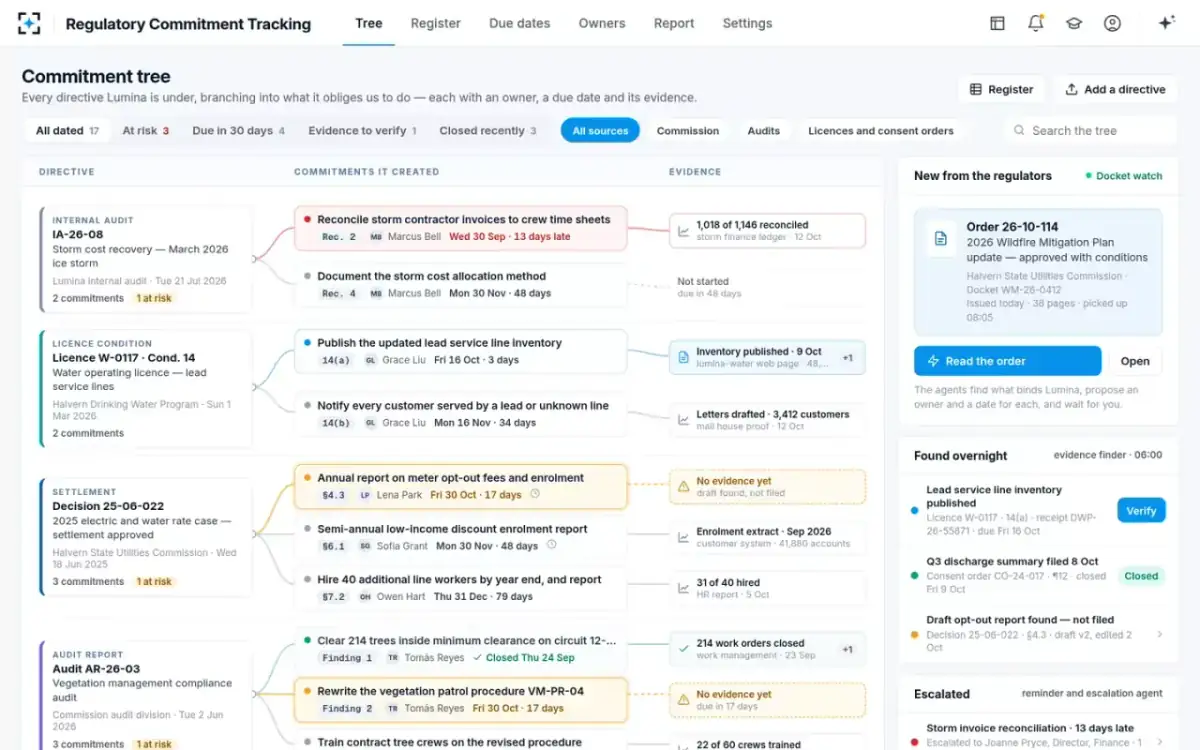

The day opens on the commitment tree
Regulatory compliance managerThe compliance manager owns the register, the list of 186 open commitments from 41 directives. The tree shows the 17 due before next April. Each directive branches into the commitments it created and the evidence for each. Three are at risk, and one of those is overdue. One has evidence waiting to be checked, and three closed recently.
“Every directive the utility is under, each branching into what it obliges us to do. Each one has an owner, a due date and its evidence.”
- 02Two amber, one red
What needs someone now
Reminder and escalation agentTwo commitments are due at the end of the month with no evidence, so they show amber. One is the annual report on meter opt-out fees under last year’s rate case settlement. The other is the rewrite of the vegetation patrol procedure, from a commission audit. The storm invoice reconciliation from an internal audit is 13 days late. So far 1,018 of its 1,146 invoices are reconciled, and it has already been escalated to the finance director.
“Amber and red ones need someone now.”
- 0308:05
A new order lands on the docket

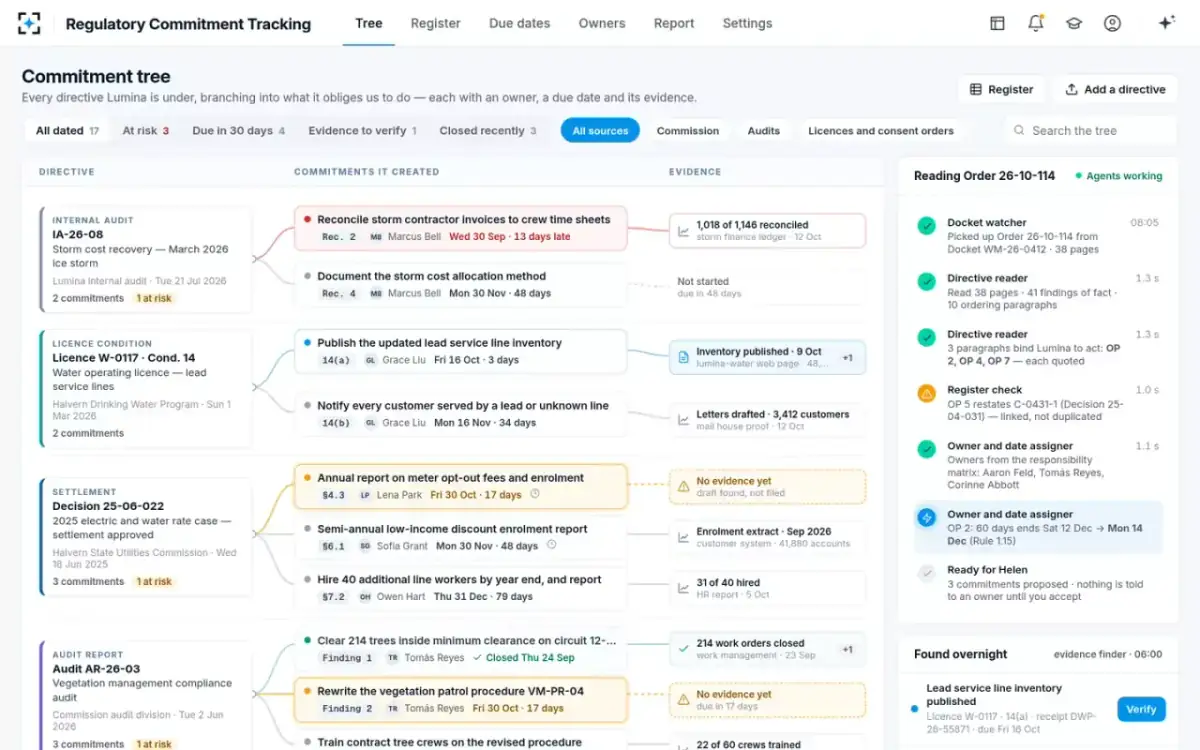

Docket watcherThe docket watcher picks up a new order from the wildfire plan docket. It is 38 pages long, issued and effective today. The compliance manager clicks Read the order. The agents work through it step by step in the right-hand panel. They find 41 findings of fact and 10 ordering paragraphs, the numbered paragraphs that carry the decision.
“The agents find what binds the utility and propose an owner and a date for each. Then they wait for you.”
- 04The order is read
Three paragraphs bind, each one quoted

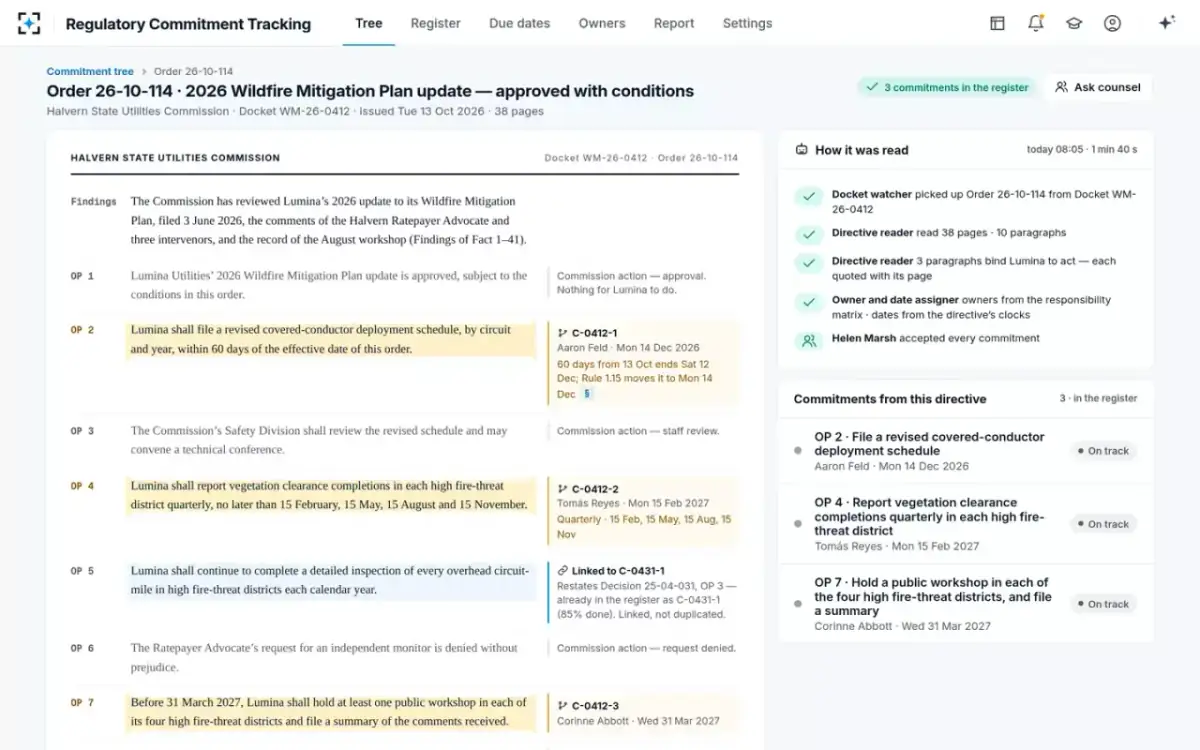

Directive readerThree ordering paragraphs, OP 2, OP 4 and OP 7, oblige the utility to act. They call for a revised covered-conductor deployment schedule and quarterly vegetation clearance reports in each high fire-threat district. They also call for a public workshop in each of the four districts. OP 1, 3, 6, 8, 9 and 10 are Commission actions or permissions. OP 5 restates the annual inspection already in the register from an earlier decision.
“OP 5 restates an existing commitment, so it is linked instead of added twice.”
- 051 min 40 s after pick-up
An owner from the matrix, a date from the order’s clock
Owner and date assignerOwners come from the responsibility matrix, the list of who owns which subject. Here they are the distribution asset strategy manager, the director of vegetation management and the community engagement manager. OP 2 gives 60 days, and day 60 falls on a Saturday. Commission Rule 1.15 moves that date to the Monday. The agents’ notes on the order explain why each other paragraph is not a commitment.
“60 days from today ends on a Saturday, so Rule 1.15 moves it to the Monday”

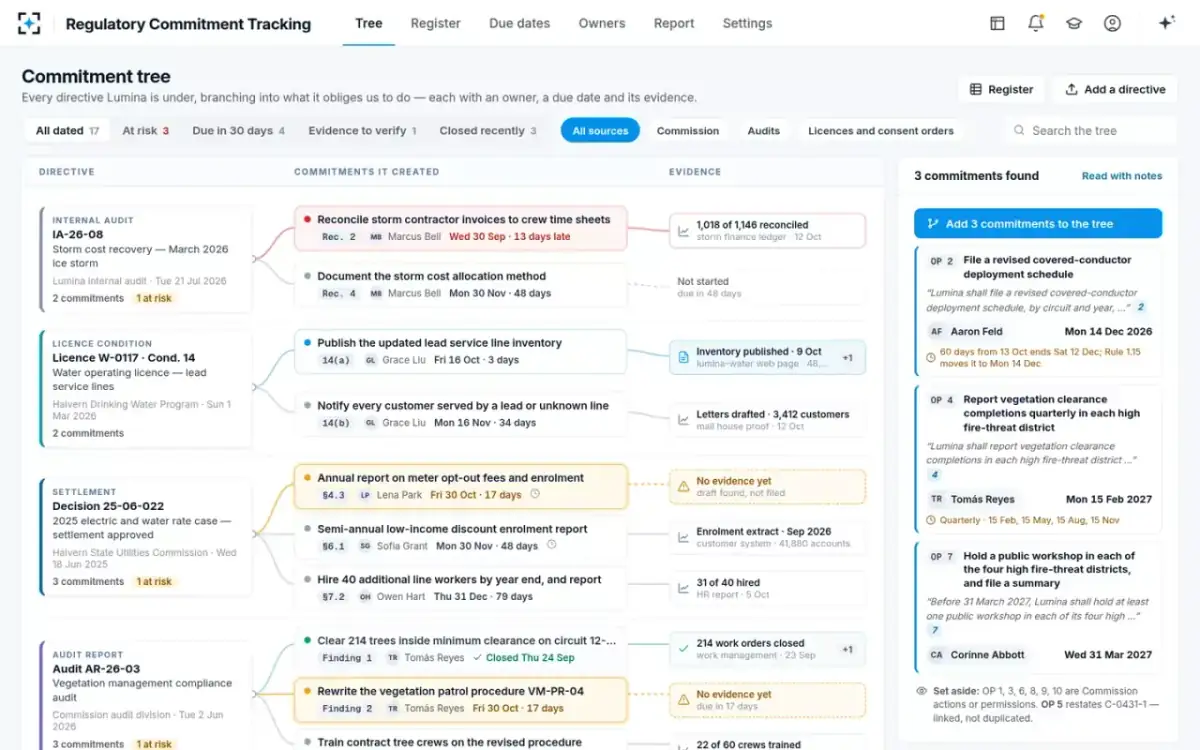

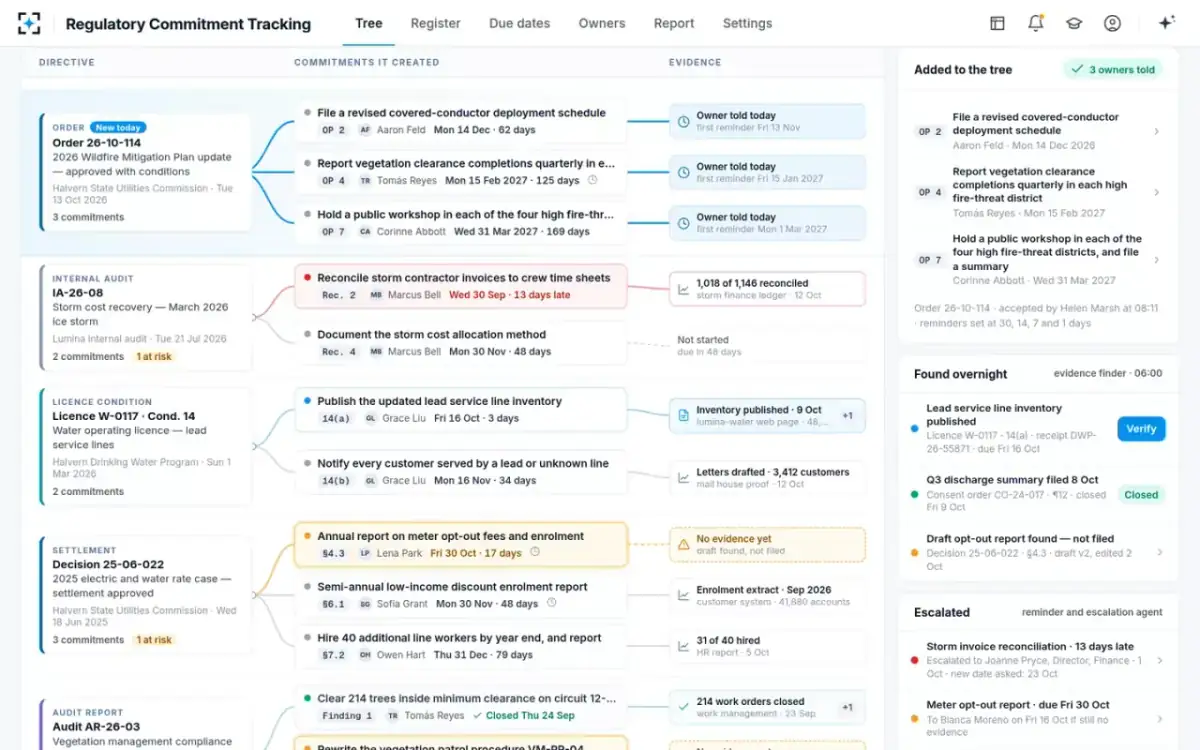

- 06One click
Accepted, and three branches grow on the tree
Regulatory compliance managerThe order joins the tree as New today, with its three commitments. First comes the covered-conductor schedule, due in mid-December. Quarterly reports start in mid-February. The workshops must happen by the end of March. Owners are told and reminders are set. Nothing was retyped.
“3 commitments added · three owners told · reminders set”

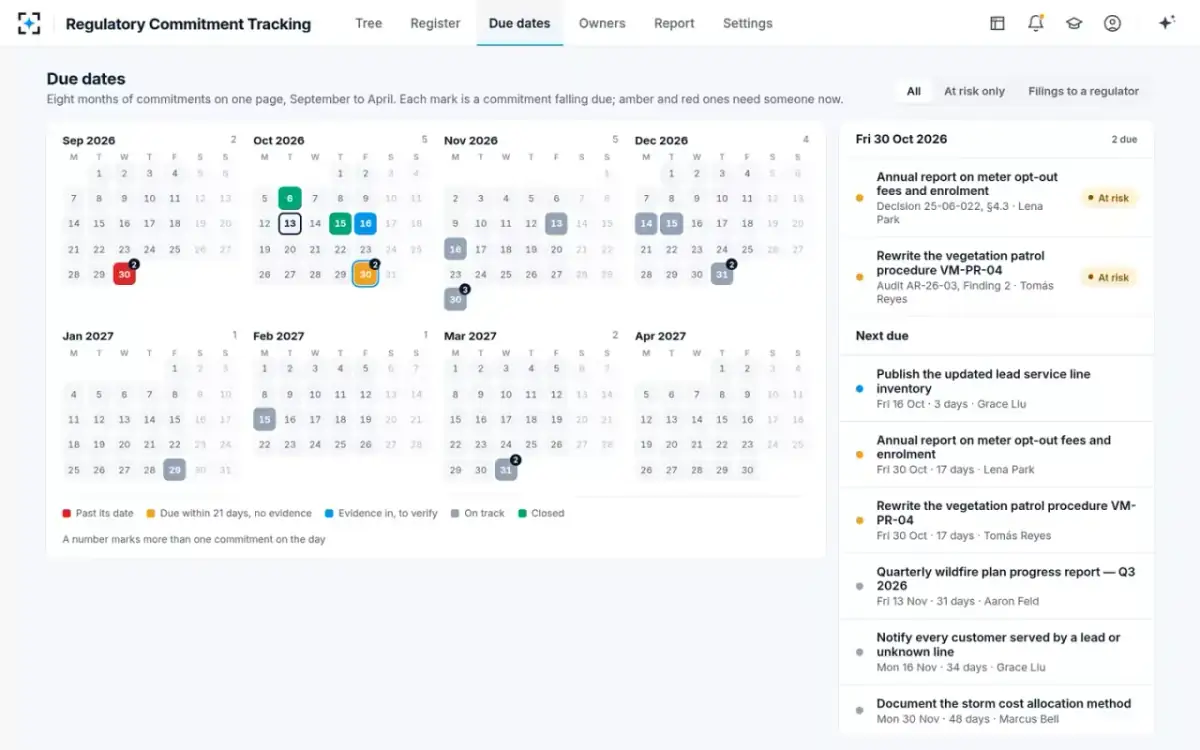

- 0717 days left
A draft is found, but a draft is not evidence

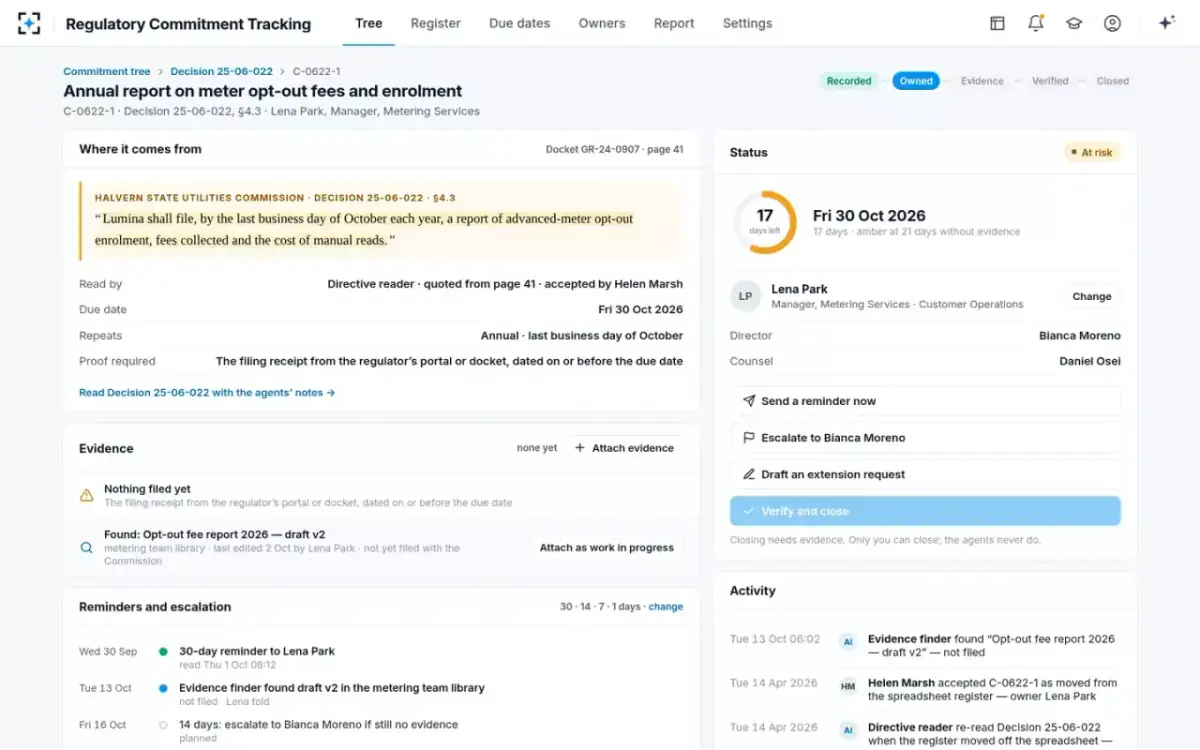

Metering services managerThe opt-out report quotes §4.3 of the settlement, which says to file by the last business day of October each year. The evidence finder found the fee report in the metering team library. It is marked draft v2, was last edited earlier this month, and has not been filed. The metering manager got the 30-day reminder. If there is still no evidence 14 days before the due date, it is escalated to the customer operations director.
“Closing needs evidence. Only you can close it. The agents never do.”
- 08If more time is needed
An extension request, drafted for counsel

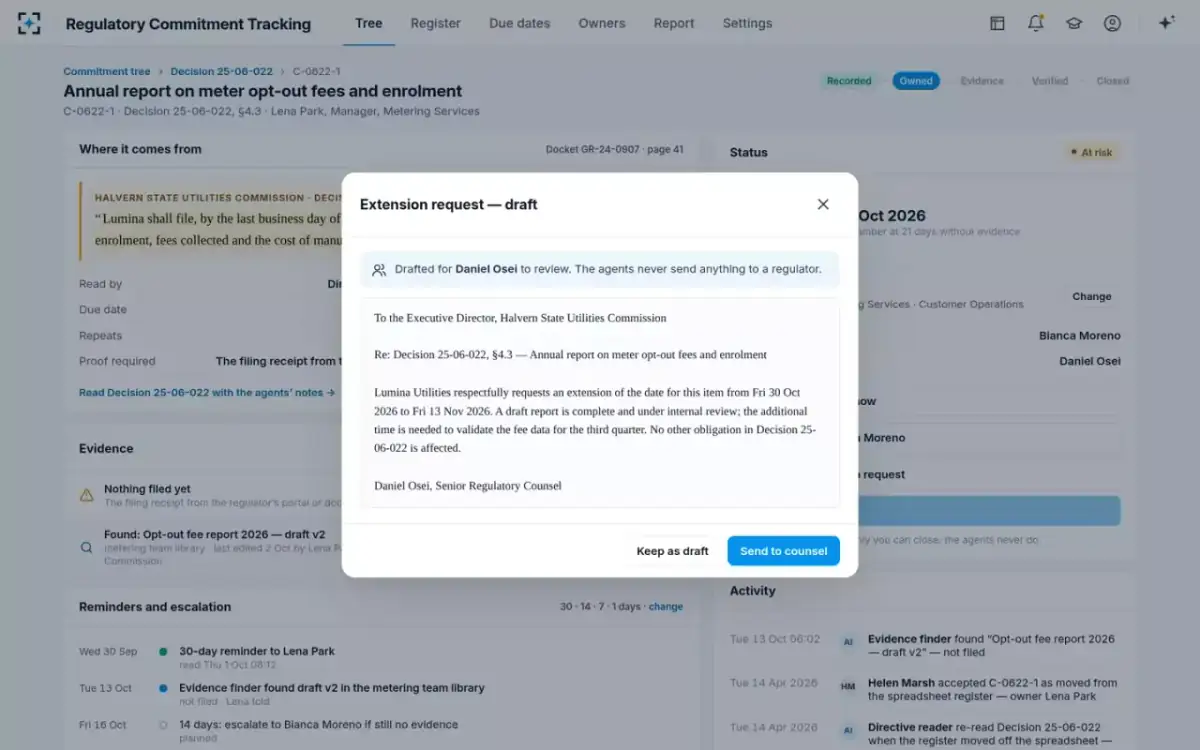

Senior regulatory counselFrom the commitment, the compliance manager can draft an extension request to the Commission’s Executive Director. Here it asks for two more weeks while the third-quarter fee data is checked. The draft goes to counsel to review. The due date stays as it is unless the regulator agrees.
“Drafted for counsel to review. The agents never send anything to a regulator.”
- 09Evidence in
Four checks on the evidence, then a signature

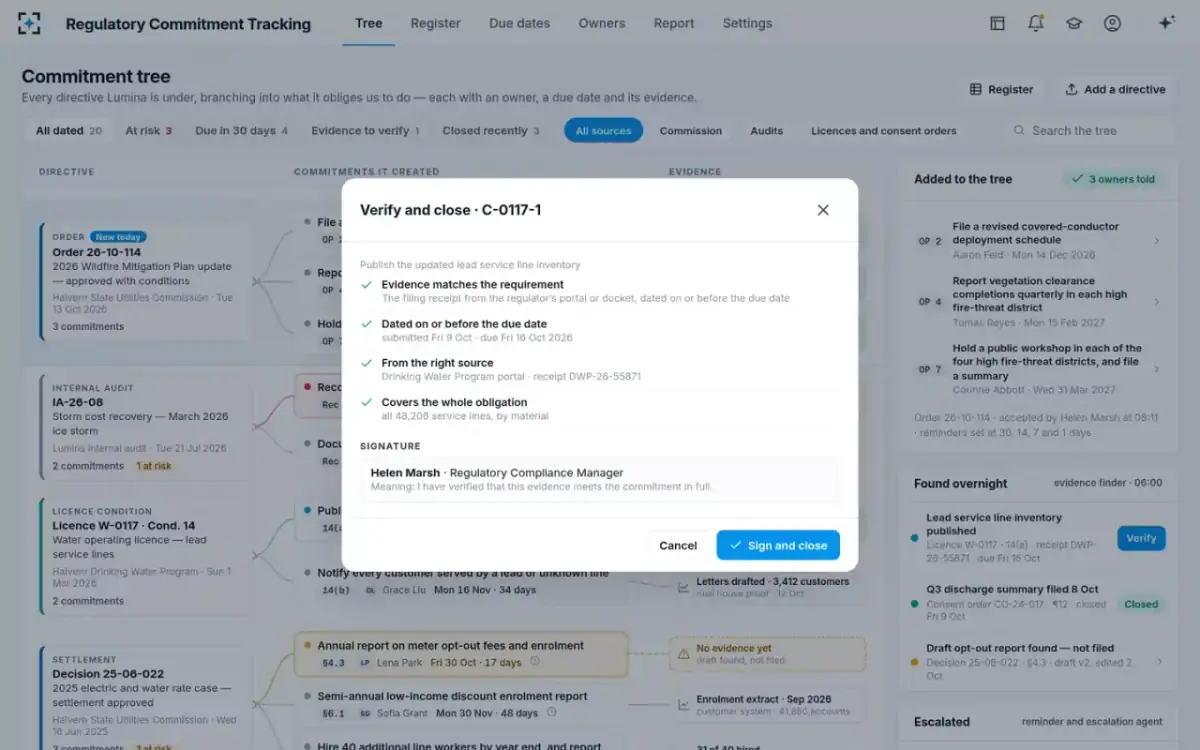

Regulatory compliance managerThe evidence finder linked a filing receipt from the drinking water program. It is for the lead service line inventory, submitted a week before its due date. The compliance manager checks that it matches the requirement and is dated on or before the due date. They also check that it comes from the right source and covers every service line. Then they sign and close it.
Signature meaning: “I have verified that this evidence meets the commitment in full.”
- 10Before the Board meets
The Board report, each number cited

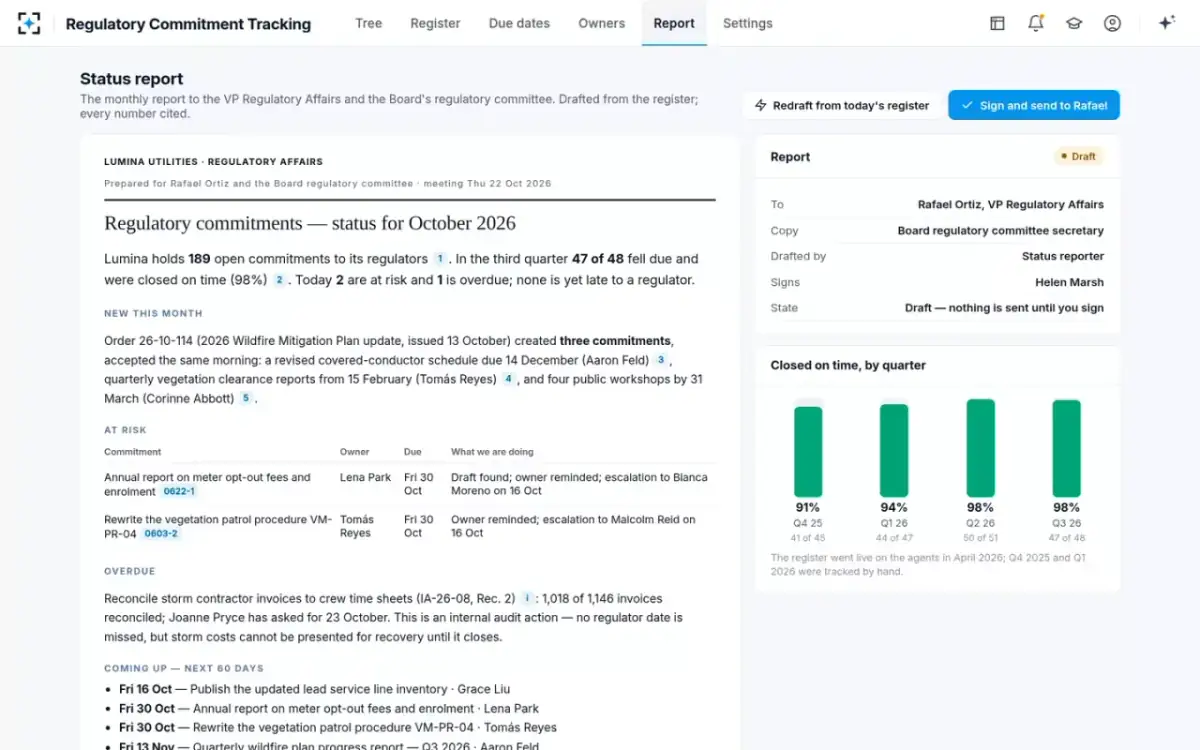

VP of regulatory affairsThe status reporter drafts the October report for the VP and the Board’s regulatory committee, using the register. There are 189 open commitments, and 47 of 48 closed on time in the third quarter. Two are at risk and one is overdue. The report also lists the three new commitments from the wildfire order. Nothing goes to the VP until the compliance manager signs.
“Draft. Nothing is sent until you sign”
