- Before
- Reads the order, then spends weeks of email finding what it touches. Knowing the rule changed is easy. Knowing what it breaks takes three weeks.
- Now
- Opens the redline with the impact graph beside it. Clicks a clause to see its procedures, systems and owners, then reviews and signs the map.
A disconnection rule rewritten, redlined and mapped to its seven owners
The state commission has adopted an order in a rulemaking docket. It rewrites the commission's rule on disconnecting residential service. The order was issued yesterday and takes effect in 94 days. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0105:30
41 new filings read, one scored 97

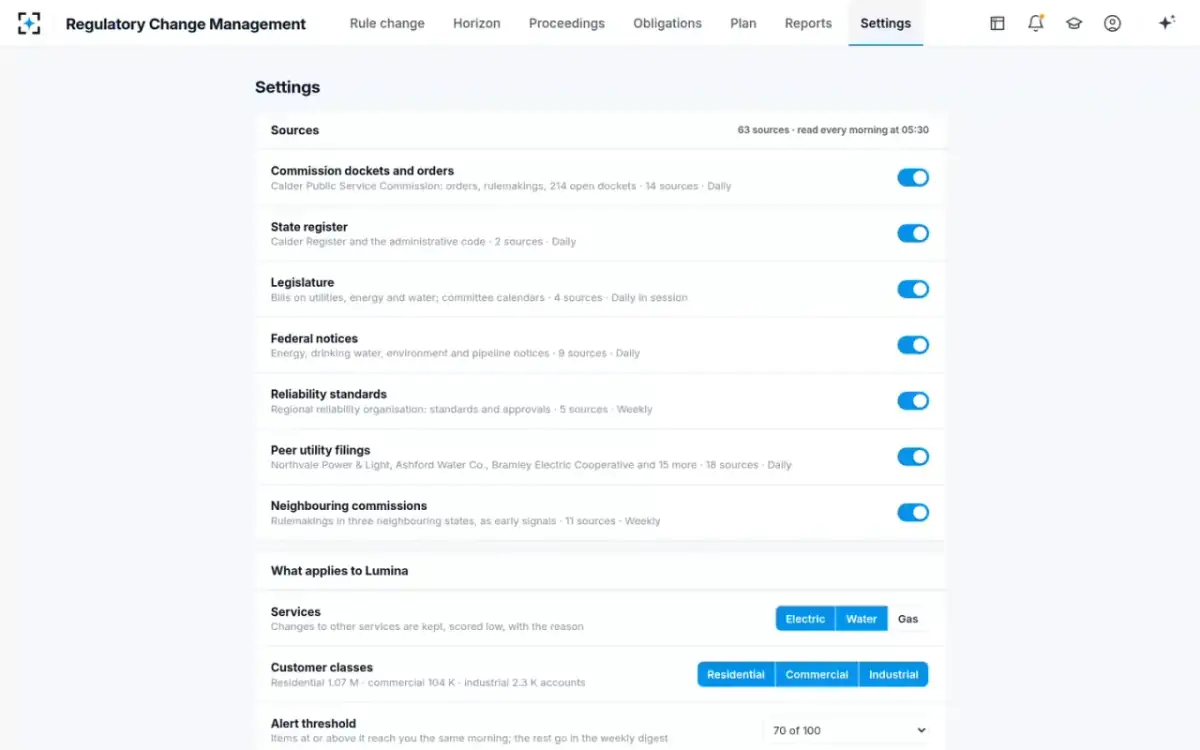

Docket watcher and Relevance rankerThe Docket watcher reads 63 sources. These are commission dockets and orders, the state register, the legislature, federal notices and 18 peer utility filings. The Relevance ranker scores the disconnection order at 97. It covers residential electric and water service, the utility is on the service list, and 6 obligations in the register cite the rule. Seven items clear the alert threshold. A gas pipeline odorant rule scores 12 and is kept, with its reason.
Kept for the record: “The utility has no gas service”. Each low score keeps its reason.
- 0205:36 to 05:46
The order redlined, and the work it touches drawn beside it

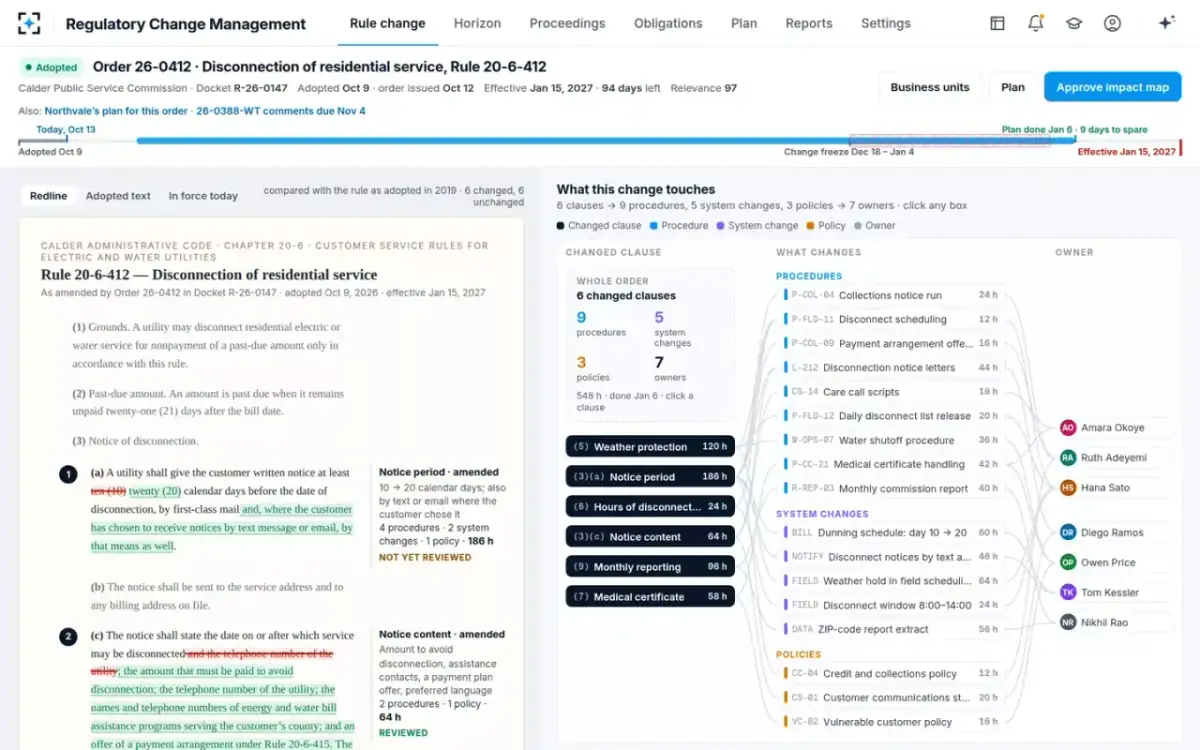

Redline builder, Impact mapper, Effort estimatorThe Redline builder compares the 14-page order with the rule in force, clause by clause. A redline marks each word struck out and each word added. The builder finds 6 changed clauses, 4 amended and 2 new, with each word quoted. The Impact mapper links them to 6 obligations, 9 procedures, 5 system changes, 3 policies and 7 owners. Its confidence runs from 89 to 97 %. The Effort estimator puts the work at 548 hours, done 9 days before the effective date.
“Plan writer drafted 19 tasks and 7 summaries, waiting for the compliance manager. Nothing is sent until the impact map is signed.”
- 03Morning

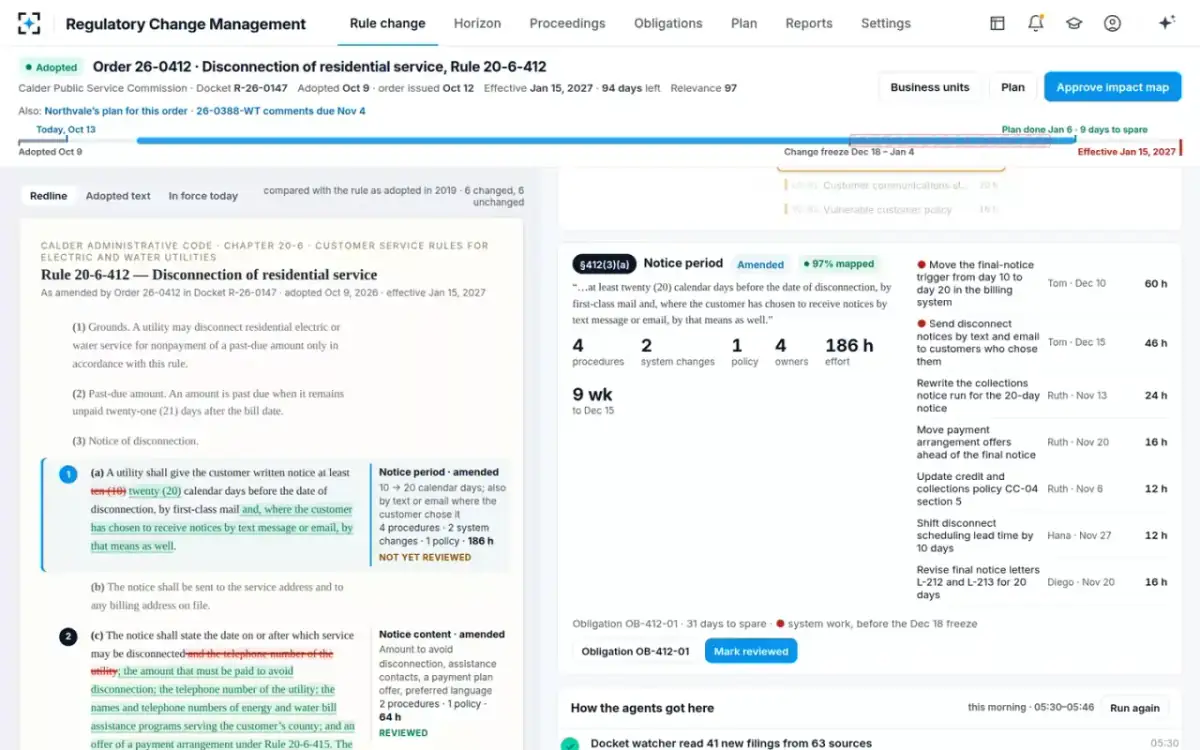

One click on the notice clause lights up its paths

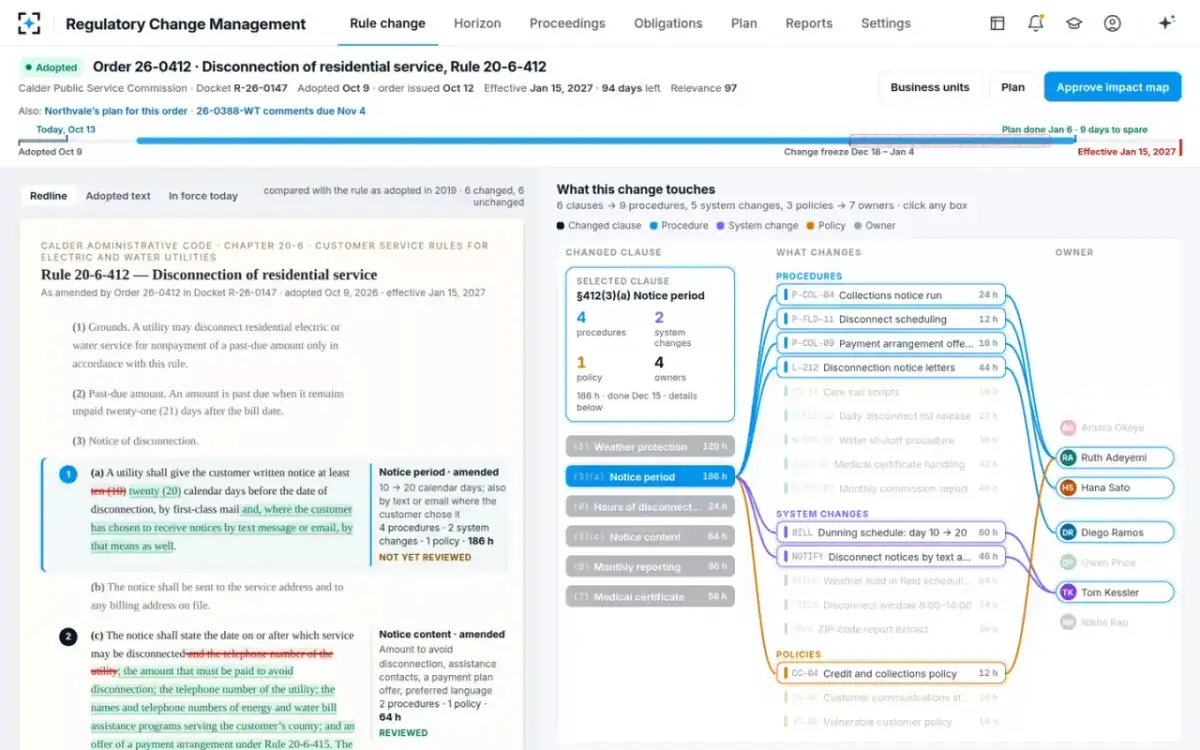

Regulatory compliance managerClause (3)(a) moves written notice from ten to twenty calendar days before disconnection. It also adds text or email where the customer chose it. In the graph, 4 procedures light up: the collections notice run, disconnect scheduling, payment arrangement offers and the disconnection notice letters. So do 2 system changes, the collections policy and 4 owners, among them the collections manager and the billing systems lead.
By mail: “…at least twenty (20) calendar days before the date of disconnection, by first-class mail…”. And by text or email: “…where the customer has chosen to receive notices by text message or email, by that means as well.”
- 04The effort
186 hours, and the two tasks that must beat the freeze
Effort estimatorThe effort card lists seven tasks for the clause, 186 hours over 9 weeks. Two are billing-system work for the billing systems lead. One moves the final-notice trigger from day 10 to day 20 (60 h). The other sends disconnect notices by text and email (46 h). Both are flagged as system work that must land before the year-end change freeze, the second three days before it starts.
“Billing changes must be live before the freeze: the day-20 trigger ends first, and text and email notices three days before it.”
- 05A peer check

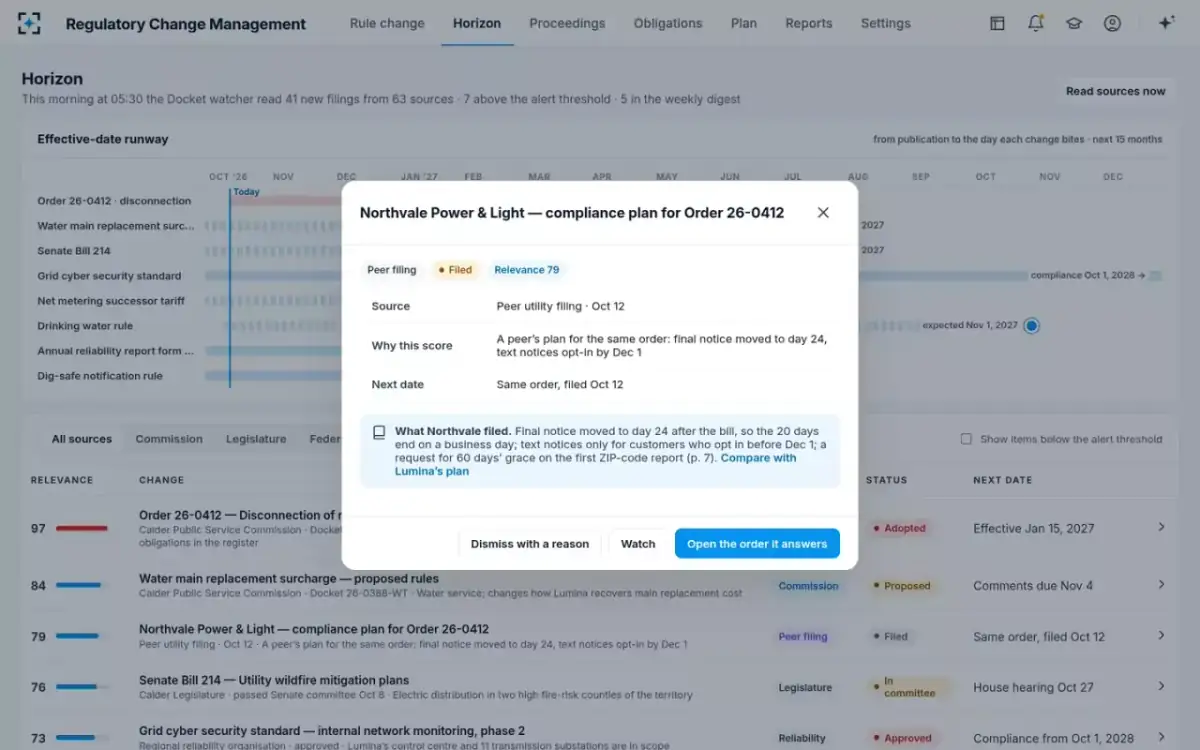

What a neighboring utility filed for the same order
Regulatory compliance managerA neighboring utility filed its compliance plan for the order on the day it was issued. Its plan moves the final notice to day 24 after the bill, so the 20 days end on a business day. Text notices go only to customers who opt in by a set date. It also asks for 60 days' grace on the first ZIP-code report. The compliance manager compares this with the utility's own plan, which files a test report 9 days before the effective date.
- 06The register

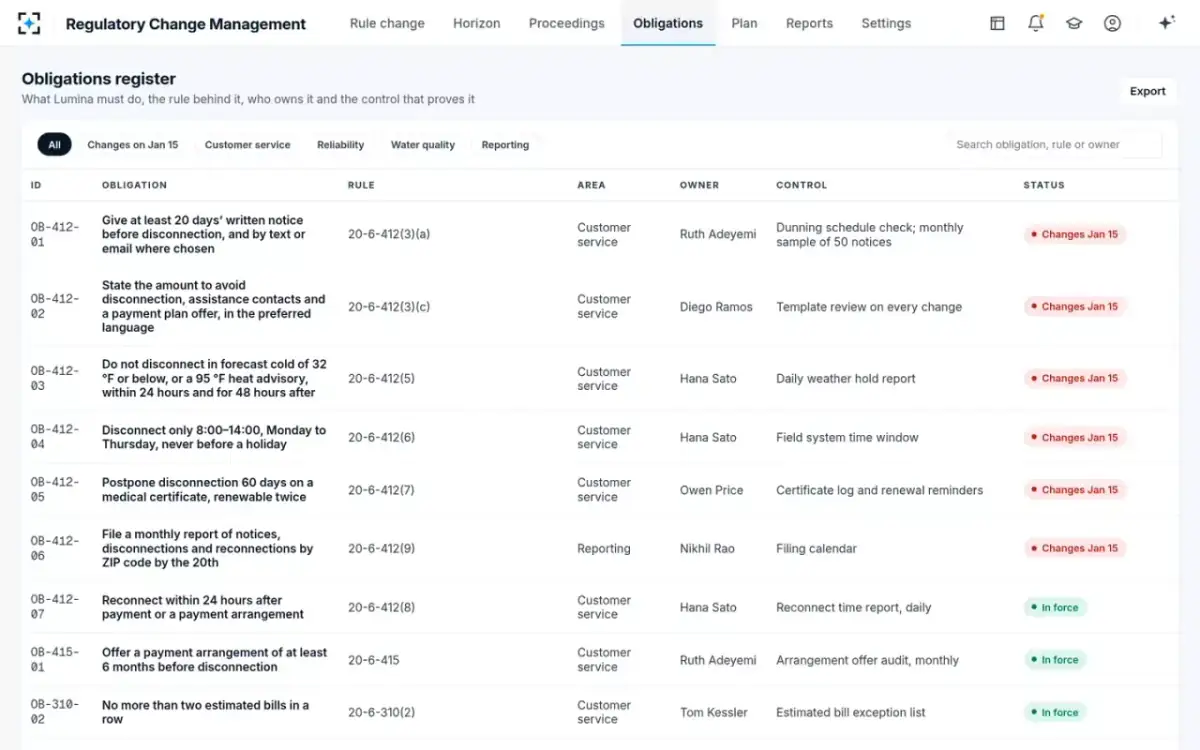

Six obligations marked as changing on the effective date
Impact mapperIn the obligations register, the six affected rows carry the new text, the owner and the control that proves it. One is at least 20 days' written notice. The collections manager owns it, and a monthly sample of 50 notices checks it. Another bans disconnection when the forecast is 32 °F or below or a 95 °F heat advisory is in effect. It has its own owner and a daily weather hold report. The rest of the register stays in force.
- 07The plan

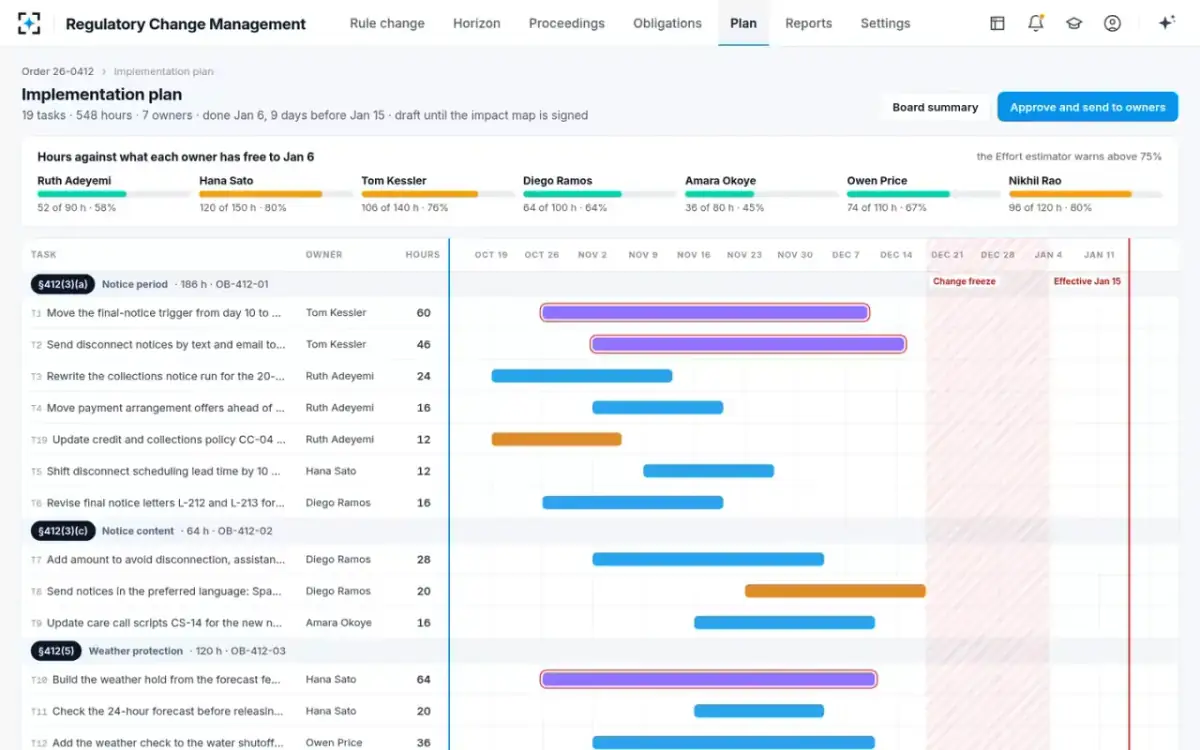

19 tasks laid out against the freeze and the effective date
Plan writer and Effort estimatorThe implementation plan runs from today to the effective date. It has 19 tasks, 548 hours and 7 owners, grouped by clause. The year-end change freeze and the effective date are drawn across the timeline. Each owner's hours are set against the time they have free. Two owners are at 80 %, and the billing systems lead is at 76 %, above the 75 % warning line.
- 08One request
A retraining task added, and the plan still fits

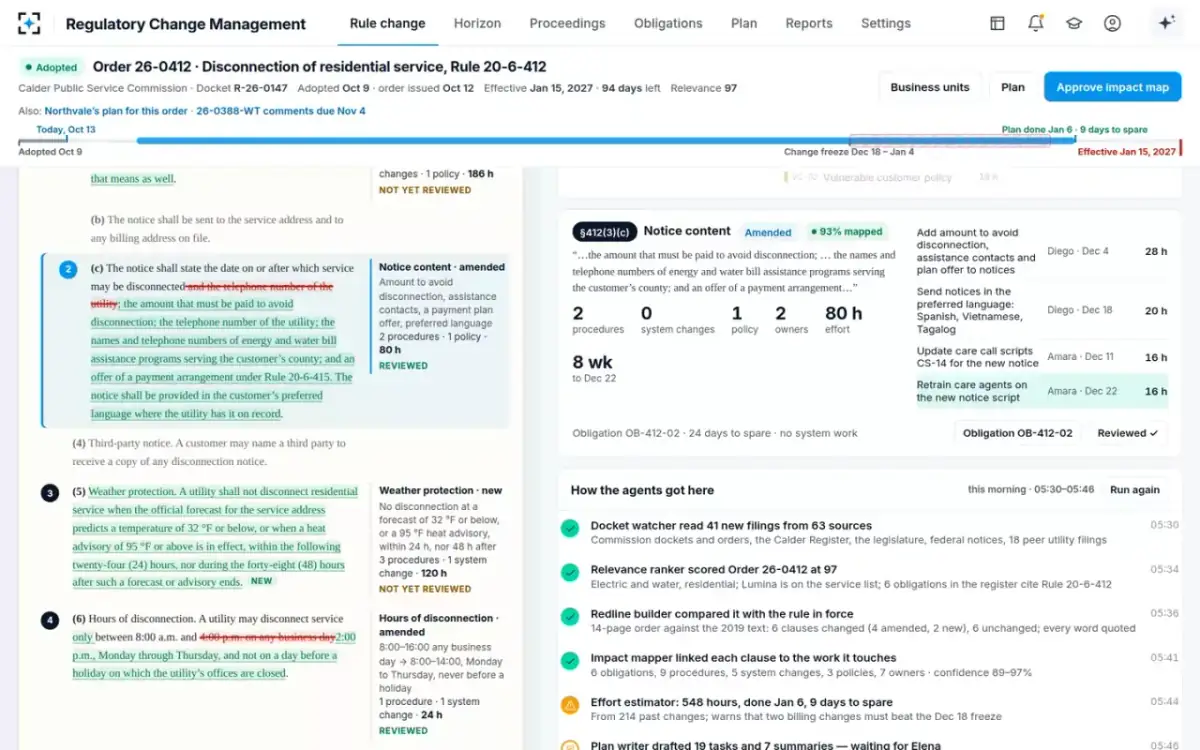

Regulatory compliance managerThe compliance manager asks the assistant to add a task to retrain care agents on the new notice script. The task lands under clause (3)(c) for an owner in customer care. It takes 16 hours over two weeks in December, after the script update. The plan now has 20 tasks and 564 hours, and still finishes 9 days before the effective date.
“Retrain care agents on the new notice script · customer care · 16 h”
- 09Review and sign
The impact map signed, with the meaning of the signature

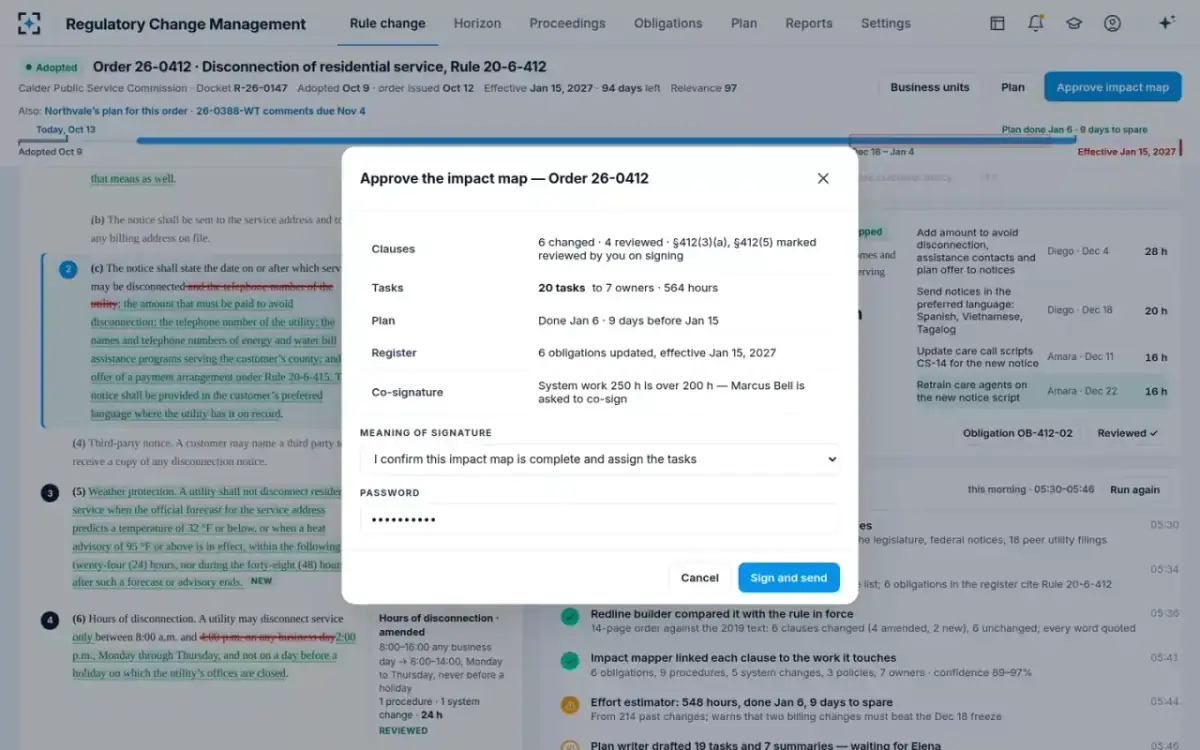

Regulatory compliance managerThe approval screen shows the 6 clauses and the 20 tasks for 7 owners. It shows the plan done 9 days early and 6 obligations updated as of the effective date. System work comes to 250 hours, over the 200-hour line, so the director of regulatory affairs is asked to co-sign. The compliance manager signs with a password and records what the signature means: “I confirm this impact map is complete and assign the tasks”.
Agents read, rank, redline, map, estimate and draft. They never sign or send.
- 10Signed, the same day

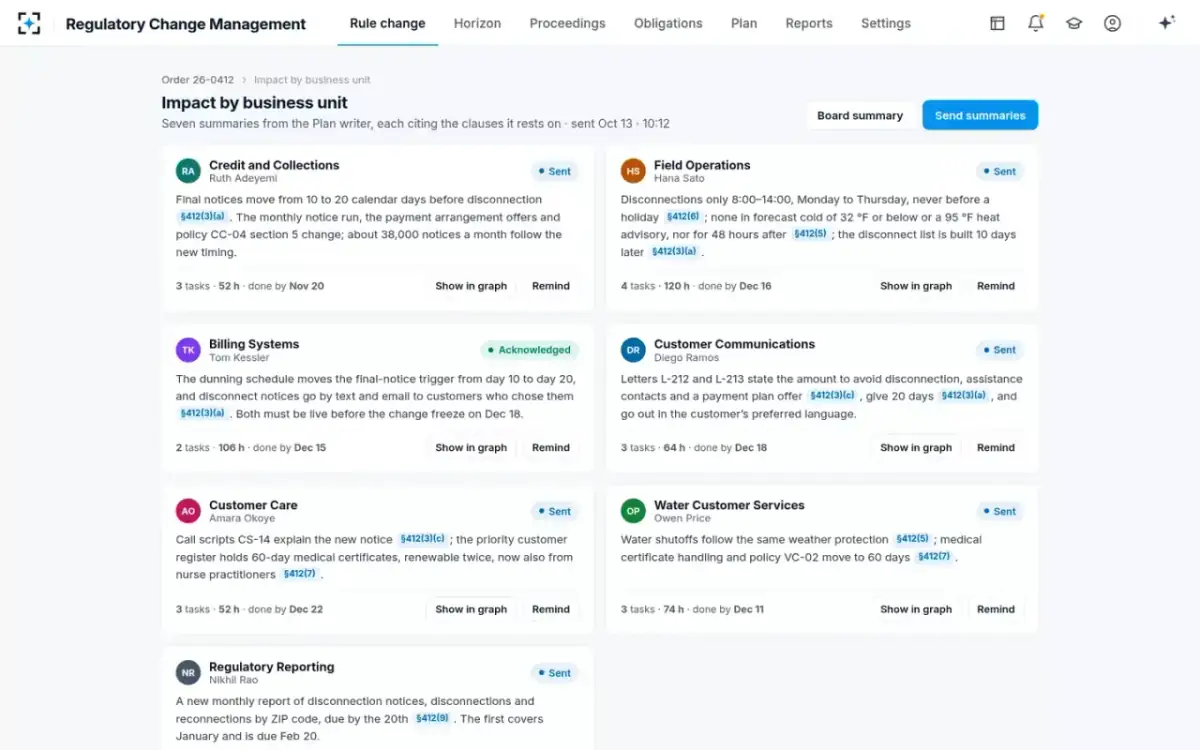

Seven summaries reach seven teams
Plan writerThe Plan writer sends 20 tasks to 7 owners. Each business unit gets one summary, and each line cites its clause. The units are Credit and Collections, Field Operations, Billing Systems, Customer Communications, Customer Care, Water Customer Services and Regulatory Reporting. Billing Systems has already acknowledged. The register is updated, and the director gets a one-page board summary.
“Signed: 20 tasks sent to 7 owners · director asked to co-sign”
