NERC CIP Audit Evidence Management

NERC CIP audit evidence management that finds the gaps before the auditor does

See one case, screen by screen ↓
Watch with transcript →

Built forCompliance managersSubject-matter expertsCIP senior managersInternal auditorsAsset owners

The Problem Today

Compliance teams pull proof from many systems by hand, so gaps are found only when the auditor samples.

$10M
penalty in one 2019 settlement covering 127 CIP violations published

Proof gathered by hand

  • Patch logs
  • Tickets
  • Access list
  • Sign-offs
  • The proof is missingPatched, but the work order never reached the binder
  • Clocks checked by handThree years of patch, log and access review cycles

The Solution

  1. Each requirement readEach audit worksheet phrase becomes a check on clock, scope or sign-off
  2. Evidence filed each nightExports pulled from ten source systems and filed to the right tab
  3. Checked, gaps sent to ownersEach phrase tested, and a missing record requested from its owner
  4. The CIP senior manager signsSigned with each open check, its owner and its request in view

Built-in controls

  • Every verdict cites its evidence item
  • Read-only, hashed and frozen at filing
  • Self-reports stay a human decision

What You Get

Missed records become requests to their owners long before the audit, so fewer gaps reach the auditor.

  • Misses seen the next dayA missed clock shows the day after it runs out
  • Narratives drafted for expertsEach worksheet answer written part by part, ready to accept
  • A readiness score each dayChecks met by standard, with each open check's owner
In short

What is NERC CIP Audit Evidence Management?

It is software that keeps the evidence for each CIP requirement in one binder, filed as it is produced. A Medium Impact entity can then show the regional entity it met each requirement across the audit period. NERC CIP Audit Evidence Management adds six agents. They read each record against the requirement's own words, name each gap and draft the request and the RSAW narrative. People send, accept and sign.

How to choose AI solutions for utilities →

Updated

The problem

CIP evidence sits in ten systems, and nobody checks it until the auditor does

NERC CIP is the set of cyber security rules for the North American power grid. A utility rated Medium Impact must prove it met each requirement across a three-year audit period. The proof is created all the time. There is a patch evaluation every 35 days, a log review every 15 days and an access check each quarter. Tests and reviews come every 15 calendar months. Each record lands in a different system: the patch tracker, change tickets, the identity directory, log monitoring, badge access and the training system. Then the audit notice arrives with the RSAWs and the request for information. RSAWs are the worksheets the auditor uses to test each requirement. The CIP team spends weeks pulling screenshots, exports and signed reviews into folders by requirement.

The failures are rarely missing controls. Most are missing proof. A firmware install was done during an outage, but its work order was never attached. A quarterly review was done but not signed. A tabletop exercise was held with no after-action record. Nobody reads the evidence against the requirement's own words until the mock audit or the auditor does. Found then, each gap is a possible violation. Found the day after its deadline passes, it is only a request to an asset owner, with time left to find the record.

typical$10Mpenalty in one 2019 settlement covering 127 CIP violations, caused by oversight gaps and weak internal controls
typical≈ $379kto set up a CIP program at a Medium Impact entity, by an estimate drawn from FERC, before any audit season
Where one requirement's audit-prep hours goestimated
By hand60 hours
With the solution13.5 hours
  • Reading the RSAW and working out what proves each part6 → 1 h
  • Pulling exports, logs and screenshots from the source systems20 → 2 h
  • Checking dates, clocks, asset scope and signatures12 → 3 h
  • Chasing missing records from asset owners10 → 3 h
  • Writing the RSAW narrative8 → 2.5 h
  • SME and internal audit review4 → 2 h

Estimated split per requirement tab, in hours, by hand and with the solution. The last audit cycle took about 60 hours for each of 39 requirements. The split will be measured in the live solution.

How it works

Nightly evidence collection, checked phrase by phrase for the CIP audit

What comes in
Evidence inThe source systems · patch, change, access, logs, badges, training
Agents at work
Requirement readereach phrase a check
Then
Evidence collector
Evidence checker
Then
Gap finder
Request drafter
Then
RSAW narrative writercited by item
A person decides
CIP compliance managersends requests; the CIP Senior Manager signs
What comes out
Binder per requirement
Gaps requested
Signed submission
One case, step by step

A missing patch record in the NERC CIP audit evidence, found and closed

A utility is 13 days from sending its RSAWs and evidence to the regional entity, the body that audits it. The on-site week follows. The three-year audit period covers 8 sites and 240 Cyber Assets. Here is that morning, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 0113 days out, morning

    The binder opens on the tab that needs attention

    NERC CIP compliance manager

    Thirty-nine divider tabs run down the left, grouped by standard from CIP-002-5.1a to CIP-013-2. Of these, 29 are complete, 7 partial and 3 missing. Readiness is 89%, with 94 of 106 checks met. CIP-007-6 R2, Security patch management, is open and stamped Partial, with 7 of 8 checks met. The requirement is printed in its own words, with each testable phrase underlined and numbered. One phrase is underlined in red and stamped “no record found”.

    Part 2.3 · “within 35 calendar days of the evaluation completion”: no record found

  2. 02Overnight, 02:14

    Eight phrases, eight checks, each with its record

    Requirement reader and evidence checker

    The requirement reader read R2 as eight checks, one per phrase. The evidence collector filed 212 items from the document library, patch tracker and change tickets. Each one got a hash, a fingerprint that shows it has not changed. The checker's table shows what the auditor will test. All 240 Cyber Assets are covered by 23 patch sources. There were 34 evaluation cycles, and the longest interval was 34 days. In all, 409 patches were applied within 35 days, and there are two dated mitigation plans.

    411 of 412 applicable patches have an action within 35 days.

  3. 03The evidence

    What the checker read, on the record itself

    Evidence checker

    This is the patch tracker's evaluation record for the August cycle. It shows 61 patches released, 14 applicable and all 23 sources evaluated, signed by the SME (subject-matter expert). It meets part 2.2. It also lists gateway firmware 4.2.7 as applicable to two RTU gateways at one substation. An RTU is a remote terminal unit, the device that links a substation to the control center. The action was due in early September.

    An unsigned or undated item does not count.

  4. 04The gap

    A miss shows the day after its clock runs out

    Gap finder

    The gap finder names exactly what is missing. It needs the install record for gateway firmware 4.2.7 on the two RTU gateways. A dated mitigation plan would also do, if it is dated on or before the action due date. On the obligation clocks, the September square for patch action after evaluation is red. The action was due, and there is no record.

    The gap finder does not decide whether a gap is a violation. The compliance manager and the CIP Senior Manager decide on any self-report.

  5. 05Drafted

    The request is written to the asset owner

    Request drafter

    The request goes to the substation automation lead. It quotes the phrase, the record wanted and the assets, and it is due three working days after it is sent. It sits in the Drafted column beside the requests already out. These are an exercise log 5 days overdue, a relay destruction certificate 1 day overdue and a training record for one person.

    The request drafter does not send a request. A person sends it.

  6. 06Sent, then answered

    The compliance manager sends it, and the work order comes back

    Substation automation lead

    The compliance manager sends the request from the tab. The substation automation lead answers the same day with the work order from the field work system. It shows firmware 4.2.6 to 4.2.7 installed on both gateways in early September, during a planned outage. SCADA, the grid control system, was polling them again with no alarms, and the baseline was updated the next day.

    Reply received: the work order, with its install date

  7. 07Checked

    The reply is read against the phrase before it counts

    Evidence checker

    The checker reads the work order against part 2.3. The firmware was installed 29 days after evaluation, so 412 of 412 applicable patches now have an action within 35 days. The tab turns Complete, 8 of 8, and readiness moves to 90%, with 95 of 106 checks met.

    Each phrase is met. The evidence covers the whole audit period.

  8. 08The RSAW

    The narrative cites each item, and says what is not yet proven

    EMS systems engineer, CIP-007 SME

    The RSAW narrative writer drafts the entity response part by part. It cites seven evidence items, such as the patch procedure, the 23 sources for 240 Cyber Assets and the 34 cycles. Before the reply was checked, the gateway sentence was marked in red as not yet proven, with the open request named. The SME accepts the narrative, edits it or exports the RSAW.

    The request is with the asset owner. This paragraph is completed when the record is checked.

  9. 0913 days out

    Each open check has an owner and a date

    NERC CIP compliance manager

    Pre-audit readiness lists the eleven checks still open, each with its owner and request. They include a training record for one person, visitor exit times at one site and a vulnerability assessment at another. When each open request is answered and checked, the binder reaches 106 of 106.

    When each open request is answered and checked, the binder reaches 106 of 106.

  10. 10Signed

    The CIP Senior Manager signs, with the open checks in view

    CIP Senior Manager

    The CIP Senior Manager signs the submission with the eleven open checks and their requests listed. The submission package freezes 1,284 items at their filed version, each with its SHA-256 hash. It indexes 39 RSAW narratives by standard, requirement and part.

    Signed by the CIP Senior Manager, with 11 open checks and their requests listed

Who it’s for

NERC CIP audit evidence management for compliance, SMEs and asset owners

The same binder, seen from the four jobs that answer for it. Here is what audit season looked like, and what it looks like now.

NERC CIP compliance manager
Owns the audit, 39 RSAWs and 11 SMEs across 8 sites
Before
Once the audit notice lands, chases evidence across eight sites and a dozen systems. Finds out a record is missing the week the auditor samples it.
Now
Opens a binder checked each night and sees each gap by phrase, asset and date. Sends the drafted request to its owner.
CIP senior manager
VP of grid operations, who signs the submission
Before
Signs the program and, at the end of audit season, the submission. Vouches for three years of compliance without seeing where it fell short.
Now
Signs with each open check, its owner and its request in view. Approves mitigation-plan extensions and rule changes, and decides with the compliance manager on any self-report.
Substation automation lead
RTUs, gateways and relays at six substations
Before
Patches RTUs and gateways during outages. The work order stays in the field system, outside the binder.
Now
Gets one specific request with the phrase, the record wanted, the assets and a due date. Answers it with the work order.
EMS systems engineer
CIP-007 SME who runs the 35-day patch evaluations
Before
Runs the 35-day patch evaluations for the control centers, 34 cycles and none late. Has to prove it to the auditor in one page.
Now
Reviews a drafted narrative where each sentence cites its evidence item, and accepts it as SME.
The agents

Reader, checker and drafter agents behind the CIP audit evidence

Each record is filed and read against its requirement's own words. Each gap is named and a request drafted. The compliance manager sends it and the CIP Senior Manager signs.

Requirement reader

Turns each RSAW requirement into testable checks, one per phrase. Each check covers the clock, the scope, the sign-off or the record. On CIP-007-6 R2 it reads eight checks.

  • Never rewrites the requirement language
  • Never drops a phrase
  • The compliance manager approves the checks once per standard version
Evidence collector

Each night, pulls exports from ten source systems. They are the patch tracker, change tickets, configuration monitor, identity directory, log monitoring, badge access, training, firewall manager, field work and the document library. Hashes each item with SHA-256 and files it to its tabs.

  • Read-only on every source
  • Never edits or deletes a record
Evidence checker

Reads each item against the exact phrase it must meet. It checks the clock to the day, the scope against the asset inventory and the signature against the approver register. It also checks coverage of the whole audit period. Each verdict cites the item and the fact.

  • Never passes a phrase without a cited item
  • Never counts an unsigned or undated item
Gap finder

For each unmet phrase, names the missing record, the assets and dates it covers, and who owns it.

  • Never judges a possible violation. The compliance manager and the CIP Senior Manager decide on any self-report
Request drafter

Finds the owner of the asset or process and drafts a short request. It quotes the phrase, the record wanted and the assets. The due date is three working days out, before the submission date.

  • Never sends a request. The compliance manager sends it
  • Never promises a date for the owner
RSAW narrative writer

Drafts the RSAW narrative part by part in plain, factual sentences, citing each evidence item by its ID. Marks any part not yet proven with its request.

  • Never claims compliance without a met check
  • The SME accepts, and the CIP Senior Manager signs the submission
CIP Senior Manager

Signs the submission and any self-report decision.

Ask in plain words

Any requirement, record or clock, answered with its evidence item

Ask in plain words, and each answer cites the evidence item. A change to an evidence rule is saved as a draft for the CIP Senior Manager to approve.

Which tabs would the auditor find a gap in today?

Ten tabs have open checks, and three are missing their core evidence. CIP-008 R2 has attendance for the June exercise but no exercise records. At CIP-010 R3, one site's vulnerability assessment was due in August. CIP-011 R2 has no destruction record for 3 retired relays. Each open check has an owner and a request.

Why is CIP-007 R2 only partial?

Seven of eight checks are met. The missing one is part 2.3. Gateway firmware 4.2.7 for two RTU gateways was evaluated as applicable in early August, so an action was due 35 days later. The patch action report shows no install record or mitigation plan for it. A request to the substation automation lead is drafted.

When is the next 35-day patch evaluation due?

By early November, because the last cycle was completed at the end of September. The actions for the 9 applicable patches from that cycle are due the same day. In the audit period there were 34 cycles, and the longest interval was 34 days.

Send the CIP-007 R2 request to the automation lead

Sent, due in three working days. It asks for the install record for gateway firmware 4.2.7 on both RTU gateways. A mitigation plan also works if it is dated on or before the action due date. When the reply comes, the checker reads it against part 2.3 before it counts.

The screens

The requirement binder, the obligation clocks and the signed submission

From the working solution, on its sample data. Pick one to see it large.

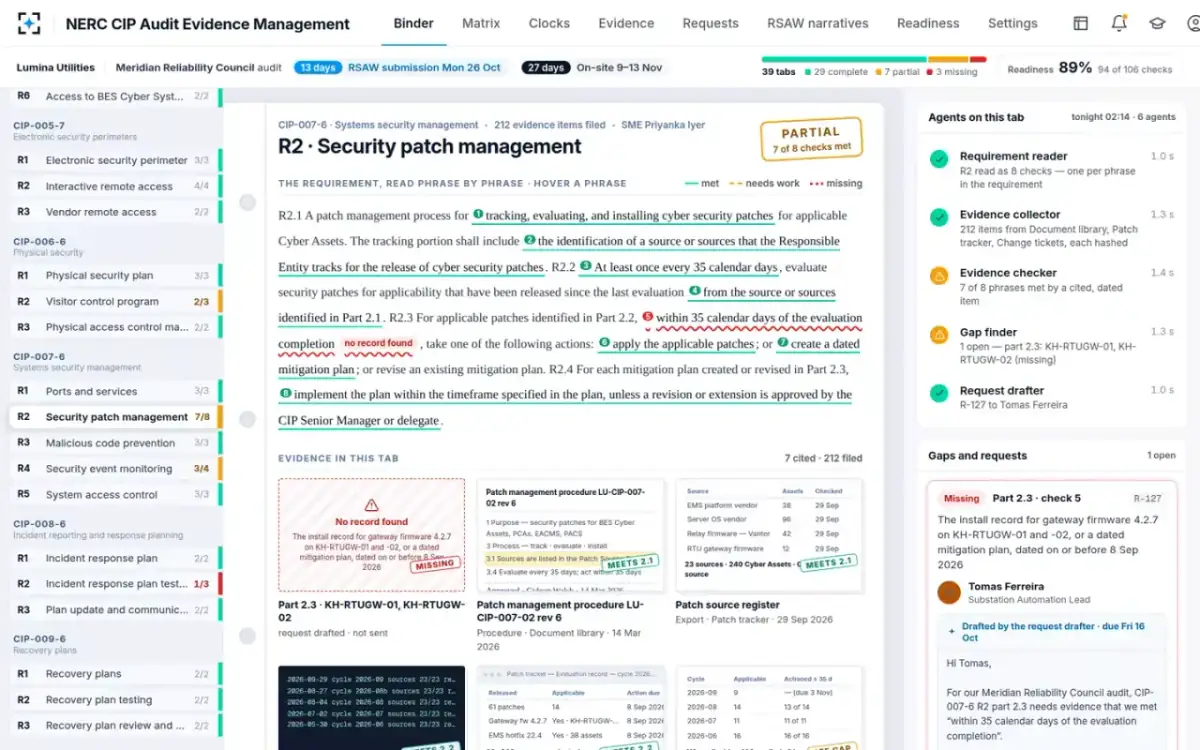

The binderThirty-nine requirement tabs by standard. The open tab's requirement is read phrase by phrase, beside its evidence sheets, the agents' run and the gap with its drafted request.

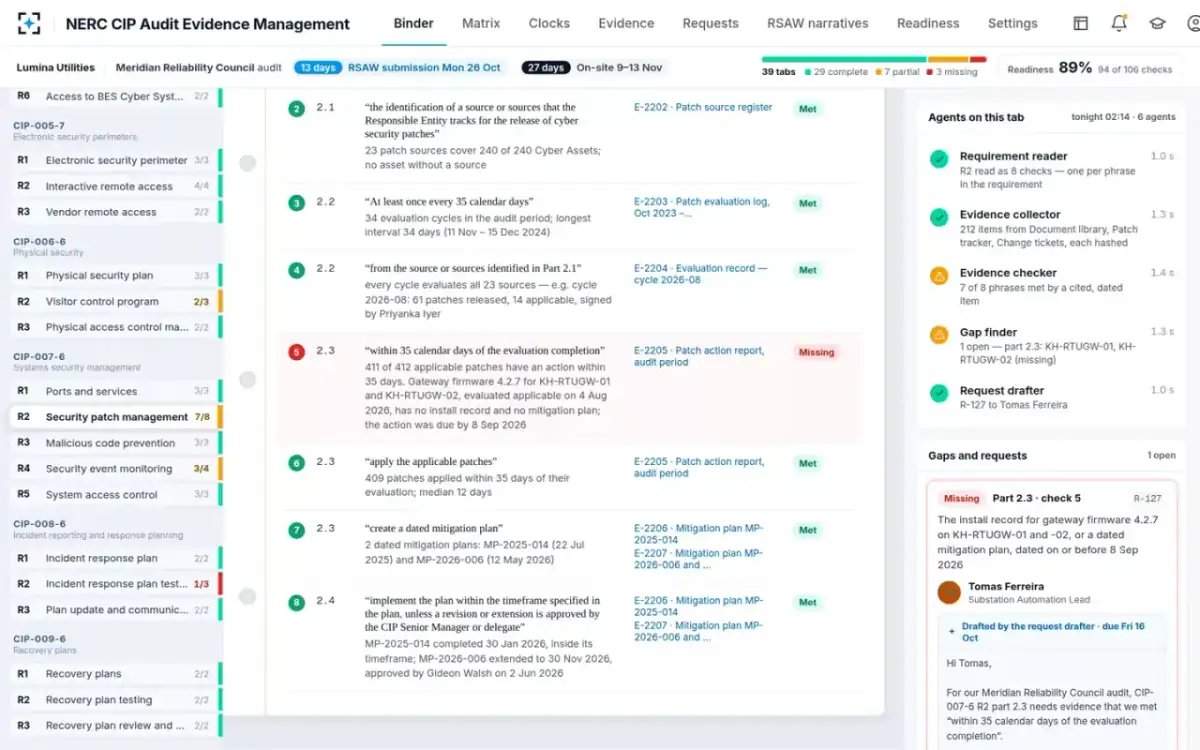

What the auditor will testEight checks for CIP-007-6 R2, each with its phrase, the fact the checker read, the evidence items and a verdict.

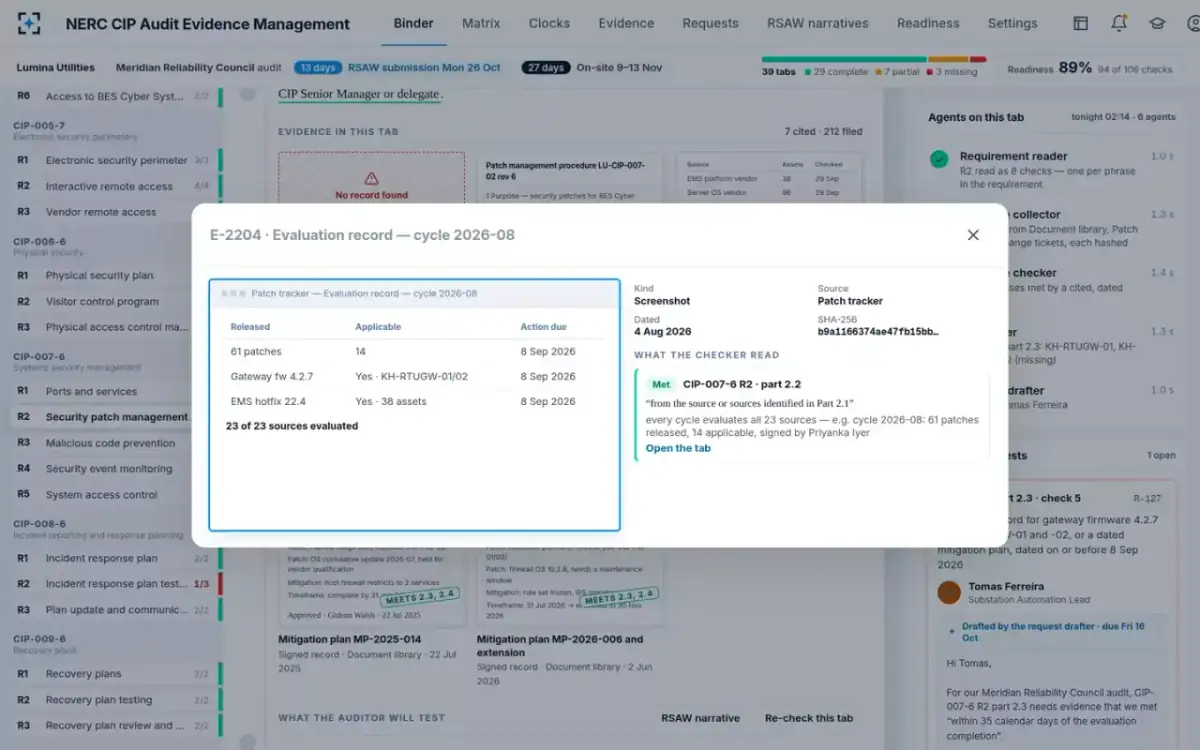

An evidence item, openedThe evaluation record for the August cycle with its kind, source, date and SHA-256, and what the checker read against part 2.2.

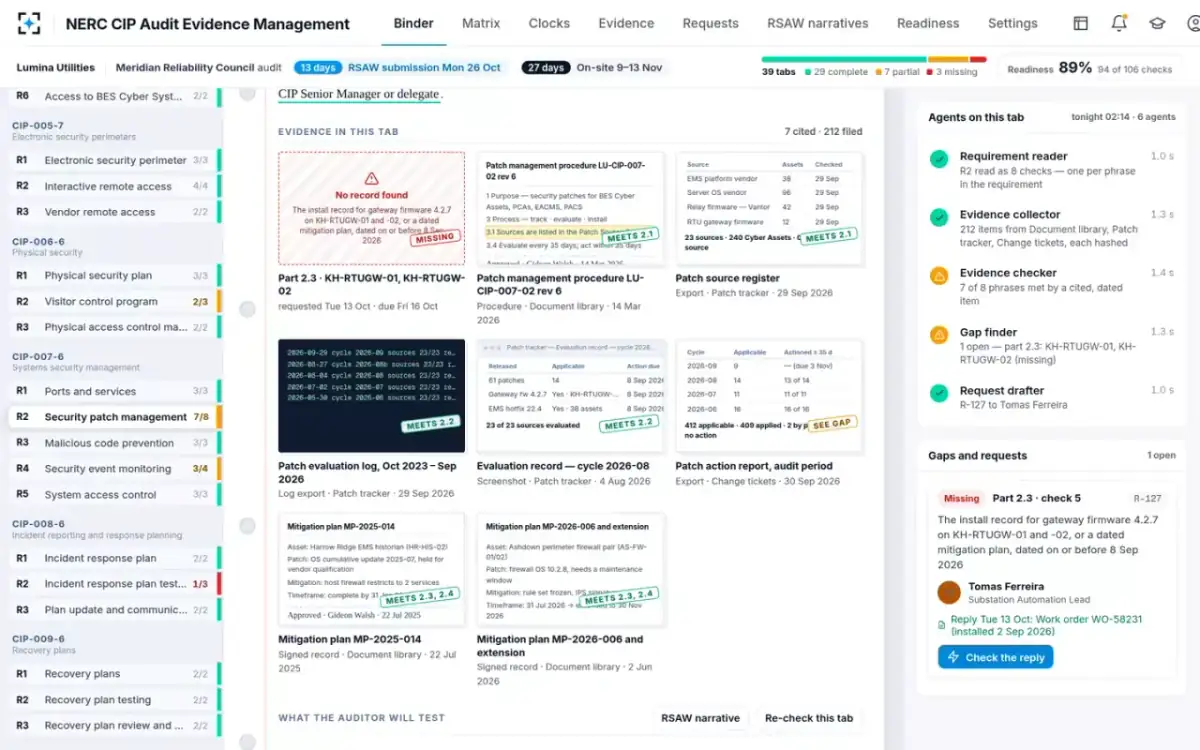

The owner's replyThe request sent to the asset owner and answered with a work order, waiting to be checked against the phrase.

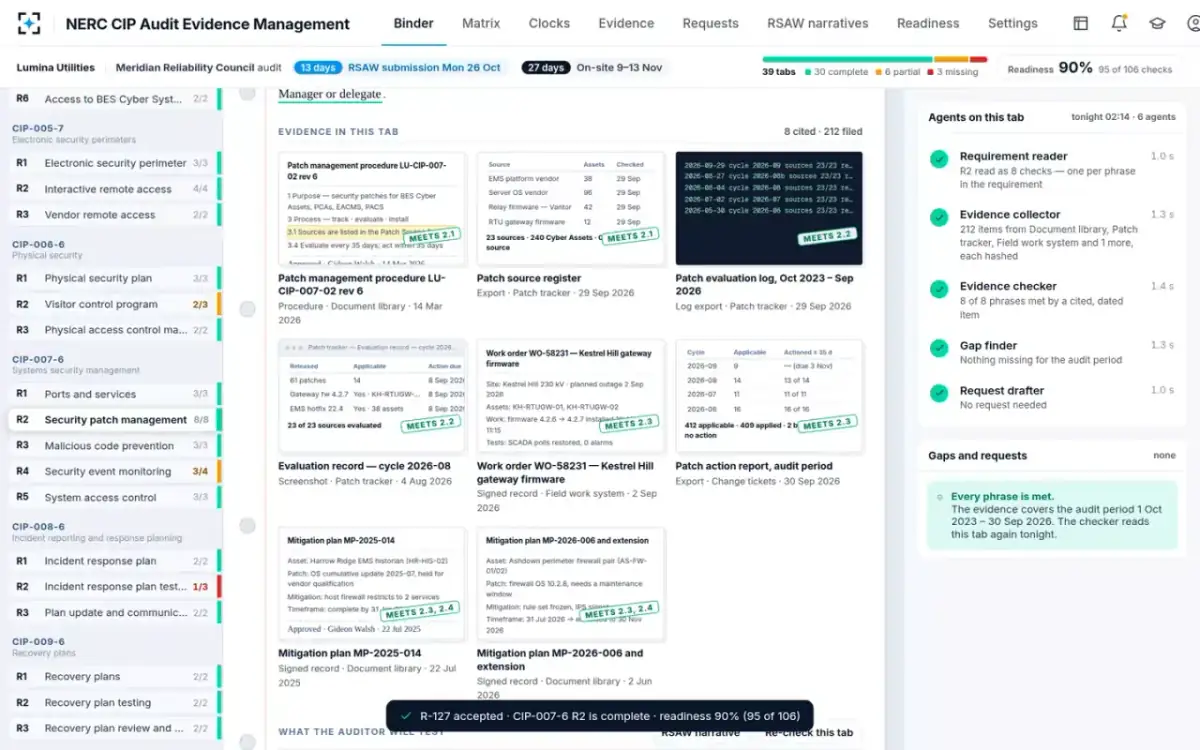

The tab completeCIP-007-6 R2 at 8 of 8 with the work order filed beside the other evidence, and readiness at 95 of 106 checks.

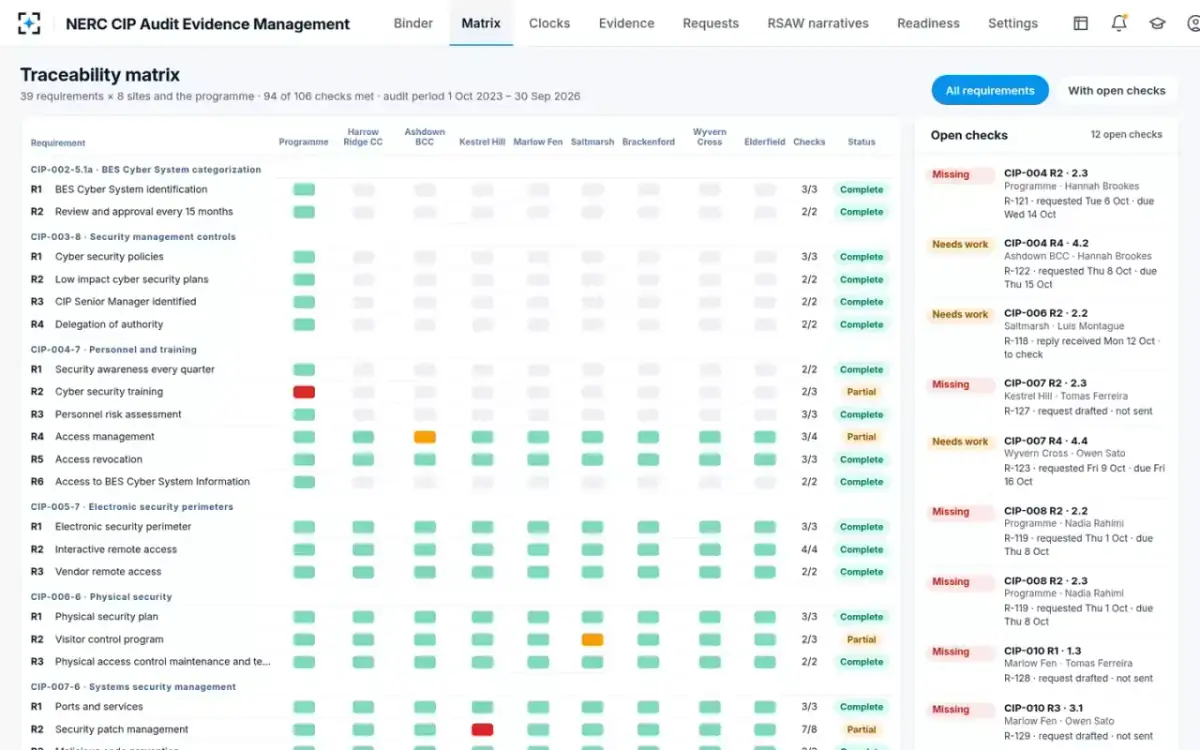

Traceability matrixThirty-nine requirements across the program and eight sites, each cell colored by status, with the twelve open checks and their owners.

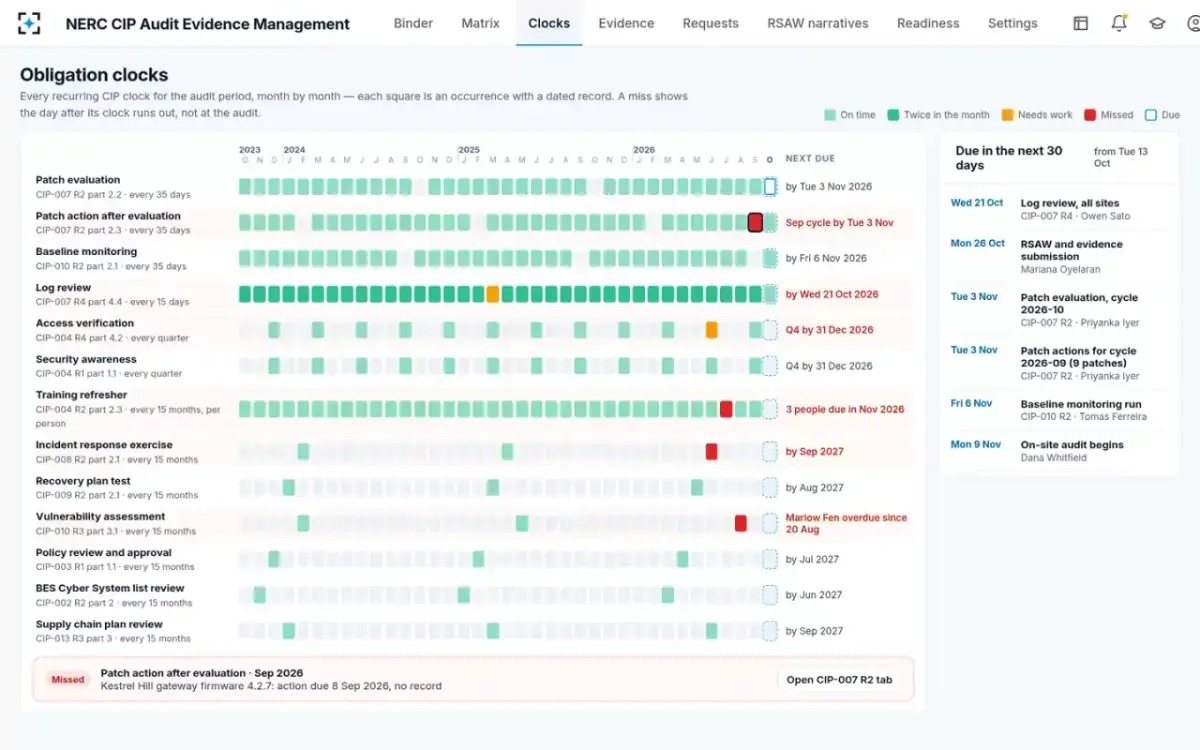

Obligation clocksEach recurring CIP clock for the three-year audit period, month by month. It shows the missed September patch action and what is due in the next 30 days.

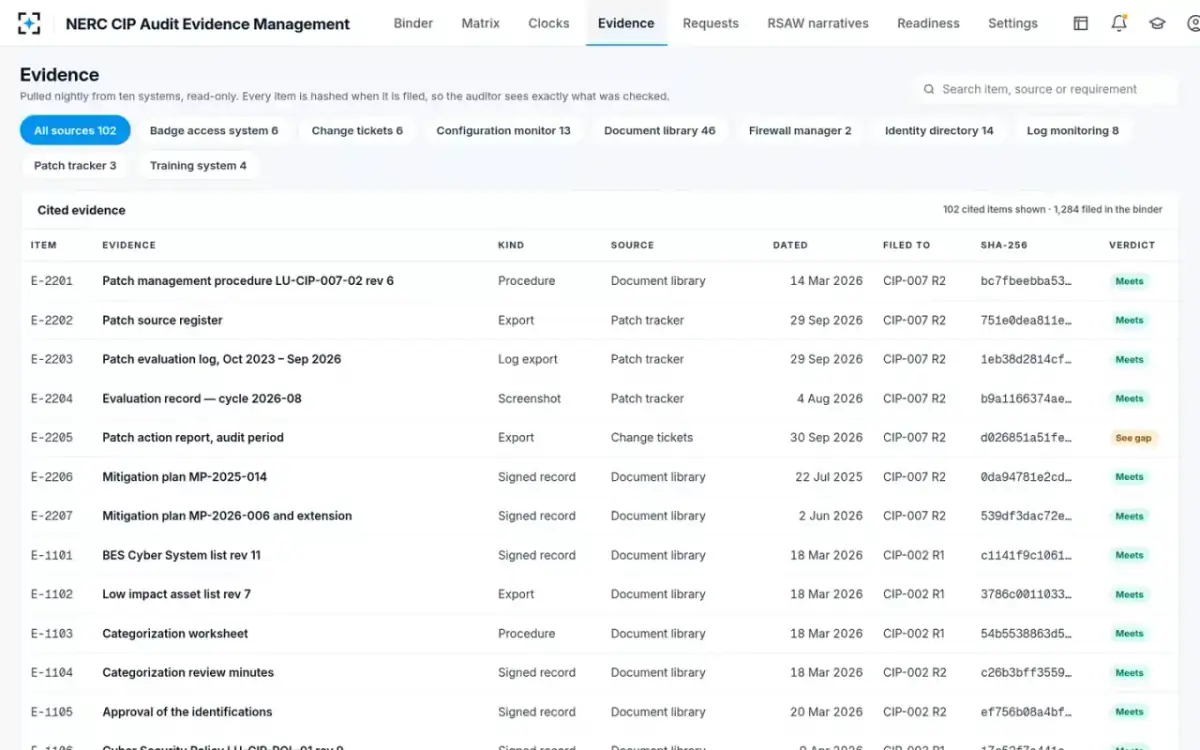

The evidence libraryItems pulled nightly from ten systems, read-only, each with its source, date, requirement, SHA-256 and verdict.

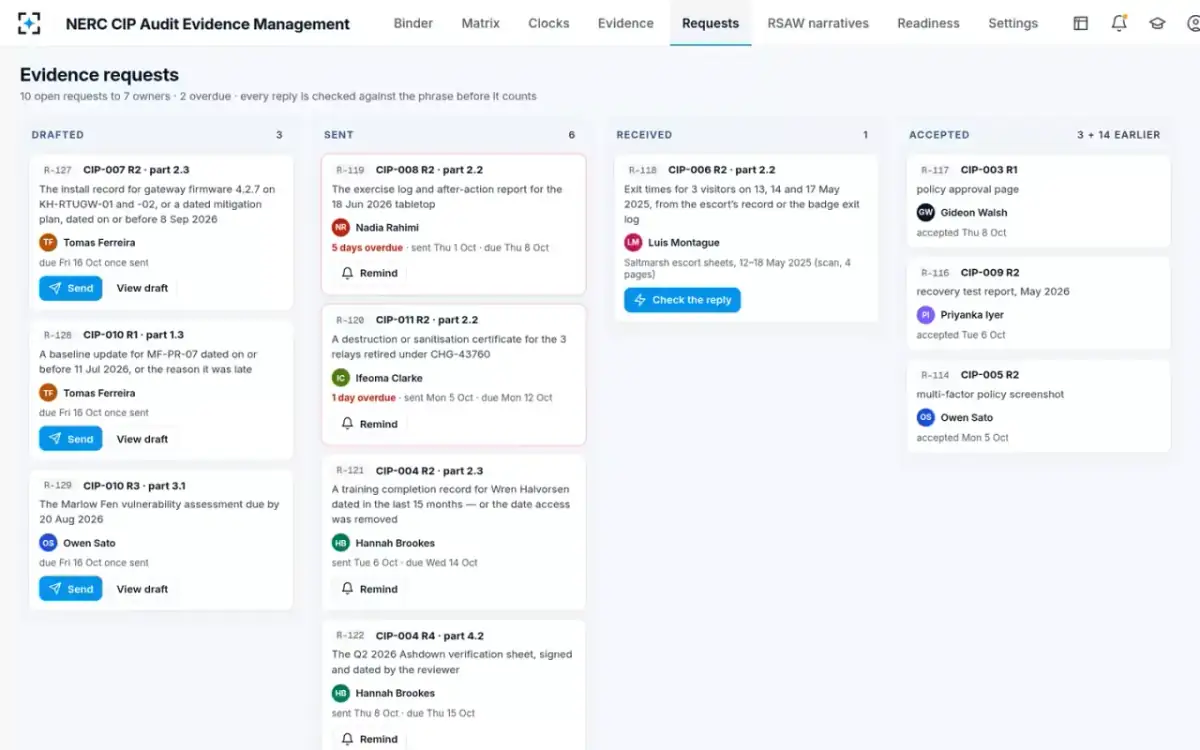

Evidence requestsRequests to owners from drafted to sent, received and accepted, with the overdue ones marked.

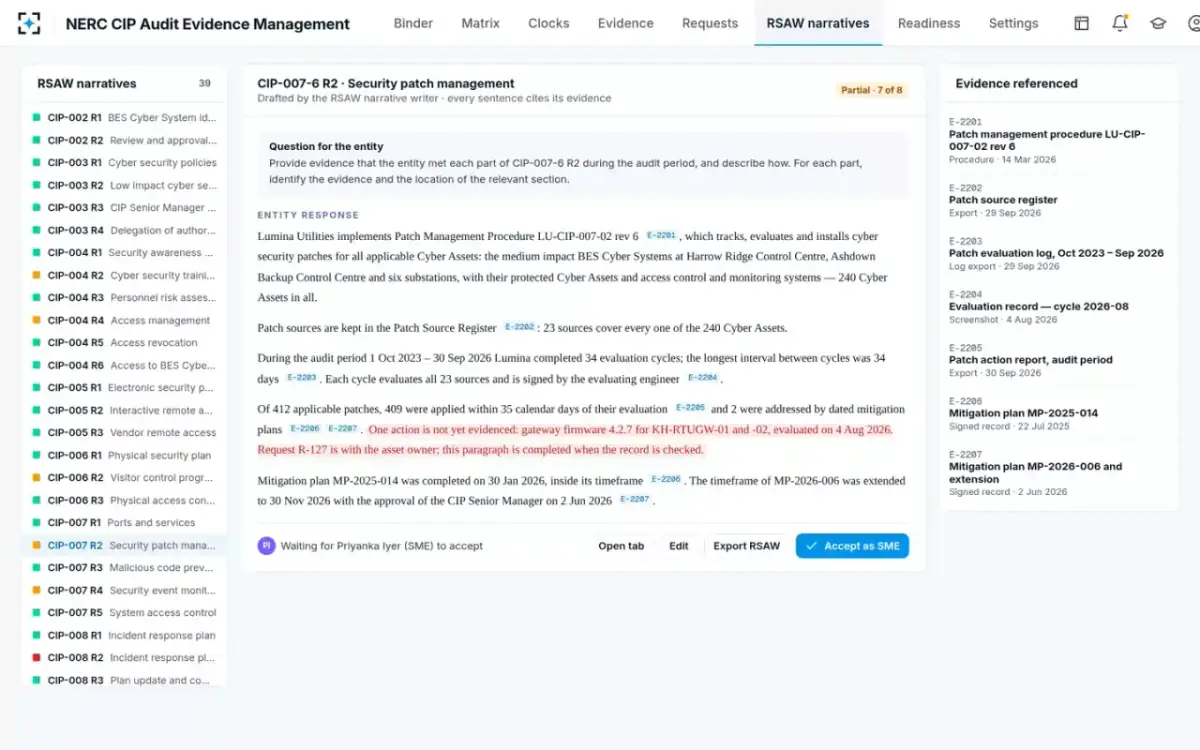

RSAW narrativesThe entity response for CIP-007-6 R2, each sentence citing its evidence, the unproven part marked, waiting for the SME.

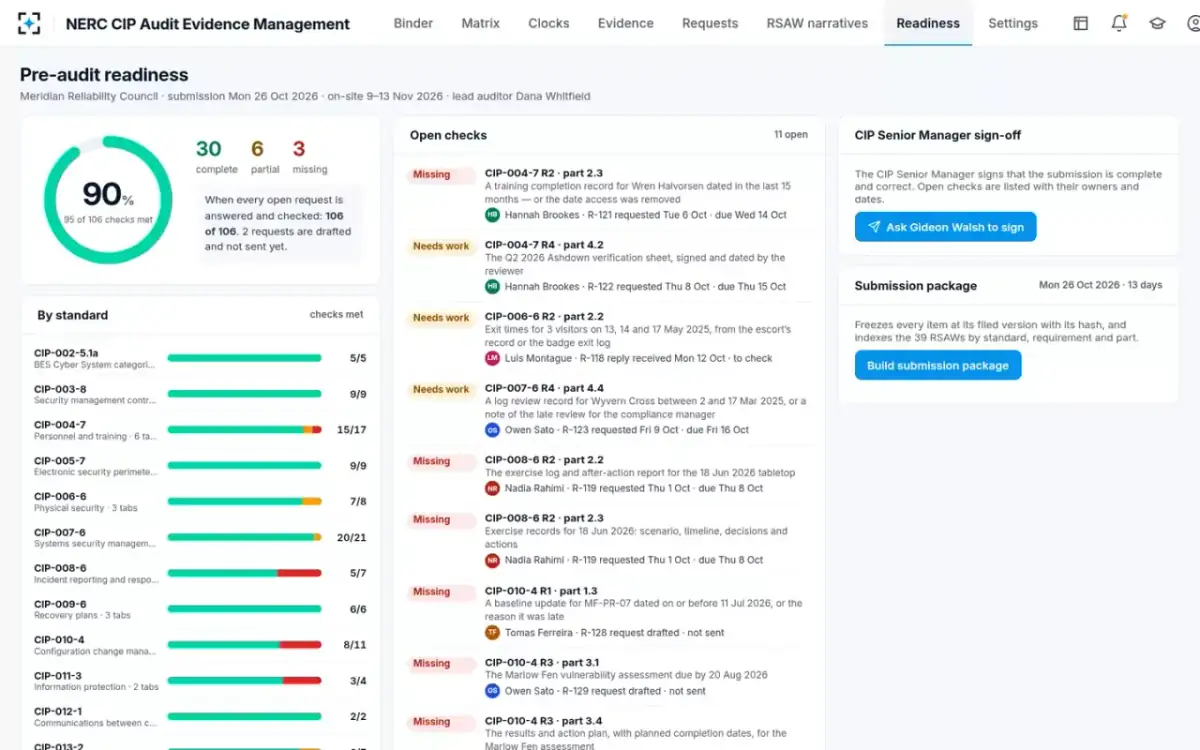

Pre-audit readinessThe readiness score, checks met by standard, each open check with its owner and request, and the CIP Senior Manager sign-off.

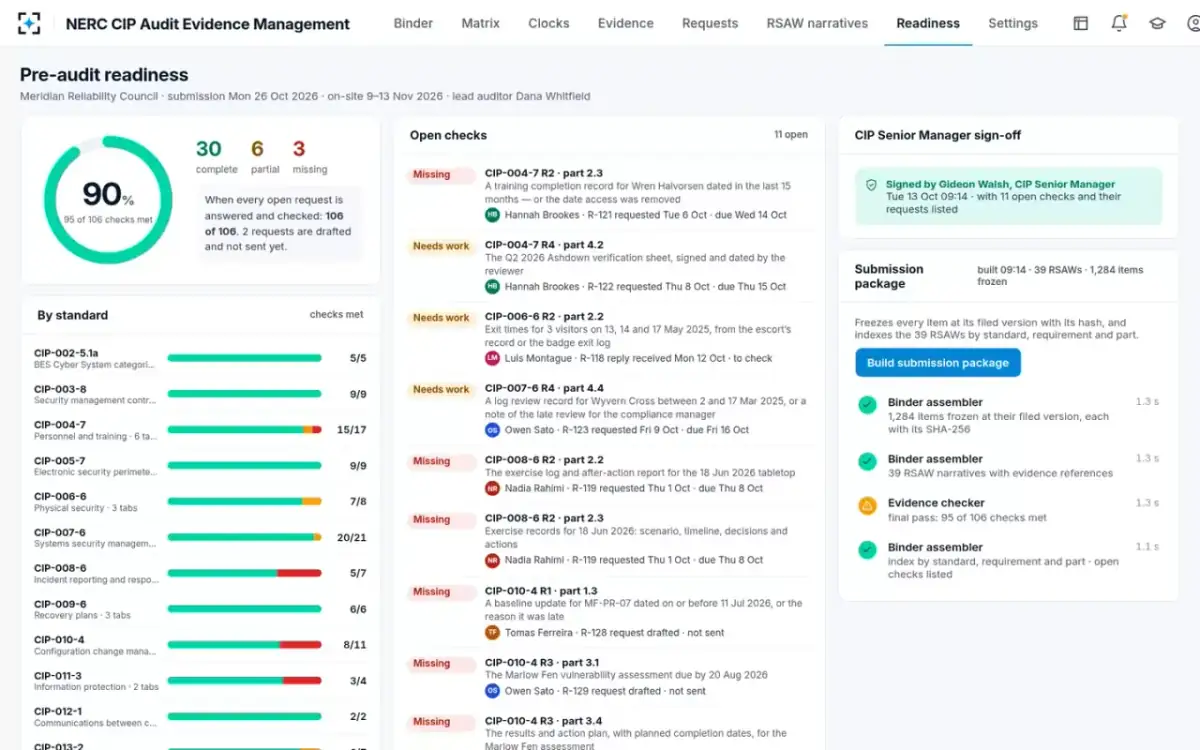

Signed and packagedSigned by the CIP Senior Manager with the open checks listed. 1,284 items are frozen with their hashes, and 39 RSAWs are indexed.

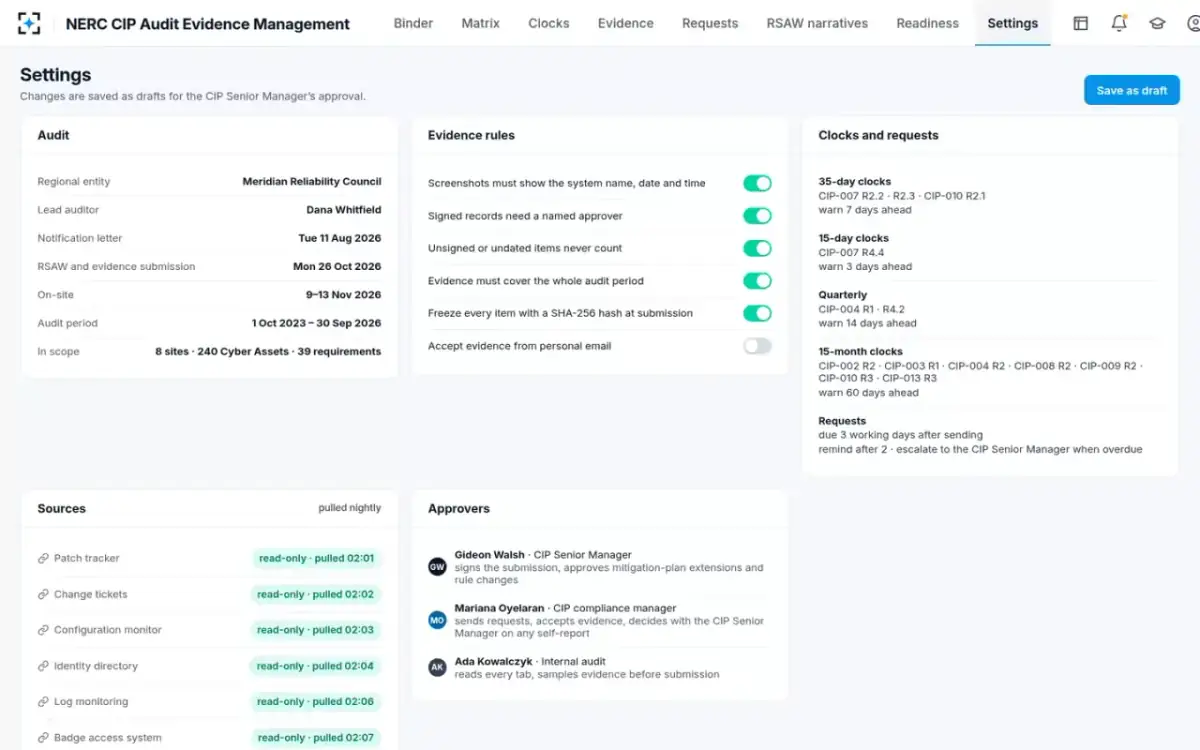

The audit settingsThe audit, the evidence rules, the clocks and requests, the read-only sources and the approvers.
Governance

Citations, hashes and human sign-off in CIP audit evidence

Every verdict cites its recordEach check names the evidence item and the phrase it meets. A phrase with nothing behind it is underlined in red and stamped “no record found”, and is not passed.
Unsigned or undated never countsScreenshots must show the system name, date and time. Signed records need a named approver. Evidence must cover the whole audit period, and evidence from personal email is not accepted.
Read-only sources, with items hashed and frozenThe agents are read-only on all ten source systems. Each item is hashed with SHA-256 when it is filed. It is frozen at that version in the submission package, so the auditor sees exactly what was checked.
People send, accept and signAgents draft requests and narratives. The compliance manager sends requests and accepts evidence, the SME accepts each narrative, and the CIP Senior Manager signs the submission.
Violations and self-reports are a human callNo agent decides whether a gap is a possible violation. The compliance manager and the CIP Senior Manager decide on any self-report. Overdue requests escalate to the CIP Senior Manager.
Rule changes wait for approval, and each step is on the trailA change to an evidence rule or clock is saved as a draft for the CIP Senior Manager's approval. Each agent run and each person's action is recorded with its time. That covers a request drafted, sent, answered or approved.
Configuration

Audit scope, evidence rules and clocks the CIP Senior Manager approves

The audit dates, the evidence rules, the clock warnings and the approvers are settings. Changes are saved as drafts for the CIP Senior Manager's approval.

SettingDefaultChoose from
Audit in scopeThe regional entity · 1 Oct 2023 to 30 Sep 2026Regional entity, lead auditor, notification letter, submission date, on-site week, audit period · 8 sites, 240 Cyber Assets, 39 requirements
Screenshots must show the system name, date and timeOnOn · Off
Signed records need a named approverOnOn · Off
Unsigned or undated items never countOnOn · Off
Freeze every item with a SHA-256 hash at submissionOnOn · Off
Accept evidence from personal emailOffOn · Off
Clock warnings7 days ahead for 35-day clocks · 3 for 15-day · 14 for quarterly · 60 for 15-monthSet per clock
RequestsDue 3 working days after sendingRemind after 2 · escalate to the CIP Senior Manager when overdue
Connections

Ten source systems the CIP evidence is filed from each night

CIP standards and RSAWsrequirement text for CIP-002 to CIP-013, RSAW templates, your procedures and the results of prior audits
Patch tracker and configuration monitorpatch sources, evaluation logs, baselines and 35-day monitoring runs
Change tickets and field work systempatch action reports, install records and work orders from outages
Identity directory, badge access and trainingaccess lists and verifications, visitor and badge logs, training completions
Log monitoring and firewall managerlog reviews every 15 days and firewall exports
Document librarypolicies, plans, signed records, mitigation plans and their extensions
What it changes

Gaps found before the auditor, missed patch cycles and audit-prep hours

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0
gaps left for the auditor to find, the design goal, because each requirement tab is checked against its own words each night
Each requirement tab
checked every night
demo
≈ $270k
of audit-prep effort avoided per audit, about 1,800 of 2,300 hours of collecting, sampling and writing, in the sample audit
By hand≈ 2,300 h
With agents≈ 500 h
target
1day
to see a missed 35-day patch cycle, so the gateway is patched in time instead of found at the next audit
Seen on day 1
of a 35-day clock

“demo” means seen in the working solution, on its sample audit data. “target” means the design goal, measured in the live solution. “estimated” means our estimate. The ≈ $270k is 39 requirements × ≈ 60 h from the last audit cycle, or ≈ 2,300 h. Of that, ≈ 1,800 h is avoided, priced at a blended $150/h for staff and consultant mock-audit time. The split of hours by task is estimated the same way. “typical” means published figures. SecurityWeek and Utility Dive reported a 2019 settlement of 127 CIP violations for $10M. The Relia Magazine CIP guide puts the cost to stand up a Medium Impact program at ≈ $379k. Regulatory context: NERC CIP-002 to CIP-013 requirement text. CIP-007-6 R2 requires a patch evaluation at least once every 35 calendar days, and action within 35 calendar days of the evaluation. Names on the screens are sample data.

Questions

NERC CIP audit evidence management questions from compliance teams

What is NERC CIP audit evidence management software?

It is software that keeps the evidence for each CIP requirement in one binder, filed as it is produced. A Medium Impact entity can then show the regional entity it met each requirement across the audit period. NERC CIP Audit Evidence Management adds six agents. They read each record against the requirement's own words, name each gap and draft the request and the RSAW narrative. People send, accept and sign.

How does it check evidence against the RSAW?

The requirement reader turns each requirement into one check per testable phrase. A check covers the clock, the scope, the sign-off or the record. The evidence checker then reads each item against its phrase. It checks the date to the day, the assets in scope, the signature and coverage of the audit period. On CIP-007-6 R2 that is eight checks, each with its evidence and a verdict.

How does it catch a missed 35-day patch cycle?

The binder is checked each night. The obligation clocks show each 35-day, 15-day, quarterly and 15-month deadline for the audit period. A miss shows the day after its clock runs out, well before the audit. In the sample binder, the gateway firmware action due in early September shows as missed. A request to the asset owner is already drafted.

Does it change anything in our source systems?

No. The evidence collector is read-only on all ten sources. They are the patch tracker, change tickets, configuration monitor, identity directory, log monitoring, badge access, training, firewall manager, field work and the document library. Each item is hashed with SHA-256 when it is filed. It is frozen at its filed version when the submission package is built.

Does it decide whether a gap is a violation?

No. The gap finder names what is missing, for which assets and dates. It does not judge a possible violation. The compliance manager and the CIP Senior Manager decide on any self-report.

Can an agent send a request or sign the submission?

No. Agents draft requests and narratives, but they do not send or sign. The compliance manager sends requests and accepts evidence. Each SME accepts the narrative for their requirement, and internal audit samples evidence before submission. The CIP Senior Manager signs. Changes to evidence rules stay drafts until the CIP Senior Manager approves them.

Can we set our own evidence rules and clocks?

Yes. The audit dates and scope are settings, and so are the evidence rules. They cover screenshots with system name, date and time, named approvers, whole-period coverage, hashing at submission and whether personal email is accepted. The warning days for each clock, the request due date, reminders, escalation and the approvers are settings too.

What do we hand over to build the first binder?

Send your RSAWs, CIP procedures, source system exports and prior audit results. The Agentic Solution Engine builds and deploys the solution from those documents. It goes live once each quality gate has passed. We will walk you through it on the evidence from your last audit first.

Read your last audit's evidence
against the RSAW, tab by tab.

We'll run NERC CIP Audit Evidence Management on the RSAWs and evidence from your last audit.
