Maintenance knowledge search for utilities: describe a fault in plain words, get a cited fix recipe from the manuals, procedures and past jobs

See one case, screen by screen ↓
Watch with transcript →

Built forMaintenance engineersTechniciansReliability engineersNew engineers

The Problem Today

Engineers hunt through manuals, bulletins and old work orders, or phone a retiring expert, and too often fit the wrong part.

20–40%
of technicians' time spent looking up maintenance information published
33–50%
of the utility workforce eligible to retire in 5–10 years published

Searched one by one

  • Manuals
  • Bulletins
  • Job notes
  • Experts
  • The expensive part fittedA costly motor changed when a cheap kit was the fix
  • Years to learn rare faultsMostly by meeting them beside someone who has

The Solution

  1. Describe the faultIn plain words; the asset, model and latest alarms are read for you
  2. Manuals and past jobs readEach passage with revision and page, and each closing note read
  3. The fix that held, firstThe field fix beside the manual, with how often each fix came back
  4. The engineer signs the noteReadings checked against the manual; the closing note drafted from them

Built-in controls

  • Safety steps locked to the procedure
  • A reliability engineer decides what becomes standard
  • Each question and decision on the record

What You Get

Fewer repeat jobs and second outages, and more know-how kept when experts retire.

  • New engineers work alone soonerRare faults answered with the notes of those who met them
  • The right part reservedStock code, depot and bin found for the kit
  • Experts asked before they goQuestions drafted from the gaps in a retiring expert's notes
In short

What is Maintenance Knowledge Search?

Maintenance knowledge search lets maintenance engineers ask about a fault in plain words and get an answer drawn from OEM manuals, maintenance procedures, standards and past work orders. Maintenance Knowledge Search answers with a fix recipe: matched symptoms, numbered steps each cited to its source, tools, and parts with stock codes, led by the fix that stopped the fault coming back.

How to choose AI solutions for utilities →

Updated

The problem

Maintenance knowledge leaves with the expert, and the same fault comes back

An alarm raises a corrective work order, and the engineer on call gets an asset number and an alarm text. The answer is out there, but in pieces: the manufacturer's manual is a 300-page PDF, the service bulletin that amends it is filed somewhere else, the safety procedure sits in the document system, and the fix that actually works is a three-line closing note in a work order written by a fitter who has since retired. Failure codes are optional and inconsistent, so no search groups tens of thousands of free-text notes like “seal gone” or “pump died”.

So the engineer follows the manual's fault table, or swaps the most expensive part to be sure. The fault comes back within weeks, a crew goes out again and the same transformer is off automatic voltage control twice. Meanwhile the people who know are leaving: new engineers can take up to three years to work on their own, mainly because rare faults are learned by meeting them beside someone who has seen them.

typical33–50%of the utility workforce eligible to retire in the next 5–10 years
typical21%of water utility staff can retire within 5 years
typical20–40%of technicians' time spent consulting maintenance information
Where an engineer's year of looking things up goesestimated
By hand50 days
With the solution14.5 days
  • Finding the right manual, revision and section14 → 4 d
  • Checking for bulletins newer than the manual4 → 0.5 d
  • Searching past work orders and closing notes12 → 3 d
  • Phoning around for someone who has seen the fault8 → 3 d
  • Finding parts, stock codes and depot stock6 → 1 d
  • Writing up closing notes6 → 3 d

Estimated split of one maintenance engineer's working days a year spent finding information, by hand and with the solution: about 50 of 220 days by hand, inside the published 20–40 % of time technicians spend consulting maintenance information.

How it works

A fault in plain words, searched across manuals and maintenance history

What comes in
Sources inThe whole library · manuals, procedures, standards, work orders
Agents at work
Fault readerasset, model, symptoms
Then
Manual and procedure searcher
Work history miner
Then
Fix recipe writersteps + field fix
Parts and tools checker
Then
Knowledge stewardnotes and field fixes
A person decides
Maintenance engineerdoes the job, decides
What comes out
Cited fix recipe
Parts reserved
Signed job note
One case, step by step

A stuck tap changer, a retired fitter's note and a fix the fleet now uses

On a set Tuesday at 06:42, SCADA at one of the sample utility's 132/33 kV primary substations raises “T2 OLTC: tap change incomplete”, then “Motor protection tripped”. The on-load tap changer on transformer T2 is at 184,212 operations, resting between taps 9 and 10. The engineer on call, two years in the job, has not met this fault before. The fitter who had met it retired last year. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 0106:58

    The fault, in plain words

    Maintenance engineer, substations

    The engineer types what is in front of them: “OLTC stuck between taps, T2, motor breaker tripped”. The open job and the 06:42 alarm are already on the question bar. The run log shows the agents at work: the tap changer manual, rev 7, read at its fault-finding, hand-operation and drive-shaft sections; 186,400 work orders and 1,240 root-cause reports searched; the safety steps locked to the substation procedure.

    Manual and procedure searcher: “found a newer service bulletin: coupling wear past 150,000 operations, not in the manual's table”

  2. 029.4 seconds later

    A six-step fix recipe, each step cited

    Fix recipe writer

    Five agents, 8 steps, 6 documents, 14 past jobs. The answer opens with the symptoms it matched (tap change incomplete alarm, motor protection Q1 tripped, indicator between taps 9 and 10, past 150,000 operations), then six numbered steps, each with its source. Beside it, Manual says · Field says: the manual's fault table points to the motor; the field record says check the coupling first, test the motor, and leave it if it passes.

    What was done, and did it hold? Coupling replaced: 0 of 9 came back. Motor replaced: 2 of 3 came back.

  3. 03Step 4

    The retired fitter's note, in the step where it matters

    Senior substation fitter, retired

    Step 4 says inspect the vertical drive-shaft coupling, gearbox end first, for a sheared nylon insert or a missing shear pin. On drives of this model past 150,000 operations this is the usual cause, which is why it comes before any motor change. The retired fitter's job note from an earlier job on this same transformer is pinned to the step. The safety steps, 1 and 6, are quoted from the substation procedure and the Safety Rules, not rewritten.

    Job note on this unit, four years and eight months earlier: “Replace the drive-shaft coupling, not the motor. Motor tests fine every time, it's the coupling insert shearing. Check the gearbox end first.”

  4. 04Why not the motor

    Fourteen jobs, read from the technicians' own words

    Work history miner

    The work history miner read each closing note on record for this tap changer model and symptom, and grouped them by the fix actually done: coupling replaced 9 times, 0 repeats in 90 days; motor replaced 3 times, 2 repeats in 30 days. On two units the new motor was back in 9 and 11 days, and both times the next job found the coupling insert sheared. On a third the motor winding really was open circuit, so step 3 still tests the motor.

    A later job, after the fitter retired: “Took two calls to find someone who knew. Coupling insert. Replaced the kit.”

  5. 0507:05

    The right part reserved, the expensive one left on the shelf

    Parts and tools checker

    The parts list shows the coupling insert kit at $110, 4 in stock at the nearest depot with its bin, and the shear pin, 12 in stock. The $6,200 drive motor is marked not needed. The engineer reserves the kit against the open job; three past jobs where this fix worked sit underneath, each done in about two hours.

    Parts and tools checker: reserves only when the engineer asks, and does not order.

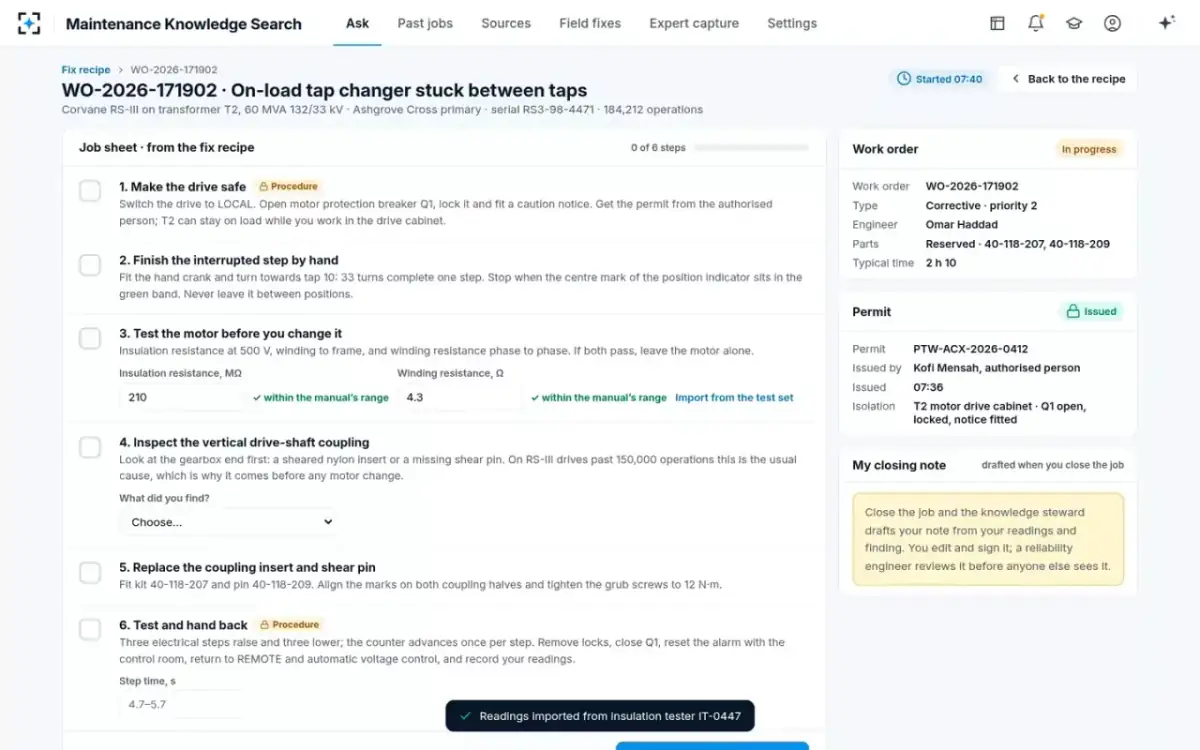

  6. 0607:40

    The recipe becomes the job sheet

    Maintenance engineer, with the authorized person

    The authorized person issued the permit at 07:36: T2 motor drive cabinet, Q1 open, locked, notice fitted. The engineer works through the recipe as a checklist. Motor readings come in from the insulation tester (210 MΩ and 4.3 Ω), and each is checked against the manual's range as it lands. Motor good, so the motor stays.

    “✓ within the manual's range” · insulation resistance > 20 MΩ, winding 4.1–4.6 Ω

  7. 0709:52

    Back on automatic voltage control, and the note writes itself from the readings

    Knowledge steward

    Coupling insert sheared at the bevel gearbox end; insert and shear pin replaced, grub screws at 12 N·m, step time 5.1 s. T2 is back on REMOTE and automatic voltage control at 09:52, 2 h 12 after the job started. When the engineer closes the job, the knowledge steward drafts the closing note from the readings and finding and links it to the fitter's earlier job on this unit. The note is the engineer's to edit and sign.

    Drafted note: “Second coupling failure on this unit in 4 years and 8 months: suggest a coupling check at each tap changer maintenance on units of this model past 150,000 operations.”

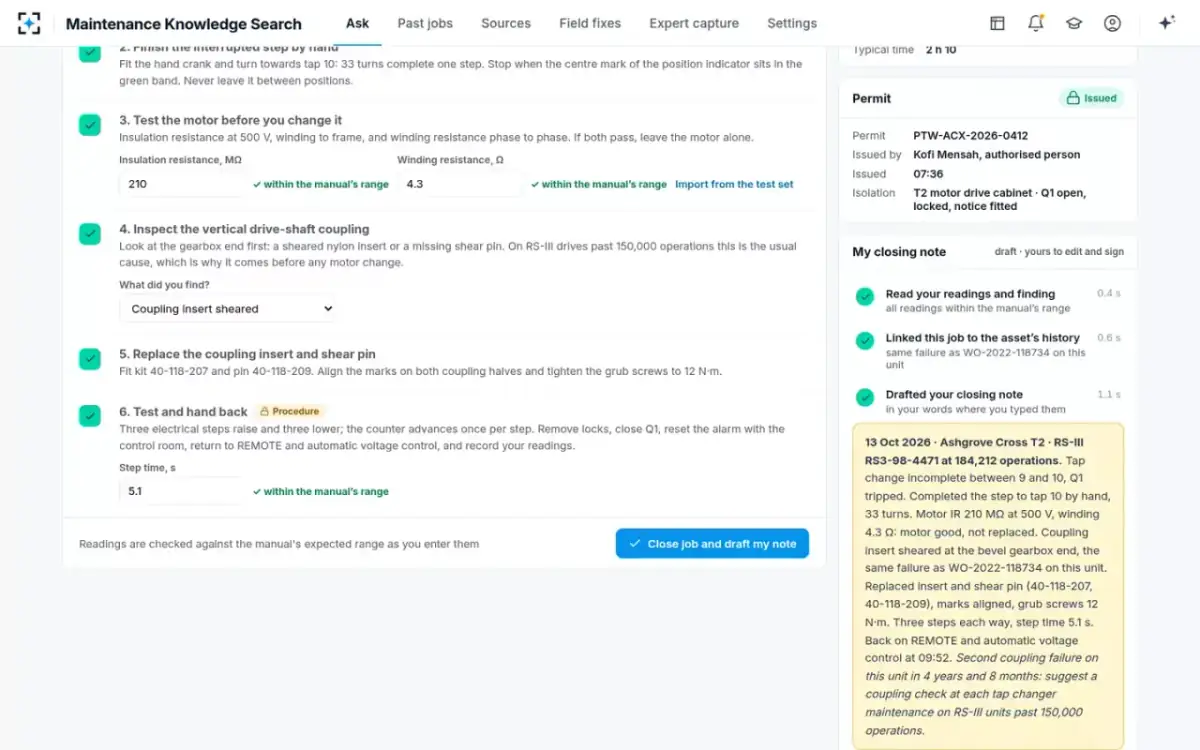

  8. 08Signed 09:58

    No note reaches anyone else until a reliability engineer reads it

    Reliability engineer, network assets

    The engineer signs and the note goes to Field fixes, waiting for the reliability engineer. Beside it, the knowledge steward suggests adding this job to the model's field fix as its 10th coupling job. The reliability engineer can publish the note or ask the engineer a question first, and publishes it.

    “Nothing changes in an answer until a reliability engineer approves it.”

  9. 0914:20

    Field-proven, for each unit of this model past 150,000 operations

    Reliability engineer

    The proposal puts the answer today, which follows the manual's table, beside the proposed recipe, with the evidence: at least 3 jobs with the same fix (9); none back within 90 days (0 of 9); consistent with the newer service bulletin; safety steps unchanged, quoted from the substation procedure. It changes the answer for 12 assets. The reliability engineer approves it as field-proven, and could instead have asked the manufacturer to confirm, or rejected it with a reason.

    “Approved by the reliability engineer at 14:20. Answers now lead with this fix.”

  10. 10Before the next one leaves

    Ask the next expert now, while they are still here

    Senior process technician, water treatment works

    A senior process technician retires in 66 days after 34 years on dosing, filters and pumps; 41 % of the technician's 1,412 jobs have a usable note. The coverage map shows where the knowledge is written down and where it is not: filters at 29 %. The knowledge steward drafted questions from the gaps for the next session, such as what “as before” means on 9 high-lift pump 2 vibration jobs.

    Session 1 · 47 minutes: 5 notes drafted from the recording; the technician has signed 3.

Who it’s for

Maintenance knowledge from the engineer on call to the retiring expert

The same tap changer for the five people around it: their day before, and their day now.

Maintenance engineer, substations
On call for 23 primary substations
Before
Two years in, most faults are new, and the person who knew has retired. The manual says change the motor, and someone must have seen this before.
Now
Describes the fault and gets a six-step recipe with the retired fitter's note in the step that matters, parts by stock code and readings checked as they are taken.
Reliability engineer, network assets
Decides which field fixes become standard
Before
Reviews repeat failures and decides which field fixes become standard, and needs to know which fix stopped the fault coming back, beyond which one was tried.
Now
Gets field fixes proposed with the jobs, the repeats and the bulletin behind them, and approves, rejects or asks the manufacturer from one screen.
Authorized person
Issues permits and checks isolations
Before
Issues permits and checks isolations, and holds that the safety steps come from the procedure, with no improvising.
Now
Sees the safety steps quoted word for word from the substation procedure and the Safety Rules, with the permit and isolation on the job sheet.
Senior process technician, water treatment
Retiring expert, 34 years on site
Before
Thirty-four years on dosing, filters and pumps, and half of it is written nowhere. Wants to be asked now, while still here.
Now
Answers questions drafted from the gaps in the technician's own record, and checks and signs each note drafted from the sessions.
Retired substation fitter
Retired after 39 years
Before
Closed 2,930 jobs in 39 years and wrote short, exact notes. After the retirement, the next engineer took two calls to find someone who knew. The fitter's view: it is rarely the motor, and usually the coupling.
Now
89 % of the fitter's jobs have a usable note, and those notes are cited in 212 answers a month.
The agents

Fault reader, history miner and recipe writer behind each answer

Manuals, procedures and past jobs are searched by six agents; the engineer decides what to fix, a reliability engineer what becomes standard.

Fault reader

Reads the engineer's question, the open work order and the latest alarms; finds the asset, the site, the equipment model and serial, and lists the symptoms in plain words.

  • Never guesses an asset
  • Asks which one when two assets match
Manual and procedure searcher

Searches manufacturer manuals, service bulletins, the utility's procedures, safety rules and standards for this model and fault, and returns each passage with document, revision, section and page.

  • Cites document, revision, section and page
  • Prefers a bulletin over the manual revision it amends, and says so
  • Never cites a superseded revision without saying so
Work history miner

Finds corrective jobs on the same model with the same symptoms, reads each closing note, groups them by the fix actually done in the technician's words, and links repeats on the same asset to count which fixes held.

  • Never counts a job without a closing note as a success
  • The repeat window comes from Settings
Fix recipe writer

Writes the numbered fix recipe (symptoms, steps, tools and parts) and puts the field fix beside the manufacturer's procedure with the outcomes of each past fix.

  • Quotes safety steps from the procedure word for word; never removes, reorders or rewrites one
  • Never shows a step without a source
Parts and tools checker

Maps the parts to stock codes, depot stock and bins from a stores feed refreshed every 15 minutes, and lists the tools and test equipment for the job.

  • Reserves only when the engineer asks
  • Never orders
Knowledge steward

Drafts the closing note from the engineer's readings and finding, proposes a field-proven fix to a reliability engineer when the evidence meets the rule, and drafts questions for experts before they retire.

  • Never publishes a note or a fix without a reliability engineer
  • The engineer edits and signs the note
Reliability engineer

Approves what becomes standard.

Ask in plain words

Follow-ups in plain words, answered from manuals and job notes

Ask a follow-up in plain words, or ask for something to be done. Each answer names its sources.

Why does the recipe say not to replace the motor?

Because on this tap changer model the motor is rarely the fault. Of 14 jobs with this symptom on record, the motor was replaced 3 times and the fault came back within 30 days on 2 of them. The coupling was replaced 9 times and none came back within 90 days. The newer service bulletin says coupling inserts wear past 150,000 operations; T2 is at 184,212. The recipe still tests the motor: on one unit the winding really was open circuit.

Which other units of this model are past 150,000 operations?

Twelve of the utility's 38 units of this model, including T2: T2 at 184,212, then units at 176,940, 171,300 and 168,450, and 8 more from 151,200 upwards. Three have had the coupling replaced already. The field fix waiting for the reliability engineer would put the coupling check first for all twelve.

Reserve the coupling kit for this job

Reserved against the open job at the nearest depot: 1 × coupling insert kit, 3 left; 1 × shear pin, 11 left. Nothing has been ordered: stores re-orders the kit when stock reaches 2.

What did the retired fitter write about this tap changer?

The fitter closed 31 jobs on drives of this model, and the notes are short and exact. On this fault the same thing was written four times: the coupling, not the motor. After the retirement, the next job took “two calls to find someone who knew”. That note now sits in step 4 of the recipe.

The screens

The fix recipe, the job sheet, field fixes and expert capture

From the working solution, on its sample data. Pick one to see it large.

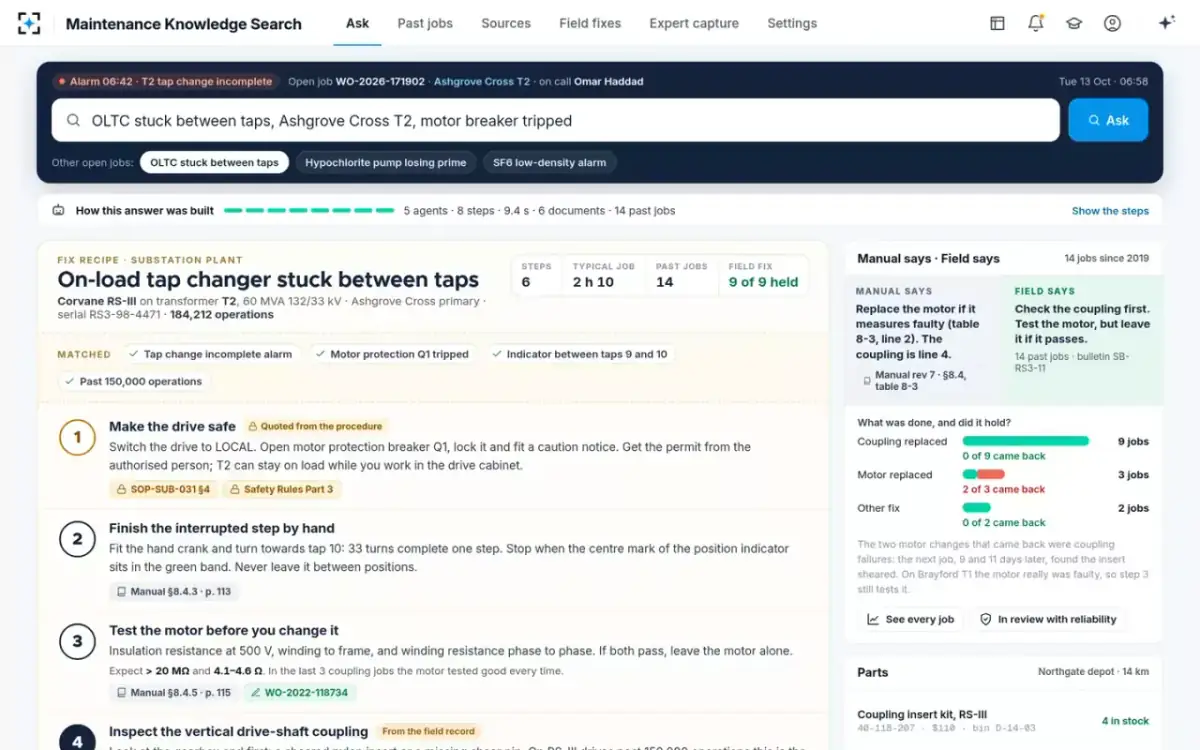

The fix recipeThe open job and alarm on the question bar, the six-step recipe with its matched symptoms, and Manual says · Field says with what held.
How the answer is builtThe agents at work: asset found, manual and newer bulletin read, 186,400 work orders searched, safety steps locked to the procedure, stock checked.

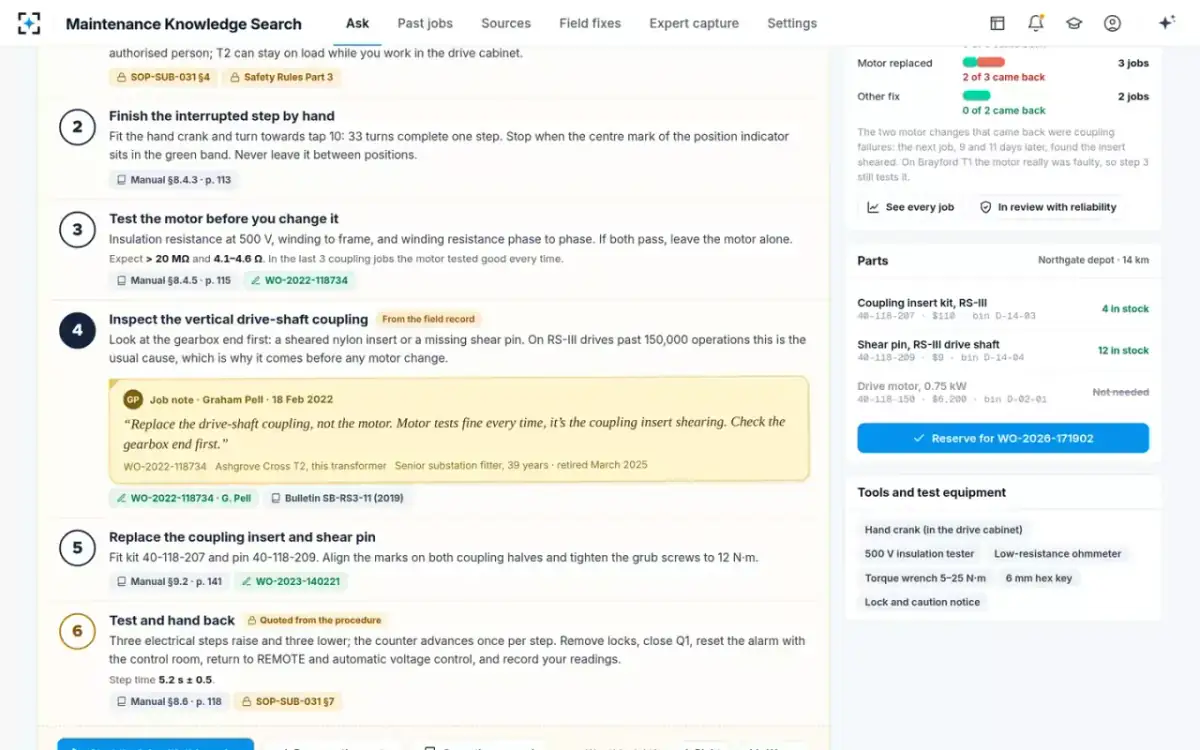

The field note in the stepStep 4 with the retired fitter's job note pinned to it, safety steps quoted from the procedure, and the parts with stock codes and depot stock.

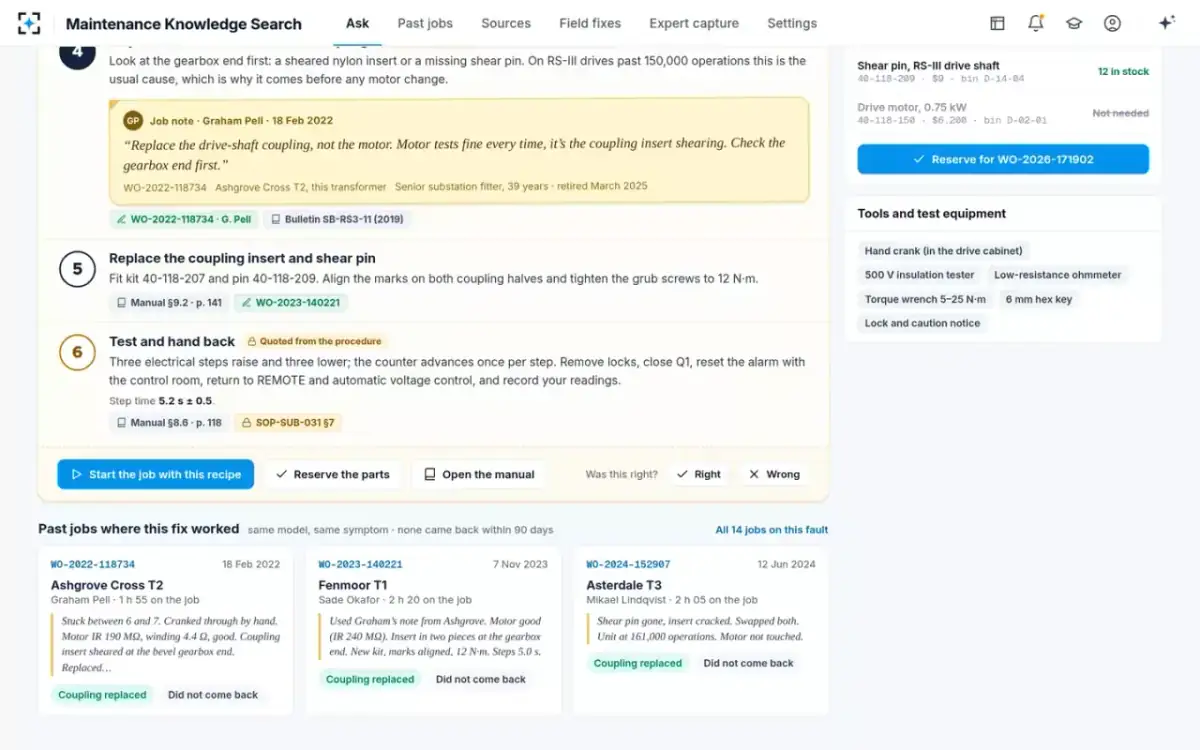

Past jobs where this fix workedThree jobs on the same model and symptom (where, when, who, how long and what was found), none back within 90 days.

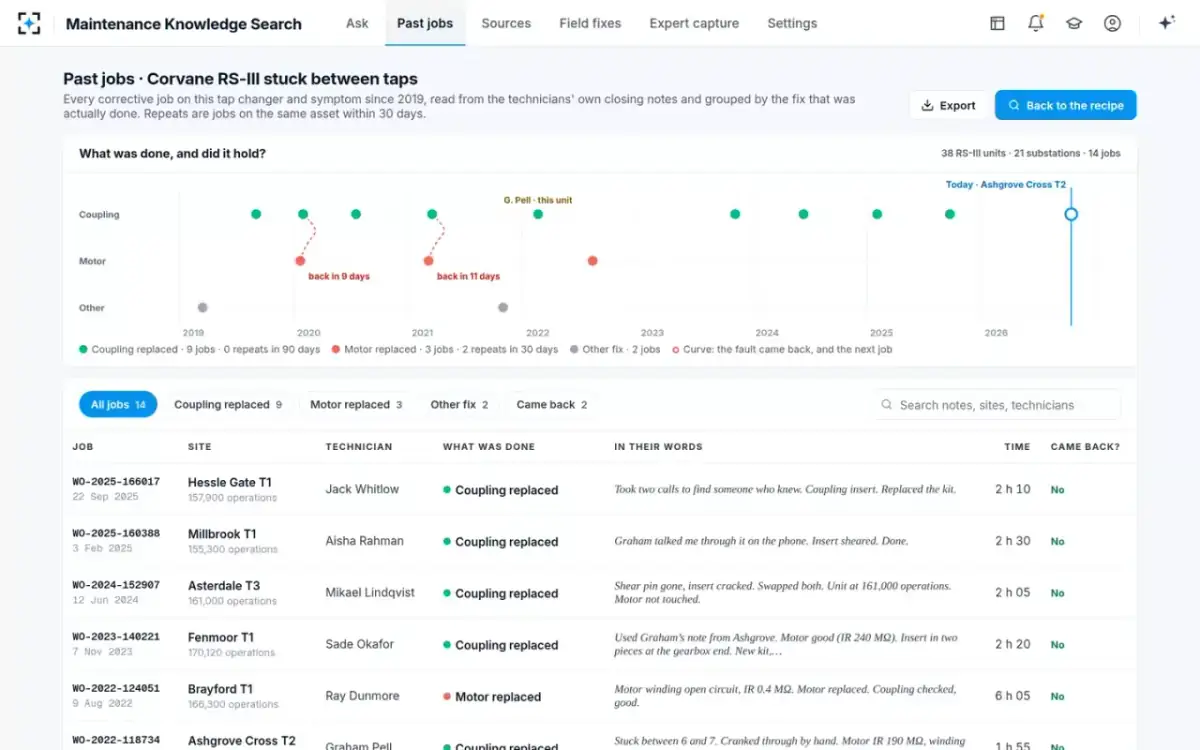

Past jobsEach job on record for this tap changer and symptom, grouped by the fix actually done, with repeats linked and the technicians' own words.
The job sheetThe recipe as a checklist, the permit and isolation, and readings checked against the manual's range as they come in.
The closing noteEach step done, and the closing note drafted from the engineer's readings and finding, for the engineer to edit and sign.

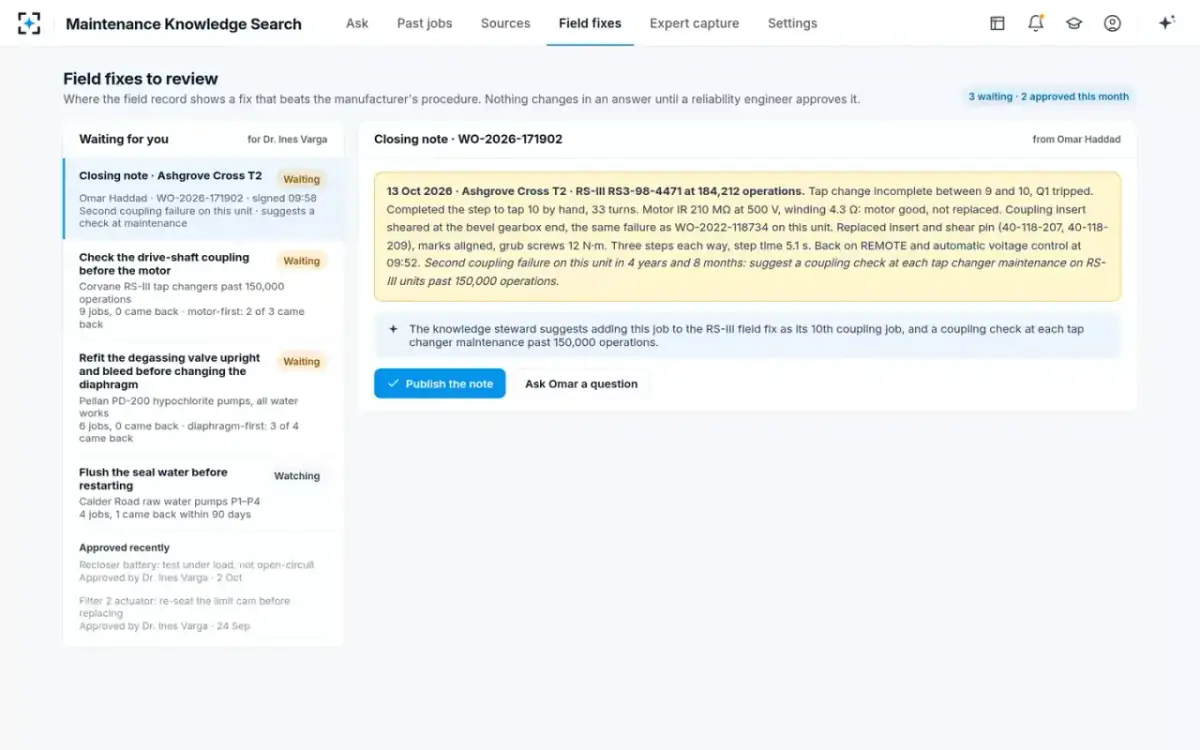

Notes to reviewA signed closing note waiting for the reliability engineer, with the suggestion to add it to the field fix.

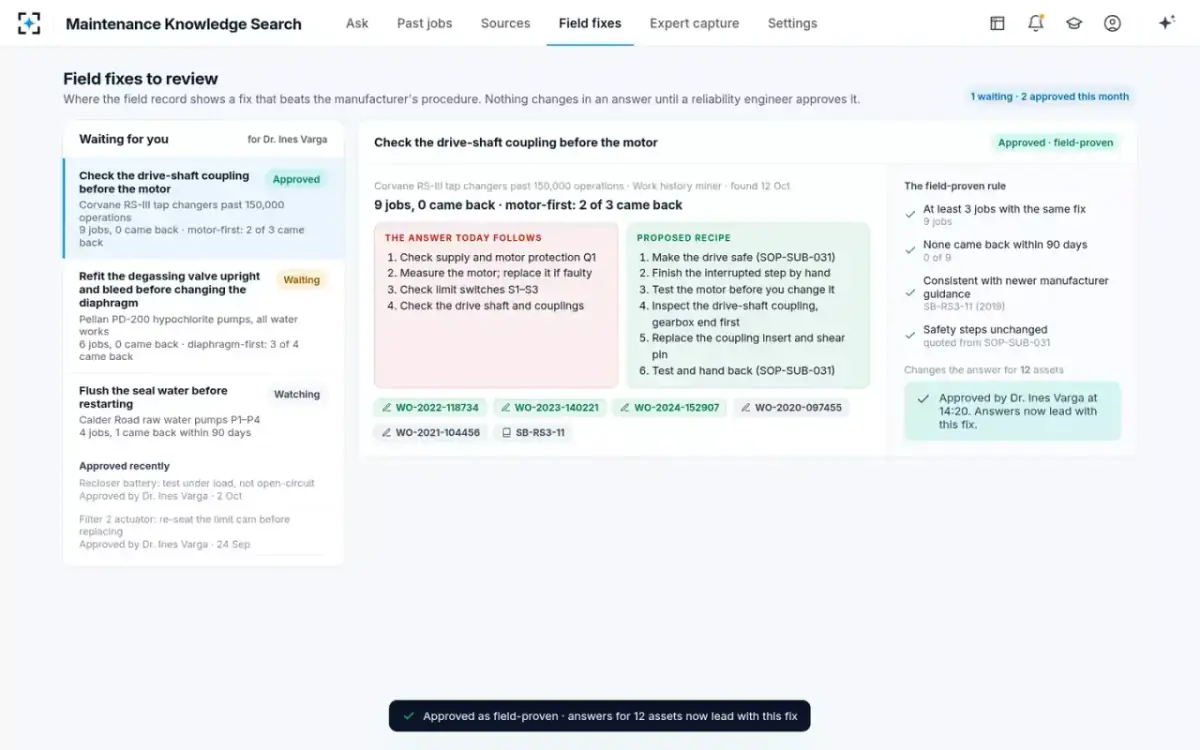

Field fixesThe answer today beside the proposed recipe, the evidence against the field-proven rule, and the approval that changes the answer for 12 assets.

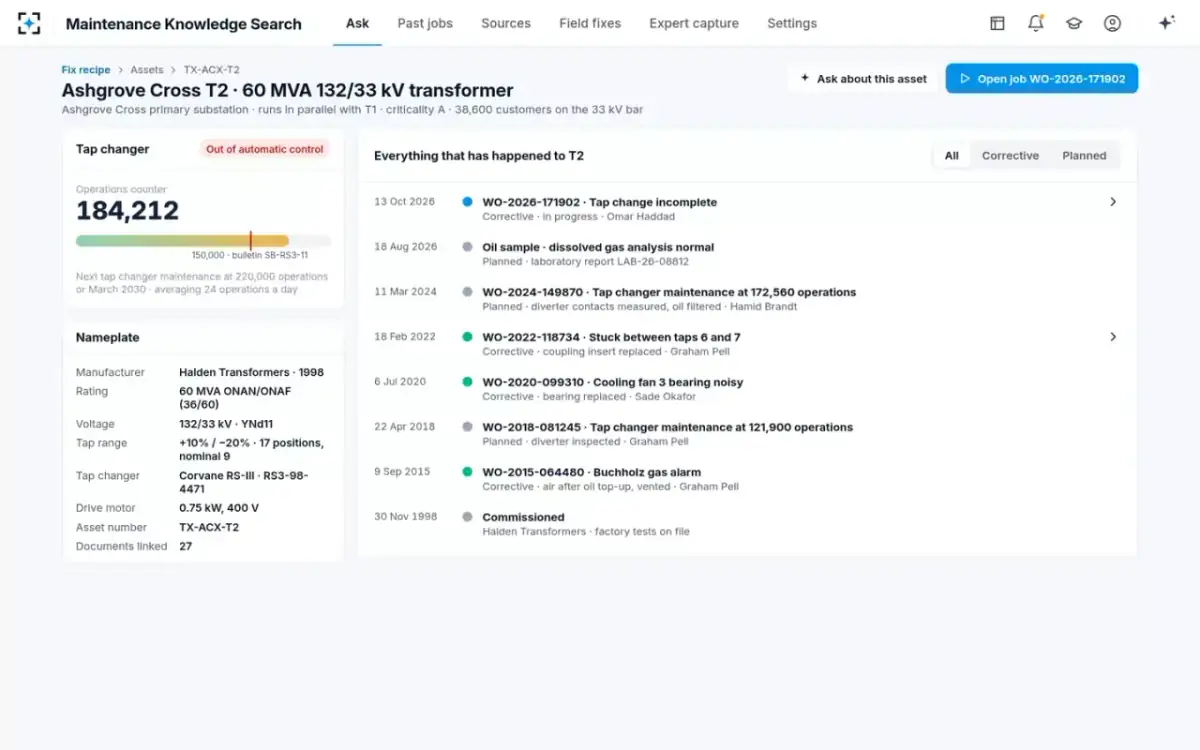

The assetThe transformer: the tap changer's operation counter, the nameplate and everything that has happened to it since installation.

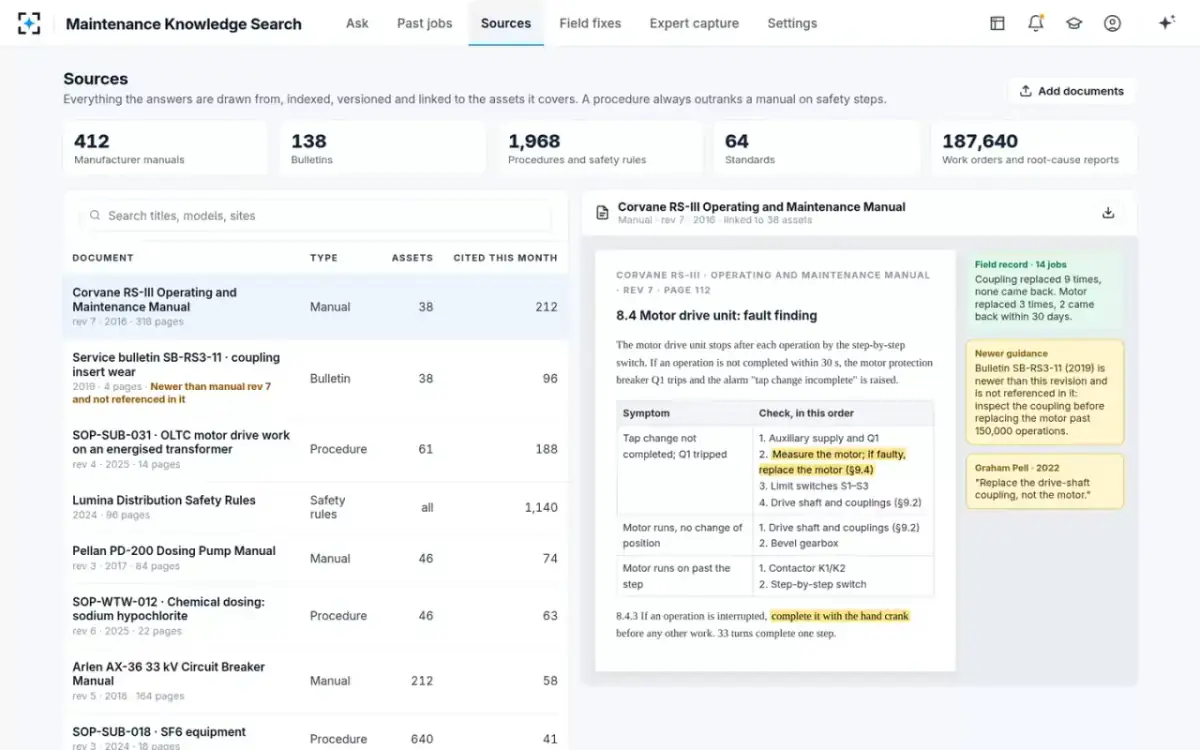

SourcesManuals, bulletins, procedures, standards and work orders, with the cited manual page open beside the field record and the newer bulletin.

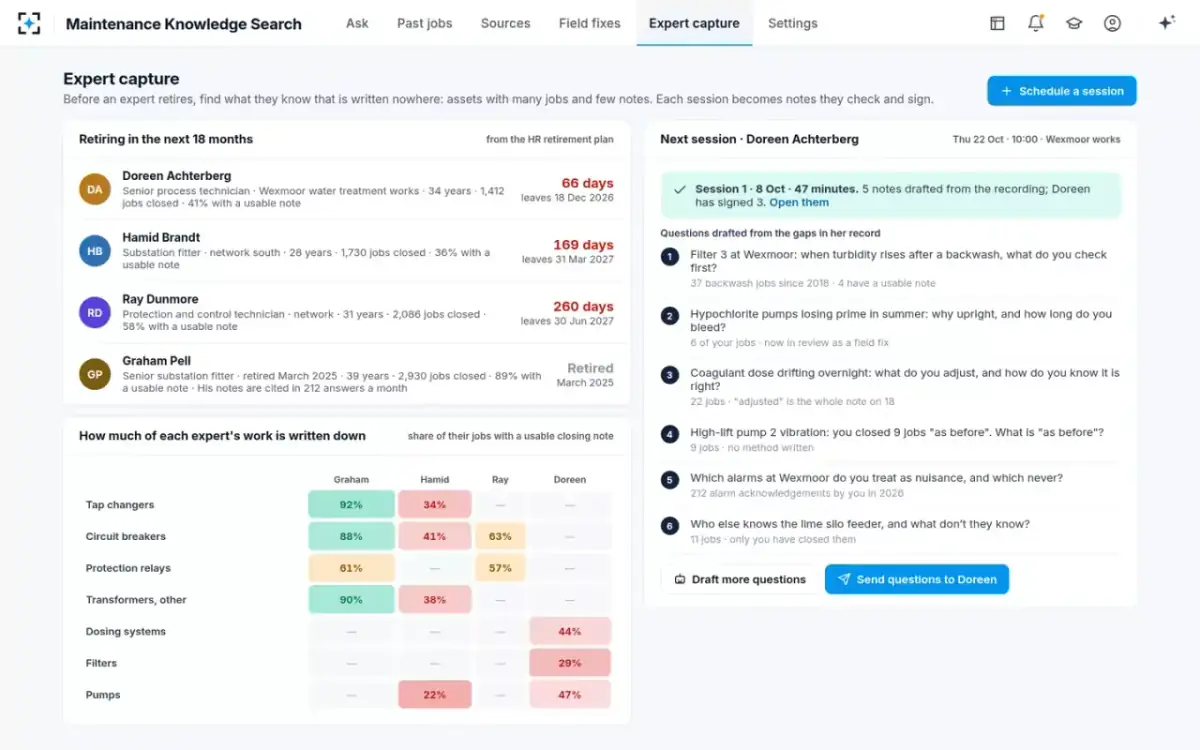

Expert captureExperts retiring in the next 18 months, how much of their work is written down, and questions drafted from the gaps.
The source rulesThe order sources are trusted in, the field-proven rule, who approves, and how answers are built.
Governance

Locked safety steps and signed notes in maintenance knowledge search

Each step cites its sourceEach step names its document, revision, section and page, or its work order and author, and opens at the cited passage. A step without a source is not shown.
Safety steps are locked to the procedureSafety rules and procedures are always trusted first and quoted word for word. Only the procedure owner can change a safety step; the agents cannot remove, reorder or rewrite one.
A person decides what becomes standardA field fix needs at least 3 jobs with the same fix, none back within 90 days, and a reliability engineer's approval, with the evidence attached. The manufacturer can be asked to confirm from the same screen.
The engineer signs the noteThe knowledge steward drafts the closing note from the readings; the engineer edits and signs it, and a reliability engineer reviews it before anyone else sees it.
What the agents may not doThey reserve parts only when asked and do not order, change a work order's status, change a safety step or publish a fix. Protection settings are shown only to authorized protection staff.
Each question and decision on the recordEach question, answer, part reserved, note drafted and approval is recorded with who did it, person or agent, and when.
Configuration

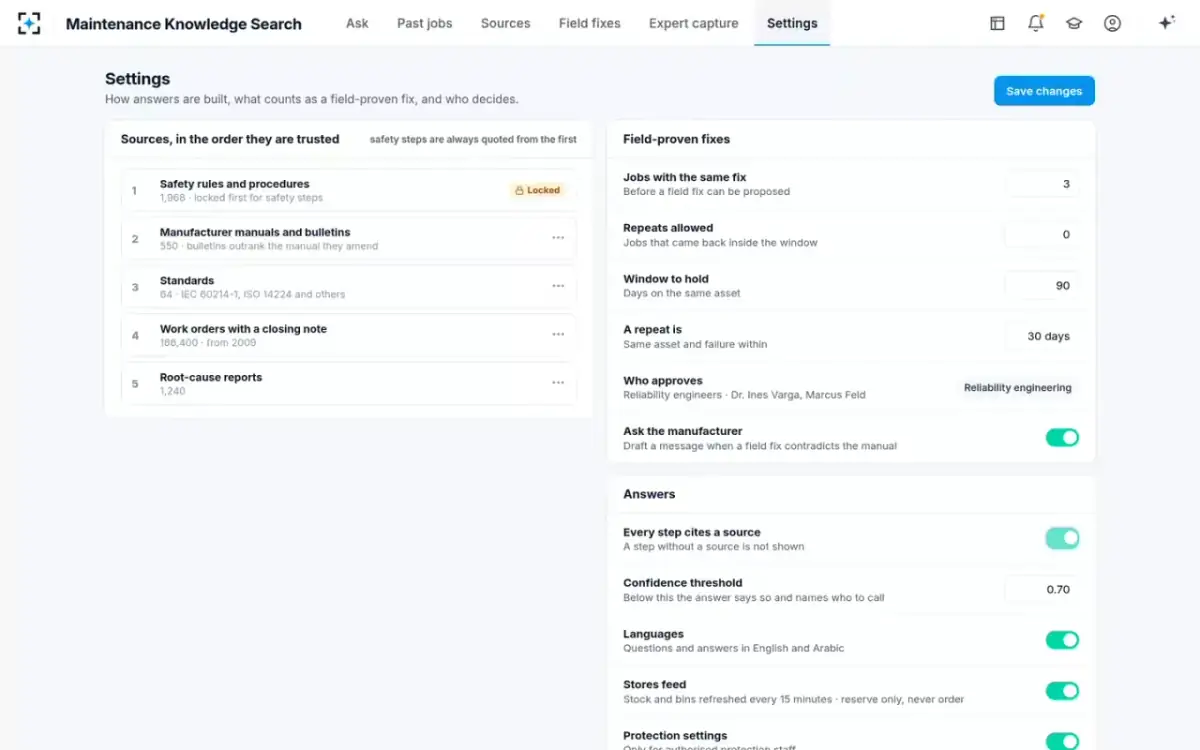

Trusted sources and the field-proven rule behind each maintenance answer

Which sources are trusted first, what counts as a field-proven fix and who decides are settings, chosen by reliability engineering.

SettingDefaultChoose from
Sources, in the order they are trustedSafety rules and procedures first — lockedthen manufacturer manuals and bulletins, standards, work orders with a closing note, root-cause reports; bulletins outrank the manual they amend
Jobs with the same fix before a field fix can be proposed3Before a field fix can be proposed
Repeats allowed, and the window to hold0 within 90 daysJobs that came back inside the window, on the same asset
A repeat is30 daysThe same asset and failure within this window
Who approves field fixesReliability engineeringReliability engineers · two named engineers
Ask the manufacturerOnOn · Off — drafts a message when a field fix contradicts the manual
Confidence threshold0.70Below it the answer says so and names who to call
Stores feedOnStock and bins refreshed every 15 minutes · reserve only, never order
Connections

Manuals, bulletins, procedures and work orders the search reads

OEM manuals and service bulletinseach revision, linked to the assets it covers; bulletins newer than their manual flagged
Maintenance procedures and safety rulesSOPs and the utility's safety rules, trusted first for each safety step
Standardssuch as IEC 60214-1 for tap changers and ISO 14224 for failure data
Work orders from your maintenance systemcorrective and planned jobs with their free-text closing notes, refreshed every 15 minutes
Root-cause reportspast investigations of repeat and serious failures
Asset register, alarms and storesnameplates and operation counters, alarm history, stock codes, depot stock and bins
What it changes

Repeat jobs and time to work alone, with maintenance knowledge search

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
50%
fewer corrective jobs that fail again within 30 days
Today8% of jobs
With the fix recipe4%
demo
$1.2Ma year
in repeat jobs avoided, the sample's figure: 1,240 jobs × $950
Repeat jobs today2,480 a year
With the fix recipe1,240 a year
target
12months
for a new engineer to work alone, against up to 3 years today
12 of 36 months
time to work alone

“demo” = seen in the working solution, on its sample data · “target” = the design goal, measured in the live solution · “estimated” = our arithmetic for a large utility with 31,000 corrective jobs a year, on sample inputs: × 4 points fewer repeats = 1,240 jobs × $950 a repeat job (a crew of two for four hours, a vehicle and parts); the days split is our estimate · “typical” = published figures: T&D World, utility workforce crisis (33–50 % of the workforce eligible to retire in 5–10 years); AWWA 2025 (21 % of water staff within 5 years); Avers et al. via arXiv 2608.18465 (20–40 % of technicians' time consulting maintenance information). IEC 60214-1 and ISO 14224 are named as context. Names on the screens are sample data.

Questions

Answers on closing notes, field fixes and safety steps for maintenance teams

What is maintenance knowledge search?

Maintenance knowledge search lets maintenance engineers ask about a fault in plain words and get an answer drawn from OEM manuals, maintenance procedures, standards and past work orders. Maintenance Knowledge Search answers with a fix recipe: matched symptoms, numbered steps each cited to its source, tools, and parts with stock codes, led by the fix that stopped the fault coming back.

How does an AI maintenance assistant for utilities work?

Six agents share the work. The fault reader finds the asset and symptoms; the manual and procedure searcher finds the manual sections, bulletins and procedures; the work history miner reads past closing notes and counts which fixes held; the fix recipe writer builds the cited recipe; the parts and tools checker finds stock; the knowledge steward drafts the closing note. In the sample case the answer took 9.4 seconds.

Can it search old work orders and free-text closing notes?

Yes. It reads the technicians' own closing notes as well as failure codes, groups them by the fix actually done and links repeats on the same asset. A job without a closing note is not counted as a success.

What happens when the field fix differs from the manufacturer's manual?

The answer shows both side by side, with the outcome of each past fix. When a fix meets the field-proven rule (set in the sample to at least 3 jobs, none back within 90 days), it goes to a reliability engineer, who approves it as field-proven, rejects it with a reason or asks the manufacturer to confirm. Nothing changes in an answer until a reliability engineer approves it.

Can it capture knowledge from retiring workers?

Yes. Expert capture lists experts retiring in the next 18 months and shows how much of their work has a usable note. The knowledge steward drafts questions from the gaps in their record, and each session becomes notes the expert checks and signs.

Does it work for water treatment as well as substations?

Yes. The working solution also answers a hypochlorite dosing pump losing prime at a water treatment works, and an SF6 low-density alarm on a 33 kV circuit breaker. Questions and answers can be in English and a second language.

Who can change a safety step, and who decides what gets fixed?

Safety steps are quoted word for word from the procedure and safety rules, and only the procedure owner can change one. The engineer decides what to replace and signs the closing note; the authorized person issues the permit; a reliability engineer decides what becomes standard. The agents do not order parts, change a work order's status or publish a fix.

What do you need from us to start?

Your manuals, procedures, safety rules and work order history. The Agentic Solution Engine builds and deploys the solution from these, and it goes live once each quality gate has passed. We first run it with you on your own closed corrective jobs.

Search your own maintenance knowledge
on your closed corrective jobs.

We'll run Maintenance Knowledge Search on your manuals, procedures and a sample of your closed corrective jobs.
