- Before
- Reads 30 to 60 findings one by one on a patrol day. Spends the morning working out which pole a photo shows and whether a job already exists.
- Now
- Opens a board already sorted by clock. Each work request is drafted and each repeat sighting sits on its open job. Then the planner decides, raises and sends.
Inspection finding triage on one morning: 46 findings sorted by their clocks
A utility runs electricity and water across one network from a single depot. One morning at 07:40, the maintenance planner opens Inspection Finding Triage. Here is what happened overnight and what the planner decides, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

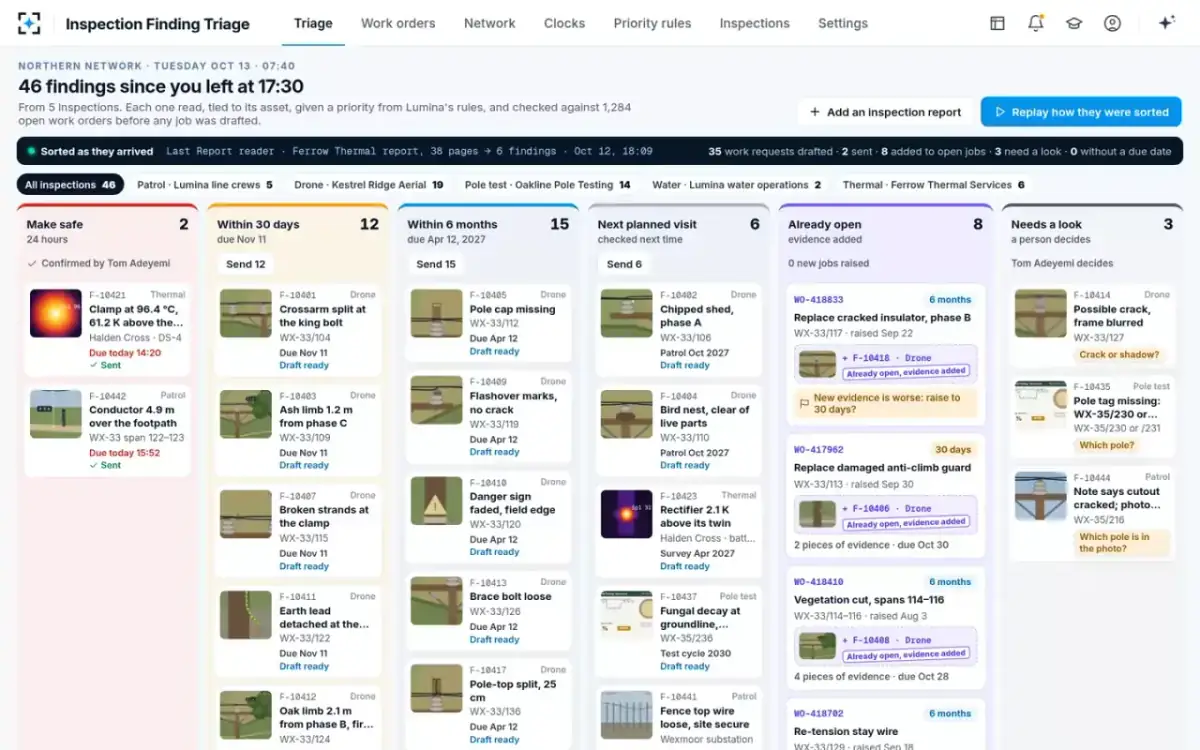

- 01Start of the day

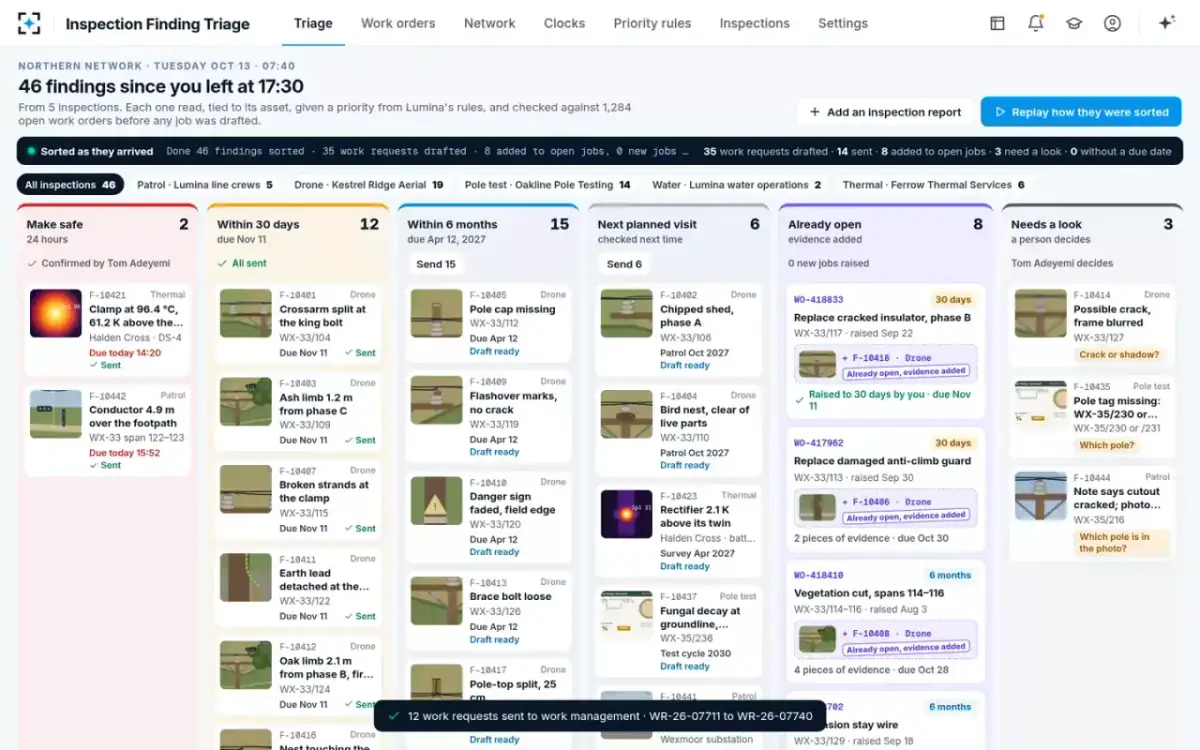

46 findings since the planner left, already sorted by their clocks
Maintenance plannerSince the planner left yesterday, 46 findings arrived from 5 inspections. Each one was read, tied to its asset and given a priority from the utility's rules. Then it was checked against 1,284 open work orders before any job was drafted. They sit in six lanes. Two are in Make safe · 24 hours, 12 in Within 30 days and 15 in Within 6 months. Six are in Next planned visit, 8 in Already open · evidence added and 3 in Needs a look.
“35 work requests drafted · 2 sent · 8 added to open jobs · 3 need a look · 0 without a due date”
- 02Overnight

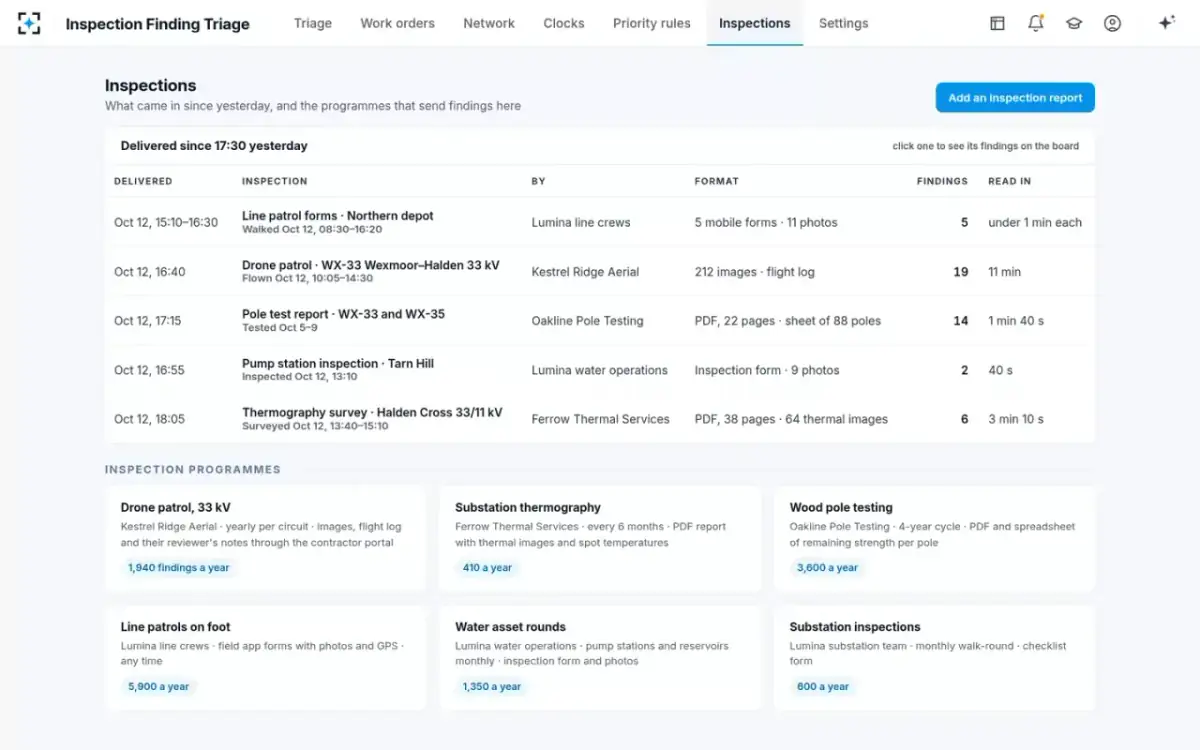

Five deliveries split into findings, each with its measurement
Report readerA contractor's drone patrol of a 33 kV line sent 212 images and a flight log. They became 19 findings in 11 minutes. A pole testing contractor sent a 22-page PDF with a sheet of 88 poles. It became 14 findings in 1 minute 40 seconds. A thermal contractor's 38-page survey of a 33/11 kV substation became 6. Five patrol forms from line crews and a pump-station inspection make up the rest.
- 03The evening before
A hot clamp goes straight to make safe

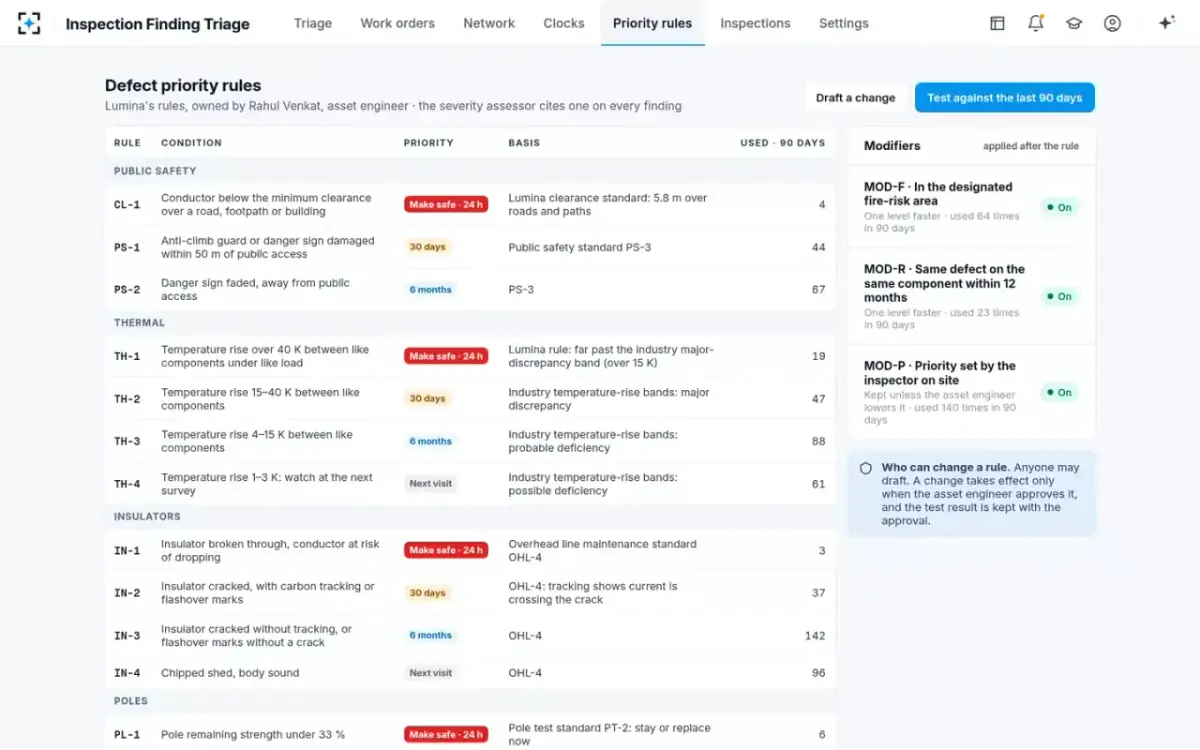

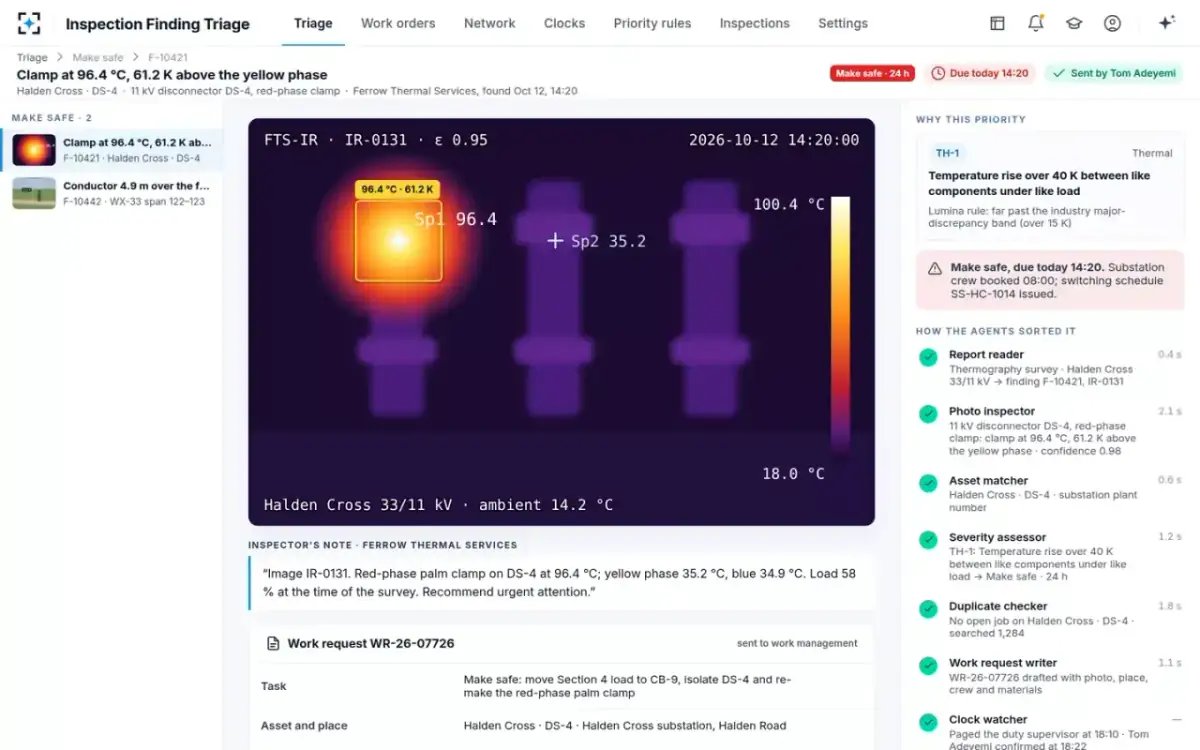

Severity assessor and Clock watcherThe thermal image shows the red-phase palm clamp on 11 kV disconnector DS-4 at 96.4 °C. The same part on the yellow phase reads 35.2 °C. That is a 61.2 K rise at 58 % load. Under the thermal rule, a rise of over 40 K between like parts makes it a 24-hour make-safe, a job to make the site safe. The clock watcher paged the duty supervisor at 18:10, and the supervisor confirmed at 18:22. A substation crew is booked for 08:00 and the switching schedule is issued.
Drafted task: “Make safe: move Section 4 load to CB-9, isolate DS-4 and re-make the red-phase palm clamp”
- 04As each finding arrives

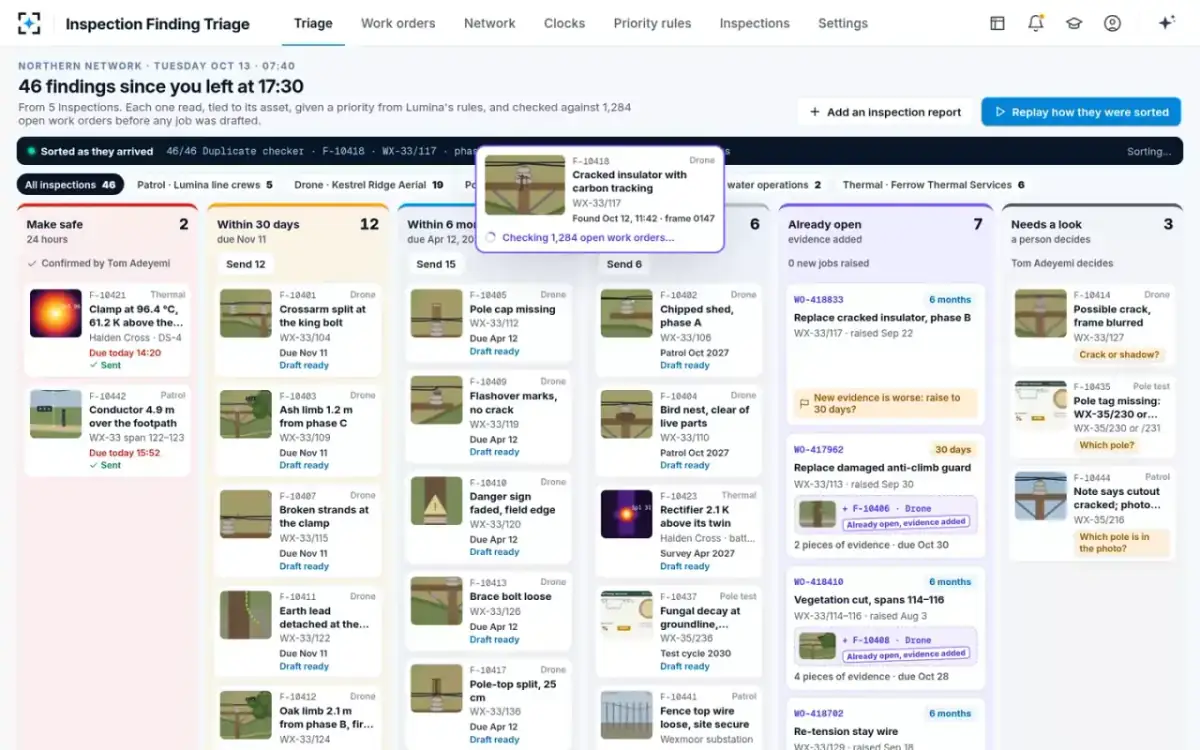

Checked against 1,284 open work orders before a job is drafted

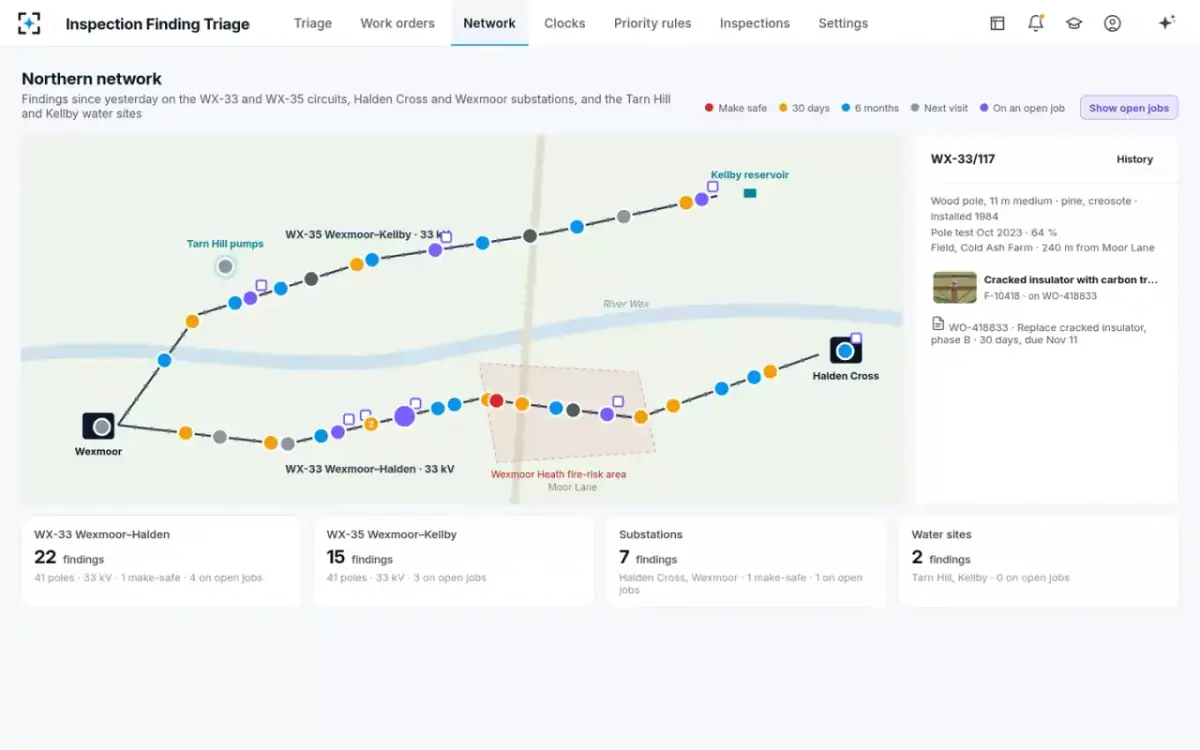

Duplicate checkerThe board replays the night, with each finding placed in its lane as it arrived. One drone frame shows a pole with a cracked insulator and carbon tracking, the burn marks left by current leaking across it. The frame stops before it reaches a lane, while the duplicate checker searches the open jobs on the same asset and part.
- 05Already open

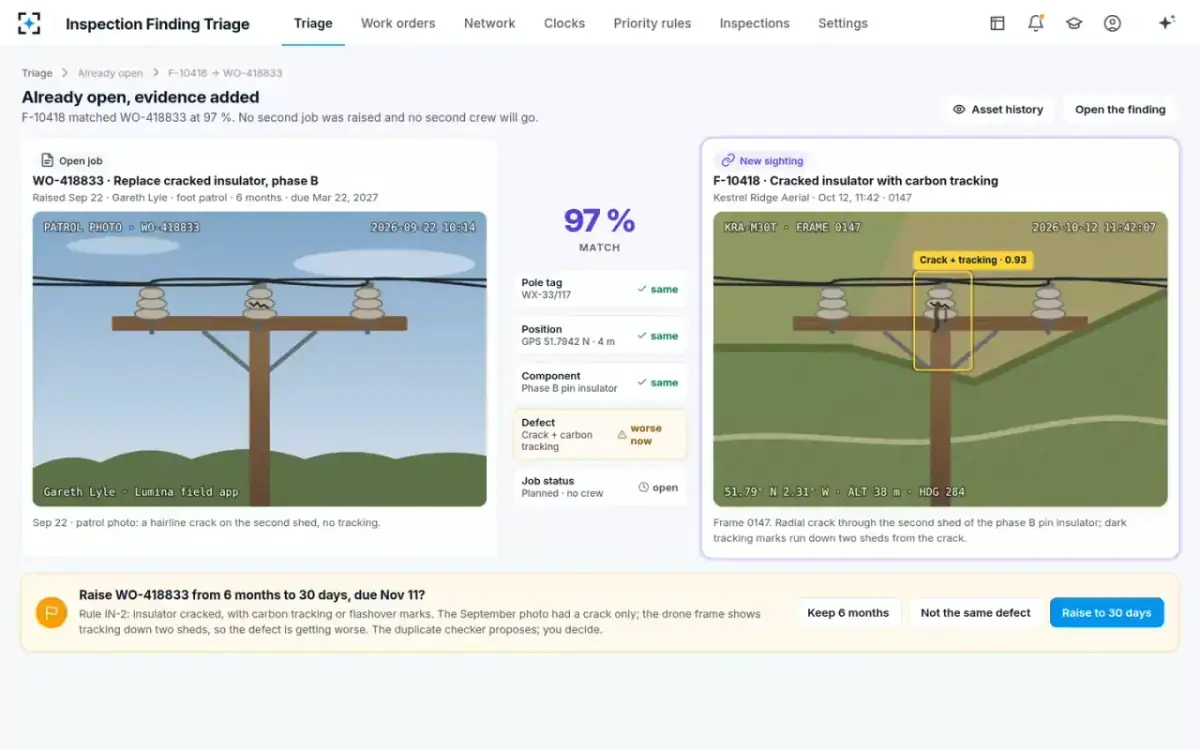

A 97 % match with a job the crew lead raised earlier
Duplicate checkerThe open job reads “Replace cracked insulator, phase B”. The line crew lead raised it weeks earlier from a foot patrol. It is set at 6 months and planned, but no crew is booked. It has the same pole tag, a GPS fix 4 m away and the same phase B pin insulator. So no new job is raised, and the drone photo is added to the job as evidence. The defect is worse now, though. The patrol photo showed a hairline crack with no tracking. Now the drone frame shows tracking down two sheds.
- 06One click

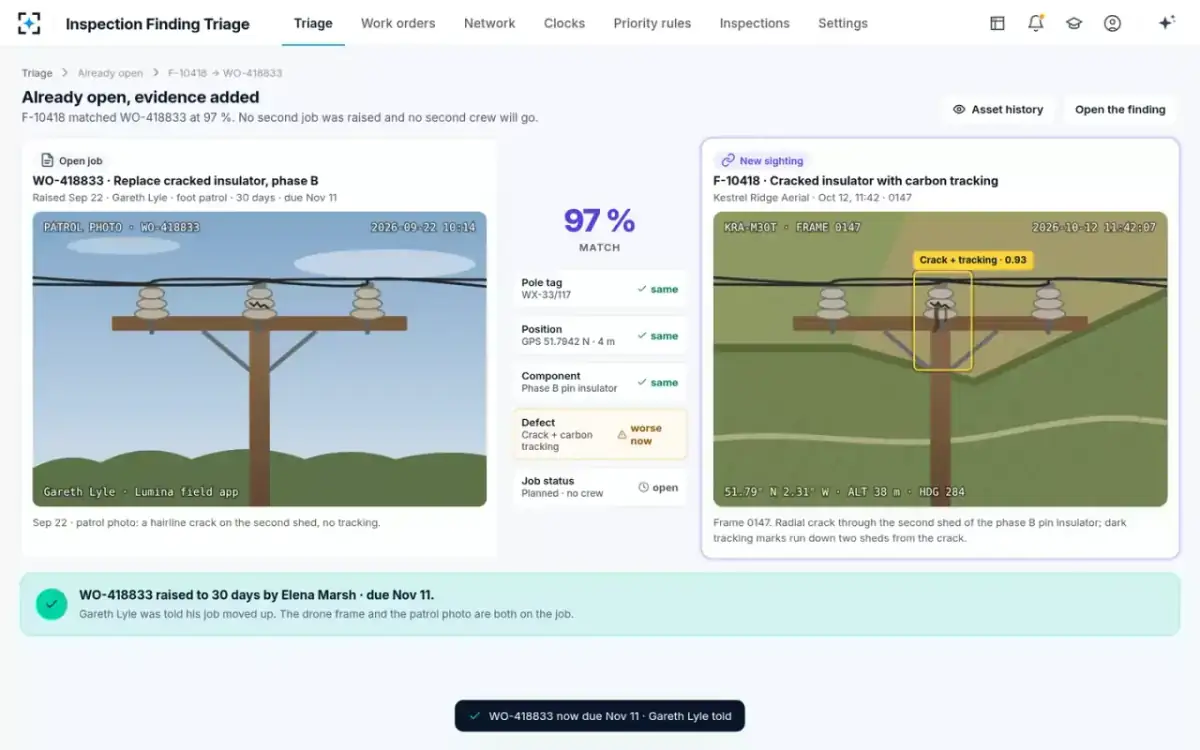

The planner raises the open job to 30 days
Maintenance plannerThe insulator rule says a cracked insulator with carbon tracking or flashover marks must be fixed within 30 days. So the duplicate checker proposes raising the job from 6 months to 30 days. It cannot change the job itself. The planner compares the two photos side by side and raises it. The crew lead is told the job moved up, and both photos stay on the job.

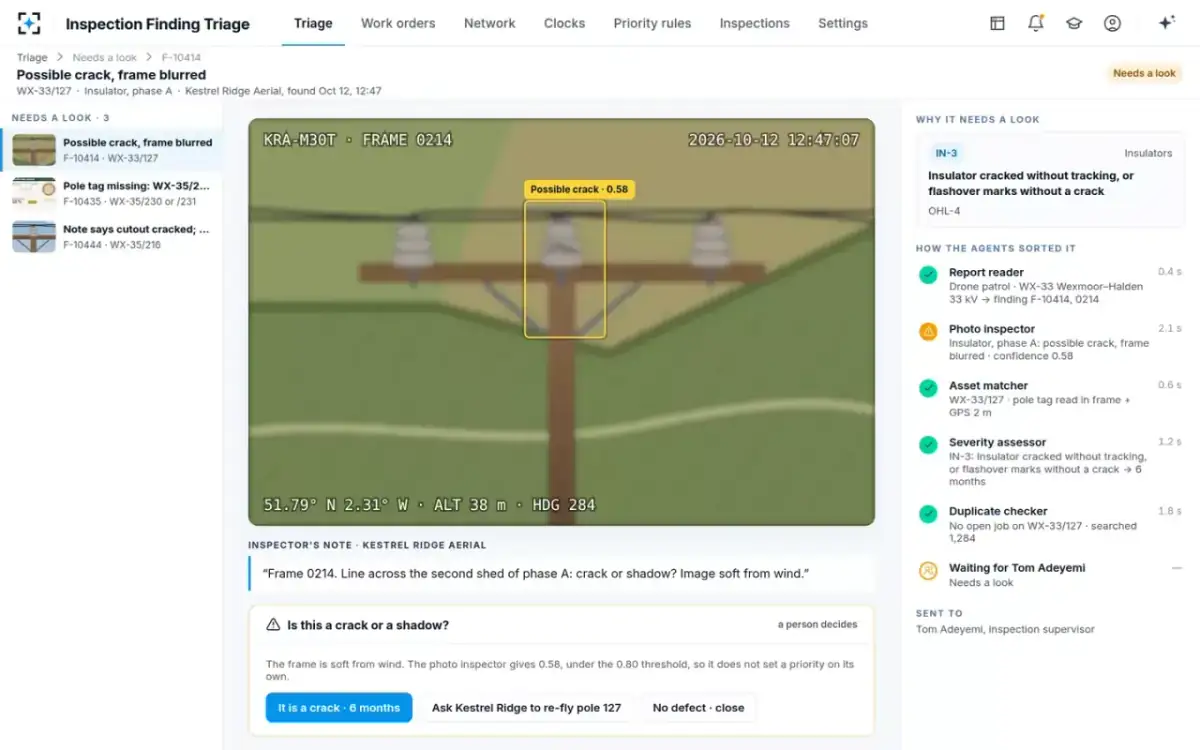

- 07Needs a look
Three findings wait for a person, with the reason
Inspection supervisorOne drone frame is blurred by wind. It shows a line across the second shed of phase A that may be a crack or a shadow. The confidence is 0.58, under the 0.80 threshold, so it goes to a person. Another finding has no pole tag and a GPS fix between two poles 11 m apart. A third has a note naming one pole and a photo whose tag shows the next. The supervisor settles each one.
Choices on the drone frame: “It is a crack · 6 months” · “Ask the contractor to re-fly the pole” · “No defect · close”

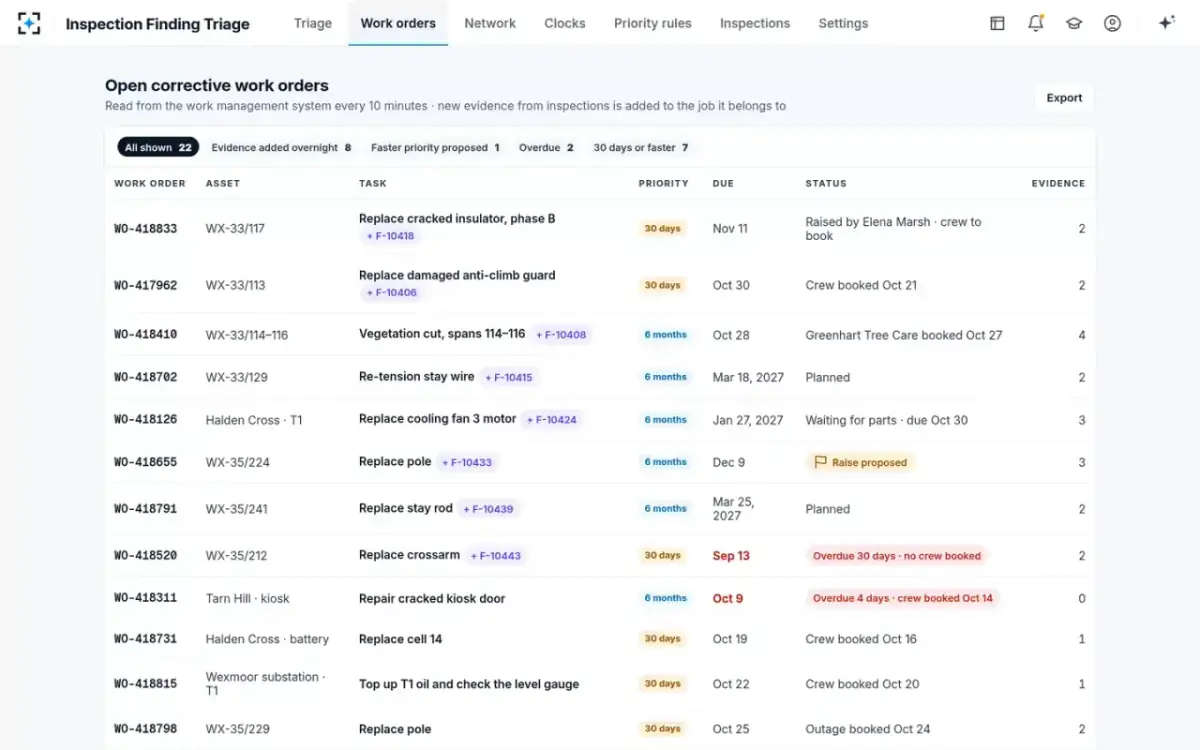

- 08Overdue
A patrol sighting brings an overdue job back to the top
Duplicate checker and Clock watcherA patrol form reads “Crossarm soft at the phase C end, getting worse”. It matches an open job raised at 30 days that is now 30 days overdue, with no crew booked. The sighting is added as evidence, and the job is escalated to the planner. The work orders list shows each open repair job with its clock and the evidence added overnight.
“Replace crossarm · Overdue 30 days · no crew booked”
- 09Sent
The 30-day lane goes to work management in one go
Maintenance plannerEach drafted request carries the task, crew, materials, outage need, marked photo, map position and due date. One reads “Replace the crossarm and king bolt”. Another reads “Cut back the vegetation to 3 m clearance”. A third reads “Replace the pole; mark it ‘no climbing’ until replaced”. The planner checks the lane and sends the 12 requests. Nothing reaches the work management system until the planner sends it.

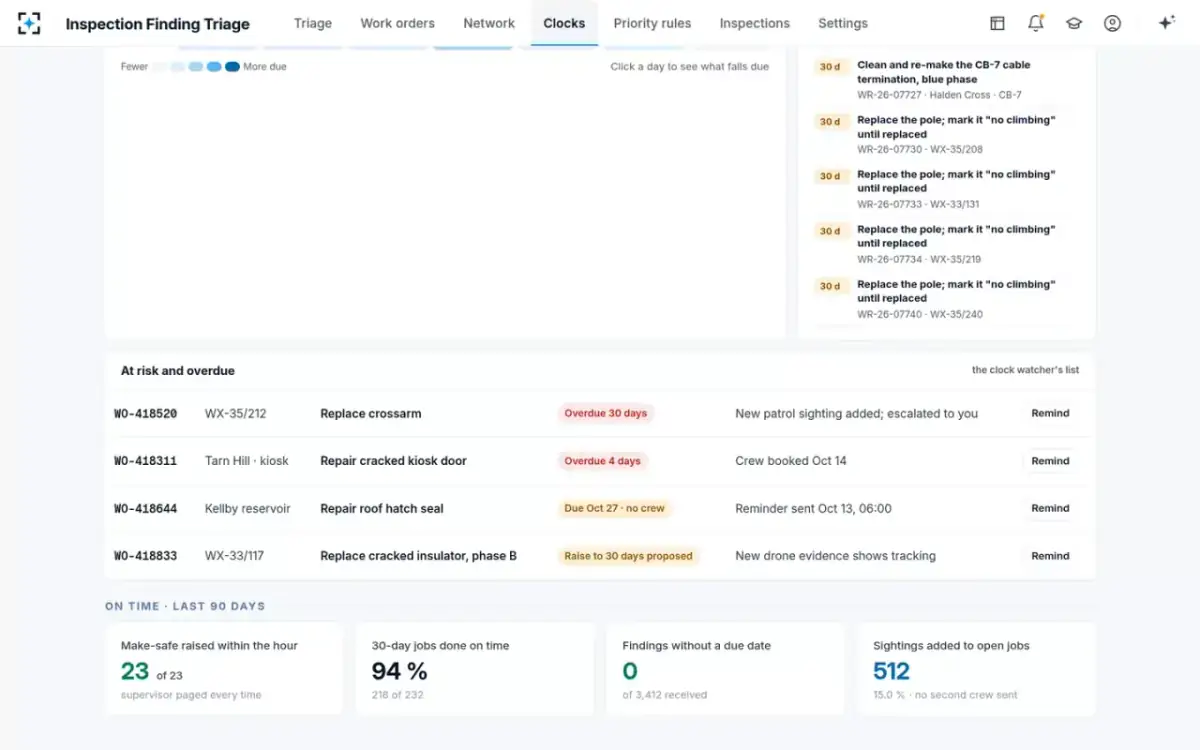

- 10On the hour
Due dates watched until the job is done
Clock watcherEach hour, the clock watcher checks each open job and finding against its due date. It alerts the planner 7 days before a 30-day job is due, and lists what is at risk or overdue. A pump-station kiosk door is 4 days overdue, with a crew booked. A reservoir roof hatch is due soon, with no crew. Over 90 days, 23 of 23 make-safes were raised within the hour, and the duty supervisor was paged each time. Of the 30-day jobs, 94 % were on time, 218 of 232. Of 3,412 findings, 512 were added to a job already open, or 15.0 %. No finding was left without a due date.
