- Before
- Owns 11 works and reads each consultant report for them, then types the grades into the EAM by hand. A 148-page survey gets one proper read.
- Now
- Opens the report beside its findings, with each row tied to its sentence. Decides only the findings the agents question, with the last survey’s sentence and the work orders beside each one.
A five-yearly treatment works survey, a questioned roof and seven defects
A utility’s water treatment works has its five-yearly condition assessment back from the consulting firm that surveyed it. The report runs to 148 pages, revision 0, and arrived ten days after it was issued. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

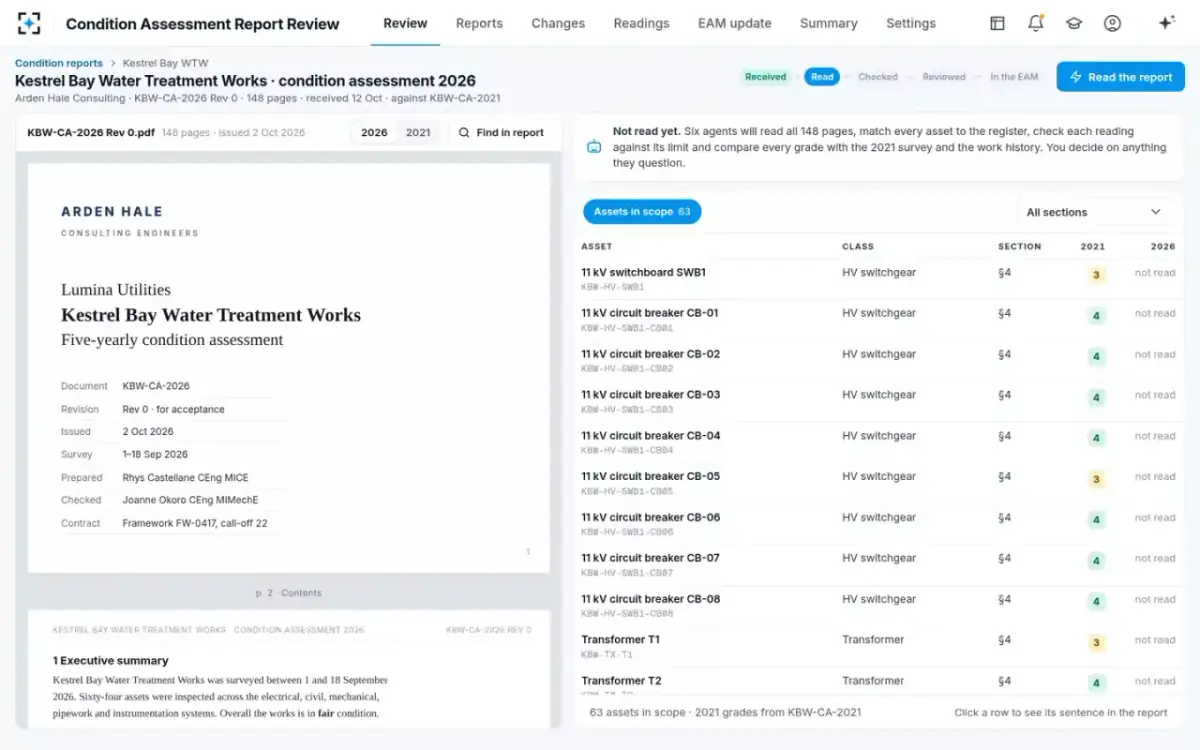

- 01The next morning

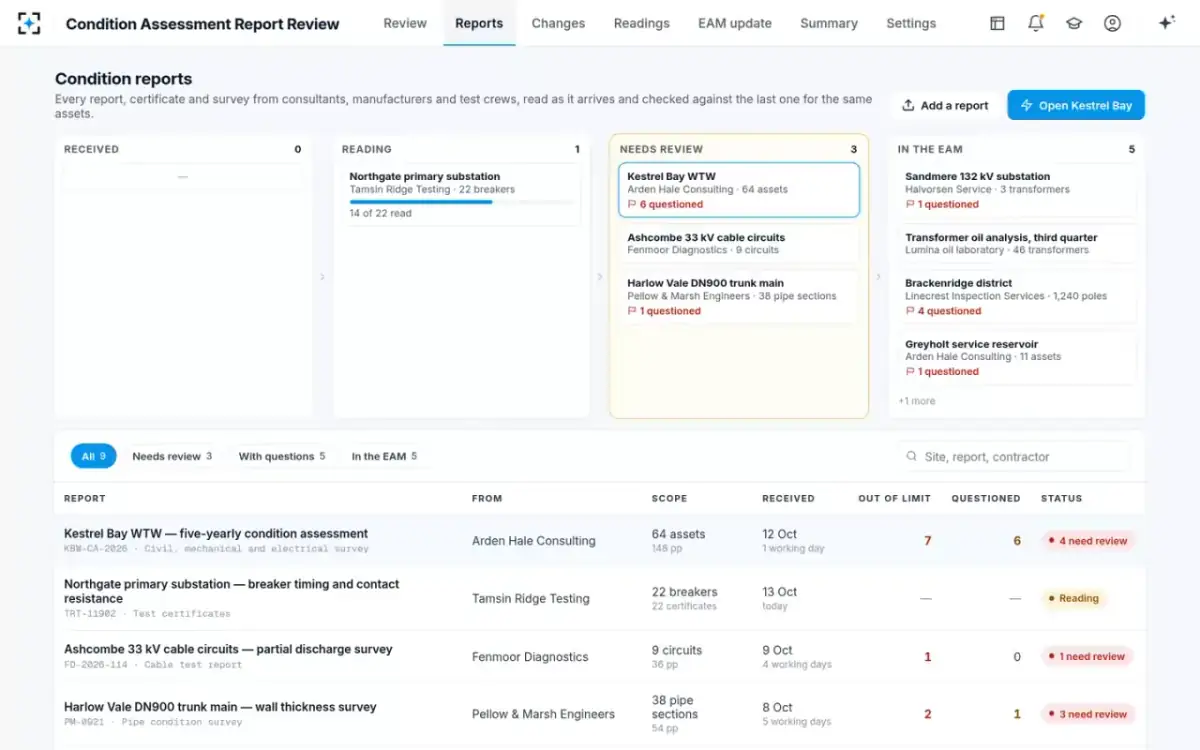

The report opens beside its findings table
Asset engineerThe asset engineer owns the treatment works in the south region and reads each consultant report for them. The review screen shows the report on the left, page by page. On the right are the 63 assets in scope, each with its grade from the last survey. The new column still reads “not read”.
“Not read yet. Six agents will read all 148 pages and match each asset to the register. They will check each reading against its limit and compare each grade with the last survey and the work history. You decide on anything they question.”
- 02One click

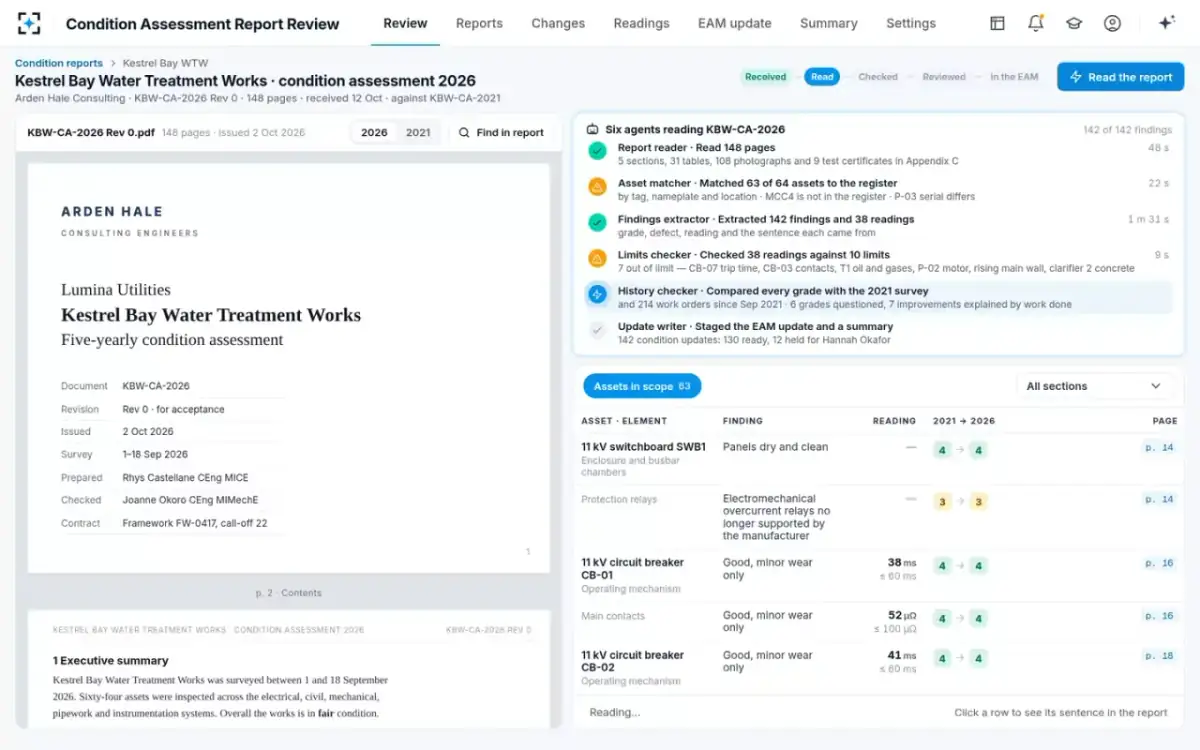

Six agents read the survey, step by step
Six agentsThe engineer clicks Read the report. First, the report reader takes in 5 sections, 31 tables, 108 photographs and 9 test certificates in Appendix C. Next, the asset matcher finds 63 of 64 assets in the register. The findings extractor pulls 142 findings and 38 readings. Then the limits checker tests the readings against 10 limits, and the history checker compares each grade with the last survey.
Asset matcher: “Matched 63 of 64 assets to the register · one motor control center is not in the register · one pump’s serial differs.”

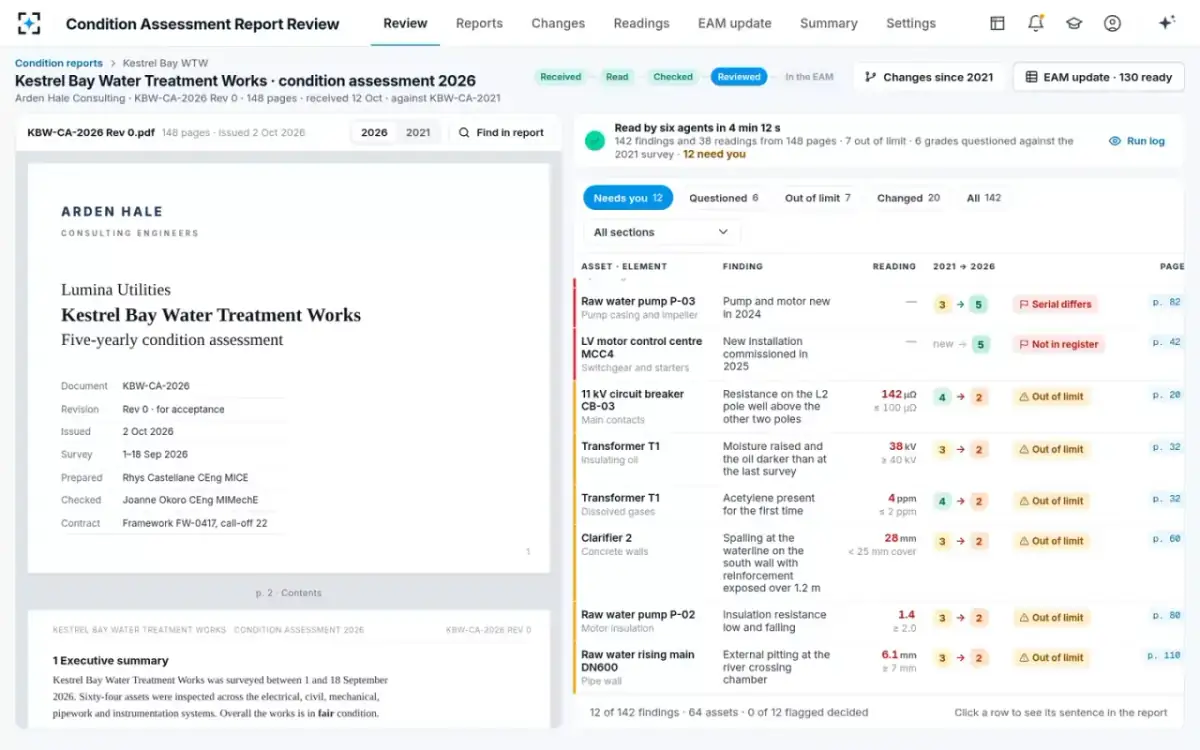

- 034 min 12 s later
Twelve findings need the engineer, and the rest are ready
Asset engineerThe screen opens on Needs you, with 12 of 142 findings. A raw water pump shows Serial differs, and a motor control center shows Not in register. Seven rows are Out of limit. They include one breaker’s contact resistance at 142 µΩ, and the works transformer’s oil at 38 kV with acetylene at 4 ppm. Another raw water pump has a polarization index of 1.4, and the DN600 rising main wall is at 6.1 mm.
“Read by six agents in 4 min 12 s. 142 findings and 38 readings from 148 pages. 7 out of limit. 6 grades questioned against the last survey. 12 need you.”

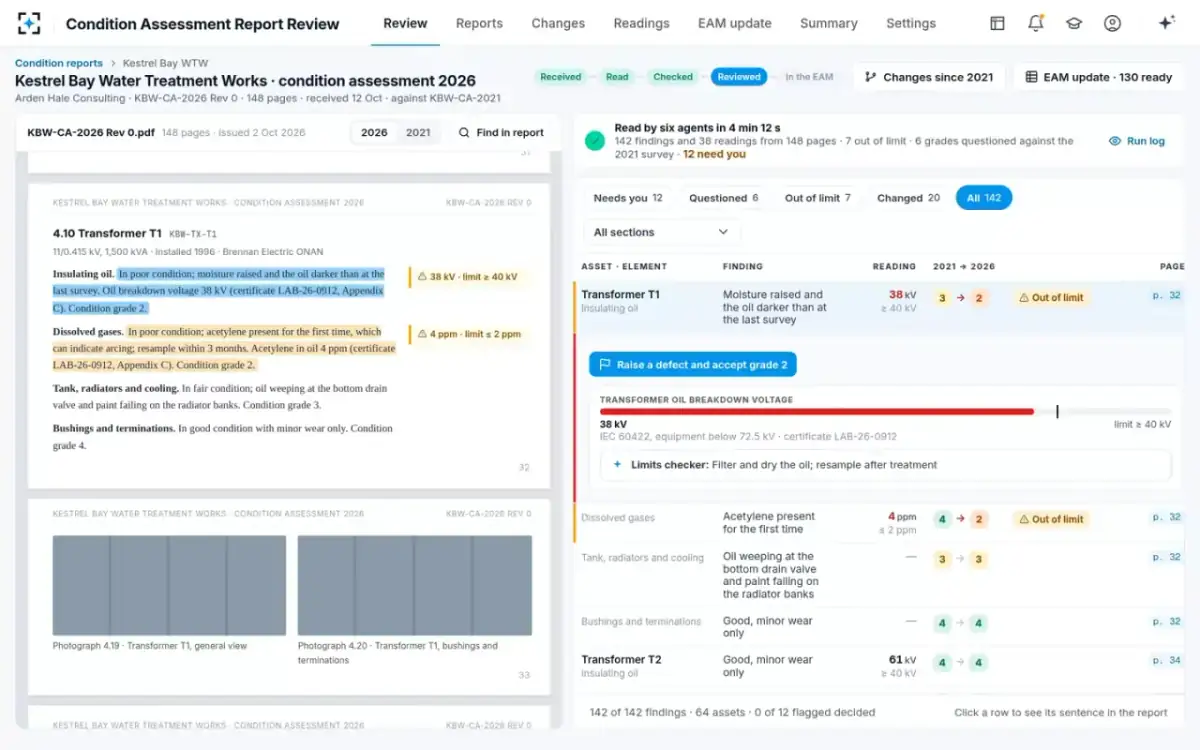

- 04Any row
Each reading, tied to its sentence and its limit
Findings extractor and Limits checkerClicking the transformer’s insulating oil row scrolls the report to section 4.10 on page 32. It highlights the sentence giving a breakdown voltage of 38 kV, with its lab certificate. The row shows the reading against the IEC 60422 limit of ≥ 40 kV for equipment below 72.5 kV. It also shows the recommended action.
Limits checker: “Filter and dry the oil. Resample after treatment.”

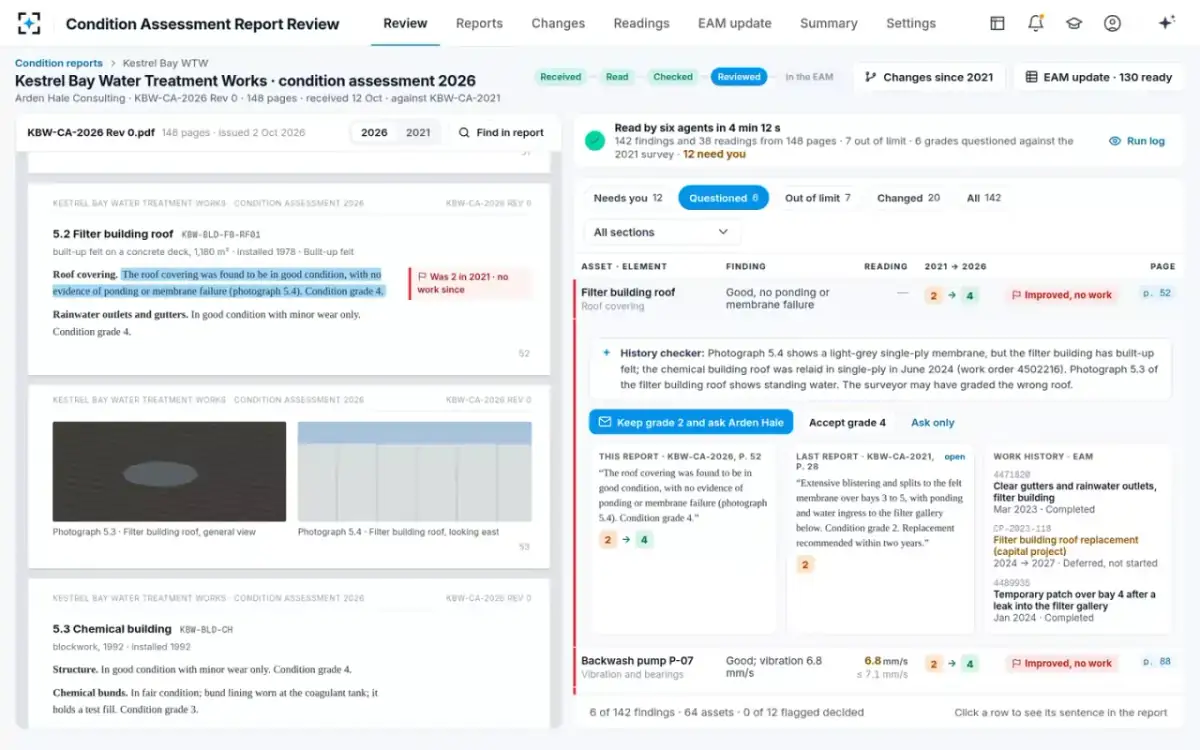

- 05The question
The roof rose from 2 to 4 with no repair on record

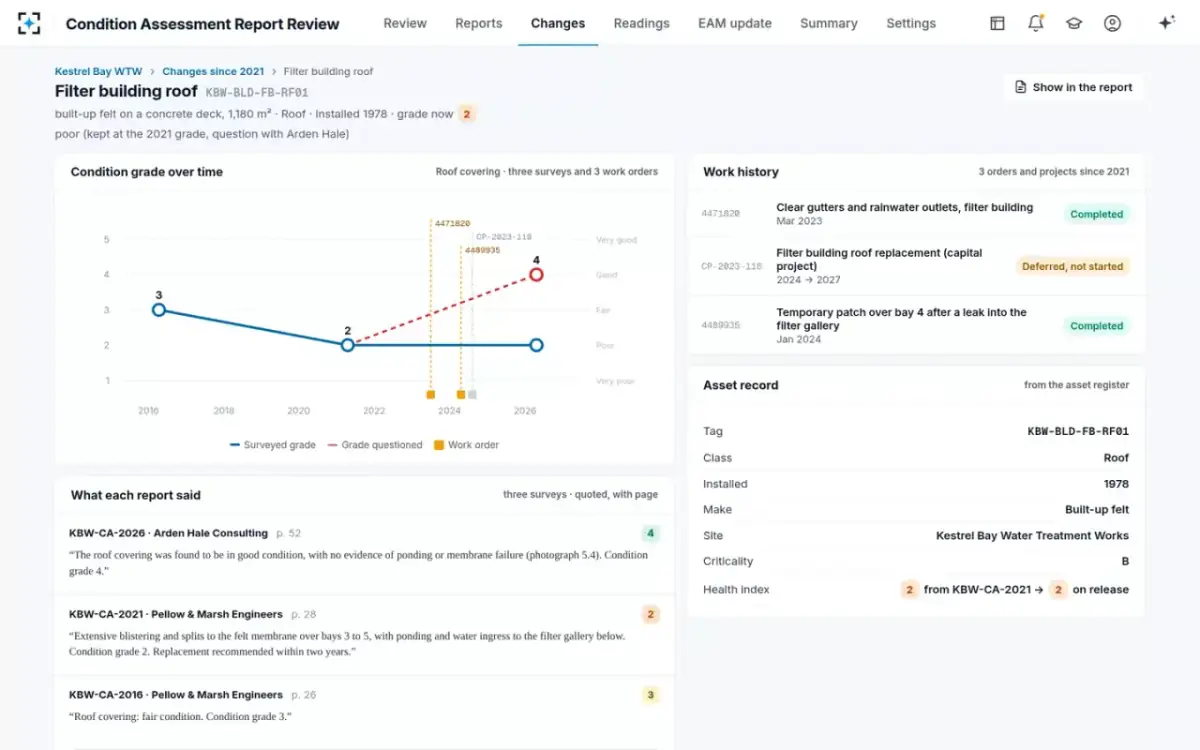

History checkerThe consultant graded the filter building roof covering 4, good. At the last survey, another firm graded it 2, with blistering, splits and water getting into the filter gallery. Since then, the work history shows only gutter clearing and a temporary patch. The roof replacement project is deferred and not started. Photograph 5.4 shows a single-ply membrane, but the filter building has built-up felt.
History checker: “The chemical building roof was relaid in single-ply after the last survey, under its own work order. The surveyor may have graded the wrong roof.”
- 06Decided
The engineer keeps grade 2 and asks the consultant
Asset engineerThree sources sit side by side. They are this report’s sentence on page 52, the last survey’s sentence on page 28, and the work orders. The asset history draws the grade over the last three surveys, with the questioned rise dashed. The engineer chooses Keep grade 2 and ask the consultant. Accepting grade 4 would have needed a written reason, shown to the condition assessment lead with the summary.
“Kept grade 2 · question sent to the consultant · 11 still need you”. The answer is due in 10 working days under the framework contract.

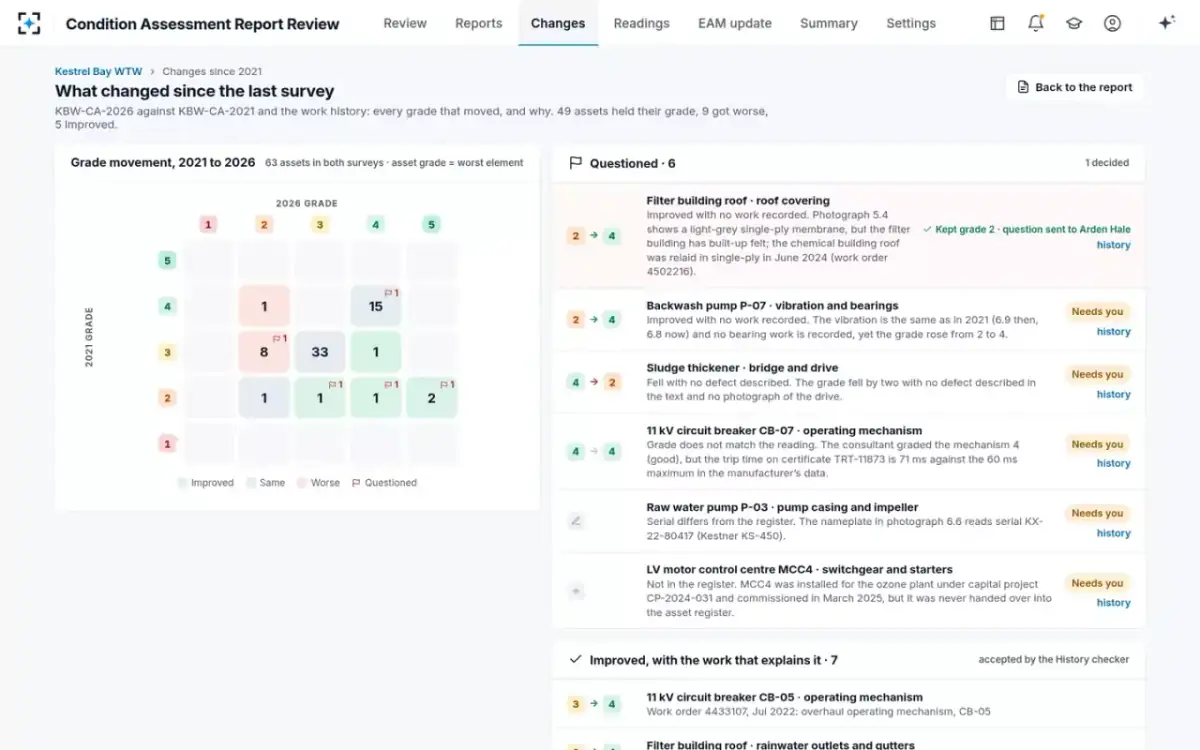

- 07Since the last survey
Each grade that moved, and why
History checkerChanges since the last survey sets the two surveys side by side for the 63 assets in both. Of those, 49 held their grade, 9 got worse and 5 improved. Six grades are questioned against that survey and 214 work orders. One is the backwash pump, which rose from 2 to 4 while its vibration stayed the same (6.9 mm/s then, 6.8 now). Another is a breaker graded 4 although its trip time is 71 ms. Seven element grades that improved are explained by completed work, such as a breaker mechanism overhaul.
“Improved, with the work that explains it · 7, accepted by the History checker”

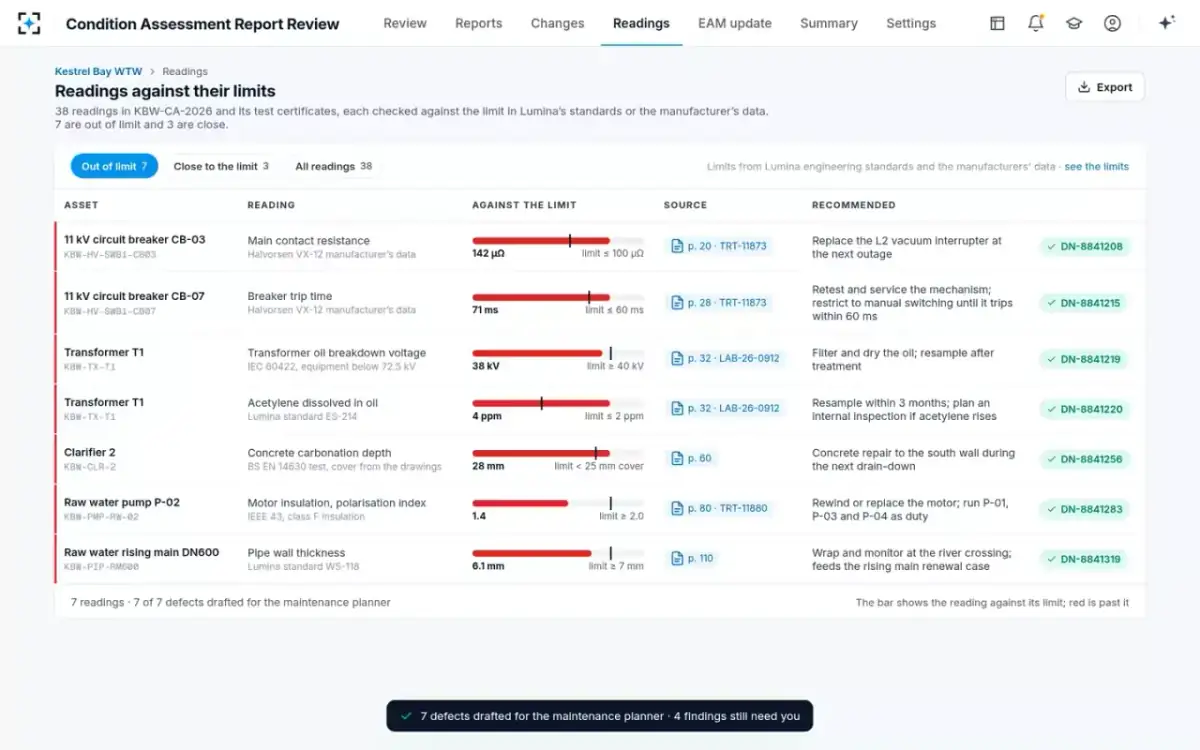

- 08Seven defects
A defect for each reading past its limit

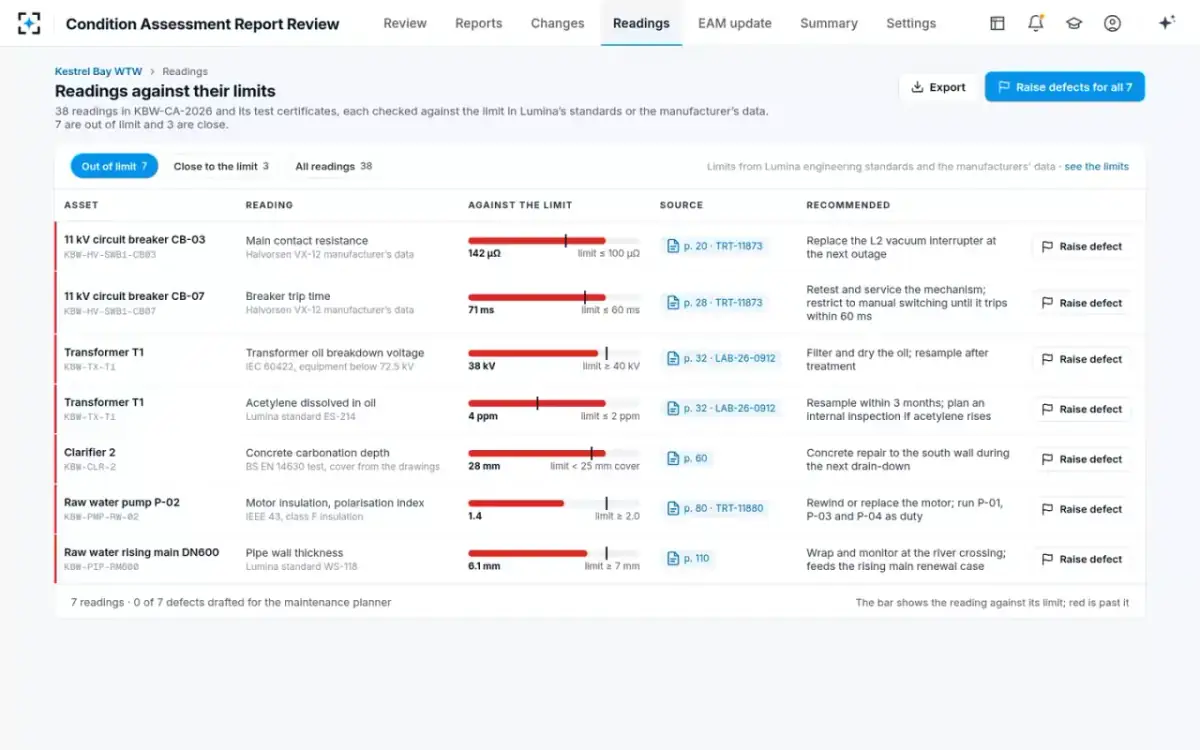

Asset engineerReadings shows the 38 readings against their limits, each with its standard, source page and recommended action. For the high-resistance breaker, the action is to replace the L2 vacuum interrupter at the next outage. For the slow breaker, the action is to restrict it to manual switching until it trips within 60 ms. For the weak pump motor, the action is to rewind or replace it and run the other raw water pumps as duty. The engineer clicks Raise defects for all 7. Seven defect notifications are drafted for the maintenance planner.
“7 defects drafted for the maintenance planner · 4 findings still need you”

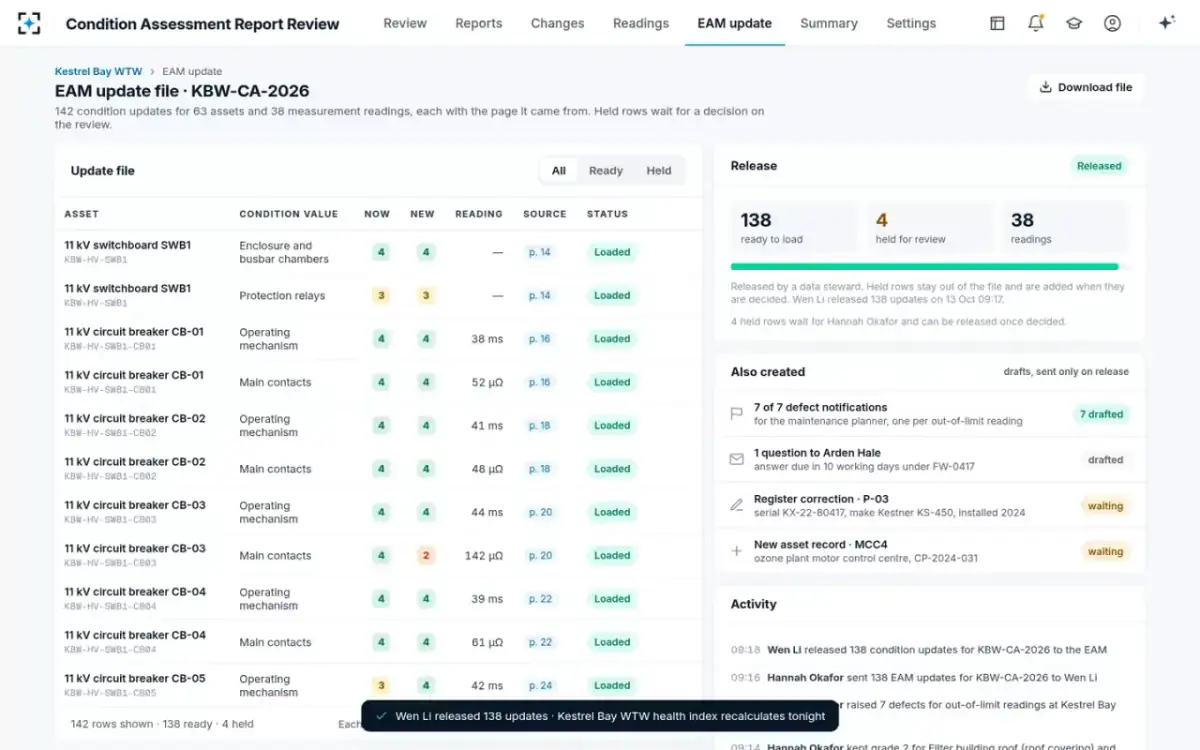

- 09Released
The steward releases the update, and the health index recalculates tonight
Asset data stewardThe EAM update file holds a condition update or reading for each finding, each with its source page. The engineer sends 138 ready updates to the data steward. Four stay held until they are decided. The steward releases the 138. Two more changes are waiting. One corrects the register for the pump with the new serial and nameplate. The other is a new asset record for the motor control center.
“The data steward released 138 updates · the works health index recalculates tonight”
- 10For capital planning

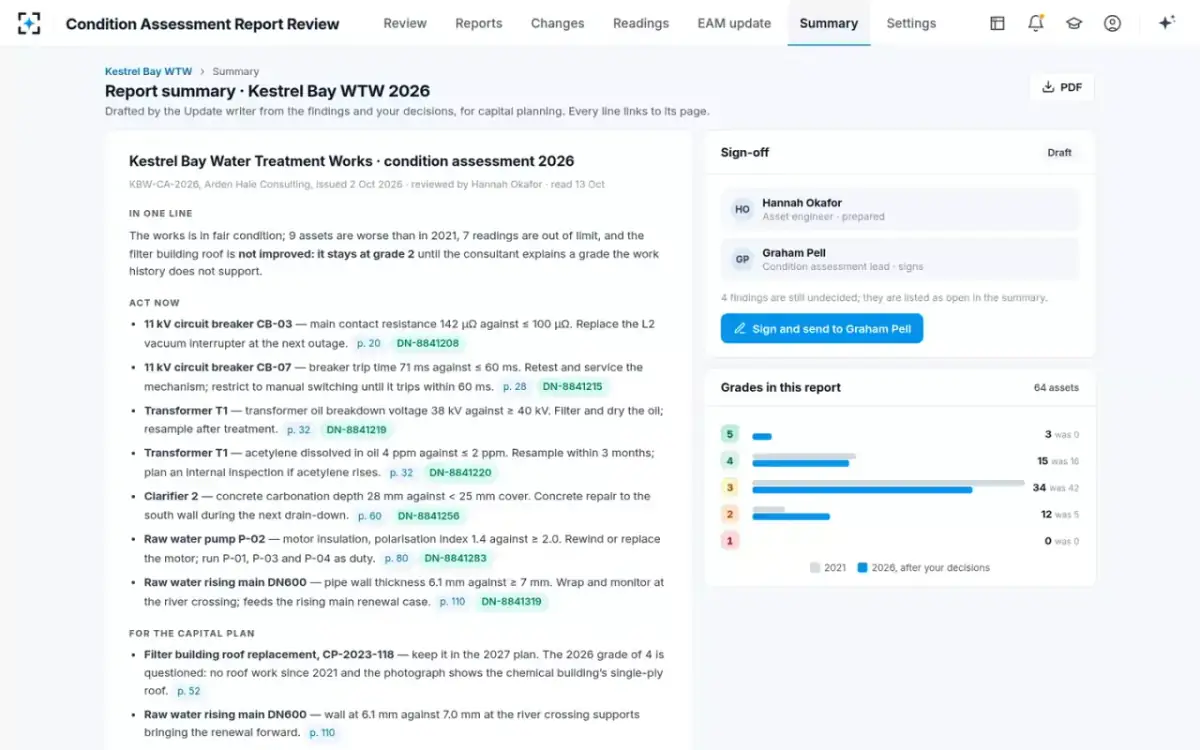

A one-page summary, signed twice
Condition assessment leadThe update writer drafts the summary from the findings and the engineer’s decisions, with each line linked to its page. It tells capital planning to keep the filter building roof replacement in next year’s plan. It also says the DN600 rising main, at 6.1 mm against 7.0 mm, supports bringing its renewal forward. The engineer signs it and sends it to the condition assessment lead. The lead signs and sends it to the capital planning manager.
In one line: “The filter building roof is not improved. It stays at grade 2 until the consultant explains a grade the work history does not support.”
