SearchAsset Management & Maintenance

ISO 55001 Audit Readiness

ISO 55001 audit readiness: each clause of ISO 55001:2024 mapped to your own evidence, with each gap found before the auditor finds it

See one case, screen by screen ↓
Watch with transcript →

Built forAsset management leadsAsset management directorsQuality and audit teamsFinance business partners

The Problem Today

No one place shows which document proves which clause, so staff hunt for evidence by hand and find the gaps in the last two weeks.

6 weeks
of part-time evidence hunting by 3 or 4 people per audit our estimate
90 days
to close a major finding before the certificate is issued our estimate

Evidence hunted clause by clause

  • Strategy
  • Asset plans
  • Risks
  • Reviews
  • Six clauses new to the editionLast cycle's control matrix does not cover them
  • Readiness in one headWhen that person retires, the map of the evidence goes too

The Solution

  1. Ask about any clauseAsk in plain words whether a clause is ready, across all your evidence
  2. Each line gradedEach requirement graded evidenced, out of date, draft or missing
  3. Missing evidence requestedEach gap names its owner and what the auditor will likely ask
  4. The director signs the packCited documents frozen and filed by clause, shared only once signed

Built-in controls

  • Each evidenced line cites its passage
  • A draft does not count as evidence
  • Requests are drafted; people send them

What You Get

Gaps are found and closed weeks before the auditor arrives, so fewer findings hold up the move to the new edition.

  • Auditor questions answeredThe cited passages shown in the room, or a plain “not yet”
  • Readiness by audit sessionEach session's clauses, attendees and gaps, known ahead of time
  • Last year's findings closedMinor findings shown as closed, with the proof of closure
In short

What is ISO 55001 Audit Readiness?

ISO 55001 audit readiness software shows, clause by clause, whether an asset management system has the evidence an ISO 55001 auditor will ask for. ISO 55001 Audit Readiness maps your own documents to each requirement line of ISO 55001:2024. It cites the passage that proves each one. It also names what is out of date, still a draft or missing, with its owner and a drafted request.

How to choose AI solutions for utilities →

Updated

The problem

The audit evidence exists, but finding it takes six weeks of hunting

ISO 55001 is the international standard for managing physical assets such as pipes, pumps and power lines. A certified utility is audited every year and recertified every three years. Before 31 July 2027, it must also move to the new 2024 edition. In each audit, the auditor goes through the standard clause by clause and asks for the document that proves each requirement. That might be the Strategic Asset Management Plan (SAMP), an asset management plan, the objectives, the risk register or the minutes of a management review. No one place shows which document proves which requirement. So before each audit, the asset management office builds that map again by hand. Three or four people search folders, exports from the asset management system and inboxes for about six weeks, part time. They track it in a control matrix, which is out of date the day it is finished.

The evidence usually exists, but the details go wrong. A document is still a draft, or a review has no minutes. A report is a quarter old, or a plan covers electricity but leaves out water. Gaps like these are found in the last two weeks. The 2024 edition makes it harder, because it adds six new requirements. They cover how decisions are made (4.5), what the SAMP must contain (6.2.1) and how changes are planned (6.3). They also cover data and information (7.6), knowledge (7.7) and predictive action (10.3). Last cycle's control matrix does not cover any of them. If the auditor raises a major finding, called a major nonconformity, the certification decision waits until it is closed and checked.

estimated90daysabout the time to close a major finding before the certificate is issued, usually with a follow-up audit
typical21%of water utility staff can retire within 5 years
Working days in one audit cycle, from control matrix to sign-offestimated
By hand30 days
With the solution2 days
  • Rebuilding the clause-by-clause control matrix5 → 0.1 d
  • Finding the evidence across folders, asset system exports and inboxes10 → 0.2 d
  • Checking versions, approvals, review dates and scope4 → 0.1 d
  • Chasing document owners for what is missing7 → 1 d
  • Assembling and indexing the audit pack3 → 0.1 d
  • Director's review and sign-off1 → 0.5 d

This is our estimate for a utility running both electricity and water. It splits about 6 weeks of part-time work by 3 or 4 people in the asset management office into working days. It compares the work by hand with the work using the solution. We will measure it in the live solution.

How it works

An auditor’s question, answered with cited evidence or sent to its owner

What comes in
Evidence inThe evidence library · SAMP, plans, policies, KPI reports, audit findings
Agents at work
Clause mapperpassages → 142 lines
Then
Evidence checker
Gap finder
Then
Request drafterowner + due date
Auditor question answerer
Then
Audit pack assemblerindexed by clause
A person decides
Asset management officesends requests, and the director signs
What comes out
Clause coverage
Gaps requested
Signed audit pack
One case, step by step

Clause 6.2 and the new data clause, 35 days before a transition audit

A utility runs electricity distribution up to 132 kV and water supply from source to meter. Its certification body will audit it in 35 days. The audit renews its certificate and moves it to ISO 55001:2024. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 01Morning, 35 days out

    The whole standard on one wall

    Asset management systems lead

    The systems lead owns the audit plan and the evidence. The clause map shows all 27 subclauses of ISO 55001:2024, broken into 142 requirement lines. Today the standard is 84 % ready. Of those lines, 119 are evidenced and 16 need work, and 7 documents are missing. The clauses that are new or revised in 2024 are marked. Each gap shows in red on its tile.

    6.2 Asset management objectives and planning · REVISED · 14/20 · 2 missing · 70 %

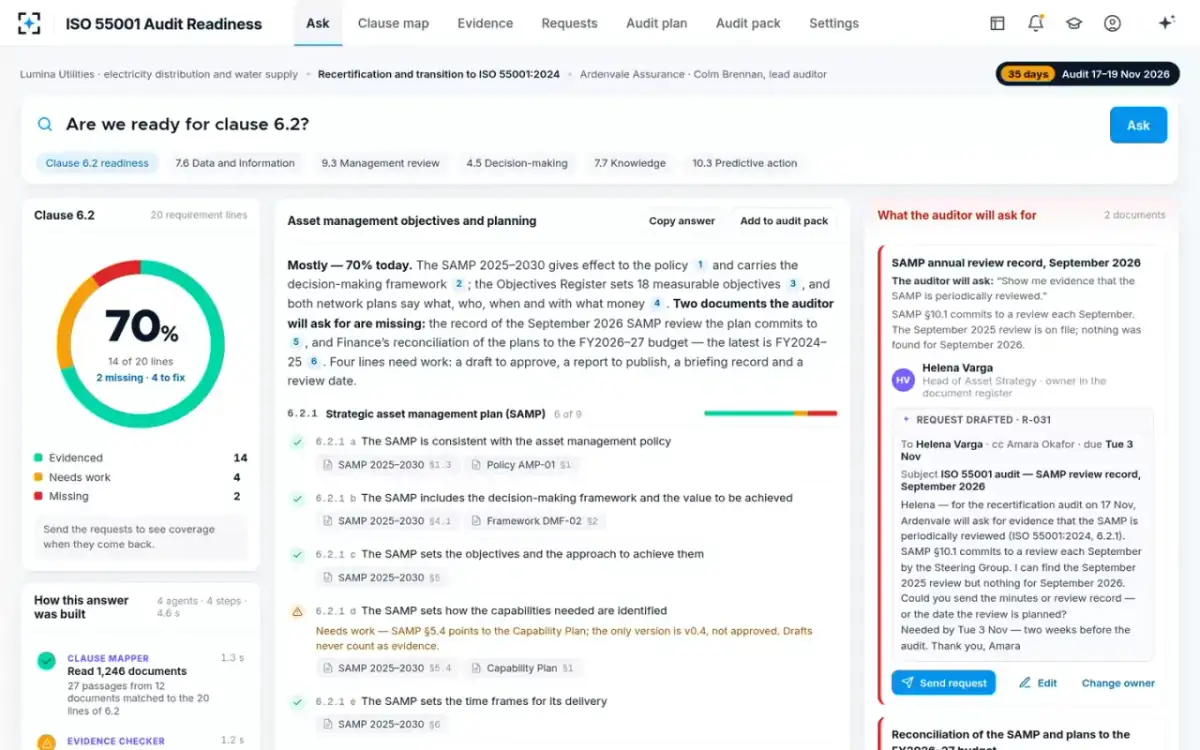

  2. 02One question

    “Are we ready for clause 6.2?”

    Asset management systems lead

    The lead asks the question in plain words. The clause mapper reads 1,246 documents. It matches 27 passages from 12 of them to the 20 lines of clause 6.2. The evidence checker checks versions, approvals and dates. The gap finder names what the auditor will ask for, and the request drafter finds the owners. Four agents take four steps in 4.6 seconds.

    “Mostly: 70 % today.” 14 of 20 lines evidenced · 4 need work · 2 missing

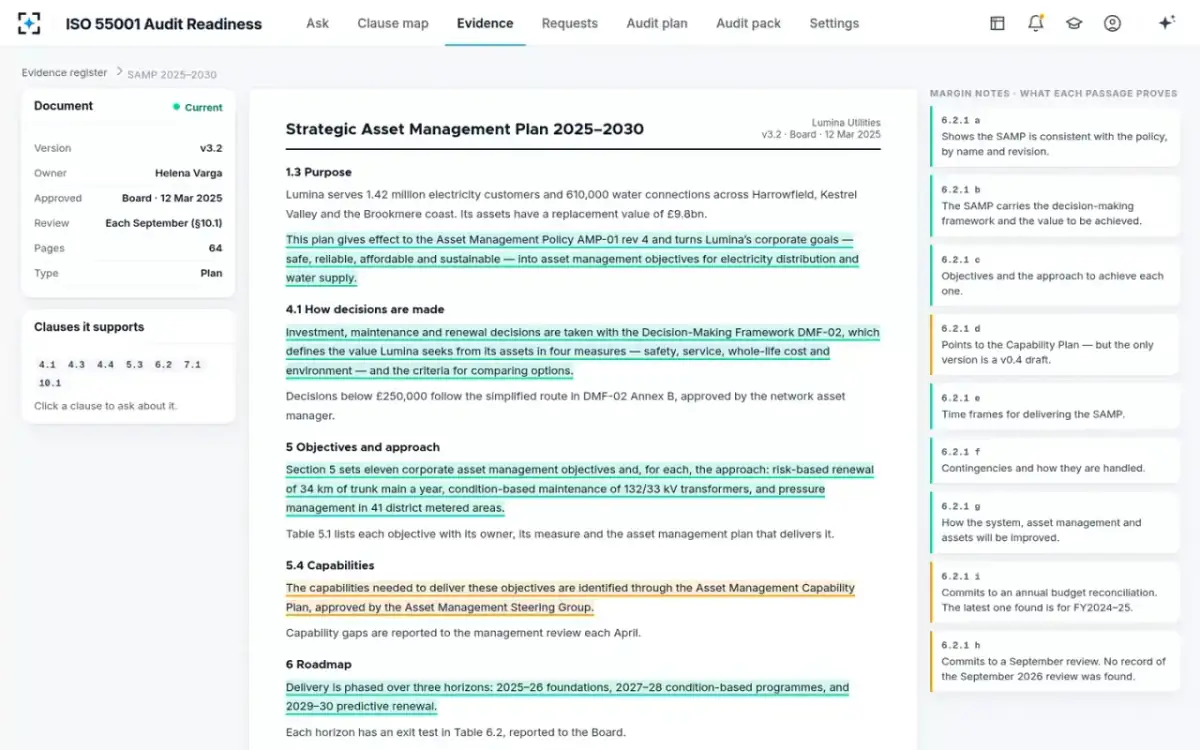

  3. 03The evidence

    Each line with the passage the auditor will read

    Clause mapper

    Each requirement line shows the passages that prove it. SAMP §1.3 puts the Asset Management Policy into effect, naming it and its revision. That is the evidence for line 6.2.1 a. SAMP §4.1 holds the Decision-Making Framework. It also sets the value the utility seeks in four measures: safety, service, whole-life cost and environment. That is the evidence for 6.2.1 b. Open the SAMP and each passage is highlighted, with a margin note on what it proves.

    Margin note, 6.2.1 a: “Shows the SAMP is consistent with the policy, by name and revision.”

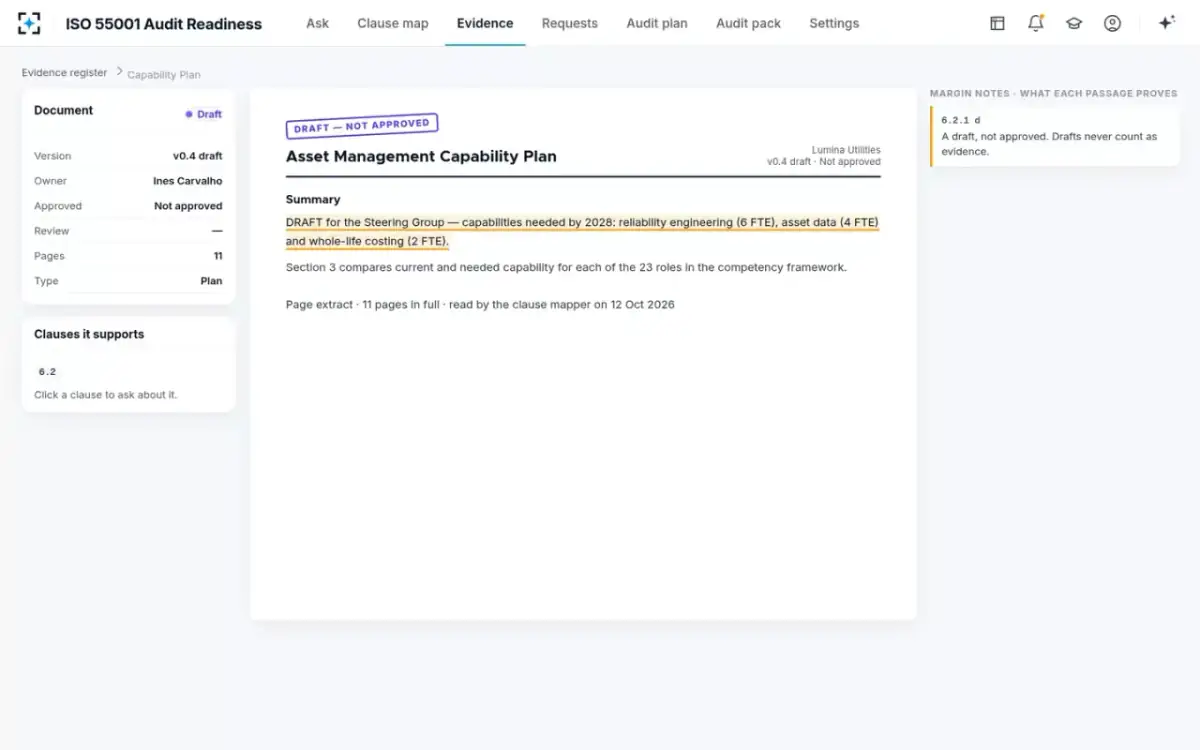

  4. 04Needs work

    A draft does not count

    Evidence checker

    SAMP §5.4 says the capabilities needed are identified through the Asset Management Capability Plan, approved by the Steering Group. The only version on file is v0.4, marked draft and not approved. So line 6.2.1 d is graded as needing work. The next step is for the plan's owner to take v0.4 to the Steering Group's next meeting. Then they send in the approved version.

    “Needs work: the only version is v0.4, which is not approved. Drafts do not count as evidence.”

  5. 05Missing

    Two documents missing, each with its request drafted

    Gap finder and Request drafter

    SAMP §10.1 promises a review each September. Last year's review is on file, but there is nothing for this year. SAMP §9.2 says Finance checks the plans against the approved budget each June. The latest check found is two budget years old. Each gap names the auditor's likely question and its owner. The owners are the head of asset strategy and the finance business partner. Both requests are drafted, due two weeks before the audit, and the systems lead sends them.

    “80 % when the 2 requests come back, 16 of 20 lines.”

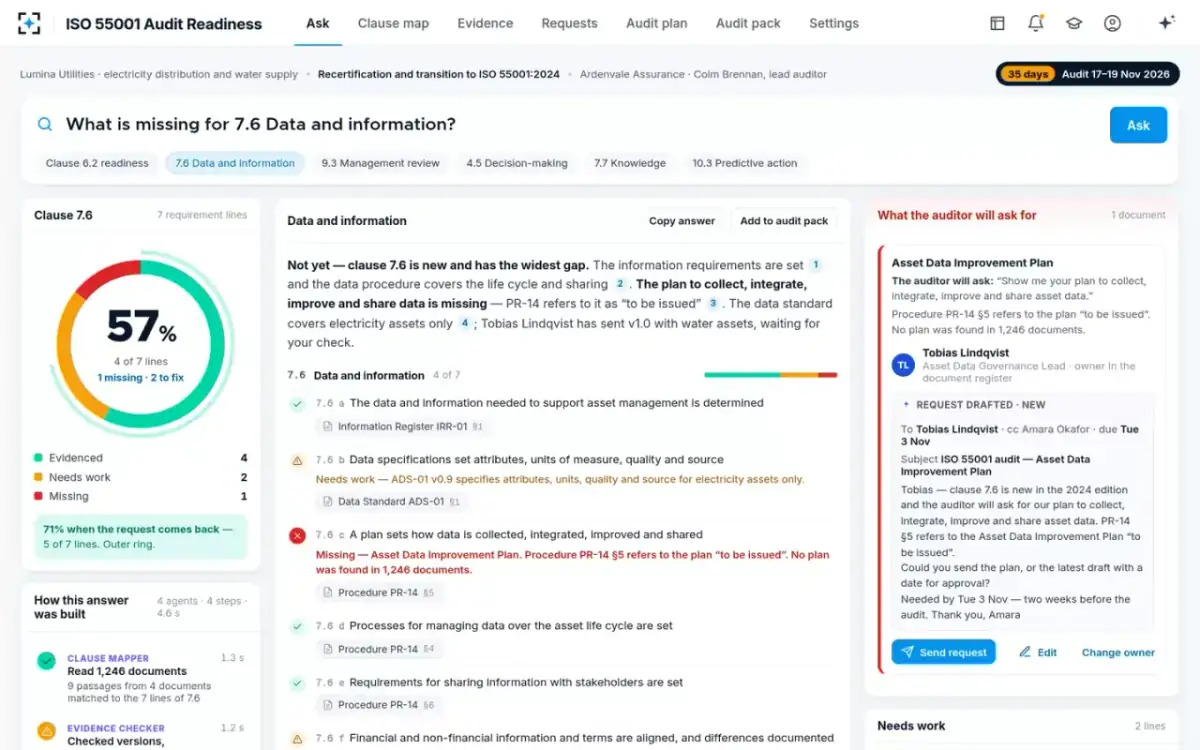

  6. 06The next clause

    Clause 7.6 is new, and has the widest gap

    Asset management systems lead

    The lead asks, “What is missing for 7.6 Data and information?” The clause is 57 % ready, with 4 of 7 lines evidenced. The information requirements register sets out what data is needed. A procedure covers the data life cycle. But the plan to collect, join up, improve and share asset data is missing. The procedure's §5 calls it “to be issued”. The Asset Data Standard, v0.9, covers electricity assets only.

    The auditor will ask: “Show me your plan to collect, integrate, improve and share asset data.”

  7. 07Tracked to the audit

    Each request, its owner and its date

    Asset management systems lead

    Each request moves from drafted to sent, received and accepted. The two clause 6.2 requests are sent, due two weeks before the audit. An earlier request, for evidence of competence in roles that make investment decisions, is 4 days overdue. One click sends reminders to owners who are late. Another request has come back: the Asset Data Standard v1.0, Part 3, which covers water assets.

    “Requests are due 14 days before the audit.”

  8. 08Checked before it counts

    The new data standard is checked, and coverage moves

    Evidence checker

    The systems lead clicks Check it. The evidence checker reads the version and the approval. It is v1.0, approved by the Asset Data Board four days earlier. It reads the scope too: Part 3 covers 11 classes of water asset, from mains to reservoirs. Then it checks the document against requirement 7.6 b. The document is accepted. Clause 7.6 moves to 71 %, and the whole standard to 85 %.

    “Checked by the evidence checker: v1.0 approved · 11 water asset classes · meets 7.6 b”

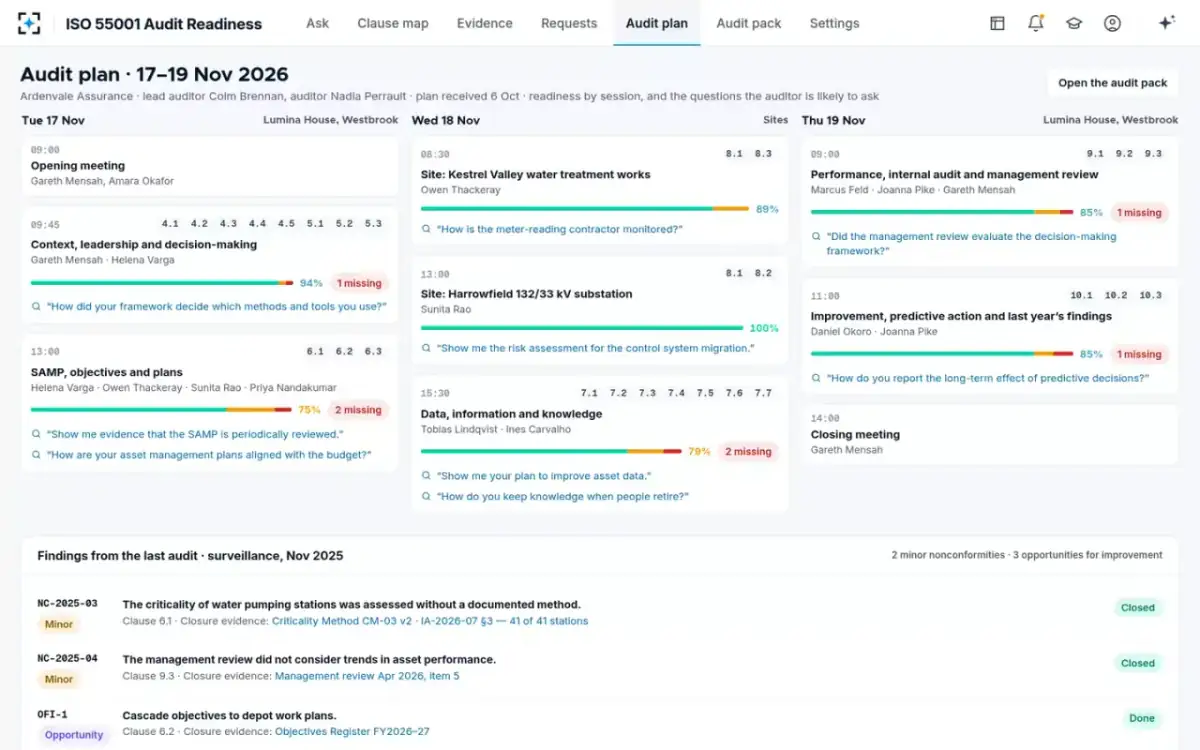

  9. 09Audit week, planned

    Readiness by session, and the questions likely to be asked

    Auditor question answerer

    The certification body's audit plan arrived a week earlier. Each session shows its clauses, who attends and how ready it is. The session on the SAMP, objectives and plans, on the first audit day, is 75 % ready with 2 documents missing. A visit to a 132/33 kV substation is 100 % ready. Last year's two minor findings show as closed, each with the proof that closed it.

    Likely question for 13:00 on the first day: “How are your asset management plans aligned with the budget?”

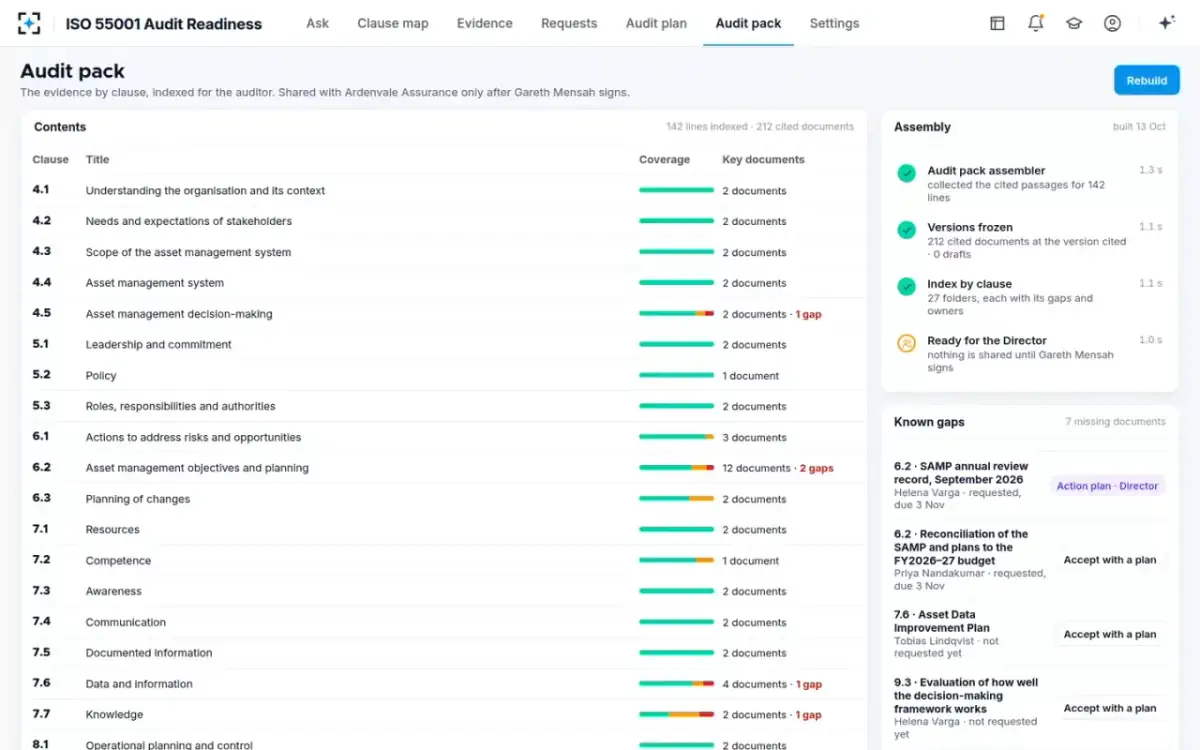

  10. 10Built, then signed

    The audit pack waits for the director’s signature

    Director of asset management

    The audit pack assembler collects the cited passages for all 142 lines. It freezes the 212 cited documents at the version cited, and none of them is a draft. It files them in 27 folders by clause, each with its gaps and owners. Known gaps go to the director with the owner's action plan and date. Nothing is shared with the certification body until the director signs.

    “Ready for the director. Nothing is shared until the director signs.”

Who it’s for

Four jobs that carry ISO 55001 audit readiness through to the signed pack

The run-up to one audit, seen from four seats: how it went by hand, and how it goes now.

Asset management systems lead
Owns the audit plan and the evidence
Before
Chases 20 document owners before each audit and rebuilds the control matrix by hand. The evidence exists. The hard part is proving where it is, line by line, in the week the auditor is there.
Now
Asks about any clause and sees each line with its passage, each gap with its owner and a drafted request to send.
Director of asset management
ISO 55001 management representative
Before
Signs the audit pack and sits in the opening and closing meetings. Does not want to hear about a gap first from the auditor.
Now
Sees each missing document and its action plan before signing, and approves any change to the evidence rules.
Head of asset strategy
Owns the SAMP and decision framework
Before
Owns the documents the auditor reads first. Knows the SAMP was reviewed in September, but not where the minutes are.
Now
Gets one request that names the clause, the SAMP section that promises the review and the date it is needed.
Finance business partner, networks
Ties the budget to the asset plans
Before
Is asked for something about the budget in the last two weeks, with no word on which table or by when.
Now
Is asked for the current check of the plans against the approved networks budget, covering capital and operating spend. It is due two weeks before the audit.
The agents

From clause mapper to pack assembler: the agents of ISO 55001 readiness

Six agents match each document to its clauses, name what is missing and draft the requests. The asset management office sends them and the director signs.

Clause mapper

Reads each document in the evidence library and matches passages to the 142 requirement lines of ISO 55001:2024. It records the line, the passage and why it applies. It runs again when a document changes.

  • Never marks a line evidenced without a cited passage
  • Never quotes anything outside the evidence library
Evidence checker

Checks each evidence document's version, approval, date, scope and review period. It grades each one current, out of date, draft or missing, using the evidence rules in Settings.

  • Never accepts a draft or an unsigned document as evidence
  • Never changes a document
Gap finder

Looks at each line with no current evidence. In the auditor's words, it names the document the auditor will ask for, the likely question and why the evidence falls short.

  • Never grades a finding. Only the auditor does that
Request drafter

Finds the owner of each missing document in the document register. It drafts a short, specific request with the document, the clause, the auditor's likely question and a due date 14 days before the audit.

  • Never sends a request. The systems lead sends it
  • Never promises a date for the owner
Auditor question answerer

Answers an auditor's question during the audit with the cited passages. It logs the question, the answer and who showed it. If no evidence exists, it says so plainly.

  • Never answers from outside the evidence library
Audit pack assembler

Collects the cited documents at the version cited and builds an index by clause and line. It lists the known gaps with their owners and action plans.

  • Never shares the pack before the director signs
Director of Asset Management

Signs the pack and accepts known gaps.

Ask in plain words

Ask the evidence library about a clause, a document or an open request

Ask in plain words about any clause, document or request, or say what to do. Each answer cites its passage. These answers use the sample data.

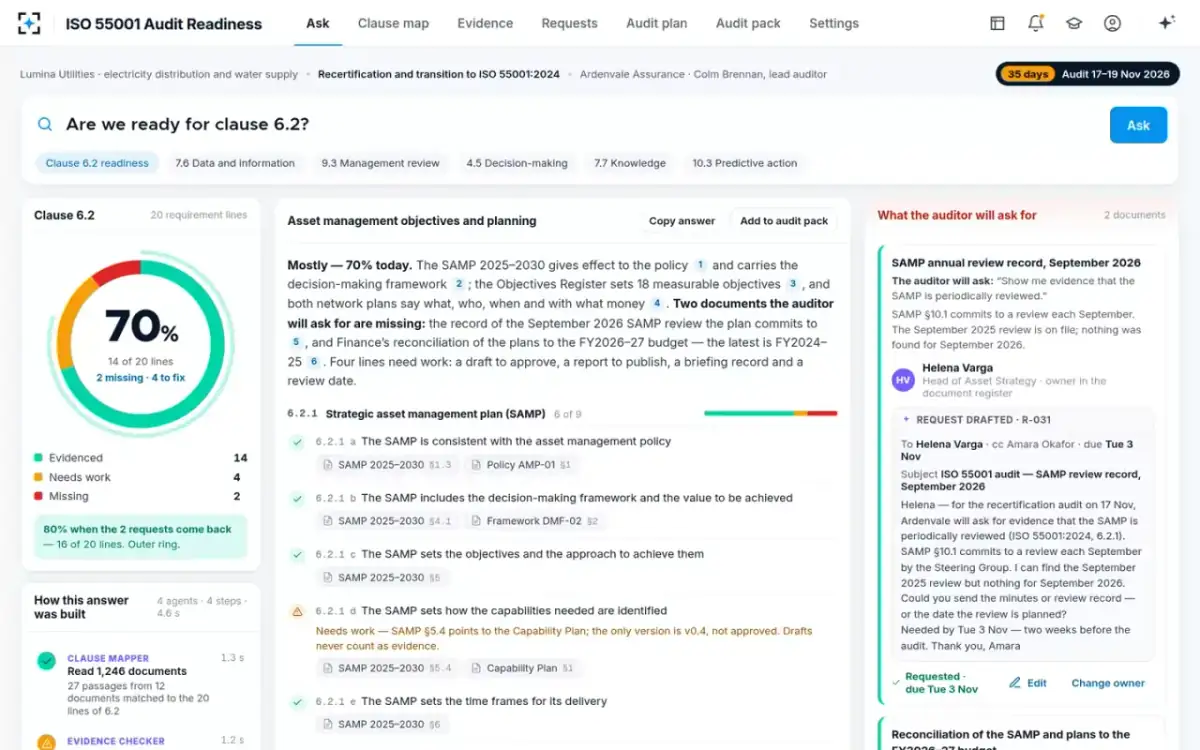

Are we ready for clause 6.2?

70 %. Of the 20 requirement lines, 14 are evidenced, from the SAMP to the Objectives Register. Two documents are missing. One is this year's SAMP review record, which the plan promises. The other is the current budget check, as the latest is two budget years old. Both requests are drafted, to the head of asset strategy and the finance business partner.

Which gaps could the auditor raise as a major finding?

None on its own. But two gaps sit at the heart of 6.2.1. The SAMP has no record of its yearly review, and the plans have no current tie to the budget. The other gaps are drafts to approve or records to file. Only the auditor grades a finding.

Is last year’s pump-station criticality finding closed?

Yes. The finding was raised at last year’s audit. The revised criticality method was approved early this year, and internal audit confirmed it on 41 of 41 pumping stations in September. The closure evidence is in the audit pack.

Send the two 6.2 requests

Sent. One went to the head of asset strategy for the SAMP review record. The other went to the finance business partner for the budget check. Both are due two weeks before the audit, with a reminder every 5 days. Clause 6.2 reads 80 % once both are back and checked.

The screens

Inside ISO 55001 audit readiness: clause map, requests and audit pack

From the working solution, on its sample data. Pick one to see it large.

Ask about a clause“Are we ready for clause 6.2?” The coverage gauge, each requirement with its cited passages, and the missing items the auditor will ask for.
Requests sent from the answerBoth requests sent to their owners, due two weeks before the audit, with the coverage the clause will reach when they come back.

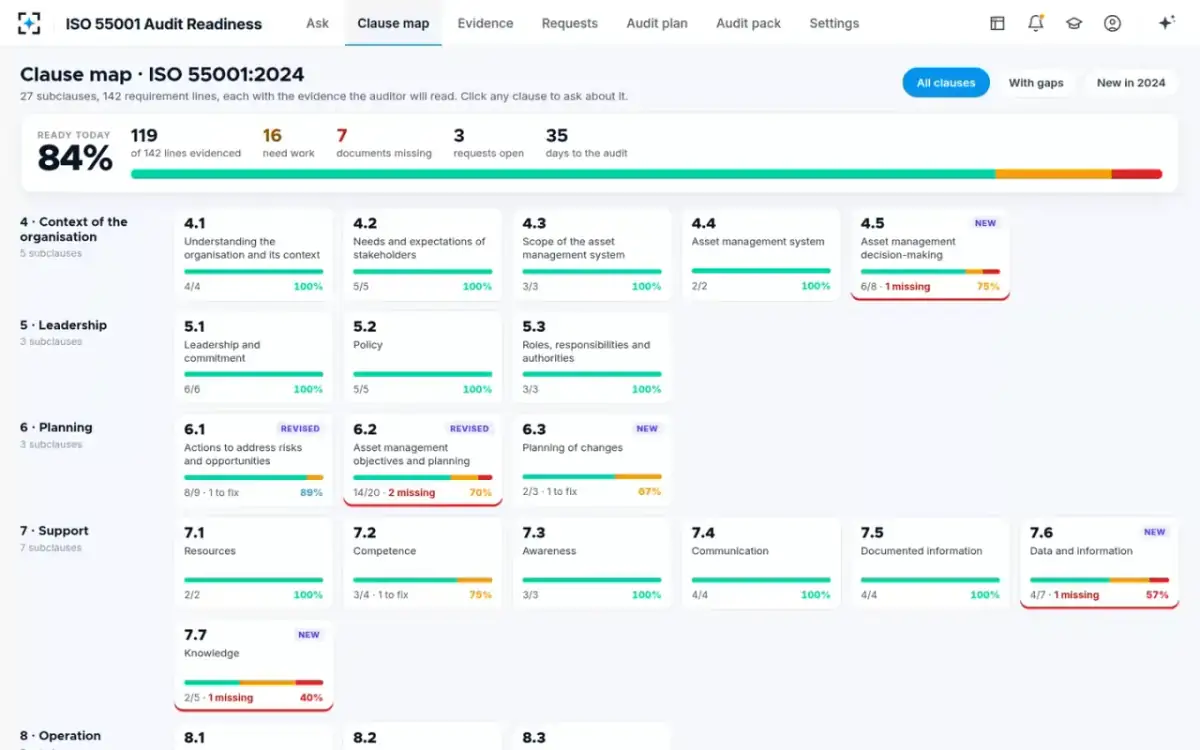

The clause mapAll 27 subclauses of ISO 55001:2024 with their coverage, the clauses new or revised in 2024 marked, and the gaps in red.
Clause 7.6 Data and informationA clause new in 2024: the lines evidenced, the data standard that covers electricity only, and the missing Asset Data Improvement Plan.

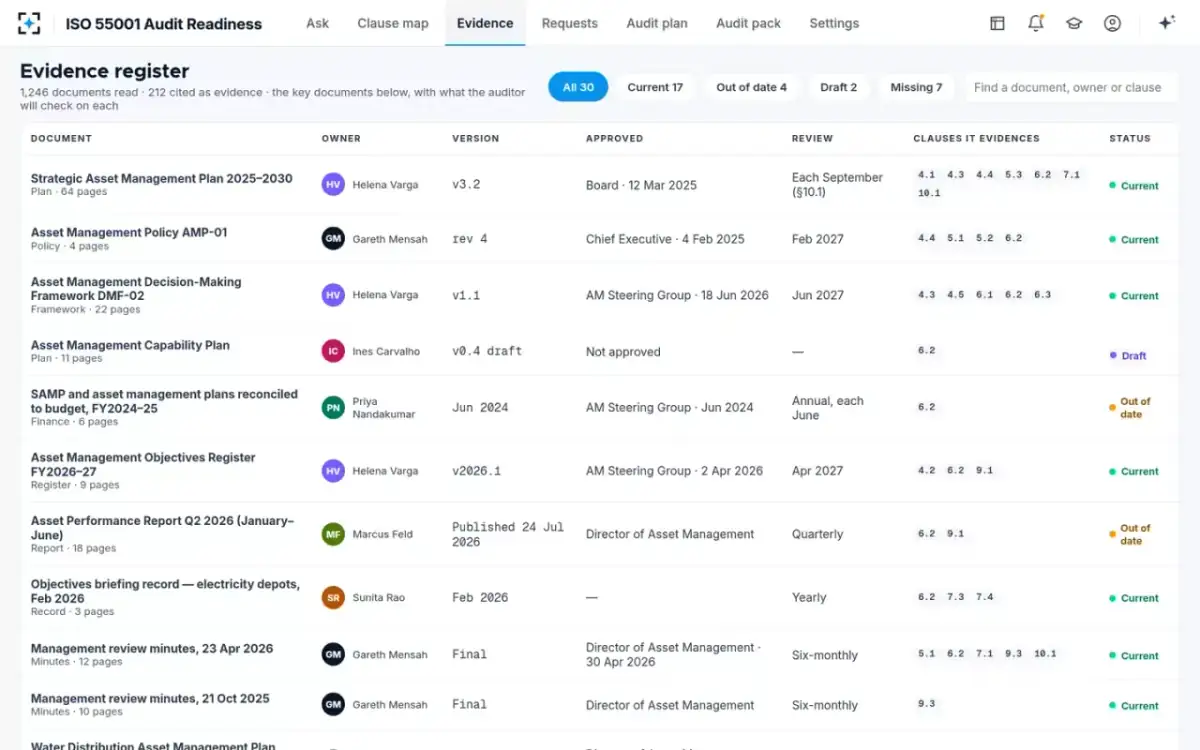

The evidence registerThe main documents, each with its owner, version, approval, review date, the clauses it proves and its status.
A document, passage by passageThe SAMP with each cited passage highlighted and a margin note on the requirement line it proves.
A draft, graded as a draftThe Capability Plan v0.4 is still unapproved. It does not count as evidence until the Steering Group approves it.

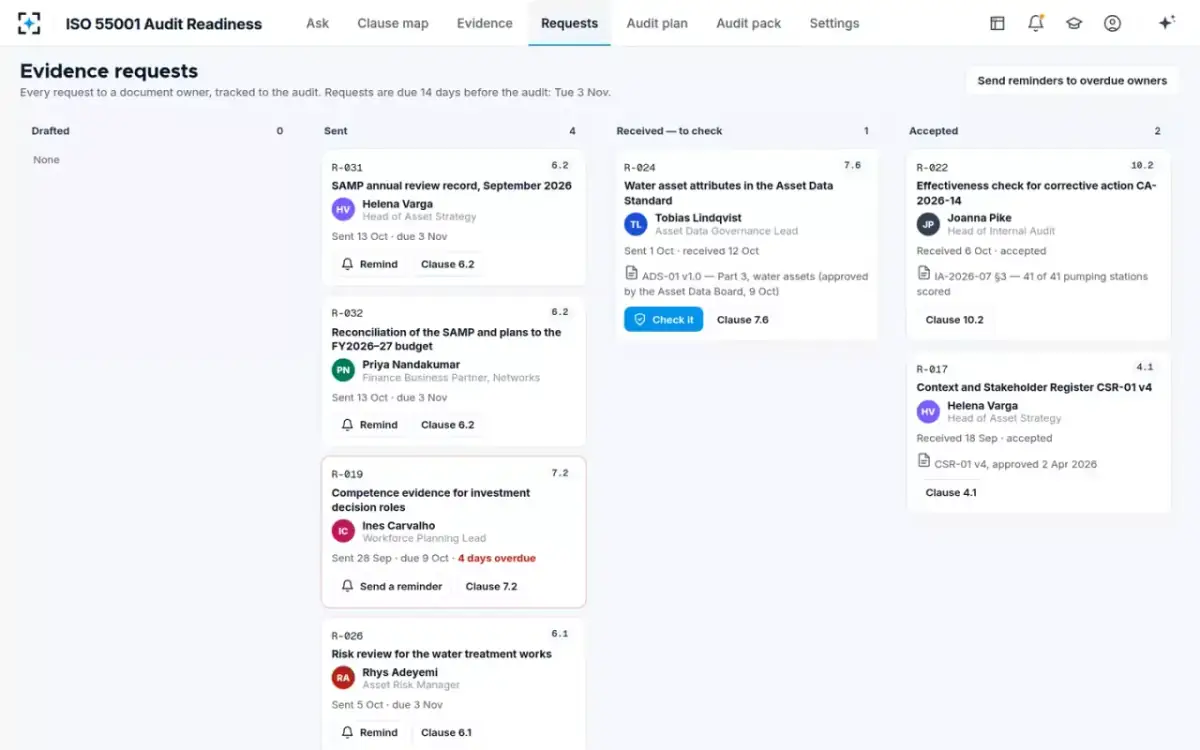

Evidence requestsEach request to a document owner, from drafted to sent, received and accepted, tracked up to the audit. Overdue ones are flagged.

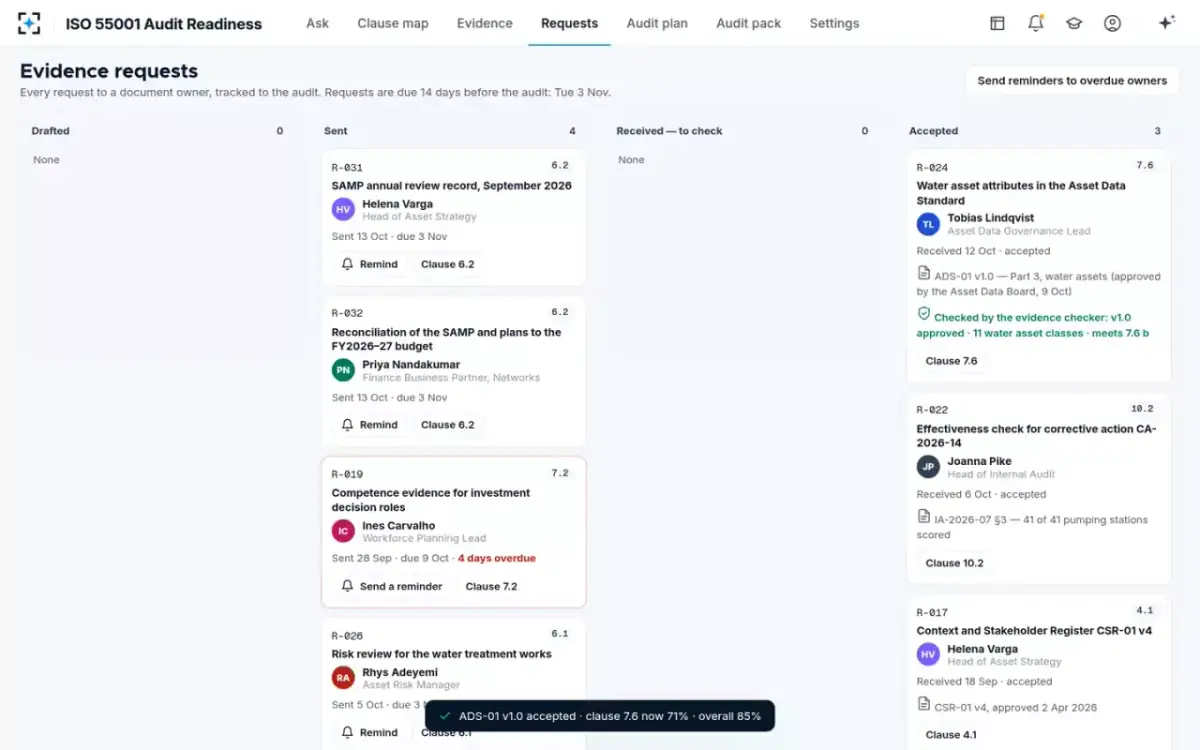

A returned document, checkedThe new data standard, checked for version, approval, scope and its requirement line before it is accepted.
The audit planEach session of the three audit days with its clauses, attendees, readiness and likely questions. Last year's findings show their proof of closure.
The audit packThe evidence by clause at the version cited, the known gaps with their action plans, and the Director's sign-off.
The rulesThe audit, the evidence rules, the request rules and the owner of each group of clauses.
Governance

An ISO 55001 audit pack the director signs, built only from cited passages

Each evidenced line cites a passageNo line counts as evidenced without a cited passage. Each passage opens at the right place in its document, with a margin note on what it proves.
A draft does not count as evidenceA document marked draft, or with no approval, is graded “draft”. Performance reports older than a quarter need work. Review records older than 12 months count as missing. Where a line applies to both electricity and water, the evidence must cover both.
Agents draft, people sendThe request drafter writes each request, but only the asset management systems lead sends it. The owner on a request can be changed before it goes. A document that comes back is checked before it counts.
Only the auditor grades a findingThe gap finder names what is missing and what the auditor is likely to ask. No agent grades a nonconformity.
The director signs the packThe audit pack goes to the certification body only after the director of asset management signs it. The director accepts each known gap with the owner's action plan and date. Changes to the evidence rules need the director's approval too.
Each step on the audit trailEach agent step is recorded, and so is each person's action, such as a request sent, a document accepted or the pack built. The pack carries its index and the version of each document it cites.

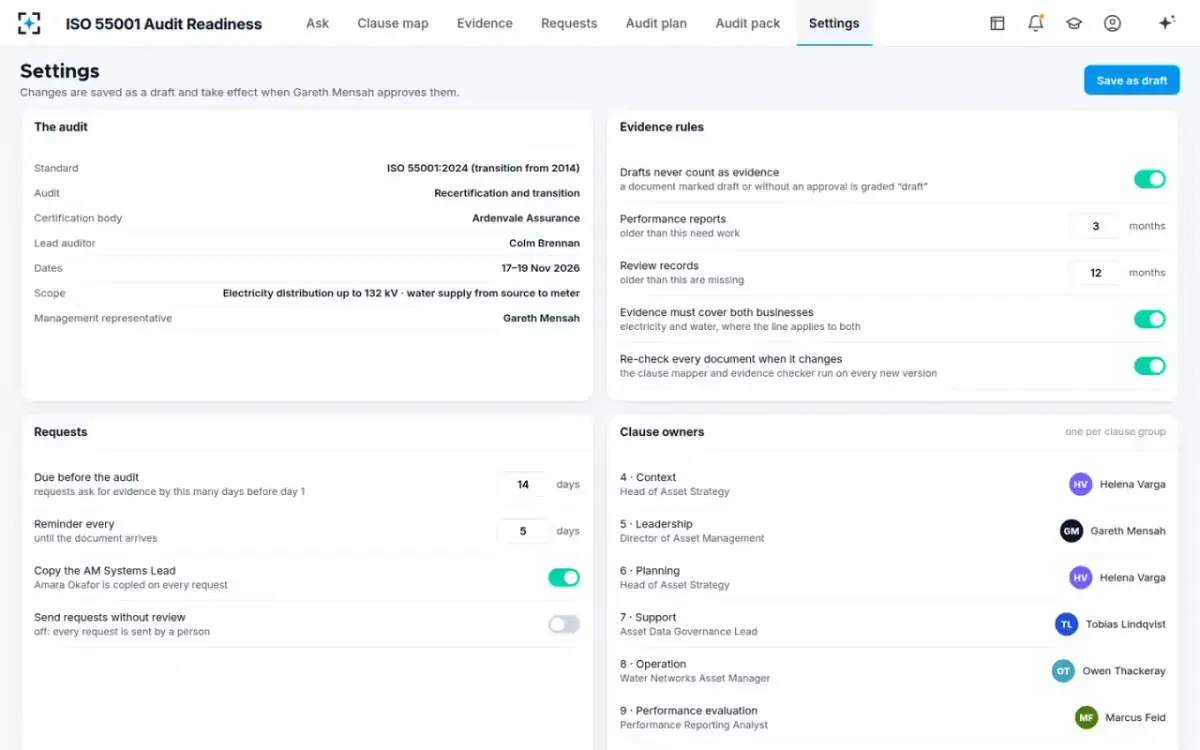

Configuration

When a draft counts, when requests are due and who signs: the audit settings

The audit, how evidence is graded, how requests go out and who owns each clause are all settings. Changes are saved as a draft and take effect when the director approves them.

SettingDefaultChoose from
Drafts never count as evidenceOnOn · Off. A document marked draft or with no approval is graded “draft”
Performance reports older than this need work3 monthsA number of months
Review records older than this are missing12 monthsA number of months
Evidence must cover both businessesOnOn · Off. Covers electricity and water, where the line applies to both
Re-check every document when it changesOnOn · Off. The clause mapper and evidence checker run on each new version
Requests due before the audit14 daysA number of days before day 1 of the audit
Reminder every5 daysA number of days, until the document arrives
Send requests without reviewOffOn · Off. When off, a person sends each request
Connections

Connected to the SAMP, the registers and the last audit reports

SAMP and asset management plansthe strategic plan, network plans and lifecycle plans for electricity and water
Policies, frameworks and proceduresthe asset management policy, decision-making framework, data and competency standards
KPI and performance reportsquarterly asset performance reports against the objectives
Registersobjectives, risk, information requirements, context and stakeholder registers
Board and committee paperssteering group approvals and management review minutes
Prior audit findingscertification body reports, internal audit reports and closure evidence
What it changes

Days to an audit pack, owned lines and transition findings for audit readiness

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0
major findings at the ISO 55001:2024 transition audit, the design goal, with each gap found before the auditor
142 of 142 lines
checked before the auditor
target
2days
to an audit pack, from about 6 weeks of evidence hunting
By hand≈ 6 weeks
With agents2 days
target
142lines
each with a named owner and cited evidence, so readiness does not rest on one person
TodayWith agents

“Demo” means seen in the working solution, on its sample utility data. “Target” means the design goal, to be measured in the live solution. “Estimated” means our estimate: about 6 weeks of part-time work by 3 or 4 people per audit cycle, for a utility running electricity and water. The 90 days comes from a certification firm, Glocert, on common ISO 55001 audit findings. A major finding must be closed and checked before certification, usually with a follow-up audit within about 90 days. “Typical” means published figures: AWWA found in 2025 that 21 % of water utility staff can retire within 5 years. Context sources are NQA's ISO 55001 transition gap analysis (2024) and ISO TC 251. UKAS gives 31 July 2027 as the deadline for the move to ISO 55001:2024 (Water Magazine, 2026). Names on the screens are sample data.

Questions

ISO 55001 audit readiness, the transition and the auditor: common questions

What is ISO 55001 audit readiness software?

ISO 55001 audit readiness software shows, clause by clause, whether an asset management system has the evidence an ISO 55001 auditor will ask for. ISO 55001 Audit Readiness maps your own documents to each requirement line of ISO 55001:2024. It cites the passage that proves each one. It also names what is out of date, still a draft or missing, with its owner and a drafted request.

How does ISO 55001 Audit Readiness work?

You ask in plain words: “Are we ready for clause 6.2?” The clause mapper matches passages from your documents to the clause's lines. The evidence checker checks version, approval, date and scope. The gap finder names what is missing, and the request drafter writes a request to each owner. In the sample case it read 1,246 documents and answered in 4.6 seconds.

Does it cover the ISO 55001:2024 transition?

Yes. It maps all 27 subclauses and 142 requirement lines of the 2024 edition. It marks the clauses that are new or revised. These include 4.5 on decision-making, 6.2.1 on what the SAMP must contain and 6.3 on planning of changes. They also include 7.6 on data and information, 7.7 on knowledge, 10.3 on predictive action and the new management review inputs in 9.3. Certified organizations must move to the 2024 edition by 31 July 2027.

Can it answer auditor questions during the audit?

Yes. The auditor question answerer answers from the evidence library only. It cites each passage and logs the question, the answer and who showed it. If no evidence exists, it says so plainly. Before the audit, the audit plan shows the questions each session is likely to bring.

Does it grade nonconformities or replace the certification body?

No. The gap finder names what is missing and what the auditor is likely to ask. No agent grades a finding, because only the auditor does that. The solution prepares your evidence, and the certification body still audits it.

Does it work for both electricity and water?

Yes. An evidence rule checks that the evidence covers both businesses where a line applies to both. In the sample case, it found a record of the objectives briefing for nine electricity depots. There was none for the six water depots. It also found an asset data standard that covered electricity assets only.

Who sends the requests, and who signs the audit pack?

Agents draft the requests. Only the asset management systems lead sends them, and documents that come back are checked before they count. The director of asset management accepts known gaps with an action plan and approves changes to the evidence rules. The director also signs the audit pack before anything is shared with the auditor.

What does an asset management office provide to start on ISO 55001 audit readiness?

Your SAMP, asset management plans, document register and last audit report. The Agentic Solution Engine builds and deploys it from those requirements and documents. It goes live once each quality gate has passed. We will walk you through it on your own evidence first.

Check your ISO 55001 audit readiness
against your own evidence.

We'll run ISO 55001 Audit Readiness on a sample of your own SAMP, plans and last audit report.
