- Before
- Reviews each flight of the 132 kV and 66 kV network one image at a time, more than 6,000 images a line. Only twelve of them count, and what matters is whether those are getting worse.
- Now
- Starts the morning on a ranked gallery, with growing and Urgent boxes first. Confirms or rejects each box with a key press.
A line's drone flight, screened overnight and reviewed by morning
The utility's overhead lines department flies each line once a year. On a set Monday, the survey contractor flies one 132 kV double-circuit line of 148 structures. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Overnight
Each image matched, screened, compared and ranked before morning

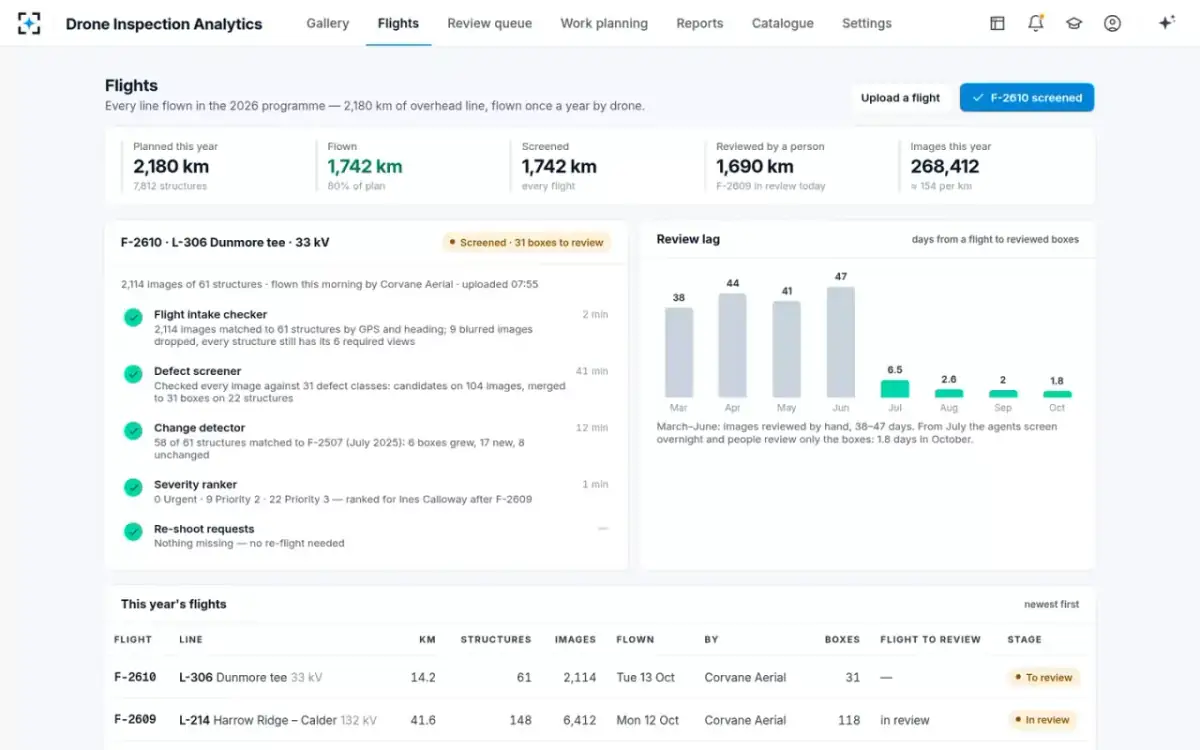

Flight intake checker, Defect screener, Change detector, Severity rankerThe drone pilot uploads the flight at 16:40: 6,412 images, out of 268,412 in the year's program so far. By 17:31 each image is matched to its structure. Two re-shoots are requested, one of a phase view and one of a footing. By 19:52 the screener has found possible defects on 425 images, merged into 118 boxes on 64 structures. By 20:48, 141 of 148 structures are compared with last year's flight. At 21:05 the queue is ranked: 2 Urgent, 30 Priority 2, 86 Priority 3. The same five steps run on demand from the Flights screen, here for a 33 kV branch line flown this morning.
Review time: 38 to 47 days by hand earlier in the year, and 1.8 days on this flight.
- 0207:00

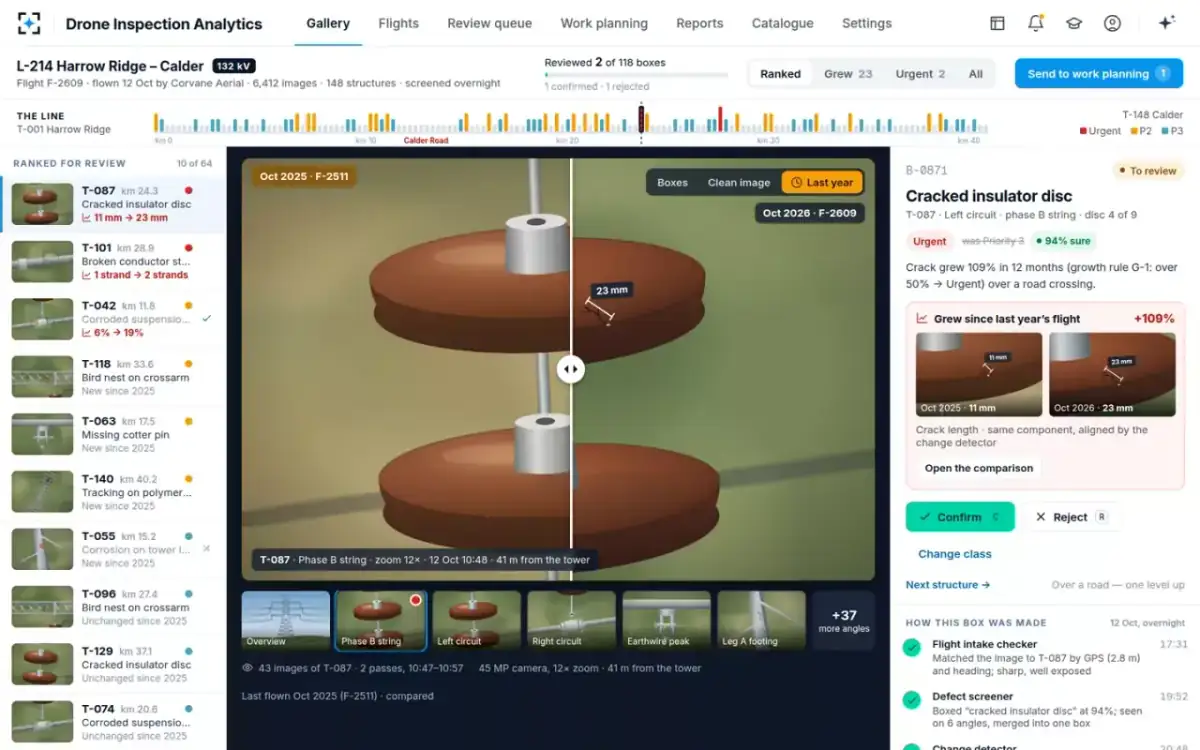

The gallery opens on the box that matters most

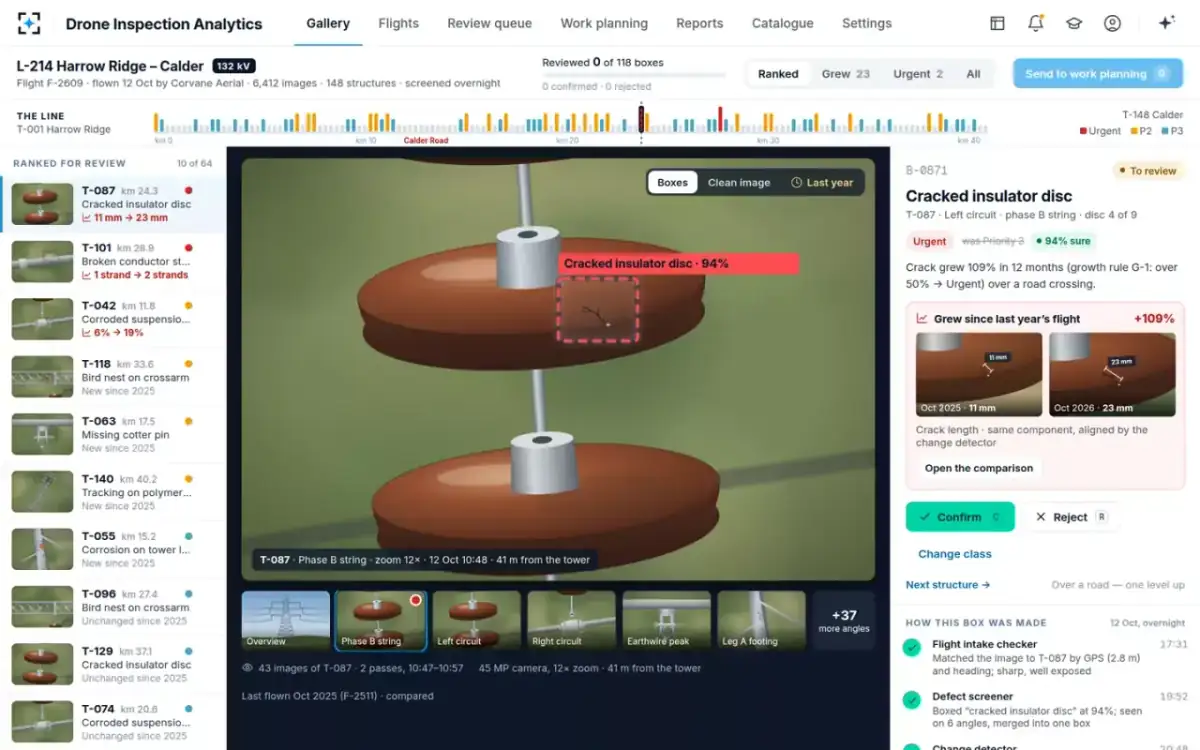

Lead line inspectorAcross the top is the line itself. All 148 structures show as ticks, colored by their worst box, with the road crossing marked. On the left, structures are ranked for review, with growing and Urgent ones first. In the center is one structure's phase B insulator string at 12× zoom, boxed “Cracked insulator disc · 94%”. On the right is the box under review, Urgent and formerly Priority 3. It shows how the box was made, agent by agent, with the time of each step.
“Crack grew 109% in 12 months (growth rule: over 50% → Urgent) over a road crossing.”
- 03One key press
Confirm the clamp, move to the next structure

Lead line inspectorOn a structure along the escarpment, rust on the phase C suspension clamp has spread from 6% to 19% of the fitting. The corrosion rule raises it one level, to Priority 2. The inspector presses C and the box is confirmed. The gallery moves on to a structure in the woods. A new bird nest sits 0.9 m from a live jumper, a short loop of wire at the tower. The screener is 97% sure.
“Confirmed · Priority 2, within 90 days”
- 04With a reason
Rust that is only fresh primer, rejected

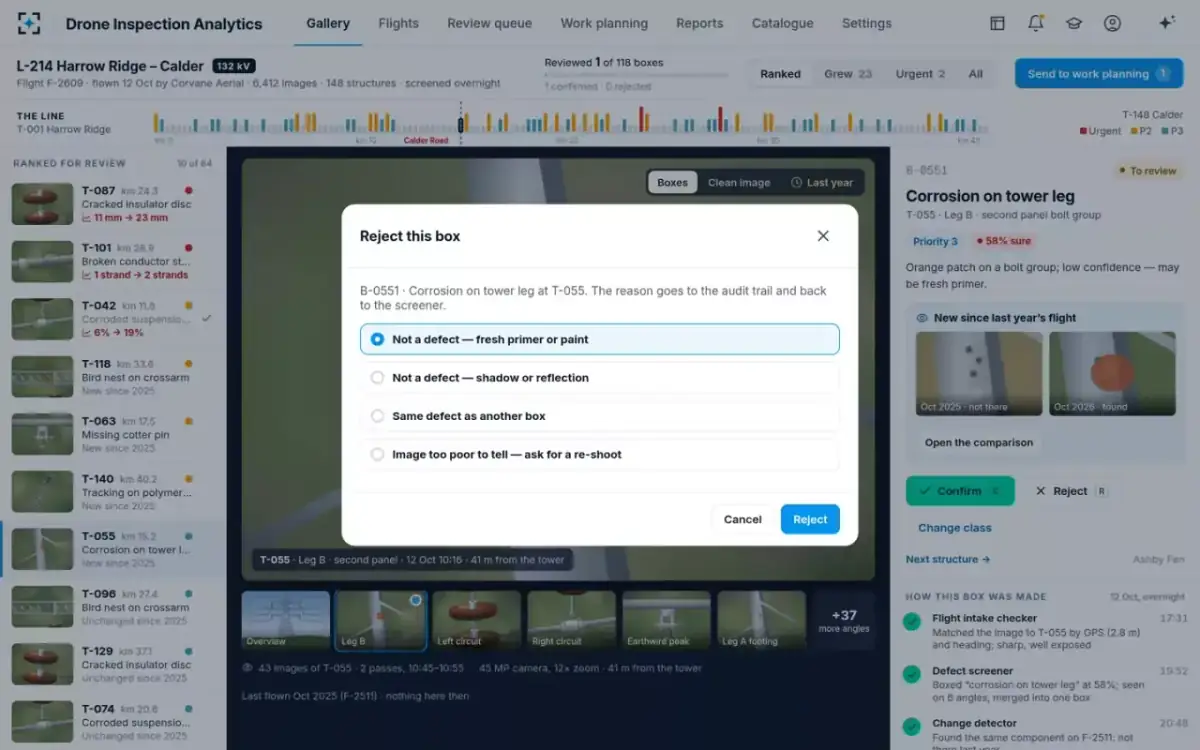

Lead line inspectorOn another structure, the screener boxed “corrosion on tower leg” at 58%. It is an orange patch on a group of bolts, flagged as low confidence and possibly fresh primer. In fact it is a repaired bolt. The inspector presses R and picks the reason, “Not a defect: fresh primer or paint”. The reason goes to the audit trail and back to the screener so it can learn.
“Each box at 40% or more is seen by a person.”
- 05Last year
The same disc, a year apart

Change detectorBack on the cracked string, the Last year button turns the image into a slider between last year's flight and this one. The inspector drags it across the string. The change detector found the same part on last year's flight. It lined the two up on fixed points and measured the crack against the 255 mm disc: 11 mm then, 23 mm now.
“Crack length · same component, aligned by the change detector”

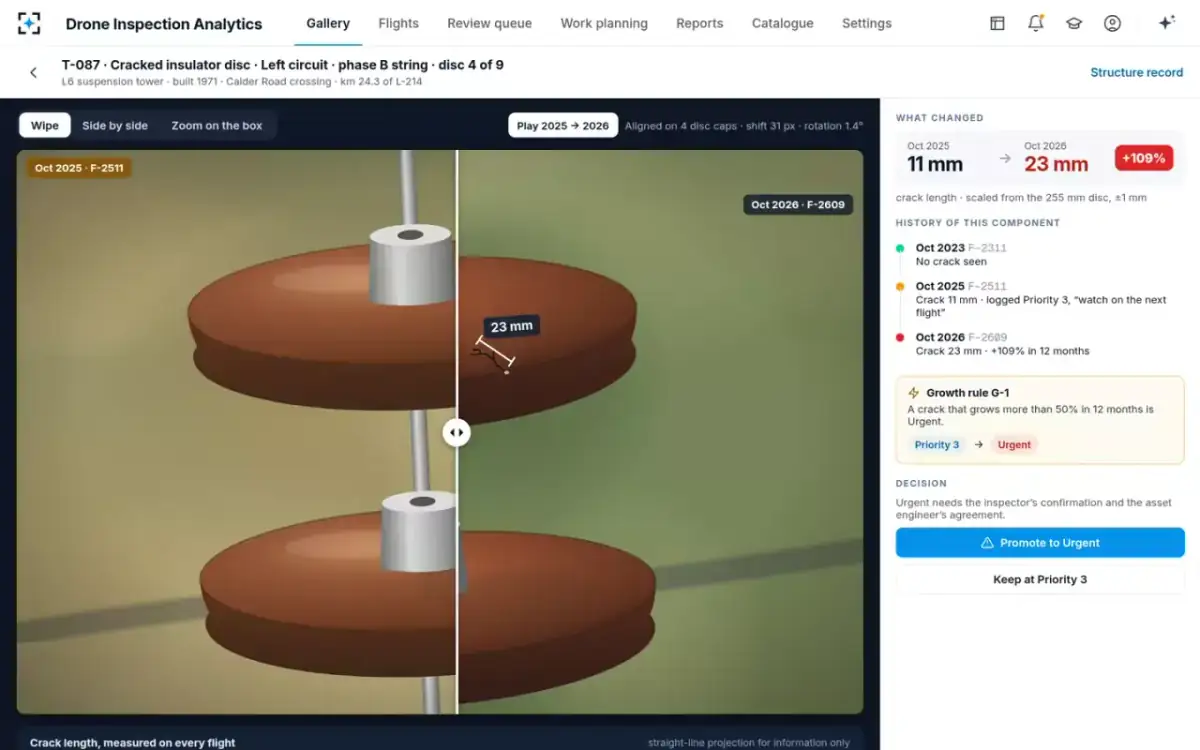

- 06The comparison
The measurement, its scale, and the rule that fired
Change detector and Severity rankerThe comparison shows the disc full size, as a slider, side by side or zoomed on the box. The two images are lined up on the four disc caps. The part's history is shown too. No crack was seen on an earlier flight. Last year the crack was 11 mm, logged Priority 3, “watch on the next flight”. Now it is 23 mm, up 109% in 12 months. The growth rule says a crack that grows more than 50% in 12 months is Urgent.
“crack length · scaled from the 255 mm disc, ±1 mm”
- 07Agreed at 09:17
Urgent needs two people

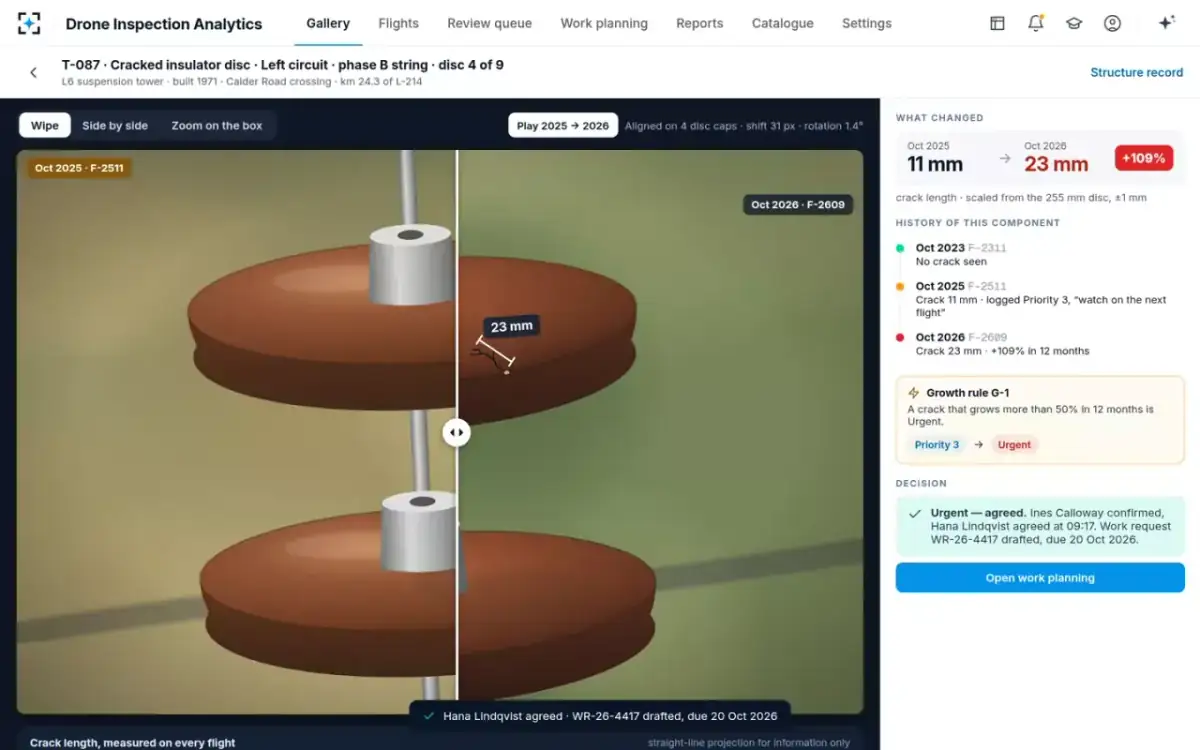

Senior asset engineerThe inspector raises the box to Urgent, due within 7 days, and adds a note. The crack on disc 4 has doubled since last year's flight, and the string is over the road crossing. The box goes to the senior asset engineer, who agrees from a phone. Only then is the work request drafted.
“Urgent, agreed. Confirmed by the inspector, agreed by the asset engineer at 09:17. Work request drafted, due within 7 days.”
- 08Drafted

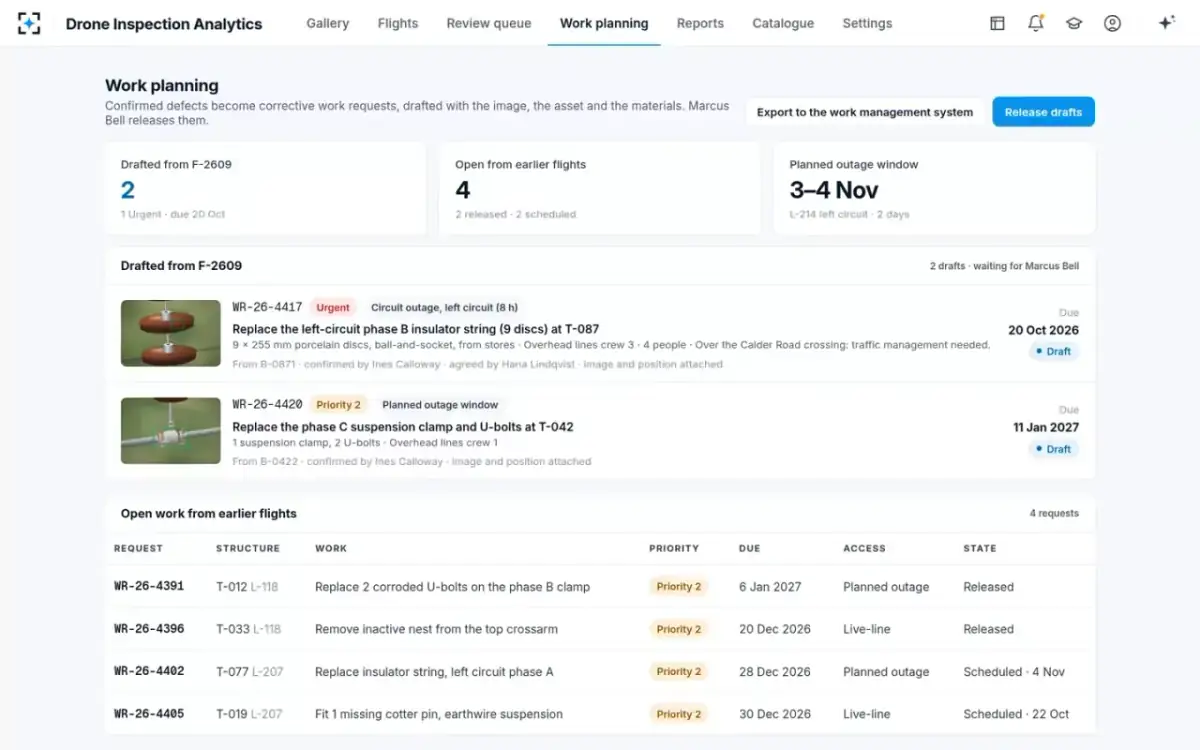

Work requests with the part, the crew and the outage
Work request drafterThe first request replaces the left-circuit phase B insulator string on the crossing structure. It lists 9 × 255 mm porcelain discs, ball-and-socket, from stores. It needs an overhead lines crew of four people, a circuit outage of 8 hours, and traffic control for the road crossing. A second request replaces the phase C clamp and U-bolts on the escarpment structure, due within 90 days. Each carries the image and its position.
Drafts only. The maintenance planner releases them to the work management system.
- 09Written
The line's inspection report, from the reviewed boxes

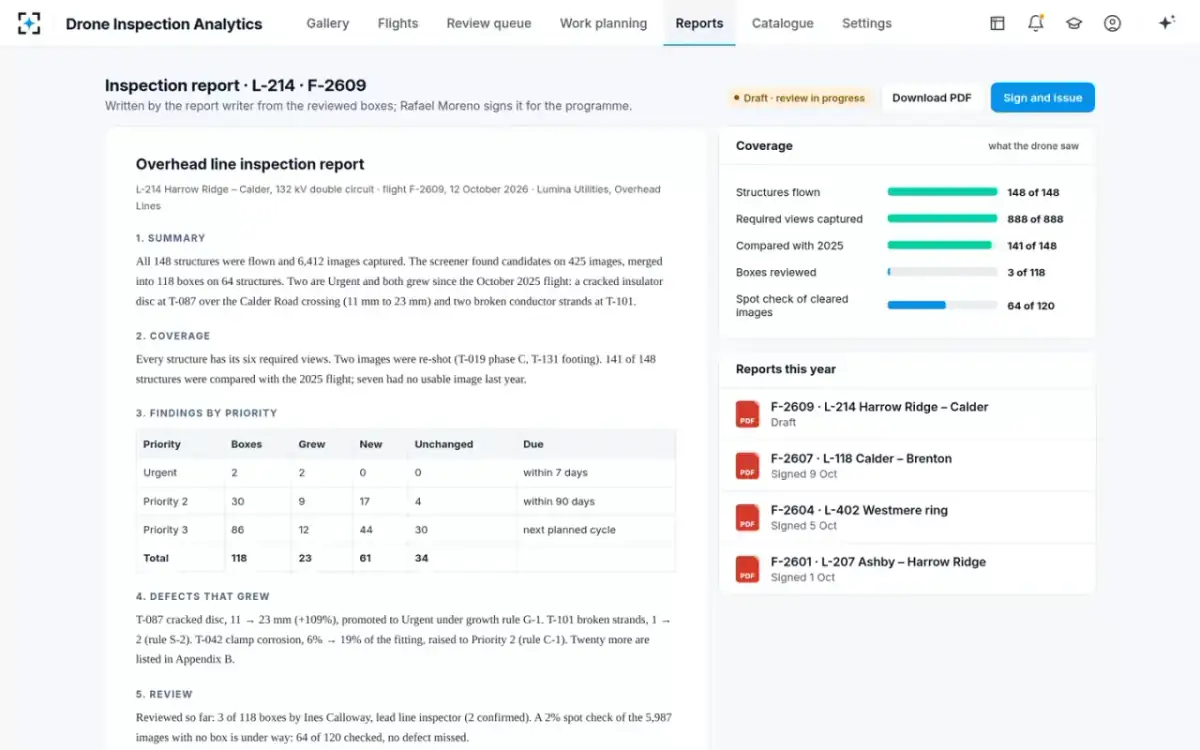

Report writer · Inspection program managerThe report writer drafts the overhead line inspection report for the flight. It covers a summary, coverage, findings by priority, the defects that grew and the review status. Each structure has its six required views, and 888 of 888 were captured. A person is spot-checking 2% of the 5,987 images with no box. So far 64 of 120 have been checked, and no defect has been missed. The inspection program manager signs and issues the report, and what the signature means is recorded.
The report does not sign itself, and it always lists the boxes still open.
