- Before
- Spends Tuesday night and Wednesday stitching twelve decks into one brief, with no time to test any colour.
- Now
- Starts Wednesday with four colour differences to decide, each with its cited findings, and the brief drafted from her decisions.
One week of Project Harbor, from reports in to brief approved
Northwind Bio closed on Calderra Biosciences on Sep 1. It is Wednesday of week 6, Day 37 of 100, and the steering committee meets Thursday at 08:00. Here is the IMO’s week, screen by screen, in the working solution.
- 01Wednesday morning
The integration, on evidence
Lena Ortiz · IMO leadLena opens the command centre. Status on evidence is amber — 5 amber and 1 red on evidence, where the leads reported 3 amber — and 4 colours wait for her decision. Wave 1 go-live on Nov 2 is 26 days away at 80% readiness; the Year-1 synergy plan is $162.4M, with $18.4M confirmed.
“Read by agents Tue 17:06 · rules from playbook 4.3”
- 02Tue 17:00 deadline

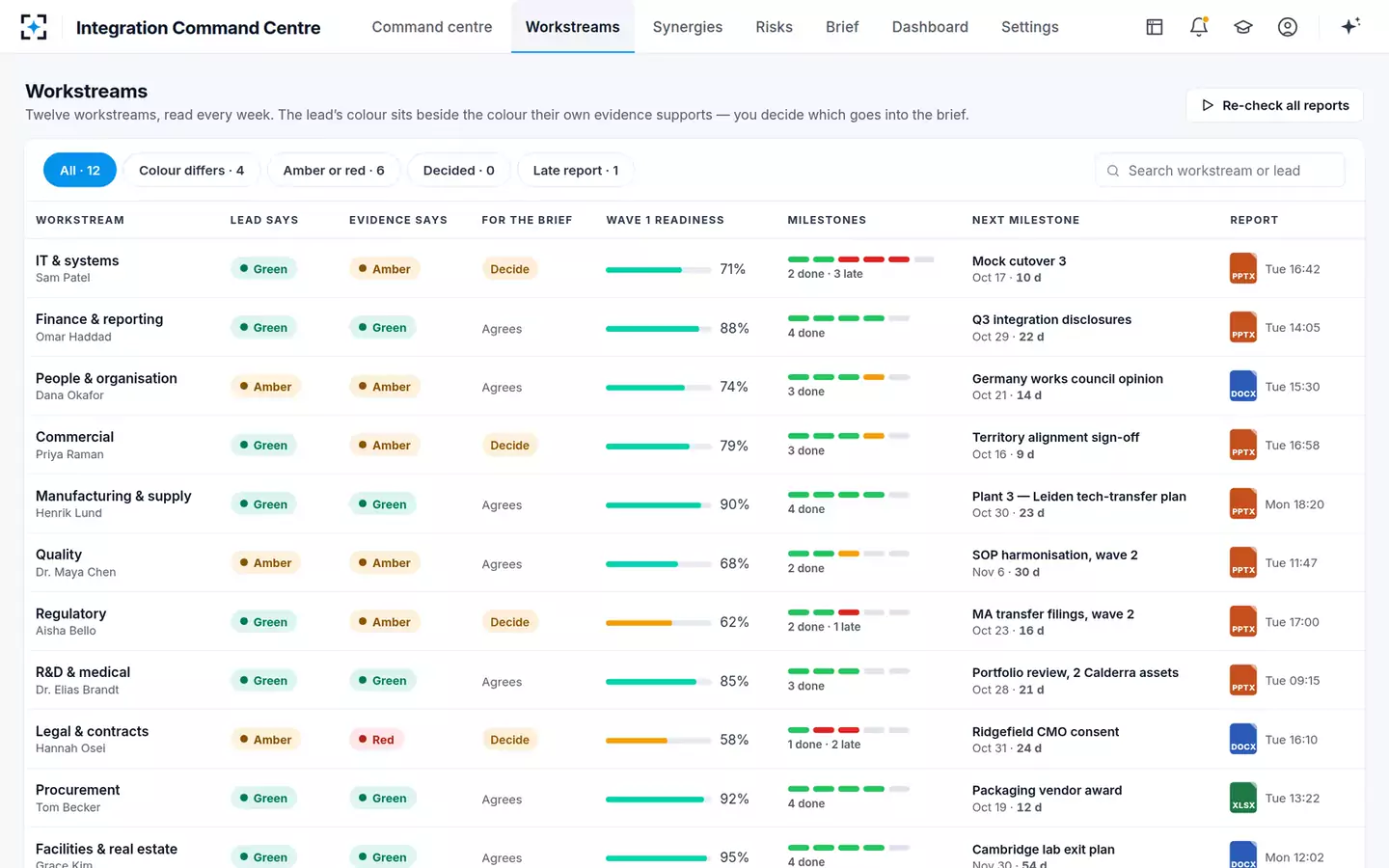

Twelve workstreams, the lead’s colour beside the evidence
Status Report ReaderEleven of twelve reports arrived by the Tuesday 17:00 deadline and every one has been read and cited. Each row shows what the lead says, what the evidence says, Wave 1 readiness and the next milestone. Communications arrived Wed 08:12, after the deadline, and shows as late until it is read.
- 038.6 seconds

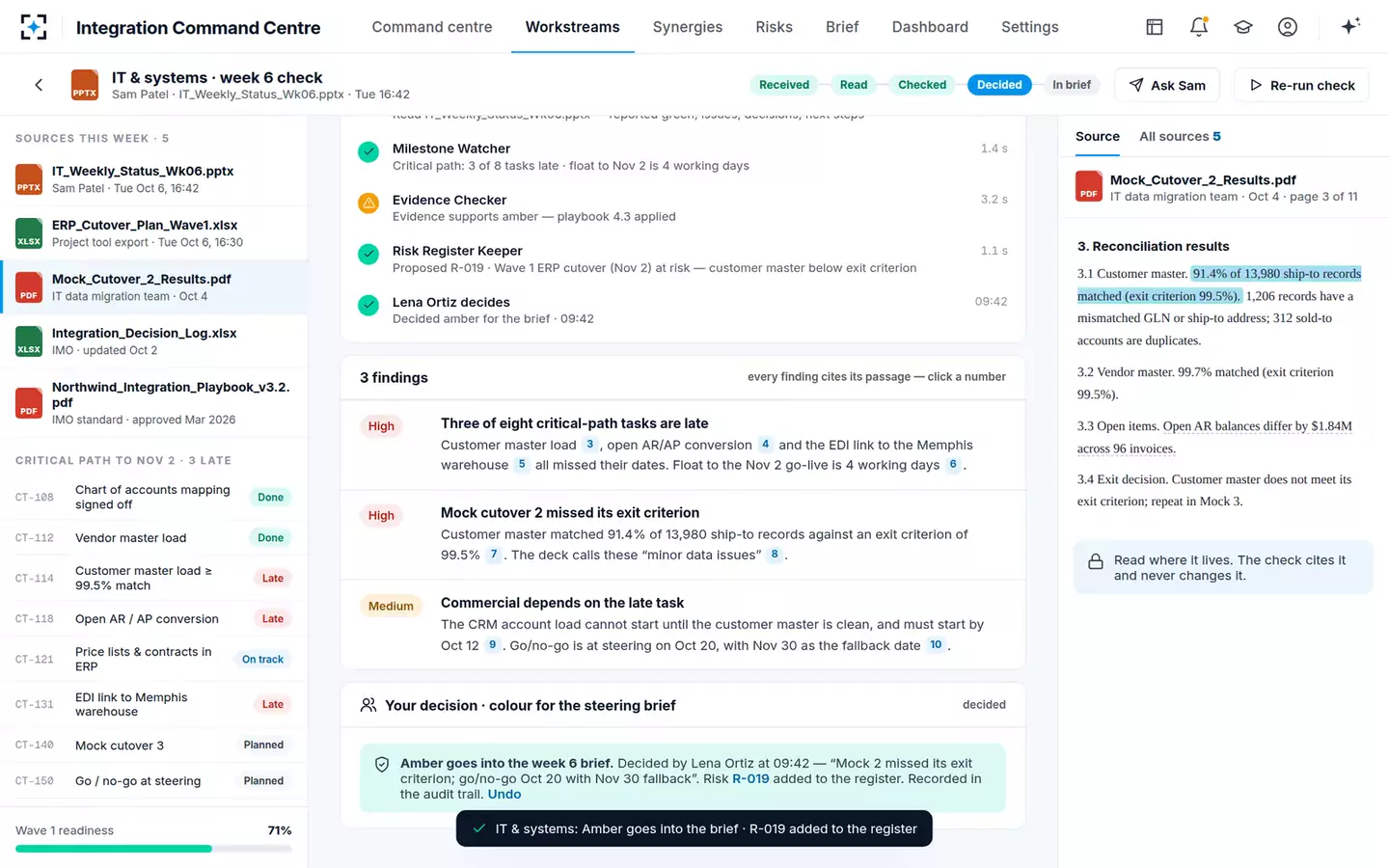

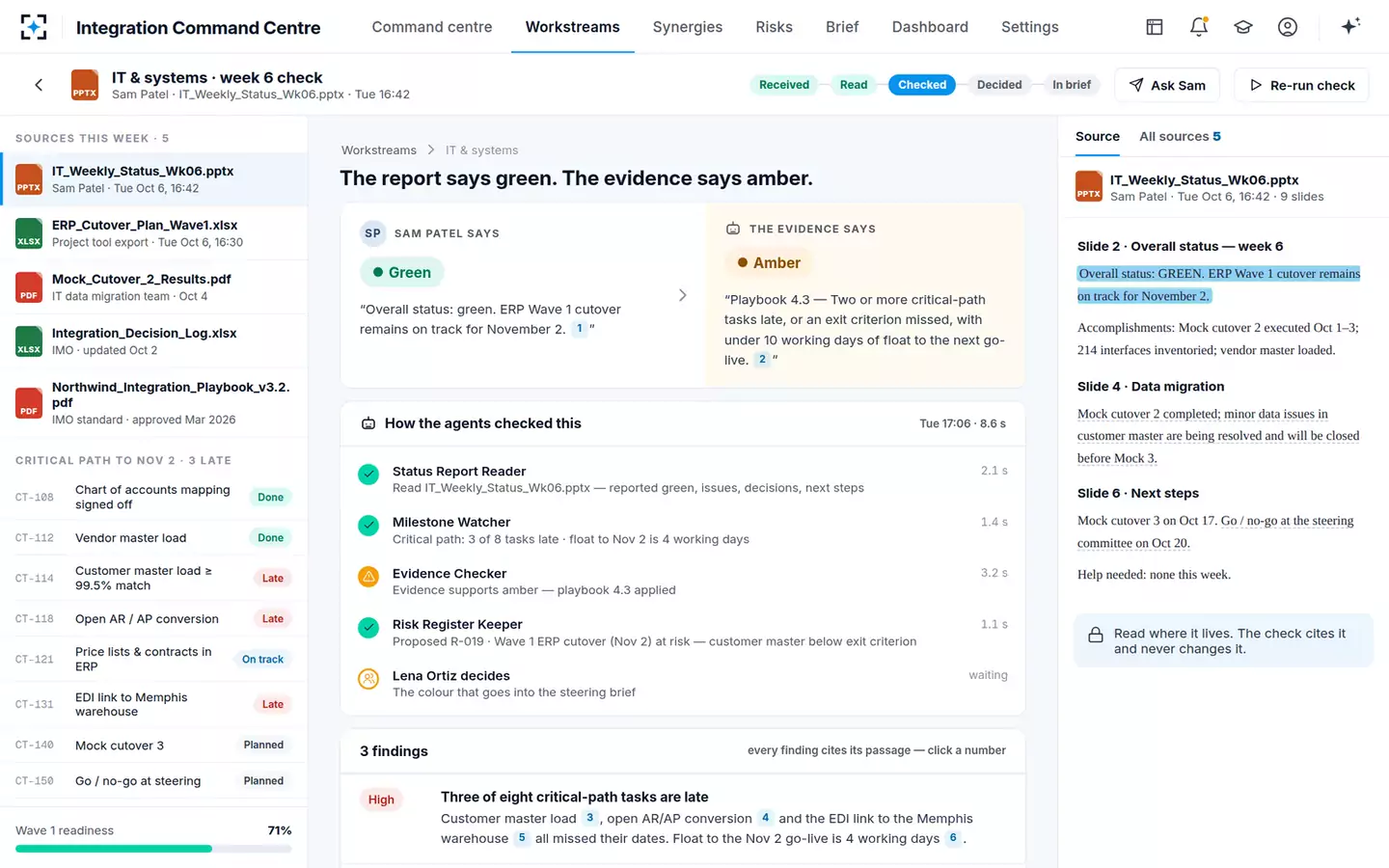

“The report says green. The evidence says amber.”

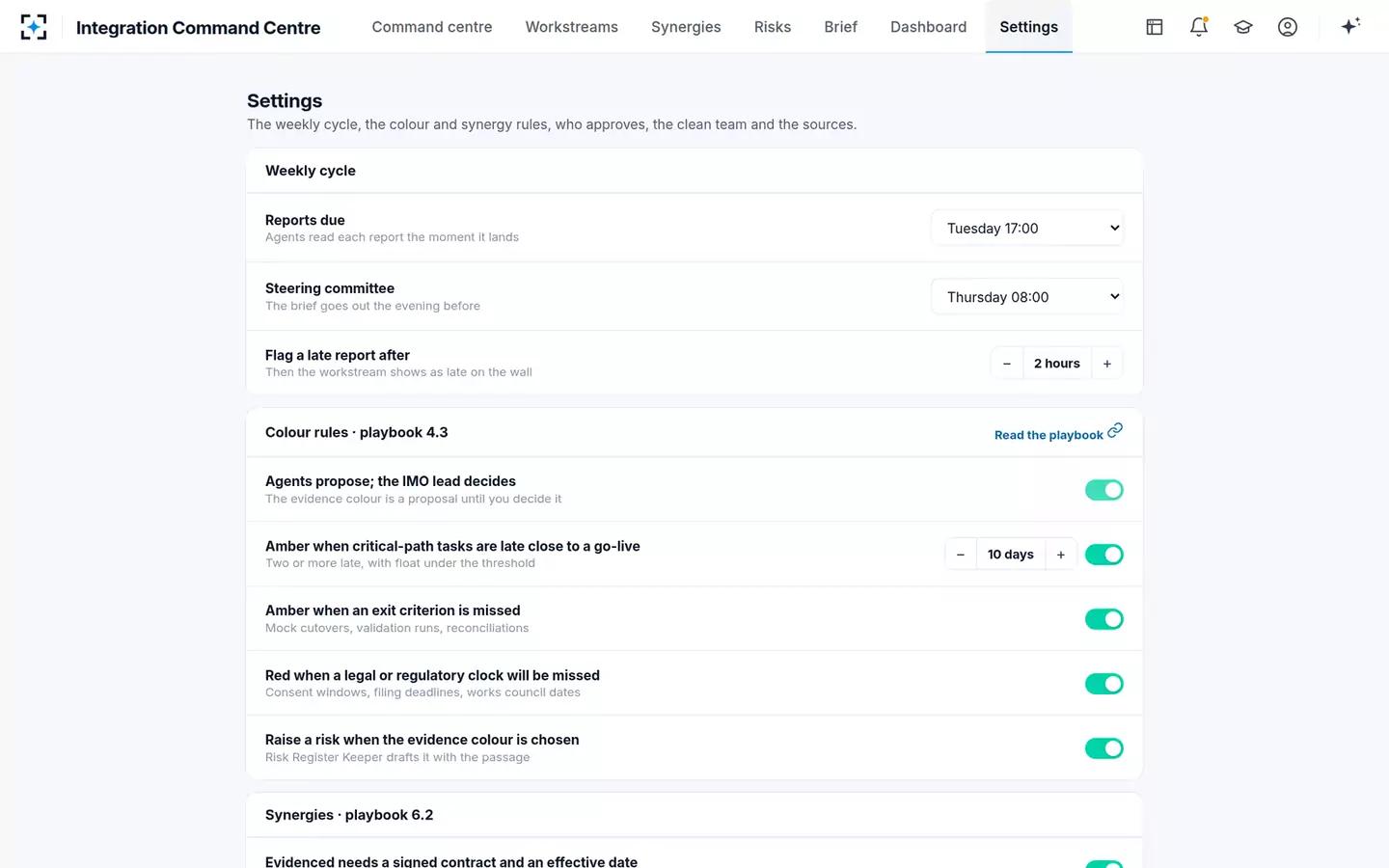

Evidence CheckerSam Patel’s IT deck says “ERP Wave 1 cutover remains on track for November 2.” The agents read it beside the cutover plan, the Mock cutover 2 results and the decision log: 3 of 8 critical-path tasks are late, with 4 working days of float to Nov 2. Playbook 4.3 makes that amber.
Evidence Checker proposes, never sets, a colour.
- 04One click
Every finding opens on its source passage
Lena Ortiz · IMO leadLena clicks a citation and the mock cutover report opens at the passage: the customer master matched 91.4% of 13,980 ship-to records against an exit criterion of 99.5%. The deck calls these “minor data issues”. The CRM account load depends on the late task and must start by Oct 12.
“Read where it lives. The check cites it and never changes it.”
- 0509:42
She decides the colour for the brief

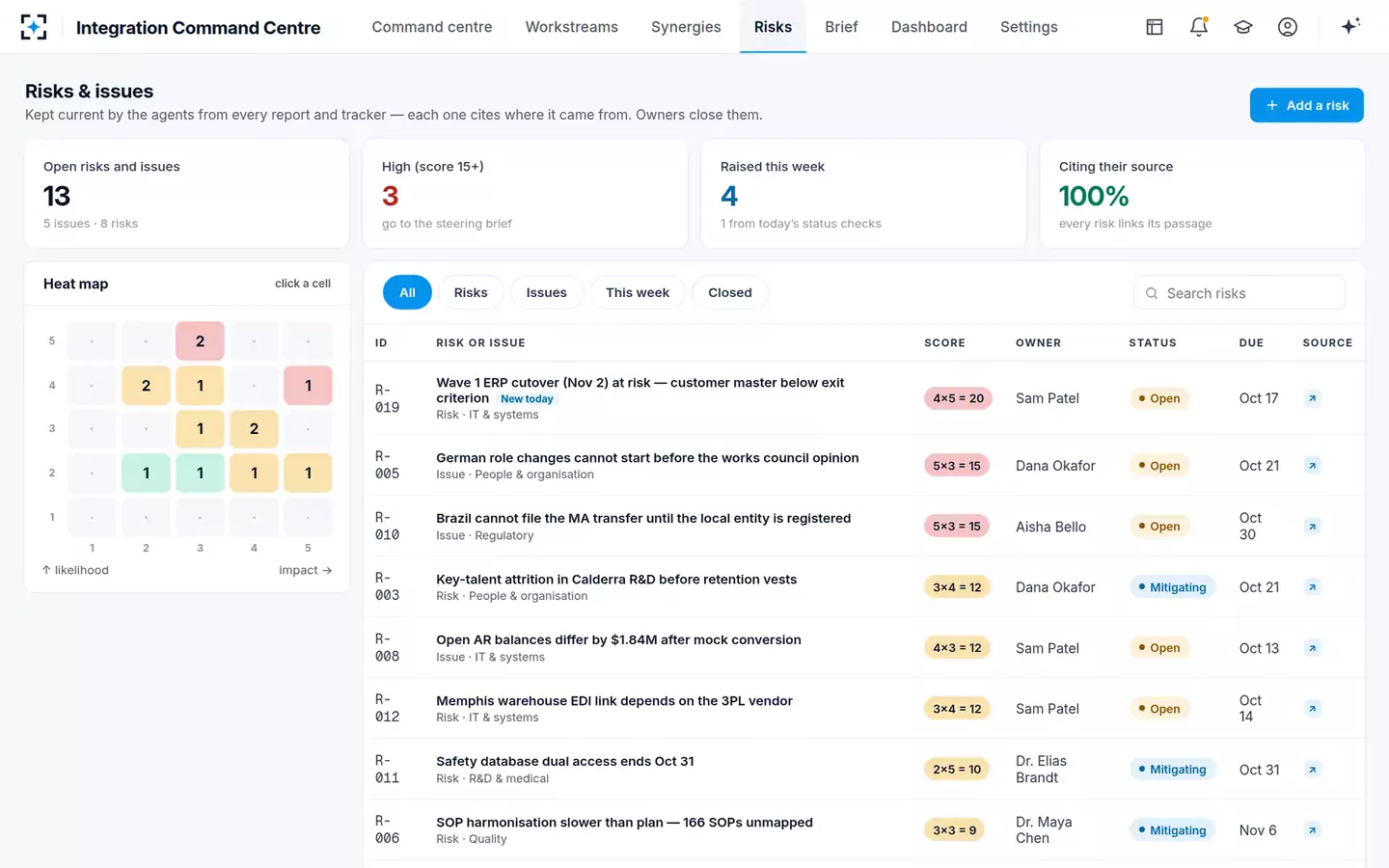

Lena Ortiz · IMO leadThree choices: use the evidence colour, keep the lead’s colour with a note for the steering committee, or ask Sam first with the findings attached. Lena takes amber and adds: “Mock 2 missed its exit criterion; go/no-go Oct 20 with Nov 30 fallback.” Choosing the evidence colour adds R-019 to the register — Wave 1 ERP cutover at risk, scored 4×5 = 20.
- 06Evidence check
The same $4.1M, claimed twice
Synergy Evidence ValidatorProcurement’s CRO preferred-provider panel (S-02, $14.5M) and R&D’s monitoring rate harmonisation (S-09, $6.2M) both draw on Brightline amendment 4: $34.2M of monitoring spend × 12% = $4.1M in both claims. The validator proposes booking it once, to S-02, because Procurement owns the contract.
“The same $4.1M is claimed twice” · confidence 0.96

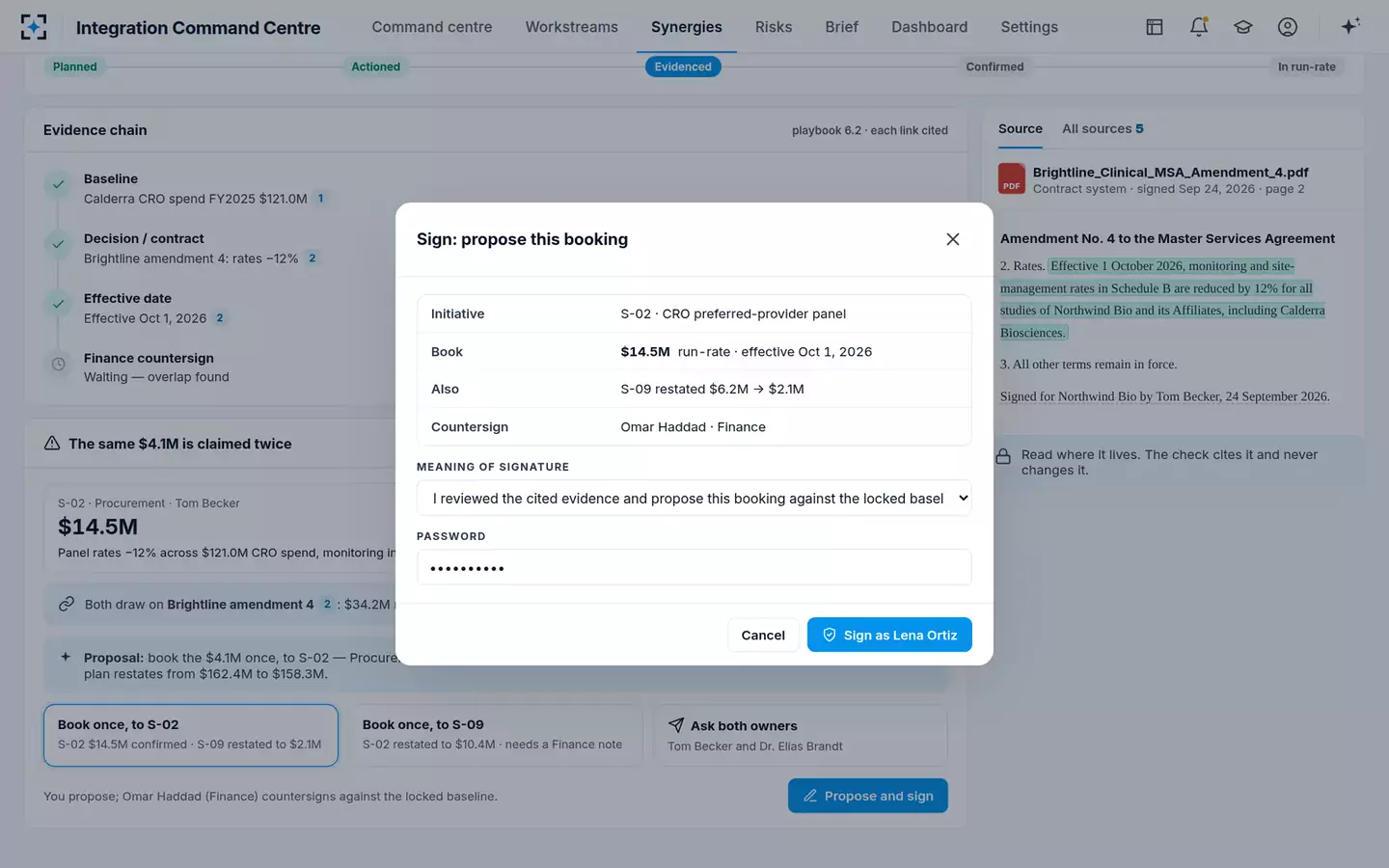

- 0709:45
Proposed by the IMO, countersigned by Finance

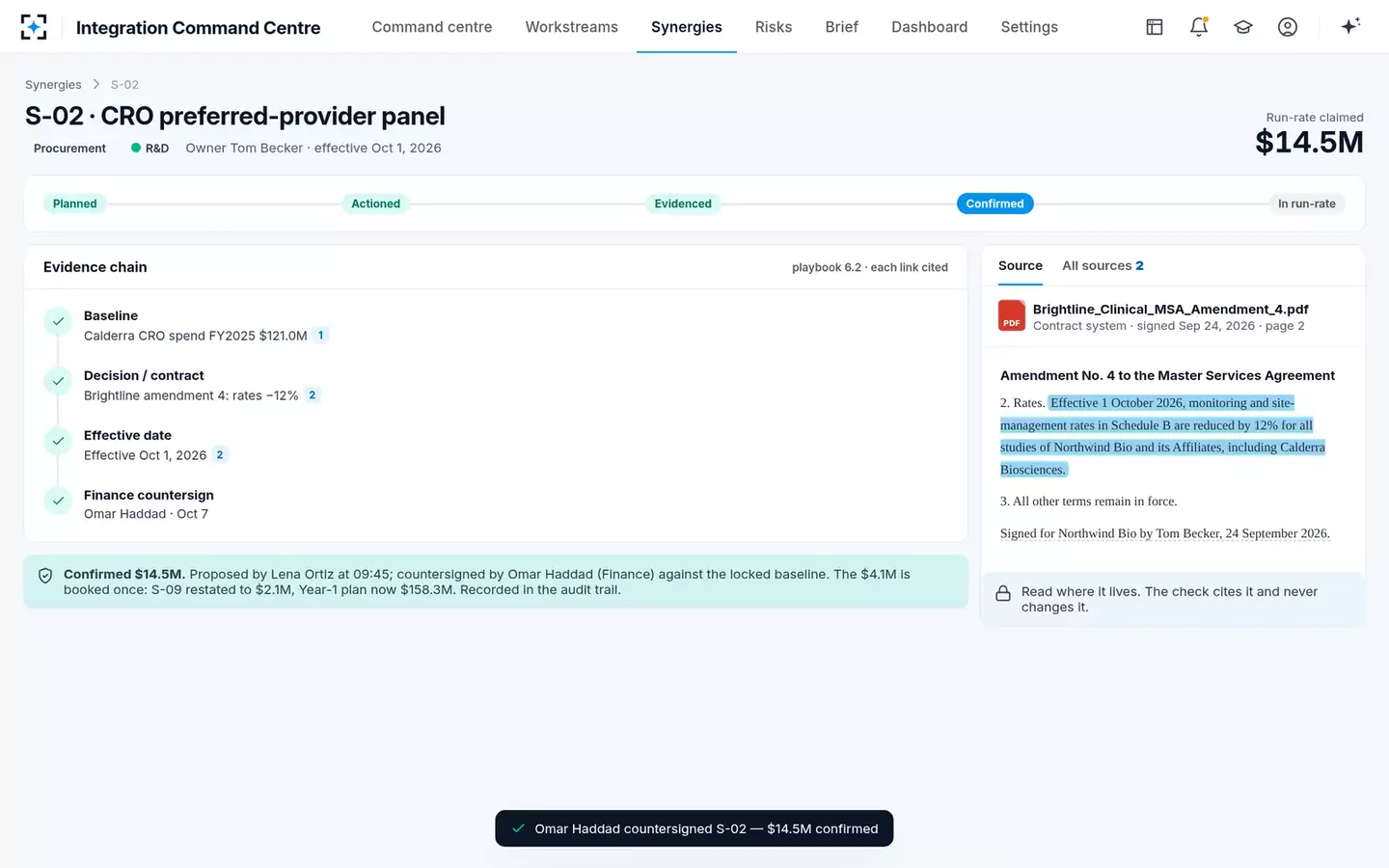

Lena Ortiz · Omar HaddadLena signs the booking with her password and the meaning of the signature: “I reviewed the cited evidence and propose this booking against the locked baseline.” Omar Haddad, the synergy controller, countersigns. S-02 is confirmed at $14.5M, S-09 is restated to $2.1M, and the Year-1 plan restates from $162.4M to $158.3M.
- 08Drafted
One page for Thursday, every number cited
Steering Brief WriterThe brief is drafted from the decided colours, the register and the synergy ledger: headline, workstream colours, synergies, decisions needed, top risks and the next two weeks. Colours Lena has not decided yet go in marked “proposed — not yet decided”, with the lead’s colour beside them.
- 09Approved
The sponsor approves before it goes
Rebecca Lang · Executive sponsorLena reviews the draft and sends it to Rebecca Lang, the COO and sponsor. She approves with a note — “Agree. Put Ridgefield first on the agenda.” — and the brief is ready to send to the nine members of the steering committee for Thursday 08:00.
“Clean-team data from Project Lark is never used in this brief.”

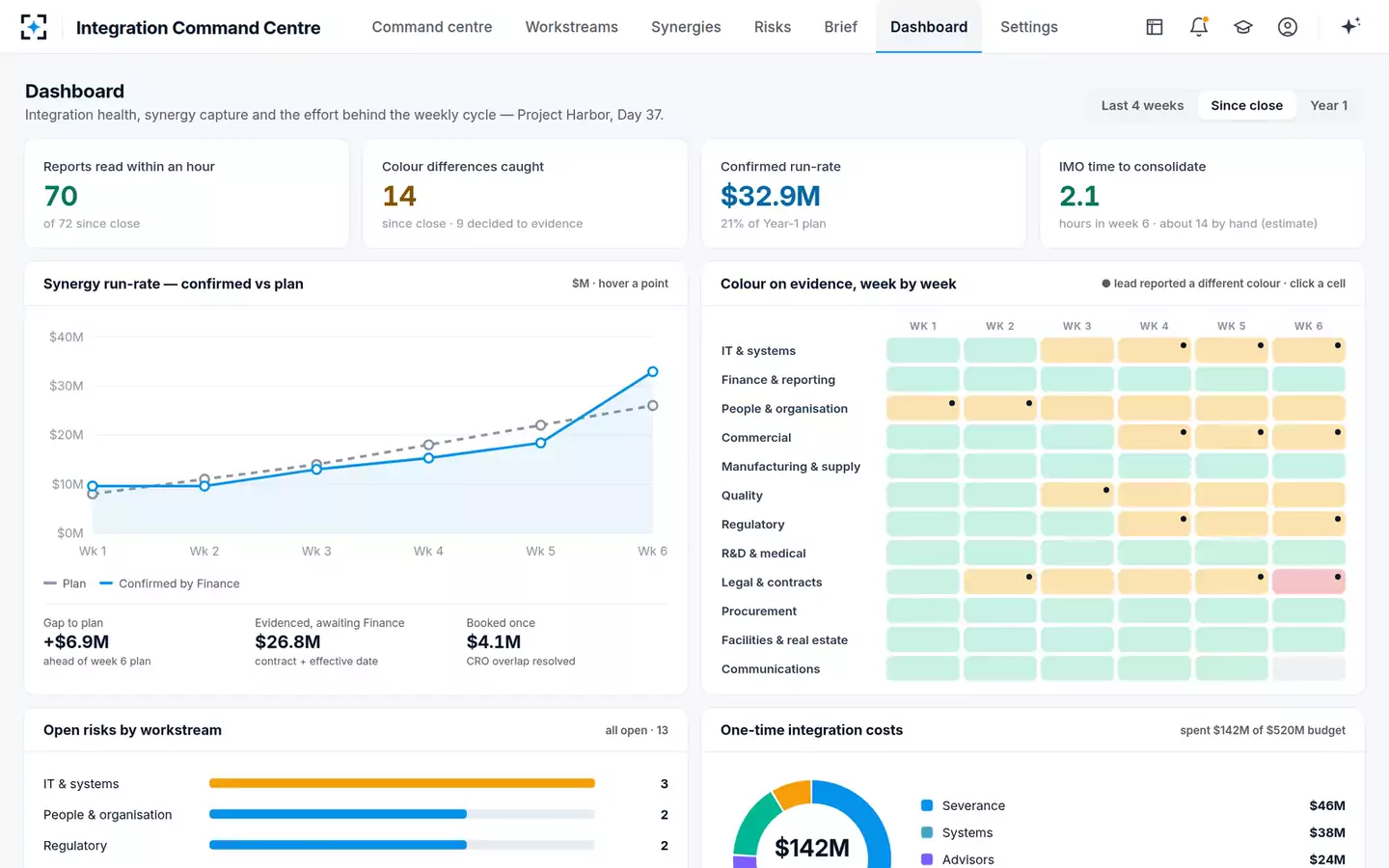

- 10Since close
The programme, week by week
Lena Ortiz · IMO lead70 of 72 reports read within an hour of arrival. 14 colour differences caught since close, 9 decided to the evidence. Confirmed run-rate against plan, colour on evidence by workstream and week, open risks, one-time costs — $142M spent of a $520M budget — and IMO hours down from 13.5 in week 1 to 2.1 in week 6.
