Electronic Permit to Work

An electronic permit to work system that blocks any permit relying on an isolation another crew still holds

See one case, screen by screen ↓
Watch with transcript →

Built forPermit issuersAuthorized isolatorsShift supervisorsMaintenance leadsContractor supervisors

The Problem Today

Permits and isolations sit on separate paper sheets, so a second permit can remove a lock another crew needs.

2,562
OSHA lockout/tagout citations in FY2025, its 4th most cited published
$165,514
maximum OSHA penalty per willful or repeat violation published

Four records, checked by hand

  • Work order
  • Drawing
  • Permits
  • Competency
  • Permits walked for signaturesThree signatures in three places before work can start
  • Plan older than the drawingA valve added to the plant, missing from the plan

The Solution

  1. Request read with drawingsWork order steps and the isolation plan, checked against today's drawing
  2. Checked against each live permitA request to take back a lock another crew works behind is blocked
  3. Each lock proved on siteLock number, proving test and time recorded before the permit is issued
  4. The issuer signsThe shift engineer issues, and the crew accepts and signs on to the permit

Built-in controls

  • No override on a conflict block
  • Each check cites its drawing or record
  • Contractors see only the permits they perform

What You Get

More planned maintenance runs on its day. A blocked test comes back with a safe new time instead of a flat no.

  • Expired authorizations heldEach name checked against the permit type and the date
  • Shared locks shownTwo permits on one valve, under one common certificate
  • Clean shift handoversThe night shift acknowledges each live permit
In short

What is Electronic Permit to Work?

An electronic permit to work system (ePTW) replaces paper permits and isolation certificates with one record. That record holds the work, its isolations, the approval chain and each signature. Electronic Permit to Work puts all live permits on a board drawn over the plant diagram. It checks each request against the drawing, the live permits and each person on the crew, and keeps the full trail.

How to choose AI solutions for utilities →

Updated

The problem

On paper, nothing stops a second job from removing another crew's isolation

Each hazardous job at a power station, substation or water plant runs under a permit to work. The permit describes the work. The energy sources are cut off and locked, a step called isolation. An authorized person then issues the permit, and the crew signs on. Nobody puts the plant back in service until each permit that relies on those isolations is cleared. On paper, the permit and the isolation certificate are separate sheets in separate offices. Some jobs need an isolation removed, such as a motor run test or a valve stroke. So a permit for one can be raised against equipment another crew is still inside.

Under time pressure, the sign-off order slips. A permit is issued before the isolator has proved the isolation. Or a contractor signs on without a current authorization. The plant is changed and the drawing gets a new revision, but the standard isolation plan stays the same. The incoming shift assumes work is finished, or that an isolation is still in place. The UK safety regulator's guidance, HSG250, says failures in the permit-to-work system were part of what led to the Piper Alpha oil platform disaster. Lord Cullen's inquiry found that a night shift restarted a pump without knowing its relief valve had been removed under another permit.

typical2,562citationsfor lockout/tagout, the rule on locking off energy before work. It was 4th on OSHA's FY2025 list of most-cited standards.
typical$165,514maximum OSHA penalty per willful or repeat violation
typical32%of recordable incidents at 11 utilities could have caused a serious injury or death, against 25 % across all industry
Where a permit's minutes go, from request to issueestimated
By hand70 minutes
With the solution15 minutes
  • Reading the work order and writing the permit15 → 3 min
  • Checking the isolation plan against the current drawing10 → 2 min
  • Checking every other live permit on the same equipment10 → 1 min
  • Checking each person's authorization and induction5 → 1 min
  • Walking the plant for the issuer's, isolator's and performing authority's signatures30 → 8 min

Our estimated split for one mechanical permit on a large site, in minutes, by hand and with the solution. On paper it takes three signatures in three places, each a 10 to 20 minute walk, plus waiting. Proving each isolation in the field still takes the isolator's time on top.

How it works

From work order to signed permit to work, check by check

What comes in
Request in4 sources · work order, drawings, people, live permits
Agents at work
Work order readerequipment, energy, steps
Then
Isolation plannerplan against drawing rev
Conflict checkerevery live permit
Competency checkerevery person
Then
Permit chain keeperorder of signatures
Then
Audit pack writercited trail
A person decides
Isolator and issuerprove each lock, then sign
What comes out
Permit issued
Conflicts blocked
Audit trail
One case, step by step

A motor test blocked while four people work inside the pump it would turn

A combined-cycle station runs three generating units and four water treatment trains. It is a weekday, 09:14, on the day shift. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 0109:14

    The shift opens on the station drawing

    Shift charge engineer

    The shift charge engineer issues and clears each permit on the day shift. The board is the station mimic, a live drawing of the plant. It shows Unit 1, Unit 2 feedwater, Unit 3, the 6.6 kV unit board and the 33 kV switchroom. It also shows the water treatment trains, cooling-water intake and chlorination. Each isolation point is drawn as a lock and each live permit as a pin. The strip above reads 11 live permits, 28 people at work, 27 points locked, 4 requests and 1 held back.

    Legend: “Held by a permit · Shared · common certificate · Proposed by a request · Free”. It sits on the station single-line drawing at its current revision

  2. 02Since 07:42

    Four people inside a feed pump

    Performing authority, pump contractor

    The permit is for a mechanical seal replacement on a feed pump. Its isolation certificate holds five points, each proved by the authorized isolator before issue. The suction, discharge and recirculation valves are locked shut. The casing drain is locked open. The pump's 6.6 kV motor breaker is racked out, locked and earthed. The job is at step 7 of 9, laser alignment, with the coupling refitted and hands on the shaft.

    Hazards: “Stored pressure and hot water · Rotating shaft and coupling · 6.6 kV motor supply · Manual handling of the seal cartridge (38 kg)”

  3. 0309:15 · Checks run

    A test permit asks for the breaker back, and the board blocks it

    Electrical maintenance lead

    The maintenance lead raises a sanction for test, a permit to run a test. It covers an insulation-resistance test of the pump motor, then a 2-minute uncoupled run. The shift charge engineer runs the checks on the board. The isolation planner builds the test plan from the standard 6.6 kV motor plan. That plan removes the breaker isolation so the breaker can be racked to service. The conflict checker finds that point held by the seal permit. It draws the conflict on the diagram and blocks the request.

    “A run would turn the shaft they are working on.” · No override on the board

  4. 04The decision

    Two safe routes, and no third

    Shift charge engineer

    The request shows why. The work order assumes the motor is uncoupled, but the seal crew refitted the coupling at step 6. The engineer can re-plan the test for after the seal permit clears. Or the engineer can ask the maintenance lead to change the method to an insulation test only, from the switchboard, with the motor cable disconnected. Override is shown, and not available. The engineer re-plans the test for 15:45, linked to the seal permit. The breaker isolation stays in until both are closed, and the maintenance lead is told.

    “Override · Not available · conflict rule 1, set by the HSE manager”

  5. 05Sharing a point

    One valve, two permits, one common certificate

    Conflict checker

    Two permits can share a point without a conflict. A high-pressure feed valve on one water treatment train is held by two permits. One is a high-pressure pump bearing change, with 3 people on. The other is a tank internal inspection, with 2 on. Both sit under one common isolation certificate. So the board shows the point as shared, and it cannot be removed until both permits are cleared.

    “Common isolation certificate · cannot be removed until both permits are cleared”

  6. 0608:44

    The drawing changed but the standard plan did not

    Isolation planner

    Another request is an impeller inspection on a Unit 3 pump after a vibration alarm. The planner compares the standard isolation plan, revision C, with the current process drawing, revision F. Revision F was issued last month and added a bypass valve. The plan lacked it. So the planner adds it as a new isolation point and holds the request until an authorized isolator walks it down.

    Limit: the isolation planner does not mark a point as isolated. Only an authorized isolator, in the field, proves it.

  7. 0708:33

    An expired authorization holds the roof job

    Competency checker

    A roof fall-arrest anchor inspection is booked with an access contractor. The competency checker checks each named person against the permit type and today's date. One technician's working-at-height authorization expired at the end of last month. The request is held until another technician is named or the authorization is renewed.

    “Working-at-height authorization expired · held by the competency checker at 08:33”

  8. 0809:16 to 09:18

    Each lock proved in the field before issue

    Authorized isolator

    A strainer basket clean on another water treatment train passed all checks. No live permit holds its two isolation points, and the crew and isolator are authorized. The isolator locks both valves shut and proves each one. The proof is its lock number and zero pressure at the gauge behind it. Only then does the decision read “Isolations proved · ready to issue”.

    “Both points are locked and tested. Your signature issues the permit. The performing authority then accepts it and signs the crew on.”

  9. 0909:19 · Signed

    The engineer signs and issues the permit

    Shift charge engineer

    The issue screen shows the work, the area and the isolation certificate, with both points proved by the isolator. The permit is valid to 19:00, then revalidated at handover. The engineer signs with badge and PIN. The performing authority, who leads the crew, accepts on a device and signs 2 people on. The permit goes live on the board.

    Agents check and block. Only people isolate, issue, accept and clear.

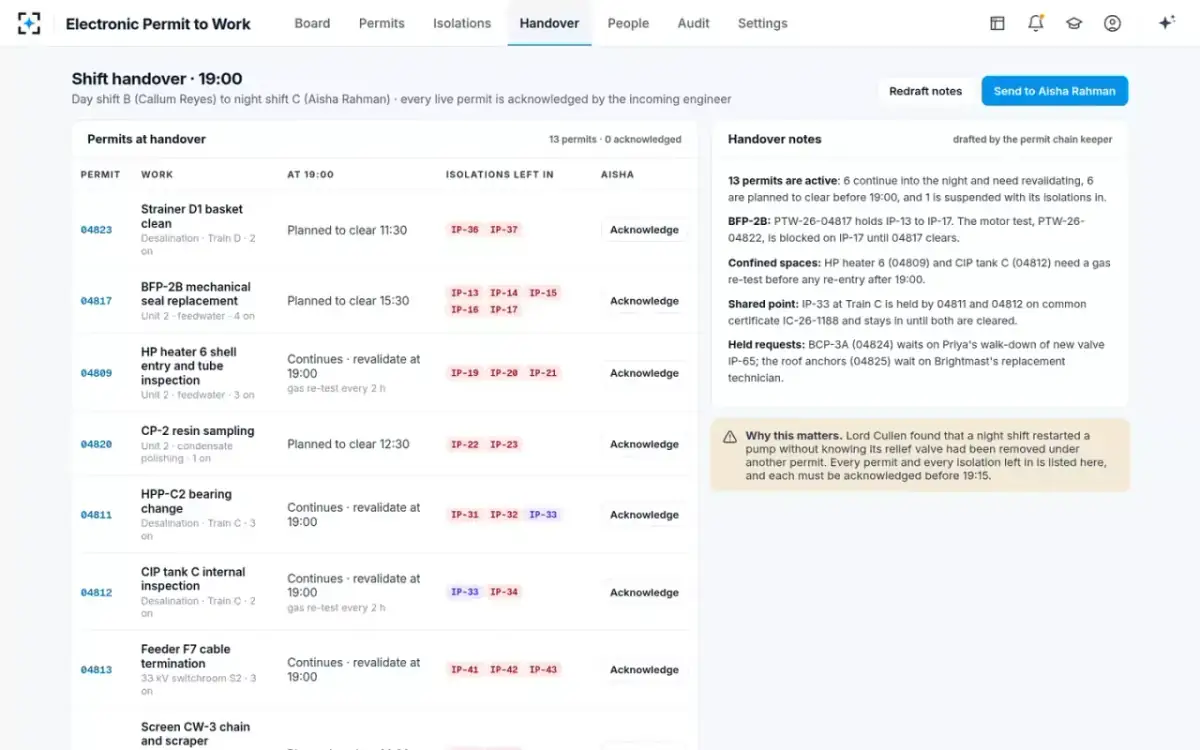

  10. 1019:00 handover

    The night shift acknowledges each permit

    Permit chain keeper

    The permit chain keeper drafts the handover from the day shift to the incoming night-shift engineer. It lists what continues and must be revalidated, and what clears before 19:00. It flags the suspended heat recovery steam generator permit with its isolations in. It also flags the two confined spaces that need a gas re-test before re-entry, and the shared point. The incoming engineer must acknowledge each permit by 19:15.

    “Feed pump: the seal permit holds five isolation points. The motor test is blocked on the breaker until the seal permit clears.”

Who it’s for

Issuers, isolators and contractors on one electronic permit to work system

The issuer, isolator, test planner, performing authority and HSE manager on the same shift. Here is how each worked on paper, and how each works now.

Shift charge engineer
Issues and clears permits
Before
Issues and clears 15 to 25 permits a shift across 3 units, the water treatment trains and the 33 kV switchroom. The isolations are on separate sheets in another office.
Now
Sees each permit, lock and crew on the station drawing, and each request checked before signing. This is the last signature before anyone puts their hands in the plant. So the engineer sees the other permits on that equipment first.
Authorized isolator
Applies and proves isolations
Before
Applies and proves 30 to 60 isolations a shift and keeps the lock boxes. Has no quick way to see whose people are behind a lock that is on.
Now
Opens the isolation register. Each point shows its lock, lock box, proving test and the permits relying on it.
Electrical maintenance lead
Plans motor and switchgear tests
Before
Asks for sanctions for test on equipment other crews may still be working on. Gets a flat no, with no time when the test could run.
Now
Gets the reason, the crew at risk and a new time. The pump motor test is re-planned for 15:45, linked to the permit holding its breaker.
Performing authority
Leads the contractor crew on the job
Before
Leads a 4-person contractor crew on the pump seal change. Signs the crew on to a sheet their lives depend on.
Now
Accepts the permit and signs the crew on only after each isolation is proved. No test can take back a lock while anyone is signed on.
Station HSE manager
Owns the permit rules
Before
Audits permits and answers to the regulator and the board. Has a box of carbon copies when an inspector asks for the whole chain.
Now
Builds the inspection pack for any permit, each entry cited to its record. The pack for the pump seal permit runs to 14 pages. Owns the rules, and each change is saved as a new version.
The agents

Conflict, isolation and competency agents behind the permit to work board

Six agents check each request against the drawing, the live permits and the crew. Isolators prove each lock and the issuer signs.

Work order reader

Reads the maintenance work order and job plan. It finds the equipment tag, its energy sources and each step that changes the plant's state, such as run, stroke, energize or test. It also notes any assumption the work order makes, such as “motor uncoupled”.

  • Never adds work to a permit that is not in the work order
  • Cites the work order line for each fact
Isolation planner

Builds the isolation plan from the standard isolation library and the current drawing revision, and compares them device by device. If the drawing has an isolating device the plan lacks, it adds it, marked for walk-down. For a sanction for test, it lists the isolations to be removed.

  • Never marks a point as isolated. Only an authorized isolator proves it in the field
  • A drawing change always holds the request
Conflict checker

Checks each new permit and each isolation removal against all live and suspended permits. It looks for shared points, points to be removed and work in the same plant area. A conflict names the permit, its crew, its job step and the safe routes.

  • Never lets a permit go live over a conflict. The block cannot be overridden from the board
  • Runs on each removal as well as each issue
  • A shared point is allowed only under a common certificate
Competency checker

Checks the issuer, the isolator, the performing authority and each crew member against the permit type and today's date. It covers authorization, expiry, contractor induction and required training, and says who is not current.

  • Never grants or extends an authorization
  • An expired authorization always holds the request
Permit chain keeper

Enforces the sign-off order. No permit is issued before isolations are proved, and no work starts before acceptance and crew sign-on. It watches gas-test validity, expiry and revalidation, and drafts the shift handover.

  • Never signs for a person
  • Never clears a permit with anyone still signed on
Audit pack writer

Assembles the full chain of a permit, or a period, for an inspection or an inquiry. That covers the permit, the isolation certificate with its proving tests, and the crew sign-on and sign-off. It adds each agent check, linked requests and the rules in force.

  • Never edits a record. The trail is append-only, so entries are only added
  • Each line cites its source
Shift charge engineer

Issues and clears, and the isolator proves every lock.

Ask in plain words

Plain questions about a permit, an isolation point or a crew member

Ask about any permit, isolation point, person or the handover, or say what to prepare. Each answer points to its record. These answers use the sample data.

Why is the motor test permit blocked?

The motor test needs the pump's motor breaker racked back to service for a 2-minute run. That breaker is one of the five isolations held by the seal permit, which covers the contractor's crew of 4 on the feed pump. They are at step 7, laser alignment, with the coupling refitted. So the run would turn the shaft they are working on. Conflict rule 1 allows no override. The earliest safe time is after the seal permit clears, planned for 15:30.

Which isolation points are shared by two permits?

One: a high-pressure feed valve on one water treatment train. It is held by a pump bearing change (3 on) and a tank entry (2 on) under one common certificate. It cannot be removed until both are cleared.

What does the night shift need to know at 19:00?

There are 12 active permits. Of these, 6 continue past 19:00 and need the incoming engineer to revalidate them. Another 5 are planned to clear before then, and 1 stays suspended with its isolations in. Both confined spaces, a high-pressure heater and a tank, need a gas re-test before re-entry. The seal permit still holds the feed pump's five isolation points. The motor test stays blocked until it clears.

Build the inspection pack for the pump seal permit

Building it now. It holds the permit, the isolation certificate with its 5 proving tests, the crew sign-on and each agent check, each cited to its record. It includes the linked motor test and conflict rules version 14.

The screens

The permit board, a blocked motor test and the isolation register

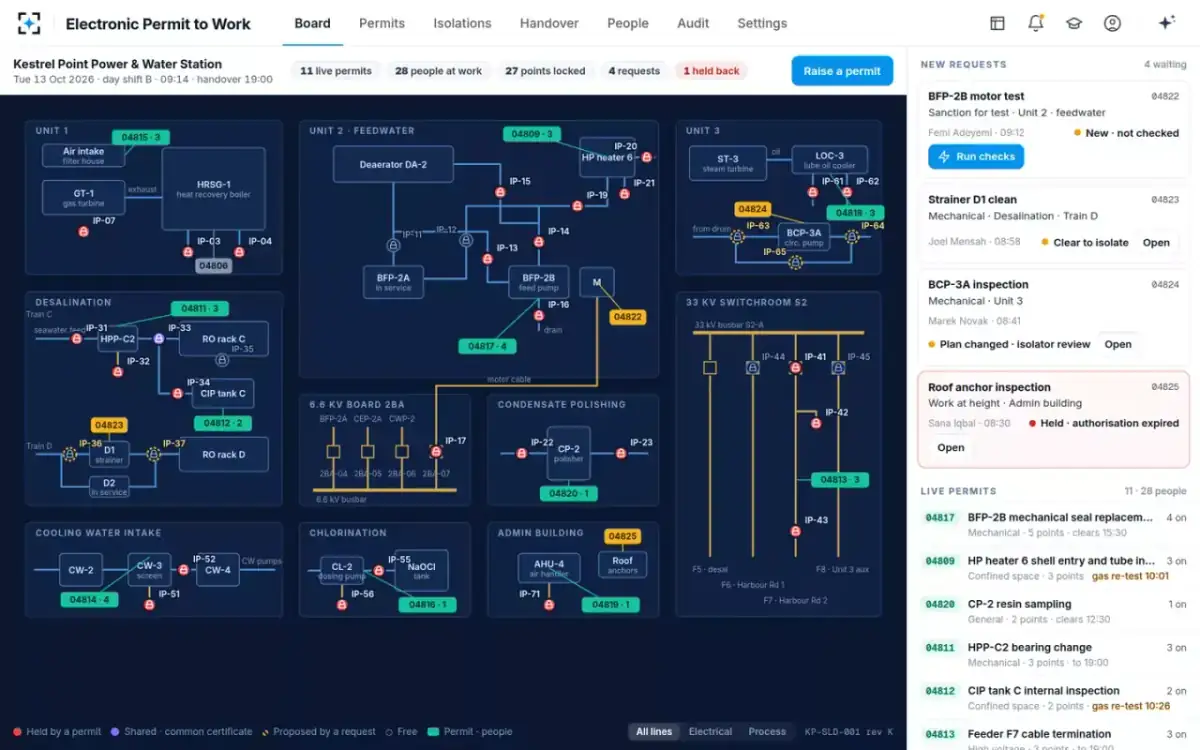

From the working solution, on its sample data. Pick one to see it large.

The permit boardThe station drawing with each isolation point as a lock, each live permit as a pin, the new requests and the live permits beside it.

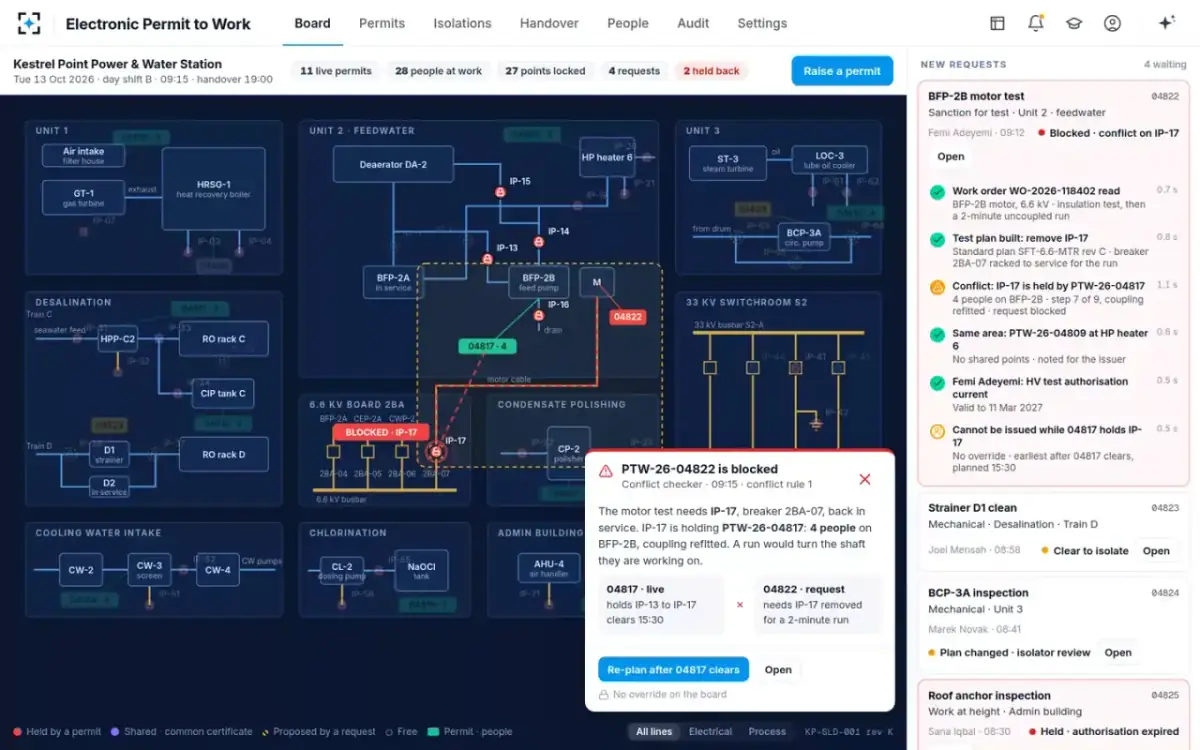

A conflict, drawn on the diagramThe motor test needs its breaker back. The board blocks it, names the crew at risk and shows the agents' checks step by step.

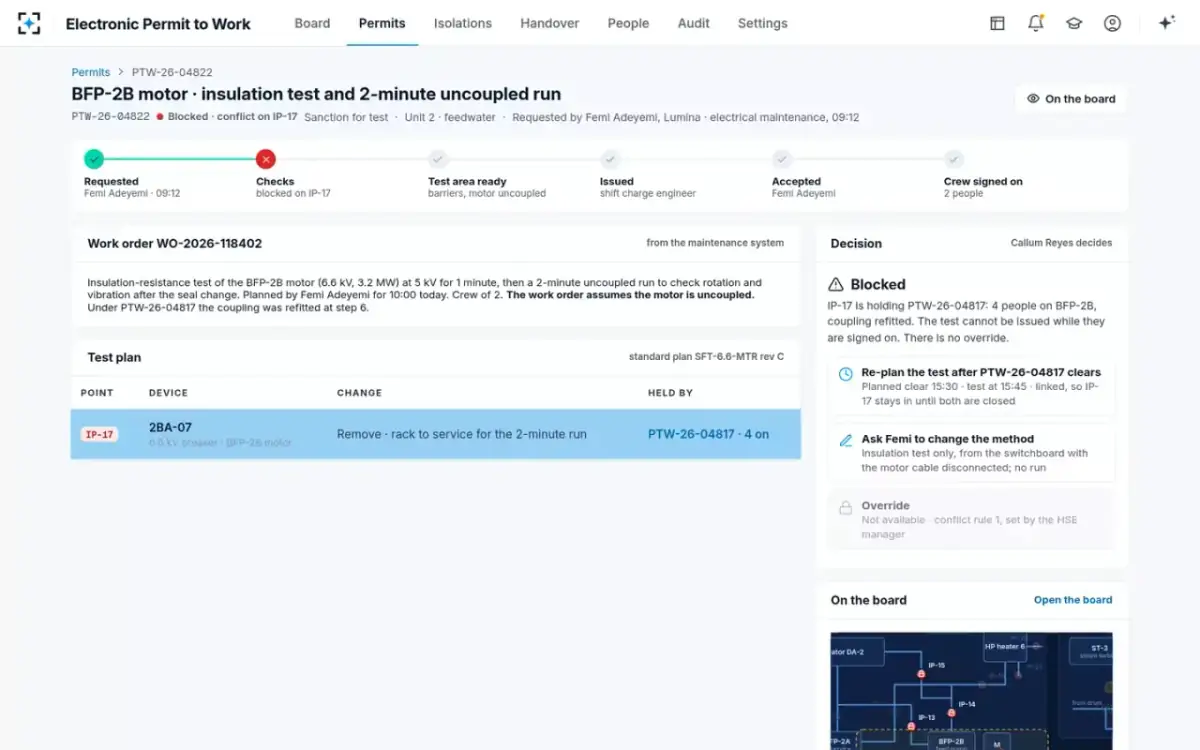

The blocked requestThe work order, the test plan, the point held by another permit and the only safe routes, with no override.

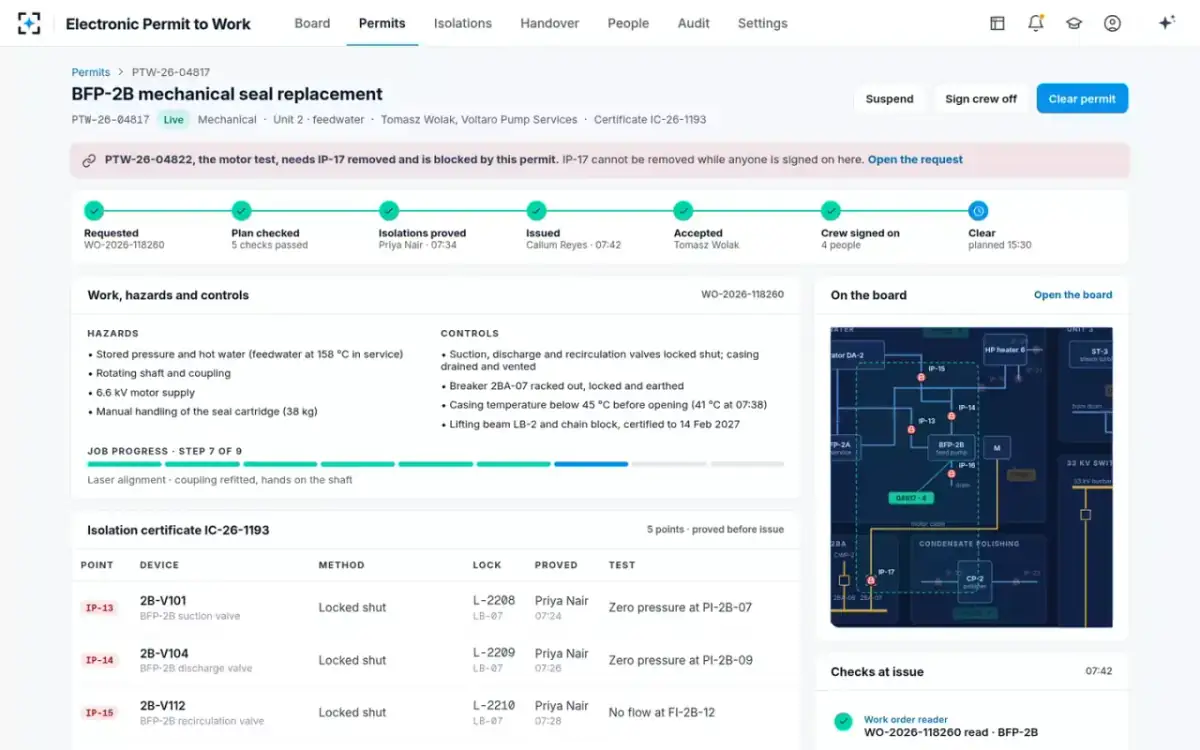

One live permitWork, hazards and controls, the enforced approval chain, job progress and the isolation certificate with locks and proving tests.

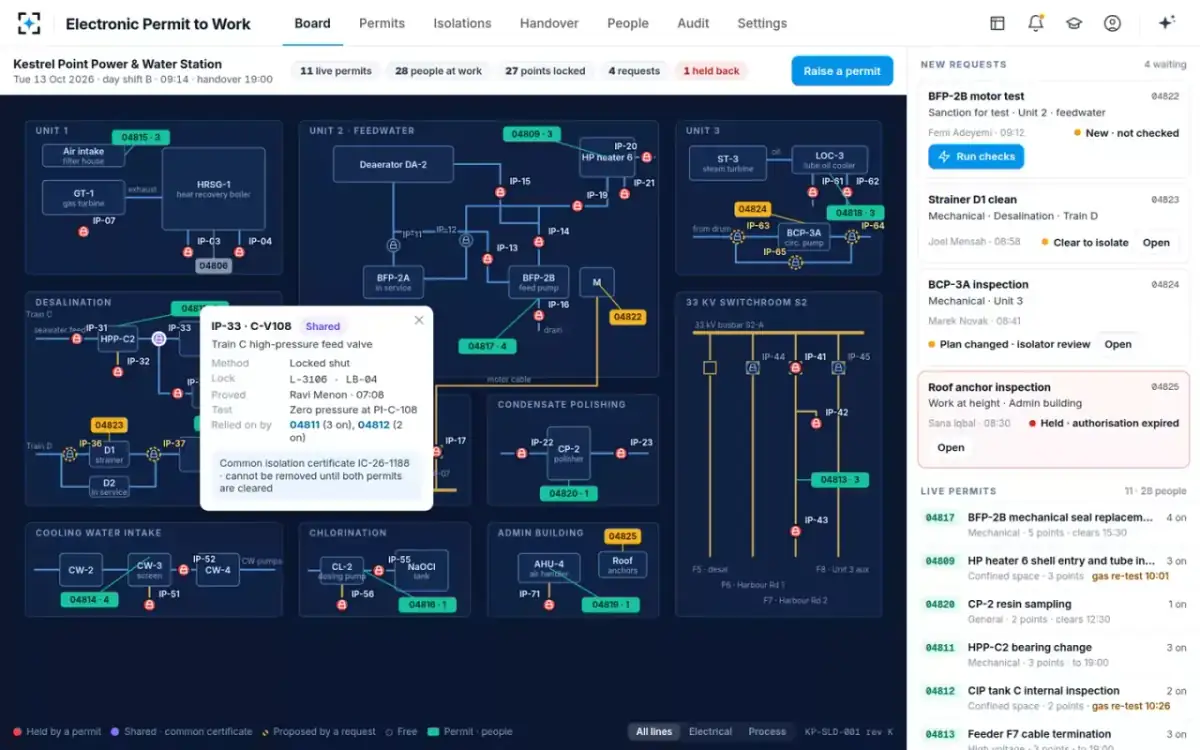

A shared isolation pointOne valve point held by two permits under one common certificate, with its lock, proof and the permits relying on it.

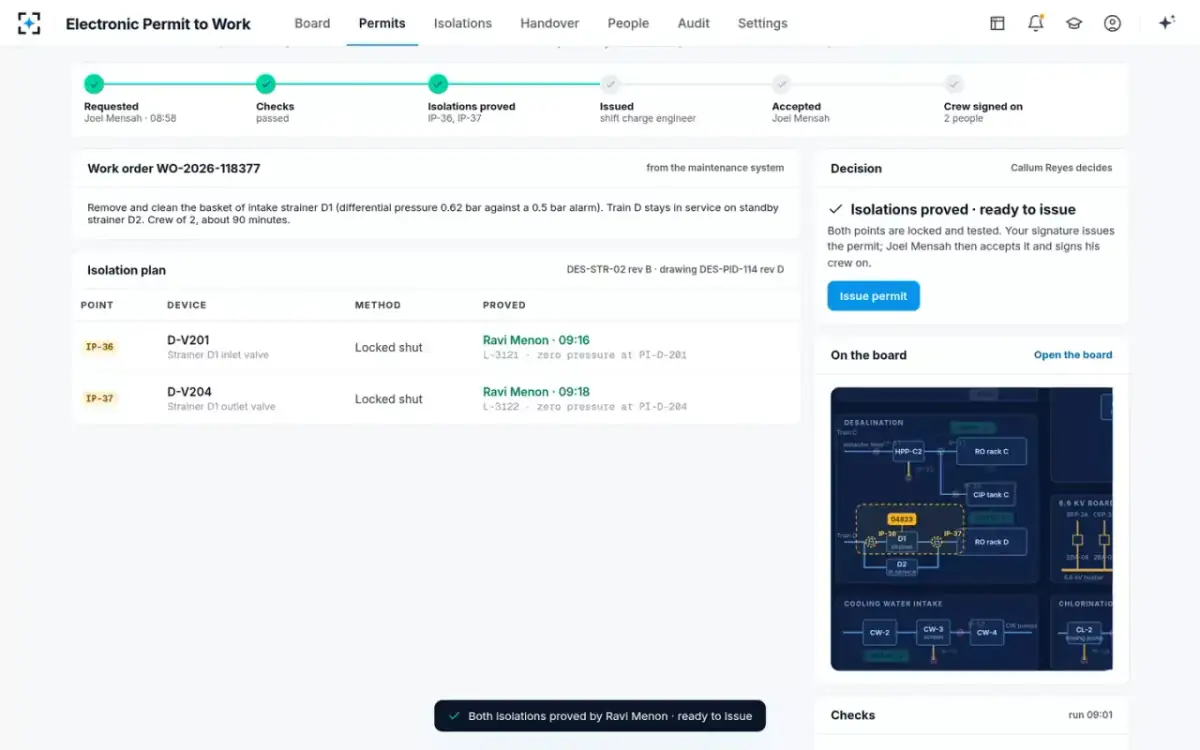

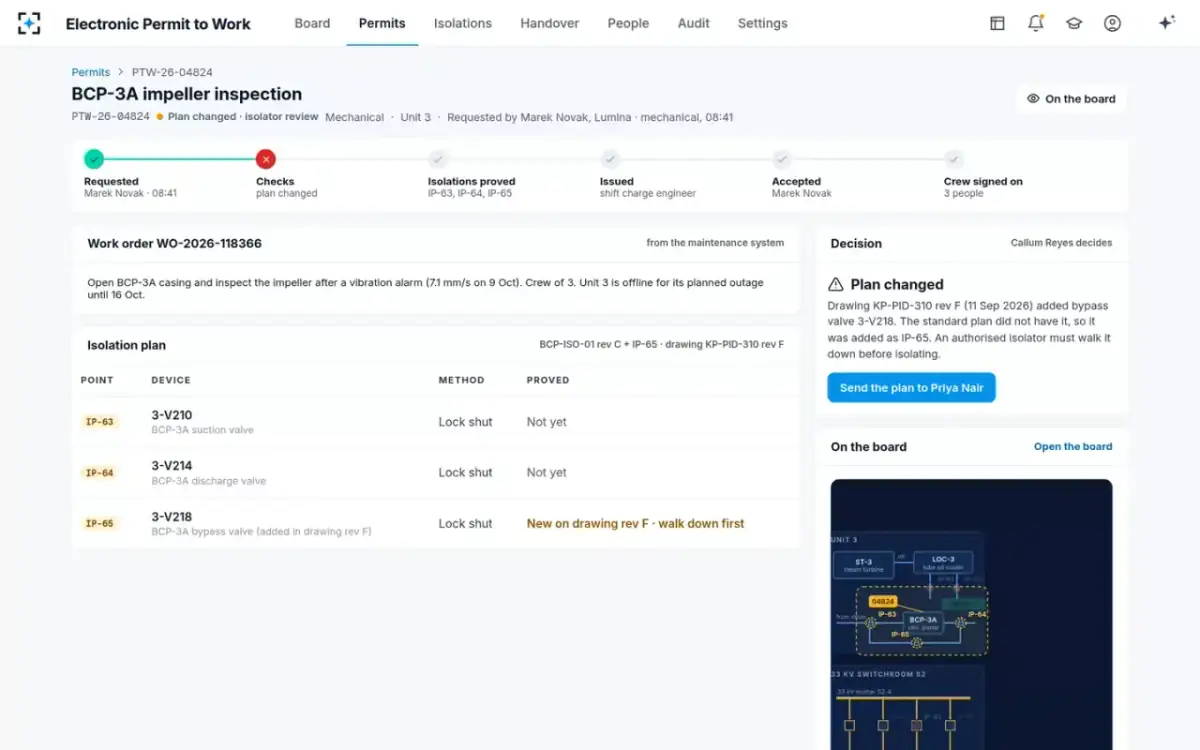

Plan checked against the drawingA valve added in drawing revision F is missing from the standard plan, so the request is held for a walk-down.
Isolations provedEach point locked and tested in the field by the authorized isolator, with lock number and proving test, before issue.

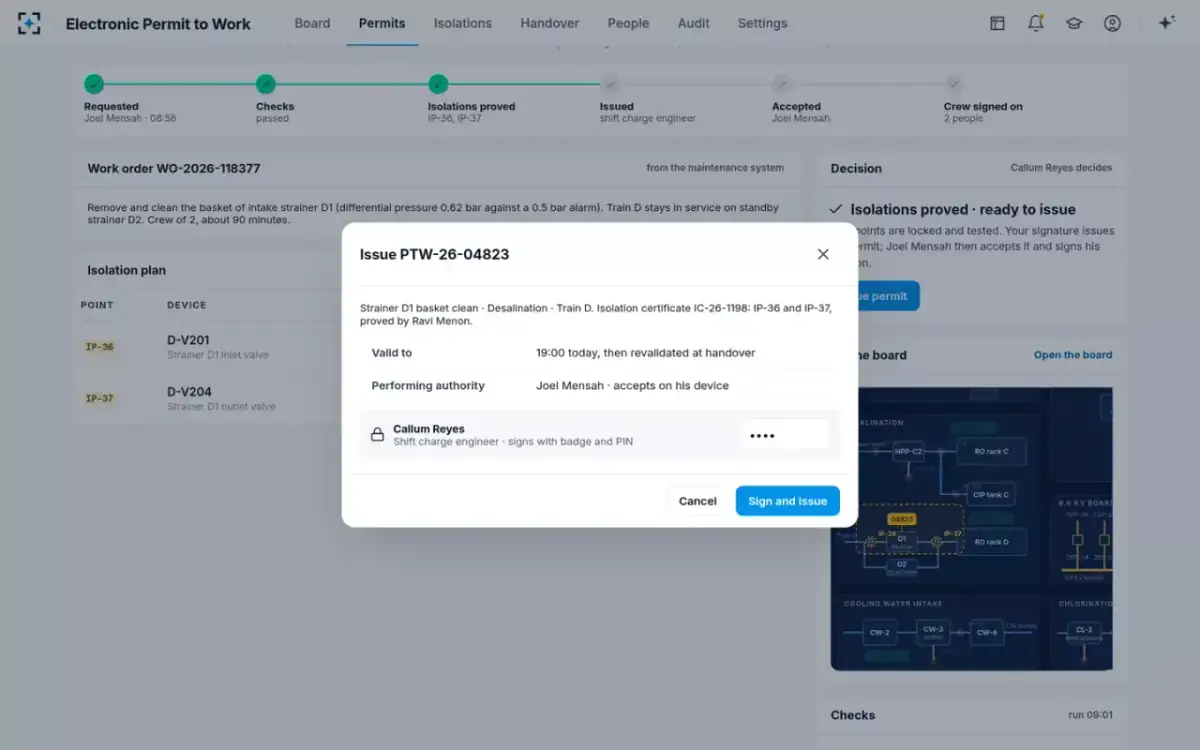

Sign and issueThe issuer signs with badge and PIN. The performing authority then accepts and signs the crew on.

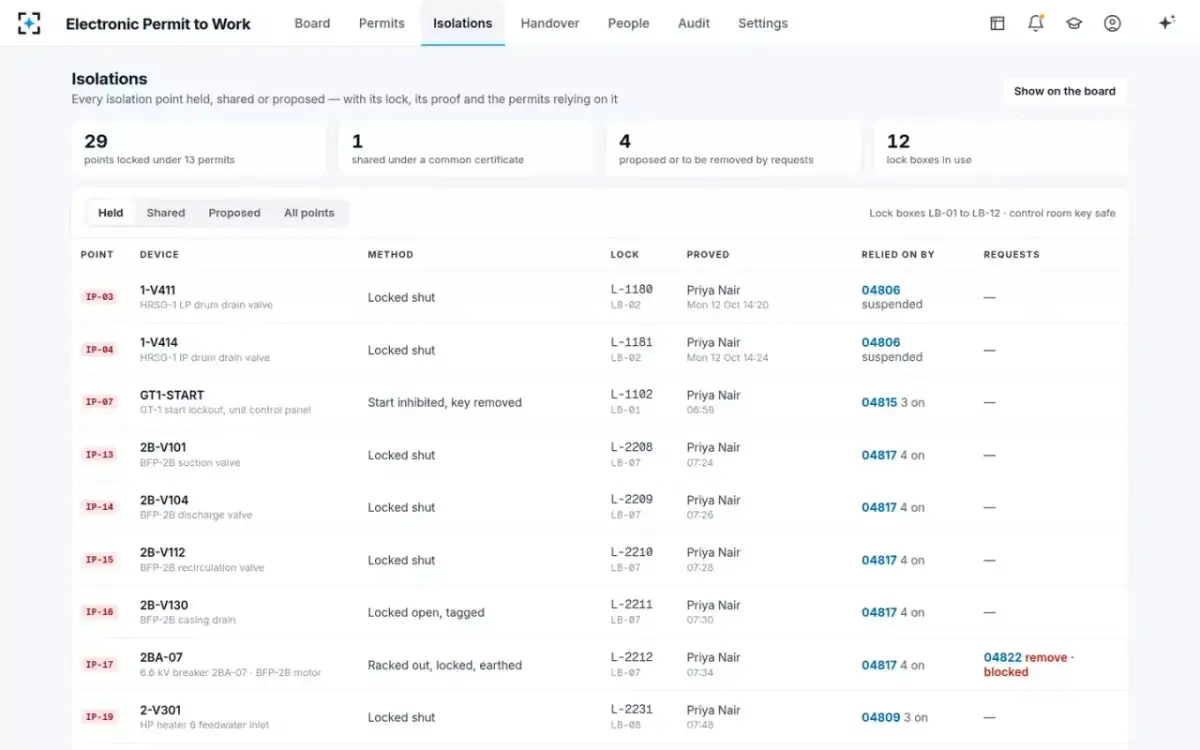

The isolation registerAll points held, shared or proposed, with their method, lock, lock box, who proved them and the permits relying on them.
Shift handoverThe active permits at 19:00 with the isolations left in, the drafted notes, and an acknowledgement from the incoming engineer.

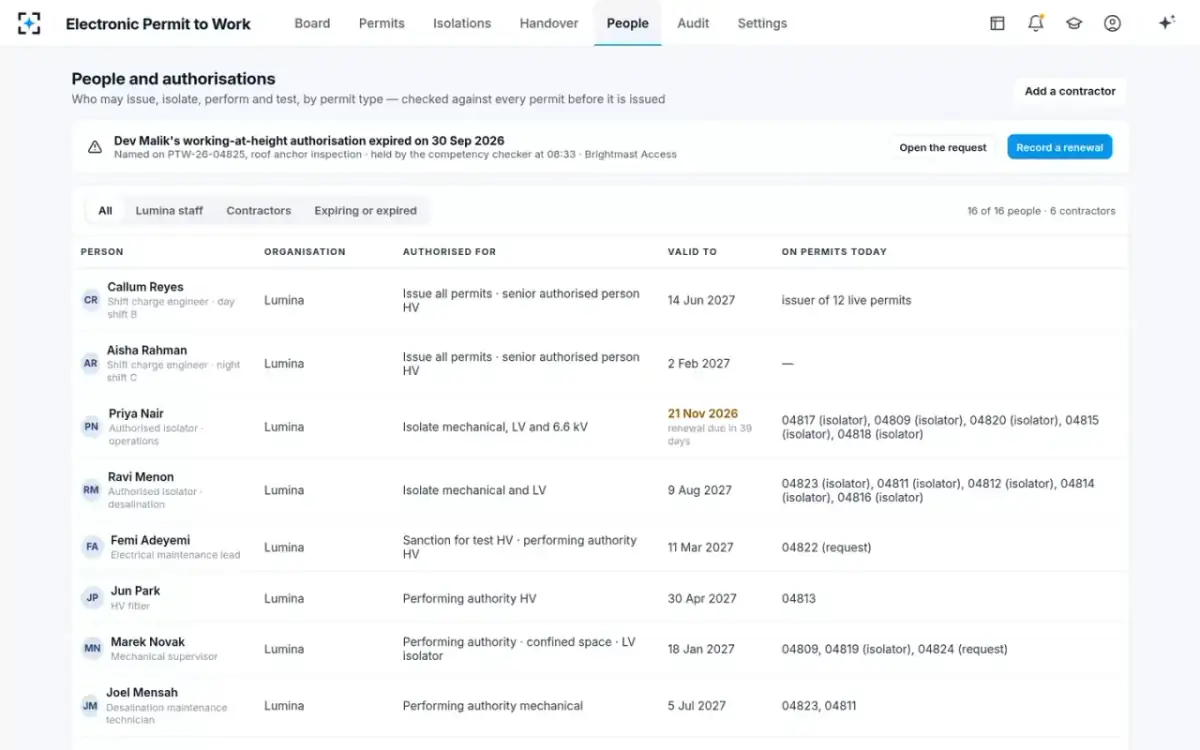

People and authorizationsWho may issue, isolate, perform and test, by permit type and expiry, with the expired authorization that held a request.

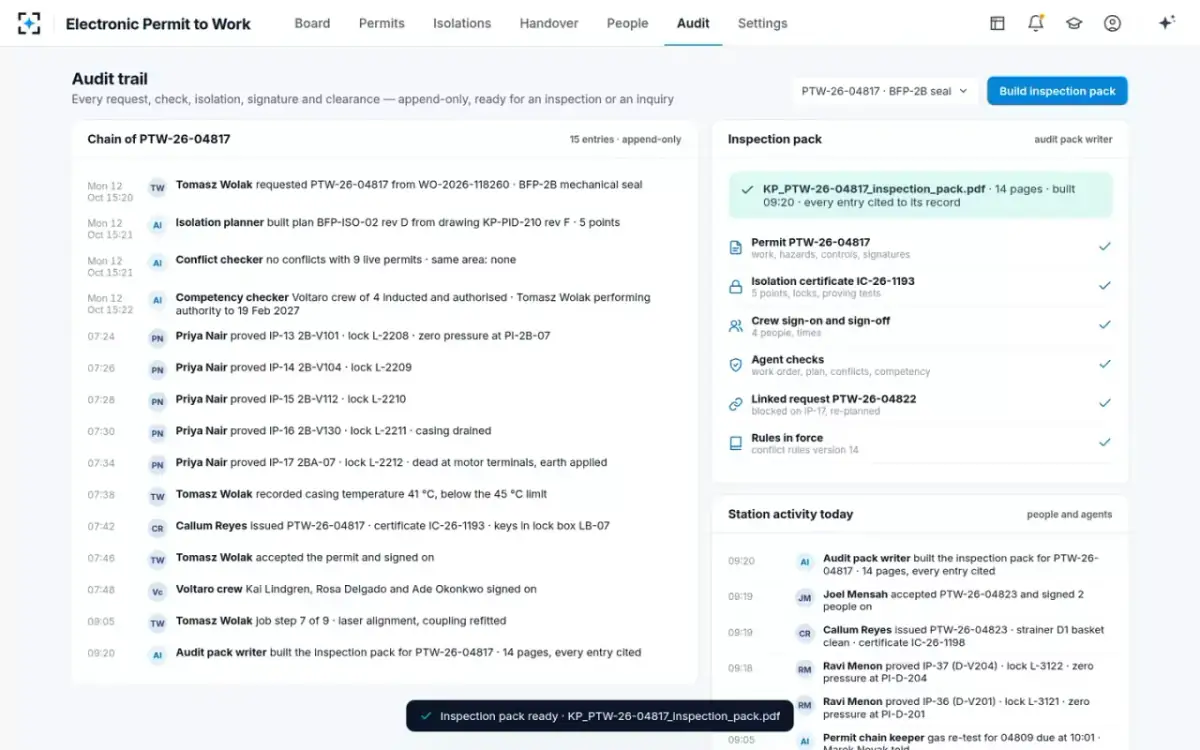

Audit trail and inspection packThe append-only chain of one permit and the inspection pack built from it, each entry cited.
The rulesConflict rules, validity and clocks, approval chains by permit type, competency rules and who owns them.
Governance

Proved locks, a block without override and an append-only permit trail

A block with no overrideA permit that would remove an isolation another permit holds is blocked, and the block cannot be overridden from the board. Changing that rule needs the HSE manager and the station manager.
People isolate, issue and clearAgents check, block and draft. The authorized isolator proves each point. The shift charge engineer issues with badge and PIN. The performing authority accepts and signs the crew on. No permit is cleared while anyone is signed on.
Each lock proved before issueEach isolation carries its lock number, lock box, the person who proved it, the time and the proving test. A proving test might be zero pressure at a named gauge, no voltage at the motor terminals or an earth applied.
Each check cites its recordEach agent check points to the record it used: the work order, the drawing revision, the live permit or the authorization record. So the issuer sees why a request is clear, held or blocked.
An append-only trailEach request, check, isolation, signature and clearance is recorded with the person, the time and the evidence, ready for an inspection or an incident inquiry.
Versioned rules, and contractors see only their own permitsThe station HSE manager sets the rules, and each change is saved as a new rule version. Contractors see only the permits they perform. The station's data stays with the utility.
Configuration

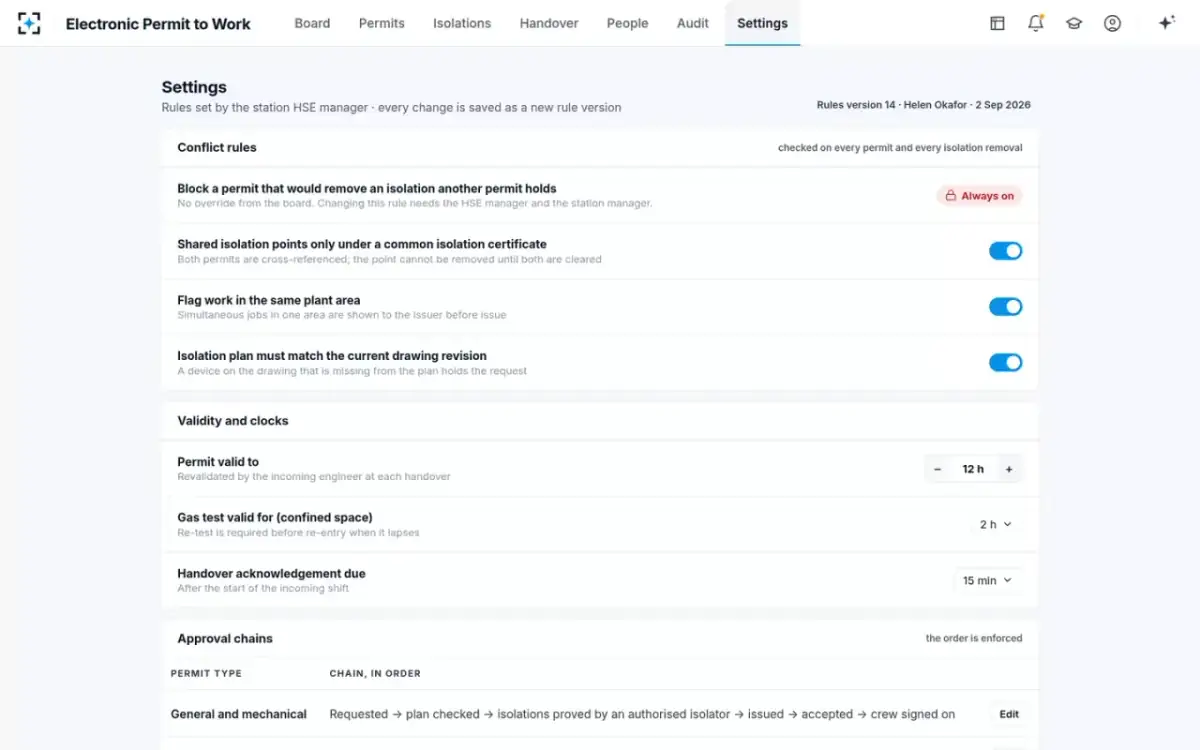

Conflict rules, clocks and approval chains in the station's permit rules

Conflict rules, clocks, approval chains and competency rules are all settings. The station HSE manager owns them, and each change is saved as a new version.

SettingDefaultChoose from
Block a permit that would remove an isolation another permit holdsAlways onLocked on, with no override from the board. Changing it needs the HSE manager and the station manager
Shared isolation points only under a common isolation certificateOnOn · Off. Both permits are cross-referenced, and the point cannot be removed until both are cleared
Flag work in the same plant areaOnOn · Off. Jobs running at the same time in one area are shown to the issuer before issue
Isolation plan must match the current drawing revisionOnOn · Off. A device on the drawing that is missing from the plan holds the request
Permit valid to12 hSet in hours. The incoming engineer revalidates the permit at each handover
Gas test valid for (confined space)2 h1 h · 2 h · 4 h. When it lapses, a re-test is required before re-entry
Handover acknowledgement due15 min10 min · 15 min · 30 min after the start of the incoming shift
Contractor site induction valid for12 months6 months · 12 months · 24 months, checked for every contractor signing on
Connections

Drawings, isolation plans and competency records each permit draws on

Work ordersthe maintenance work order and job plan, with equipment, energy sources and steps that run or test the plant
Isolation plans and drawingsthe standard isolation library, process drawings and single-line diagrams, by revision
Competency recordsstaff and contractor authorizations by permit type, inductions and expiry dates
Active permits and isolationsall live and suspended permits, isolation certificates, locks and lock boxes
Network controlremote-end isolations confirmed by network control, such as an open, locked and earthed substation breaker
Station safety rulesconflict rules, approval chains by permit type and the rules version in force
What it changes

Permits to work issued sooner, each with its full signed chain

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0
permits live over a held or unproved isolation. That is the design goal, and the conflict checker blocks each one
Each live permit
checked against every other permit
target
100%
of permits carry the full signed chain, ready for an inspector
target
15min
from request to issue, so crews wait less
Paper, walked45 to 90 min
With agents≈ 15 min

“Demo” means seen in the working solution, on its sample station data. “Target” means the design goal, measured in the live solution. “Estimated” means our estimate. The minute split comes from three signatures in three places and a 10 to 20 minute walk each. “Typical” means published figures. In OSHA's most frequently cited standards for FY2025, lockout/tagout (29 CFR 1910.147) was 4th, with 2,562 citations. The maximum penalty is $165,514 per willful or repeat violation (2025 amounts). A DEKRA study of 1,060 recordable incidents at 11 utilities found 32 % with serious-injury-or-fatality potential. The figure across all industry is 25 %. For context, see UK HSE HSG250, Guidance on permit-to-work systems, and Lord Cullen's Piper Alpha findings. See also OSHA 29 CFR 1910.269(d) and (m). Names on the screens are sample data.

Questions

Electronic permit to work system questions from plant and network teams

What is an electronic permit to work system?

An electronic permit to work system (ePTW) replaces paper permits and isolation certificates with one record. That record holds the work, its isolations, the approval chain and each signature. Electronic Permit to Work puts all live permits on a board drawn over the plant diagram. It checks each request against the drawing, the live permits and each person on the crew, and keeps the full trail.

How does it stop two permits relying on one isolation?

The conflict checker runs on each new permit and each isolation removal, against all live and suspended permits. A request that would remove an isolation another permit holds is blocked. It is drawn on the diagram, with the crew at risk and the safe routes. A point may be shared only under a common isolation certificate, and it stays in until both permits are cleared.

Can a permit be issued before the isolations are proved?

No. The permit chain keeper enforces the order set for each permit type. The order is requested, plan checked, isolations proved by an authorized isolator, issued, accepted and crew signed on. Each point records its lock number and proving test. The issue button only appears once all points are proved.

How does it handle shift handover and revalidation?

The permit chain keeper drafts the handover. It shows which permits continue and must be revalidated, and which clear before the change of shift. It lists suspended permits with their isolations in, and gas re-tests due for confined spaces. The incoming shift charge engineer acknowledges each permit, by default within 15 minutes of the start of the shift.

Does it check contractor and staff competency?

Yes. The competency checker checks the issuer, the isolator, the performing authority and each crew member against the permit type and the date. That includes contractor site inductions. An expired authorization always holds the request. The checker does not grant or extend one.

Is it permit to work software for utilities, for power and water?

Yes. It is built for generation, networks and water. The working solution runs a combined-cycle station with water treatment trains, a 6.6 kV unit board, a 33 kV switchroom, cooling-water intake and chlorination. Approval chains cover general and mechanical, confined space, high voltage, sanction for test, hot work and work at height. They also cover remote-end isolations confirmed by network control.

Can a supervisor override a conflict block when the outage is running late?

No. The conflict block has no override on the board. Changing the rule needs the HSE manager and the station manager. Agents check, block and draft, and they do not isolate, issue, sign or clear. The authorized isolator proves each lock. The shift charge engineer issues and clears, and the performing authority accepts and signs the crew on.

What do we provide to set it up for our plants?

Share your permit procedures, approval chains, standard isolation plans, drawings and authorization records. The Agentic Solution Engine builds and deploys the solution from those requirements and documents. It goes live once each quality gate has passed. We will walk you through it on your own permits first.

Run the permit to work board
on your own isolation plans.

We'll run Electronic Permit to Work on a sample of your own work orders, isolation plans and drawings.
