WorkflowLegal & IP

Acquisition Contract Change-of-Control Review

Change of control clause review for the whole inherited estate — every contract read, every consent and notice sent on its clock

Every inherited contract read in days, and each consent and notice sent before its clock runs out.

See one case, screen by screen ↓
demo4daysto read and triage all 2,846 inherited contracts, from 3,412 data-room files
demo336contractsthat need action — 74 consent, 212 notice, 9 conflict, 41 for a lawyer’s read
demo1,184clausesplain anti-assignment clauses left at No action, because the reverse triangular merger leaves the target as the party
demo6sto draft a consent request from the approved template, with the triggering clause quoted and cited
The problem

Why inherited contracts slip through after closing

The deal closes and the clocks start. Somewhere in the target’s data room are a few hundred contracts that need a consent request, a notice or a decision — and a few thousand that need nothing. Some counterparties may terminate if they have not consented within 60 or 90 days. Many notice clauses give 30 days. Exclusivity and non-compete covenants written for the target now reach every programme of the acquirer.

Finding them means reading every agreement for assignment, change-of-control, exclusivity, most-favoured and notice wording, then deciding what each clause means under the deal structure — a “by merger, by operation of law” clause bites under a reverse triangular merger where a plain anti-assignment clause does not. By the time an outside-counsel first pass comes back, the first notice deadlines have already gone, and the covenant that reaches your Phase 3 asset is one row in a spreadsheet.

demo60daysafter closing before Aldermoor may terminate, without consent, the licence KLV-210 depends on
typical2,000–5,000contractsin a typical inherited estate
demo30daysafter closing for 119 change-of-control notices in the sample deal
Where the first-pass review’s days goestimated
By hand41 days
With the solution6 days
  • Sorting the data-room export to executed versions6 → 0.5 d
  • Reading every agreement for the relevant clauses18 → 2 d
  • Deciding consent, notice or no action under the deal structure8 → 1.5 d
  • Checking covenants against the acquirer’s programmes4 → 1 d
  • Drafting consent requests and notices5 → 1 d

Estimated split for an inherited estate of a few thousand contracts, by hand and with the solution.

How it works

How an inherited contract moves

Four agents read and triage every inherited contract, two more draft the letters and chase the replies; counsel confirms each outcome and a signatory signs.

What comes in
Contracts inData-room export · 3,412 files, any template
Agents at work
Data room intakeexecuted versions
Then
Clause finder8 clause families
Then
Trigger analystdeal structure + law
Commitments checkeragainst our commitments
A person decides
Counselconfirms each outcome; conflicts go to a senior lawyer
What comes out
An outcome per contract
Consents and notices signed and sent
Replies chased to the clock
One case, step by step

One acquisition, from the data room to signed letters

Northwind Bio acquired Kelvara Therapeutics by reverse triangular merger, closing Sep 14, 2026. It is day 23. Here is the integration counsel’s morning, screen by screen, in the working solution.

  1. 01Day 23 · morning

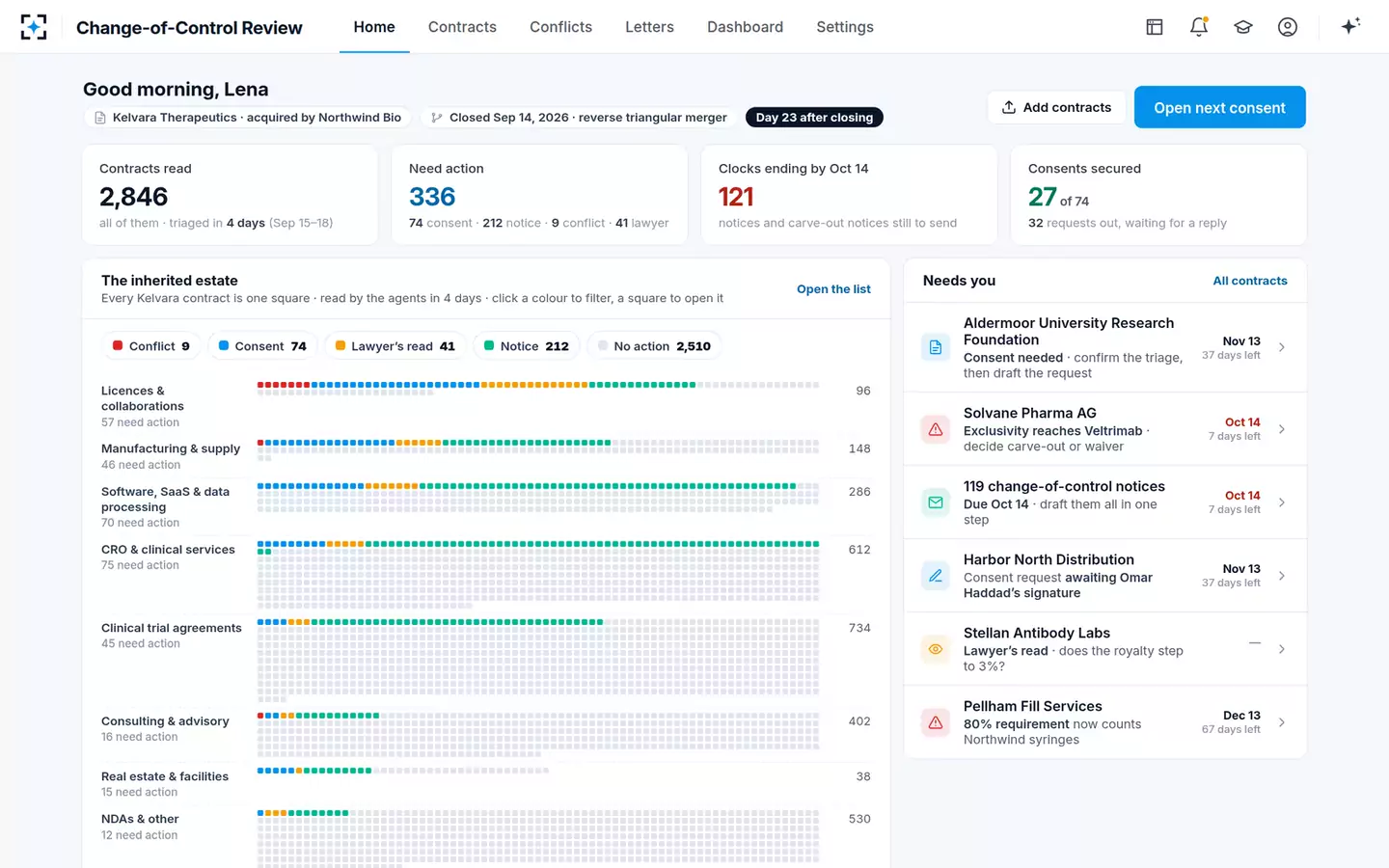

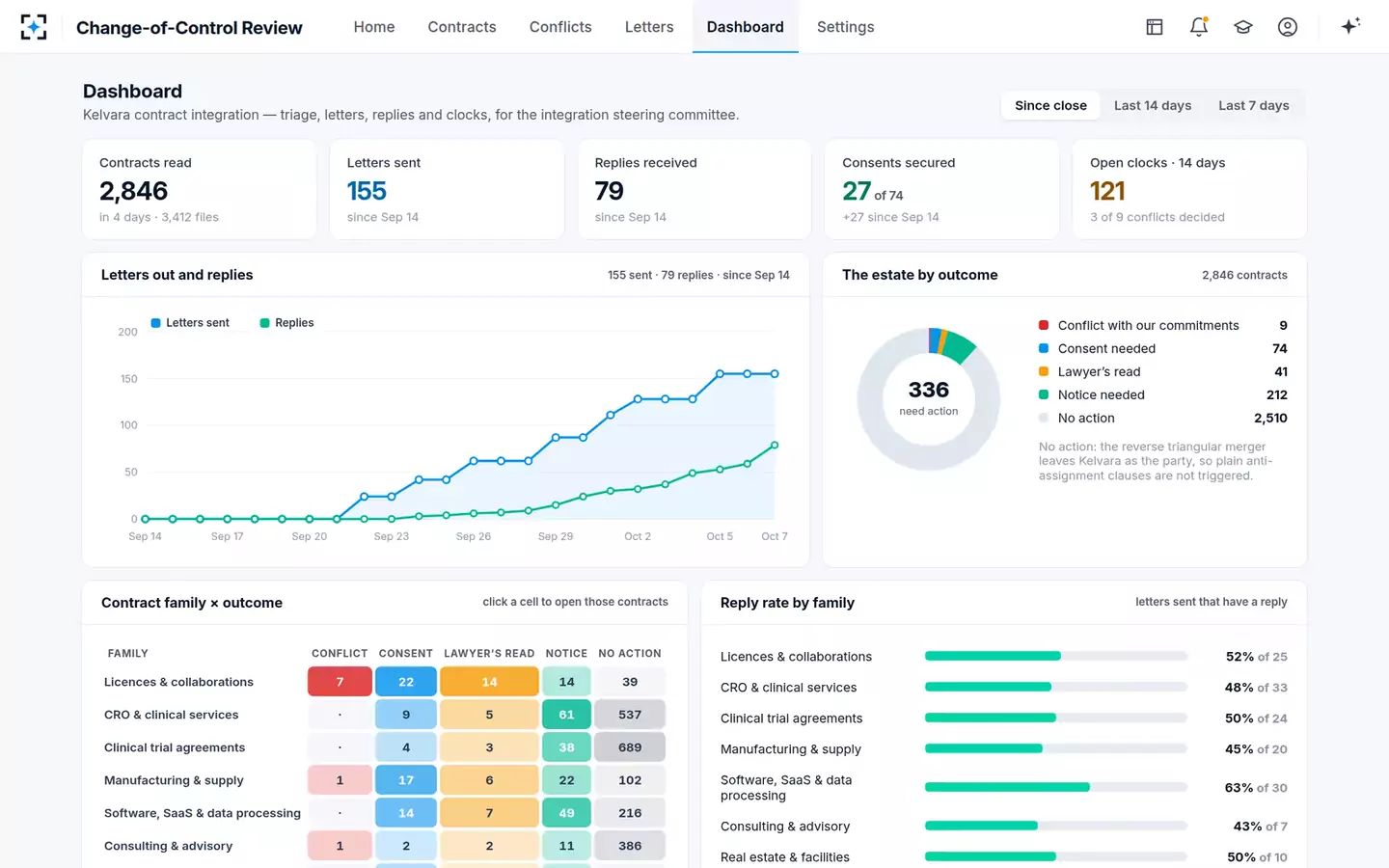

    The whole inherited estate, on one screen

    Lena Ortiz · Integration counsel

    Lena opens the solution and sees where the deal stands: 2,846 Kelvara contracts read, triaged in 4 days (Sep 15–18); 336 need action; 121 clocks end by Oct 14; 27 of 74 consents secured. Every contract is one square on the estate wall, coloured by outcome and grouped by family, and “Needs you” lists what is hers today, each with its clock.

    “119 change-of-control notices · Due Oct 14 · draft them all in one step.”

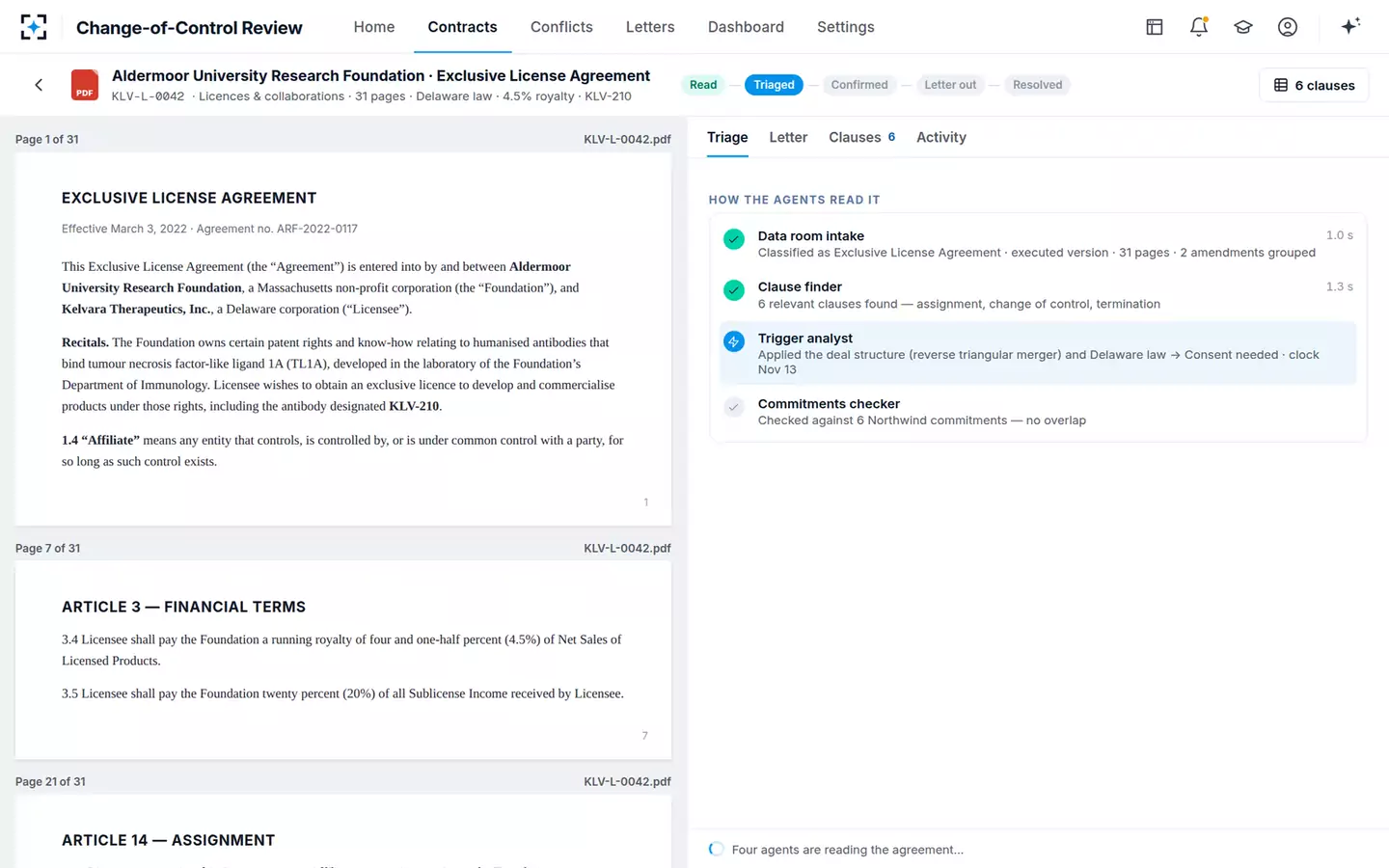

  2. 02One click

    Aldermoor’s licence, read by four agents

    The agents

    “Open next consent” brings up KLV-L-0042, the Exclusive License Agreement with Aldermoor University Research Foundation — 31 pages, Delaware law, a 4.5 % royalty, and the licence KLV-210 rests on. Data room intake confirms the executed version and groups 2 amendments, the Clause finder finds 6 relevant clauses, the Trigger analyst applies the deal structure and Delaware law, and the Commitments checker tests it against 6 Northwind commitments.

    Every step is shown as it runs, with what it found.

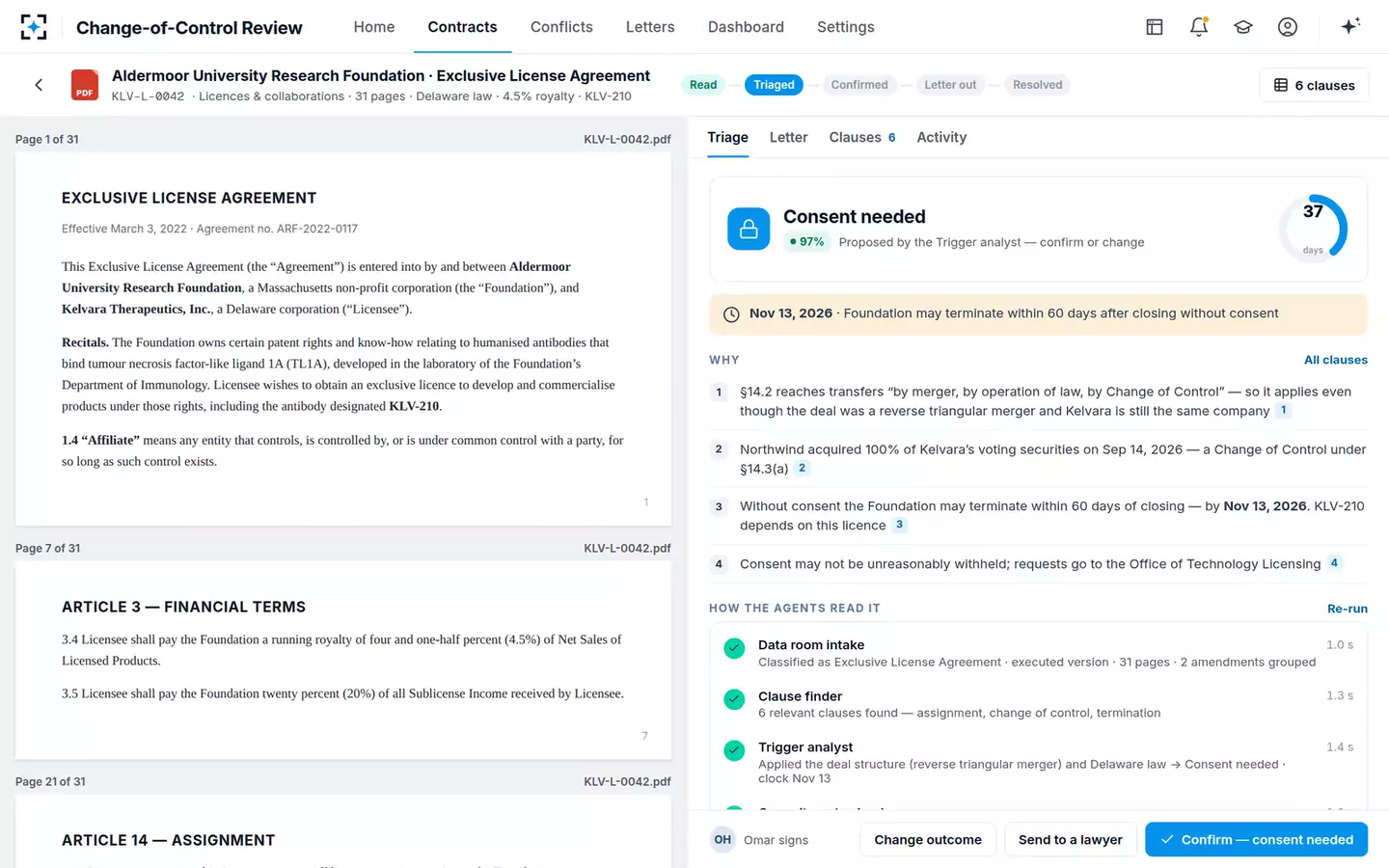

  3. 03Seconds later

    Consent needed — 97 % sure, with the clock

    Trigger analyst

    The proposal is Consent needed, with a 37-day ring: without consent the Foundation may terminate within 60 days after closing — by Nov 13, 2026. The reasons are listed and cited: Northwind bought 100 % of Kelvara’s voting securities, a Change of Control under §14.3(a); consent may not be unreasonably withheld; requests go to the Office of Technology Licensing.

    “§14.2 reaches transfers ‘by merger, by operation of law, by Change of Control’ — so it applies even though the deal was a reverse triangular merger and Kelvara is still the same company.”

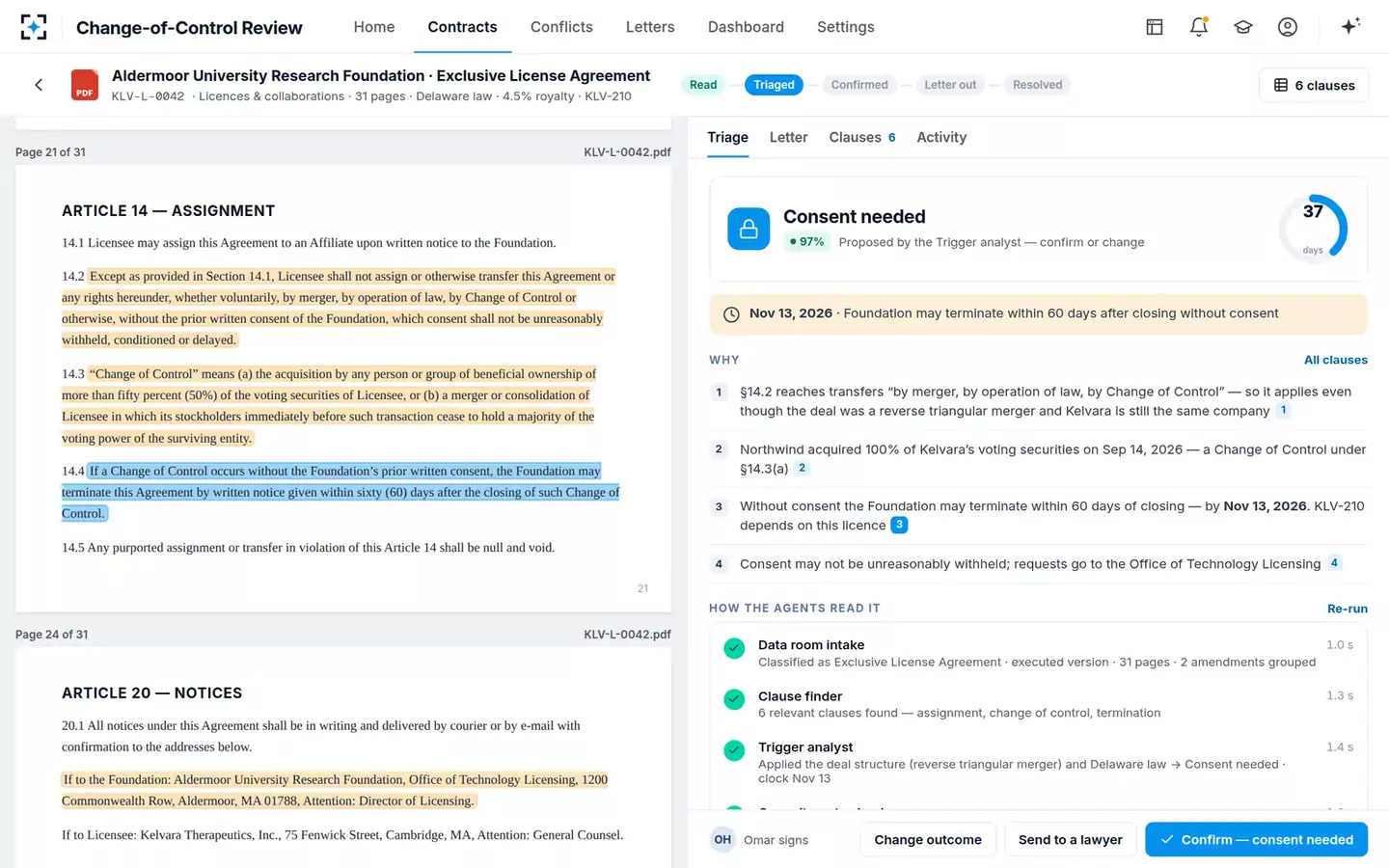

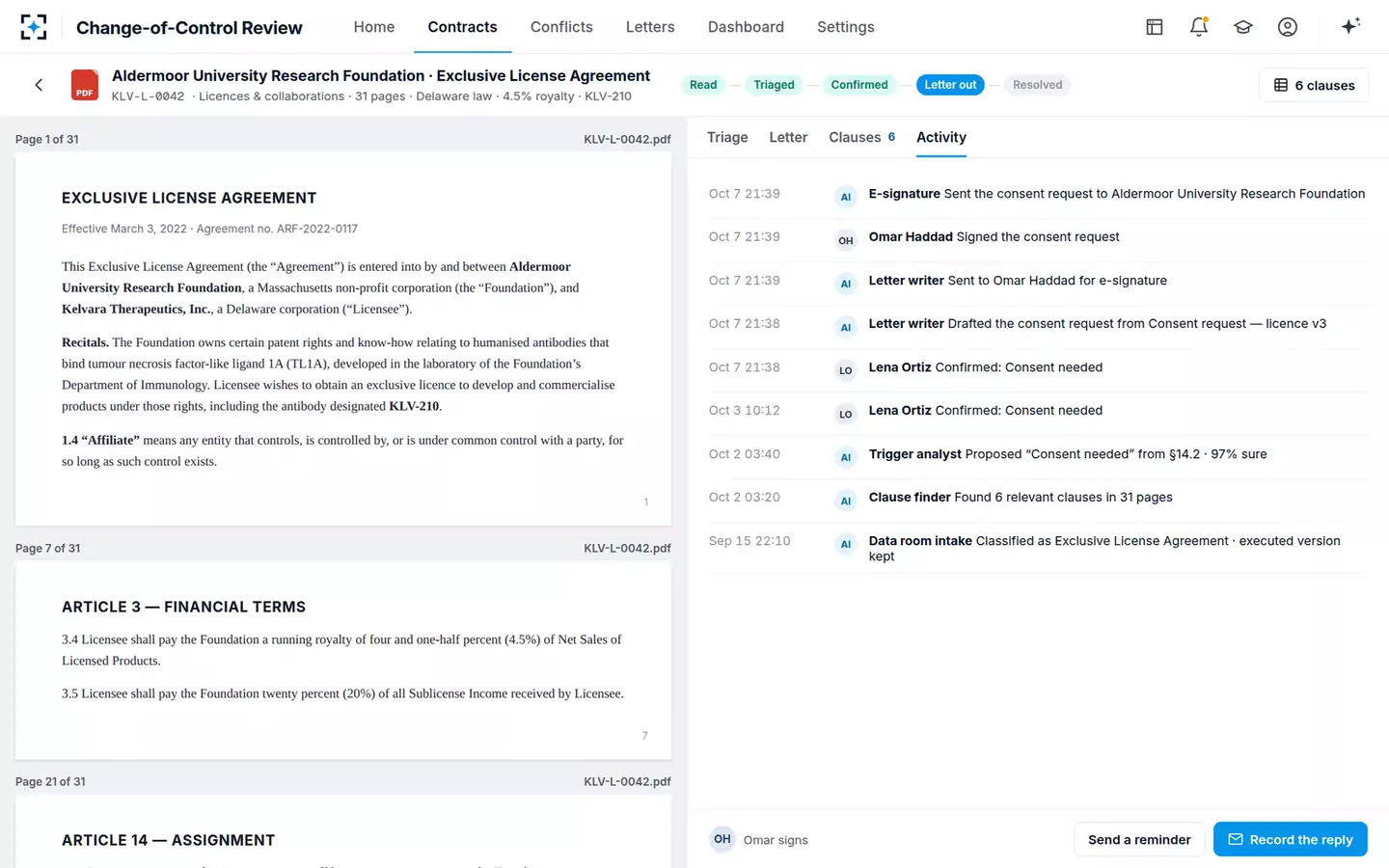

  4. 04Checked

    Every reason, back to the page it came from

    Lena Ortiz · Integration counsel

    Lena clicks a citation and the agreement opens at page 21: §14.2, §14.3 and the §14.4 termination right highlighted in the original wording, and the Article 20 notice address on page 24. She can confirm the outcome, change it with a reason, or send the contract to a lawyer.

  5. 05Confirmed · drafted

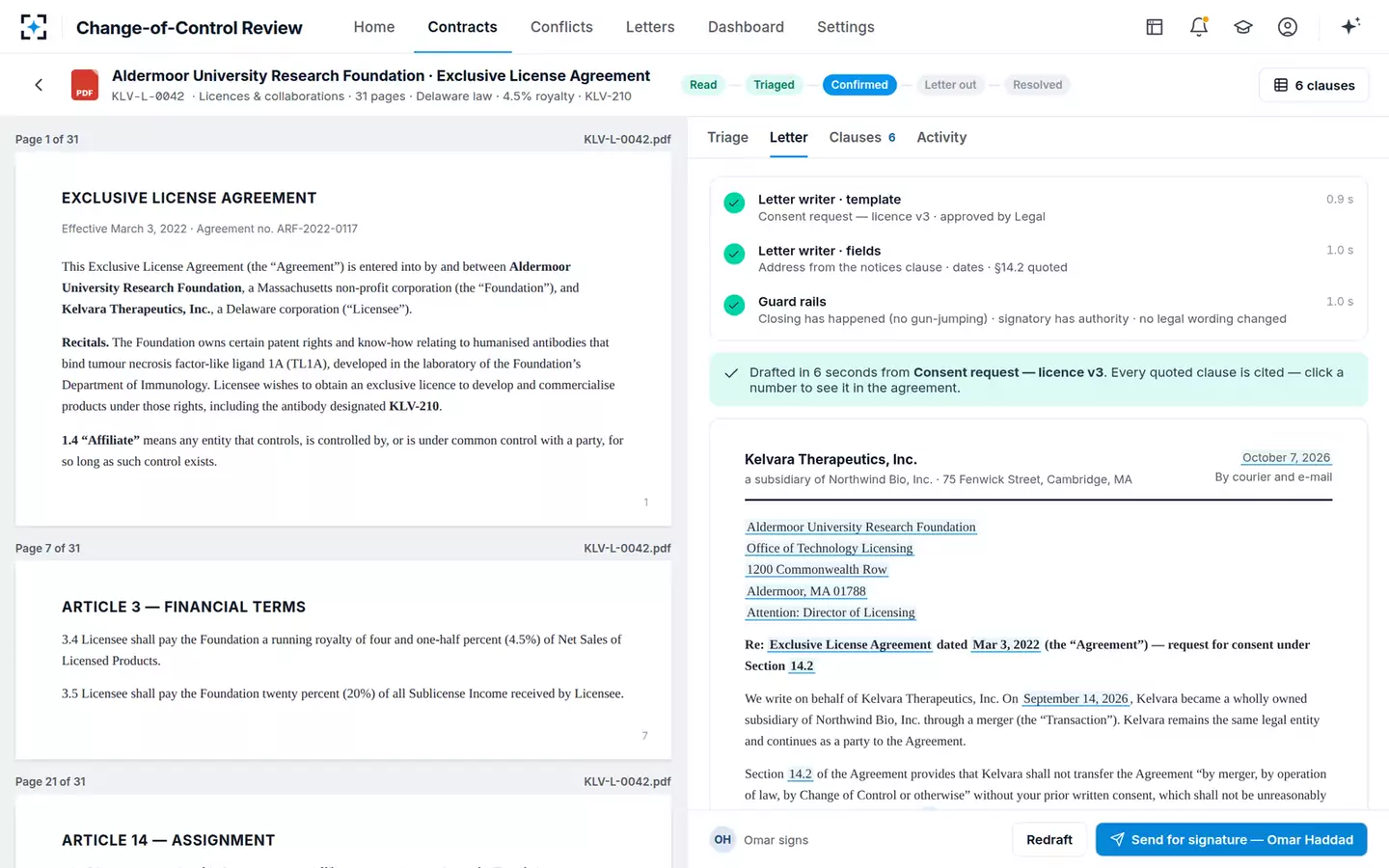

    The consent request, from the approved template

    Letter writer

    Lena confirms. The Letter writer drafts the request from “Consent request — licence v3”, approved by Legal: the Foundation’s notice address from Article 20, the agreement date, §14.2 quoted and cited. Only the highlighted fields are filled; the legal wording is locked.

    Guard rails: “Closing has happened (no gun-jumping) · signatory has authority · no legal wording changed.”

  6. 06Signed · sent

    The approved signatory signs, and it goes out

    Omar Haddad · Associate General Counsel, Transactions

    Consent requests are signed by Omar Haddad. The letter goes to him for e-signature; once he signs, it is sent to the Foundation and the contract moves to Letter out. The activity tab holds every step — the intake, the clauses found, the proposal, Lena’s confirmation, the draft, the signature and the send — with who did it and when.

  7. 07Next

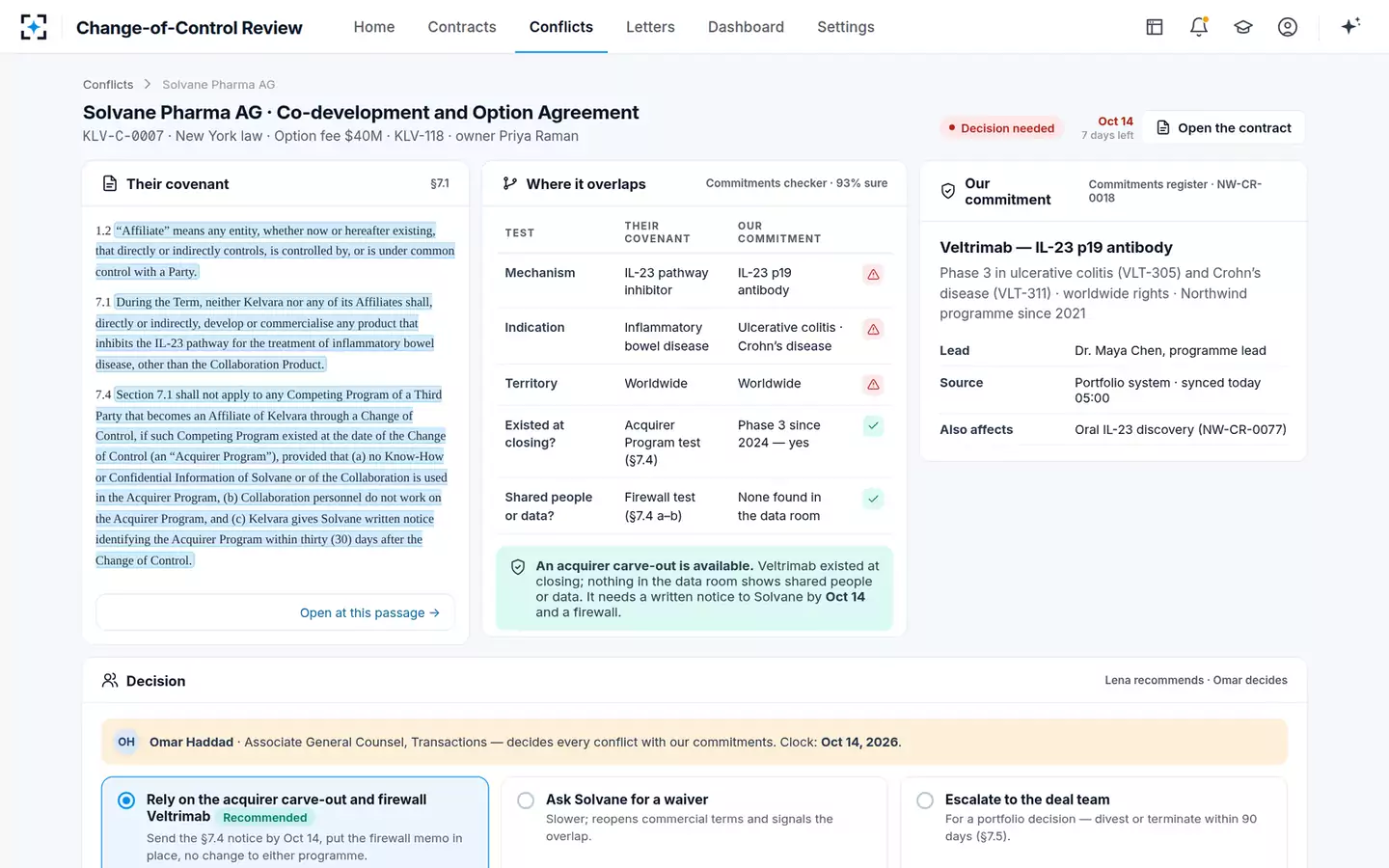

    A covenant that now reaches Veltrimab

    Commitments checker

    Solvane Pharma’s Co-development and Option Agreement binds Kelvara “and its Affiliates” not to develop any IL-23 pathway product for inflammatory bowel disease — and its Affiliate definition covers Affiliates “now or hereafter existing”. Northwind’s Veltrimab, an IL-23 p19 antibody in Phase 3 for ulcerative colitis and Crohn’s disease, overlaps on mechanism, indication and territory. The §7.4 acquirer carve-out is available: Veltrimab existed at closing and nothing in the data room shows shared people or data.

    “It needs a written notice to Solvane by Oct 14 and a firewall.”

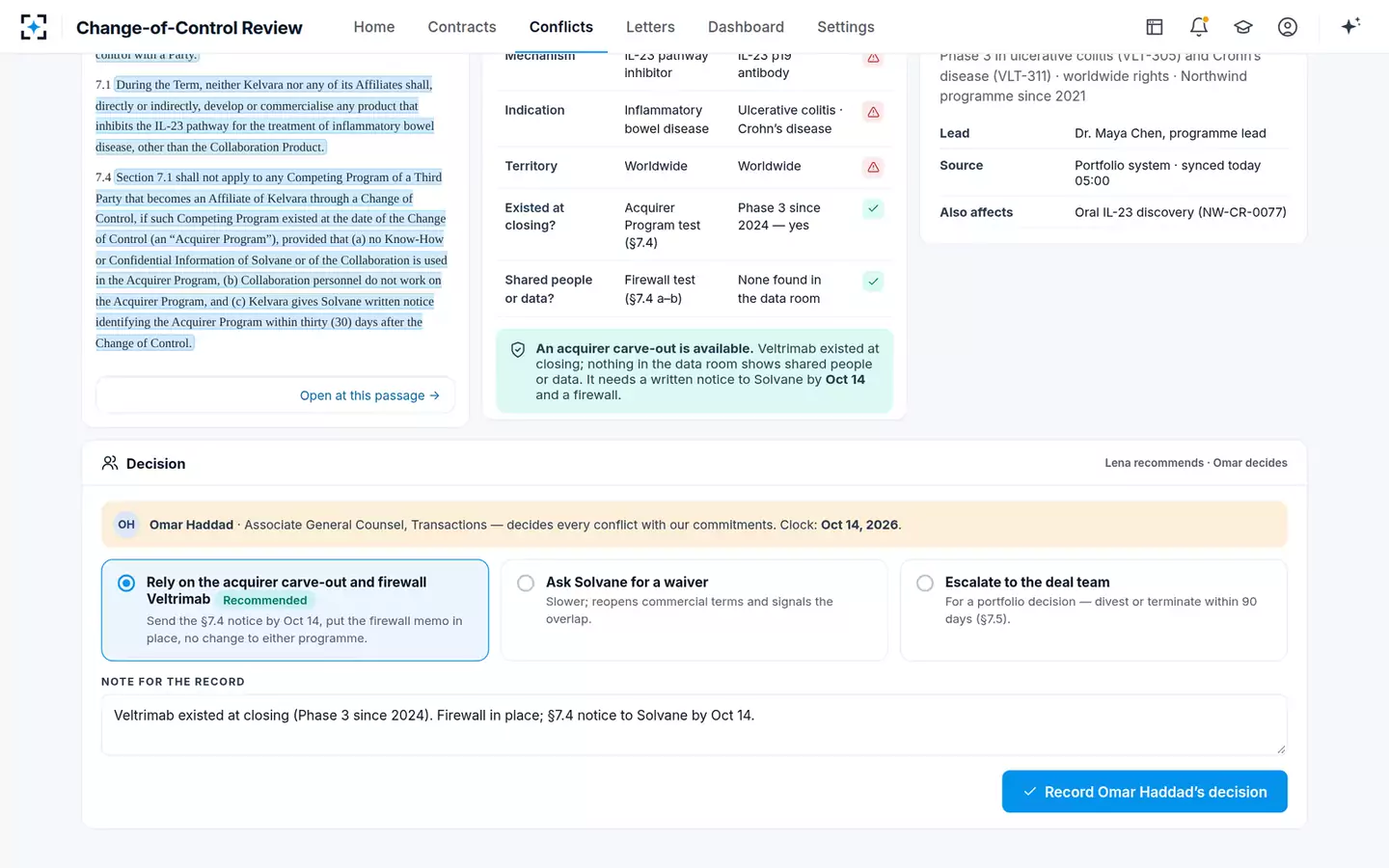

  8. 08Decided

    Lena recommends, Omar decides

    Omar Haddad · Associate General Counsel, Transactions

    Three options, each with its consequence: rely on the acquirer carve-out and firewall Veltrimab (recommended), ask Solvane for a waiver, or escalate to the deal team for a divest-or-terminate decision within 90 days under §7.5. Omar records his decision with a note; the acquirer-programme notice is drafted for his signature and the firewall memo goes to both programme leads.

    The Commitments checker never decides a conflict — Omar Haddad does.

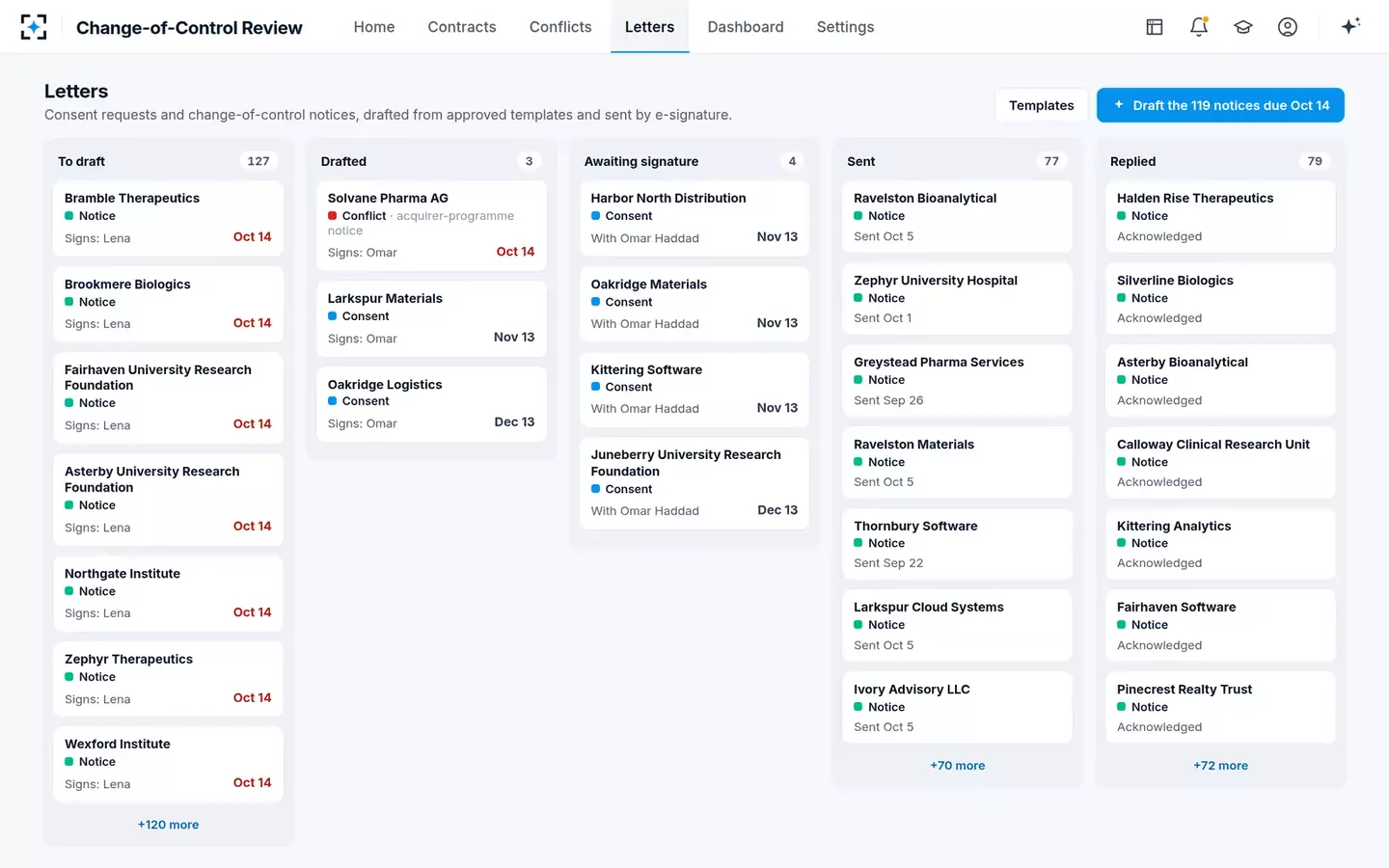

  9. 09One step

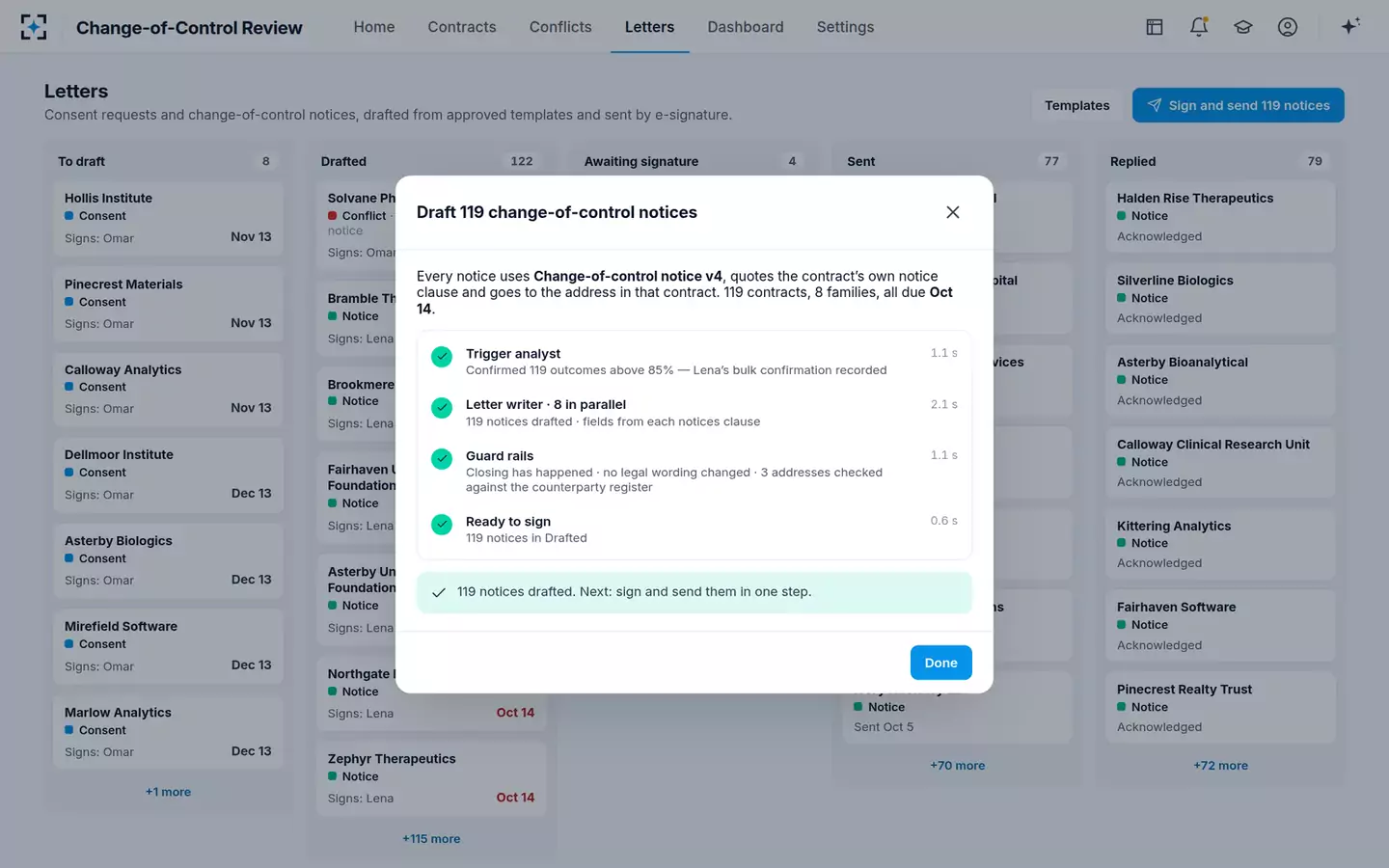

    119 notices due Oct 14, drafted together

    Lena Ortiz · Integration counsel

    From the Letters board, Lena drafts all 119 change-of-control notices due Oct 14 at once — 119 contracts across 8 families. Each uses “Change-of-control notice v4”, quotes the contract’s own notice clause and goes to the address in that contract. Lena is the approved signatory for notices, so she then signs once for all of them, and each signature is recorded per letter.

    “Closing has happened · no legal wording changed · 3 addresses checked against the counterparty register.”

  10. 10Steering committee

    The integration steering committee’s view

    Dana Okafor · Integration office lead

    Contracts read, letters sent, replies received, consents secured and clocks open in the next 14 days — 155 letters out and 79 replies since Sep 14 in the sample deal. The family × outcome grid opens any cell, and reply rates show which families are slow. The Response tracker chases consents after 7 days.

Who it’s for

Built for everyone who carries the inherited contracts.

The same deal, seen by the five people who carry it after closing — what their weeks looked like, and what they look like now.

LO
Lena OrtizIntegration counsel
Reviewer and signatory
Before
Starts from a data-room index and a spreadsheet, and works out which of thousands of contracts actually need a letter.
Now
Starts from 336 contracts that need action, each with its cited clause, its clock and a letter ready to draft.
OH
Omar HaddadAssociate General Counsel, Transactions
Approver
Before
Hears about an exclusivity covenant that reaches an acquirer programme when someone happens to read it.
Now
Gets every conflict with the covenant, the overlap, the carve-out and the clock side by side, and decides with a note for the record.
PR
Priya RamanAlliance manager
Contract owner
Before
Chases licensors and partners for consents with no clear view of which termination windows are closing.
Now
Sees each consent request from draft to reply, with reminders sent and every reply recorded against the contract.
SP
Sam PatelProcurement integration lead
Contract owner
Before
Has no quick way to see which supply agreements now count the acquirer’s own volume against a requirements clause.
Now
Sees supply and services contracts that need action, including requirements terms that now reach Northwind, with the clock on each.
DO
Dana OkaforIntegration office lead
Viewer
Before
Collects status from counsel and contract owners by email before every steering committee.
Now
Opens the dashboard: triage, letters, replies and clocks for the whole estate, and exports for the integration office.
Built on the engine

6 agents. Each with one job, and hard limits.

Four agents read and triage every inherited contract, two more draft the letters and chase the replies; counsel confirms each outcome and a signatory signs.

Data room intake

Reads the data-room export, classifies each file, keeps the executed version and groups amendments, work orders and side letters under their agreement — with counterparty, effective date, governing law and page count.

  • Never discards a file — duplicates are linked, not deleted
  • Prefers the executed, signed version
Clause finder

Finds assignment, change-of-control, exclusivity, non-compete, most-favoured, termination, notice and data-protection clauses, with page and section, and the defined terms they depend on.

  • Quotes verbatim — never paraphrases a clause as a citation
  • Every clause carries its page
Trigger analyst

Applies the deal structure and governing law to each clause: consent, notice, no action or lawyer’s read — with the clock and the consequence of missing it.

  • Below 85 % confidence, the contract goes to a lawyer’s read
  • IP licences and personal-services contracts go to a lawyer
  • Explains every outcome with cited clauses; counsel confirms or changes it
Commitments checker

Compares every exclusivity, non-compete and most-favoured term with the Northwind commitments register — mechanism, indication, territory and term — and looks for acquirer carve-outs and their conditions.

  • Never decides a conflict — Omar Haddad decides
Letter writer

Drafts consent requests, notices, carve-out notices and amendment requests from approved templates, quoting the triggering clause and routing each to the approved signatory.

  • Legal wording is locked — fields only
  • No letter before closing (gun-jumping guard)
  • Approved templates only
Response tracker

Reads replies and e-signature envelopes, records consent or acknowledgement, chases after 7 days and escalates before termination windows close.

  • Refusals and conditions always go to a person
  • Escalates to the owner 14 days before a termination window closes
Counsel

Confirms each outcome; a signatory signs. The agents propose; a named person decides.

Ask in plain words

Ask about any contract, clause or clock

Counsel and contract owners can ask about any inherited contract, clause, clock or letter in plain words — or tell it what to change. Answers cite the clause.

Why does Aldermoor need consent after a reverse triangular merger?

Because §14.2 does not stop at assignment: it bars transfer “whether voluntarily, by merger, by operation of law, by Change of Control or otherwise” without the Foundation’s consent. Northwind bought 100% of Kelvara’s voting securities — a Change of Control under §14.3(a). Without consent the Foundation may terminate within 60 days of closing — by Nov 13 — and KLV-210 depends on this licence. Consent may not be unreasonably withheld; the request goes to its Office of Technology Licensing.

What has to go out before Oct 14?

By Oct 14 (Day 30): 119 change-of-control notices, such as the Merrowfield MSA notice under §18.3, and 2 carve-out notices, such as Solvane under §7.4. The notices need no consent and can be drafted now from Change-of-control notice v4. The carve-out notices wait for Omar Haddad’s decision.

Could a letter go out too early?

No. The guard rail “No letter leaves before closing” is locked on: before Sep 14 the Letter writer could prepare drafts, but e-signature refuses to send while the deal is open. Every send is recorded with the closing evidence in the audit trail.

Add a rule: flag every royalty step-up for a lawyer

Added the rule “Flag a royalty or fee step-up triggered by a change of control” to the triage rules — on, effective now. It flags 3 contracts today, including Stellan Antibody Labs §6.3 (2% → 3%). Each goes to a lawyer’s read before any letter. You can switch it off in Settings.

Every screen

The working solution, as it ships.

13 screens from the working solution, on its sample data. Pick one to see it large.

HomeDay 23 after closing: contracts read, contracts that need action, clocks ending soon, consents secured, and what needs integration counsel today.

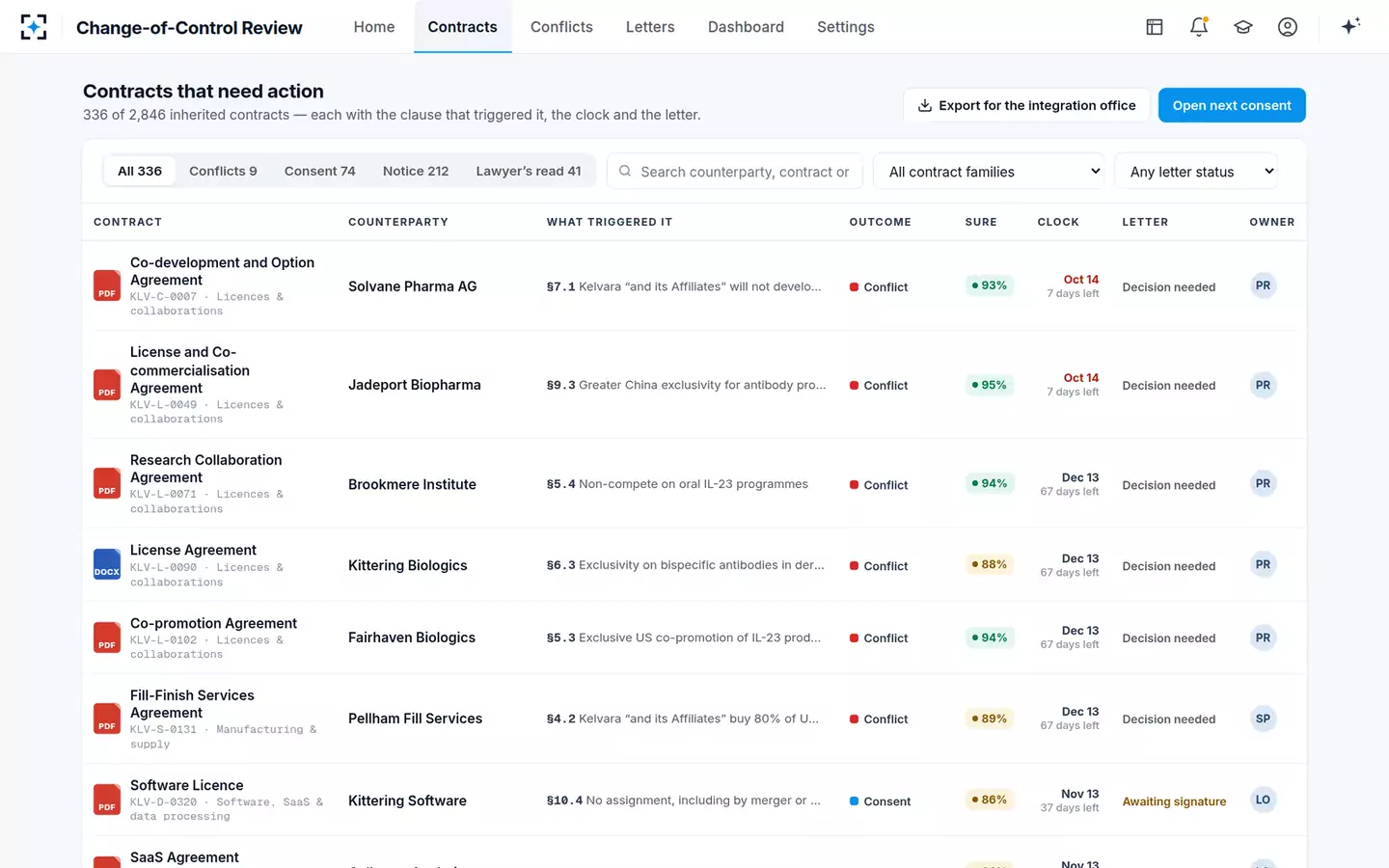

Contracts that need actionThe 336 contracts that need action, each with the clause that triggered it, the outcome, how sure the agents are, the clock, the letter and the owner.
Agents at workData room intake, Clause finder, Trigger analyst and Commitments checker read the agreement in view, each step with what it found.
The triageThe proposed outcome, its confidence and clock, the cited reasons and how the four agents read the agreement.
Back to the sourceA citation opens the agreement at the page, with the triggering wording highlighted.
The consent requestDrafted from the approved template, the notice address and dates filled, the triggering clause quoted and cited.
The activity trailEvery agent step and every human action on the contract, with who and when.
Where it overlapsTheir covenant, our commitment and the overlap test — mechanism, indication, territory, and whether a carve-out applies.
The conflict decisionThree options with their consequences, the recommended one marked, and a note for the record — Lena recommends, Omar decides.
LettersConsent requests and notices from to draft, to drafted, awaiting signature, sent and replied.
119 notices in one stepEvery change-of-control notice due Oct 14 drafted from the approved template, each quoting its own notice clause.
The integration dashboardLetters out and replies, the estate by outcome, family by outcome and reply rate by family, for the steering committee.
Deal facts and triage rulesThe acquired company, closing date and deal structure, and the triage rules counsel can switch on and off.
Governance

Built for legal work: cited, confirmed, signed, on the record.

Every outcome cites the clauseEach outcome lists its reasons with numbered citations. Click one and the agreement opens at the page, with the exact wording highlighted — quoted verbatim, never paraphrased.
Counsel confirms every outcomeThe Trigger analyst only proposes. Counsel confirms, changes the outcome with a reason, or sends the contract to a lawyer — and the change is recorded with their name.
Conflicts go to a named deciderEvery conflict with the acquirer’s commitments is decided by Omar Haddad, with the options, the consequence of each and a note for the record.
Legal wording is lockedLetters come only from templates approved by Legal. The Letter writer fills the fields — addresses, dates, sections — and never changes the wording.
Nothing goes out unsignedEach letter goes to its approved signatory for e-signature, contracts above $5M a year need the business owner’s co-signature, and no letter can leave before closing.
Every step on the recordEach agent step, confirmation, decision, signature and reply is in the contract’s activity trail, and every settings change is recorded in the audit trail.
Configuration

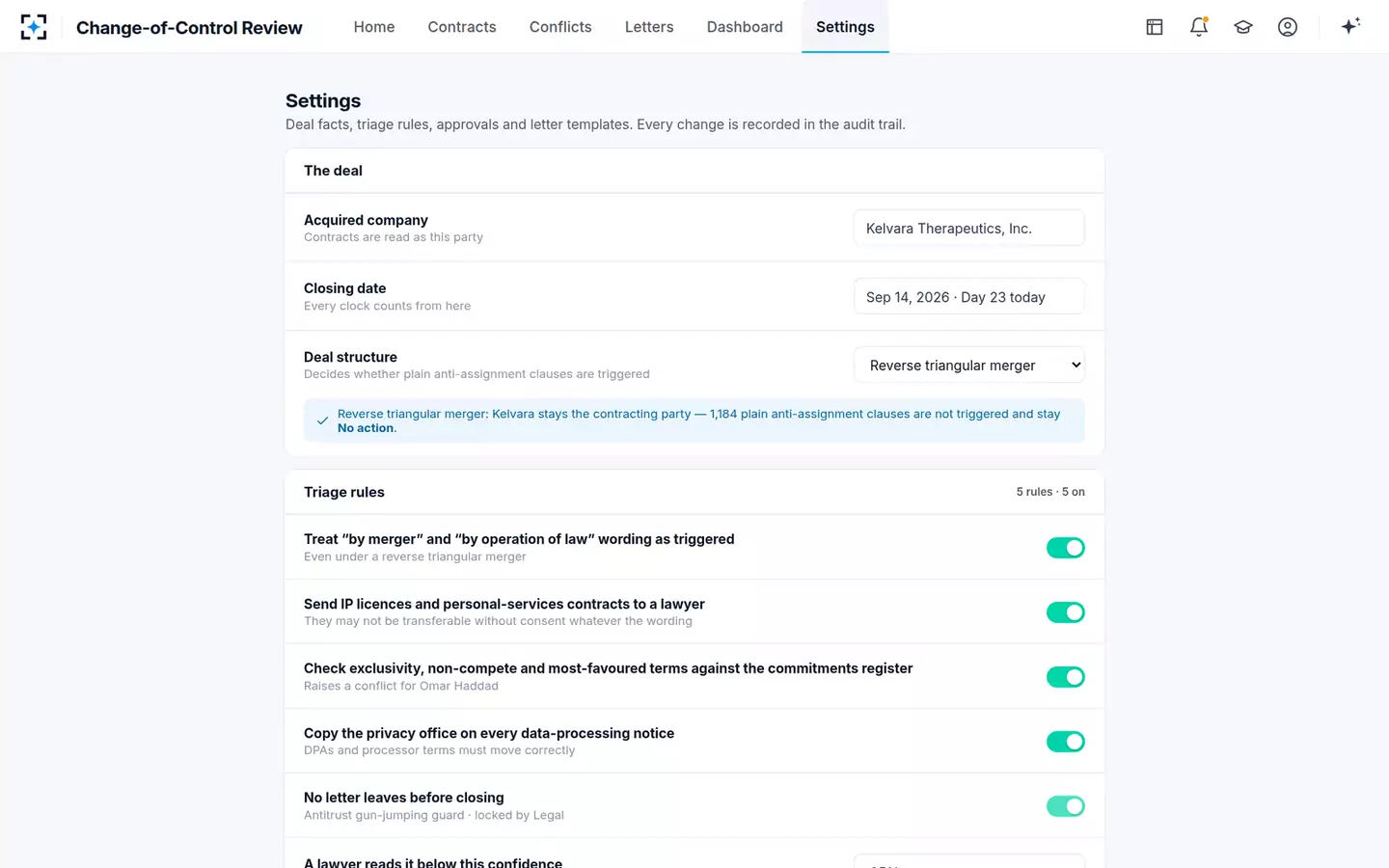

Your deal’s facts and your legal team’s rules

The deal structure, the triage rules, the confidence line and who signs what are settings — change one and the triage follows.

SettingDefaultChoose from
Deal structureReverse triangular mergerReverse triangular merger · Forward merger · Asset purchase
A lawyer reads it below this confidence85 %80 · 85 · 90 %
Treat “by merger” and “by operation of law” wording as triggeredOnOn · Off
Send IP licences and personal-services contracts to a lawyerOnOn · Off
No letter leaves before closingOnLocked by Legal
Who signs consent requestsOmar HaddadOmar Haddad · Lena Ortiz
Who signs change-of-control noticesLena OrtizLena Ortiz · Omar Haddad
Contracts above $5M a yearOmar Haddad + business ownerOmar Haddad + business owner · Omar Haddad
Connections

Works with the systems your deal already runs on

The data roomthe target’s contract export, and late files as they arrive
Your commitments registerprogrammes, partnerships and supply, from the portfolio system
Letter templatesconsent, notice, carve-out and amendment wording approved by Legal
E-signatureletters signed by the approved signatory and sent
The integration mailboxreplies read and recorded against each contract
Your contract systemthe signed letter and the reply, filed with the contract
What it changes

The difference, in numbers.

Every figure is labelled: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
4days
to read and triage 2,846 inherited contracts
By counsel6–8 weeks
With agents4 days
target
336contracts
needing consent, notice or a decision, found among 2,846
336 need action
2,510 need none, each with the reason
estimated
6min
of counsel time to confirm each contract that needs action; nothing goes out unsigned

“demo” = seen in the working solution, on its sample deal · “estimated” = our estimate · “typical” = published figures (typical inherited estates of 2,000–5,000 contracts). People and companies named on this page are characters in the working solution.

Questions

What M&A and integration teams ask us.

What is a change of control review?

After an acquisition, every contract the target signed is read for assignment, change-of-control, exclusivity, non-compete, most-favoured and notice terms, to find which ones need the counterparty’s consent, a notice, or a decision. Acquisition Contract Change-of-Control Review has agents read and triage the whole estate, and counsel confirms each contract that needs action.

How does the deal structure change the outcome?

The deal structure is a setting: reverse triangular merger, forward merger or asset purchase. Under a reverse triangular merger the target stays the contracting party, so a plain anti-assignment clause is not triggered — in the sample deal, 1,184 such clauses stay at No action. Clauses that reach transfers “by merger, by operation of law or change of control”, true change-of-control clauses and notice duties still apply.

Does it catch exclusivity and non-compete conflicts with our own programmes?

Yes. The Commitments checker compares every exclusivity, non-compete and most-favoured term with your commitments register — mechanism, indication, territory and term — and looks for acquirer carve-outs and their conditions. It raises each conflict; a named lawyer decides it.

Who signs the consent requests and notices?

The approved signatory set in Settings — in the sample deal, the Associate General Counsel for consent requests and integration counsel for notices, with the business owner co-signing contracts above $5M a year. Letters are sent by e-signature, and no letter can leave before closing.

Does the AI change the legal wording of our letters?

No. Letters come only from templates approved by Legal. The Letter writer fills the fields — notice address, dates, sections — and quotes the triggering clause; the legal wording is locked.

Do lawyers stay in control?

Yes. The agents propose and cite; counsel confirms or changes every outcome, contracts below the confidence line, IP licences and personal-services contracts go to a lawyer’s read, conflicts are decided by a named lawyer, and refusals or conditional consents always go to a person.

What happens to files that arrive late in the data room?

They are read the same way. In the sample deal, 46 late files were added: 39 duplicates linked to their agreements and 7 amendments grouped under theirs. Files are never discarded.

How long does it take to go live?

The Agentic Solution Engine builds and deploys it from your requirements and documents — your letter templates, your commitments register and a sample of your data room — and it goes live once every quality gate has passed. We will walk you through it on your own contracts first.

See it on
your inherited contracts.

We’ll run Change-of-Control Review on a sample of contracts from your own data room.
