- Before
- Re-performs every closure request by hand, pulling her own sample to learn whether the control kept working. “Done is not the same as proven.”
- Now
- Opens each request as a dossier already tested against its evidence and the system of record, checks the passages that matter, and decides with a reason code.
One MRA closure request, from the owner's done to the examiner's pack
Corvane National Bank, a fictional US regional bank supervised by the OCC, carries MRA 2025-07 on interest rate risk model assumption governance, committed for October 31, 2026. Daniel Okoro, its owner, asked for closure on October 14. Here is what happens on October 22, screen by screen, in the working solution.
- 01Thursday morning

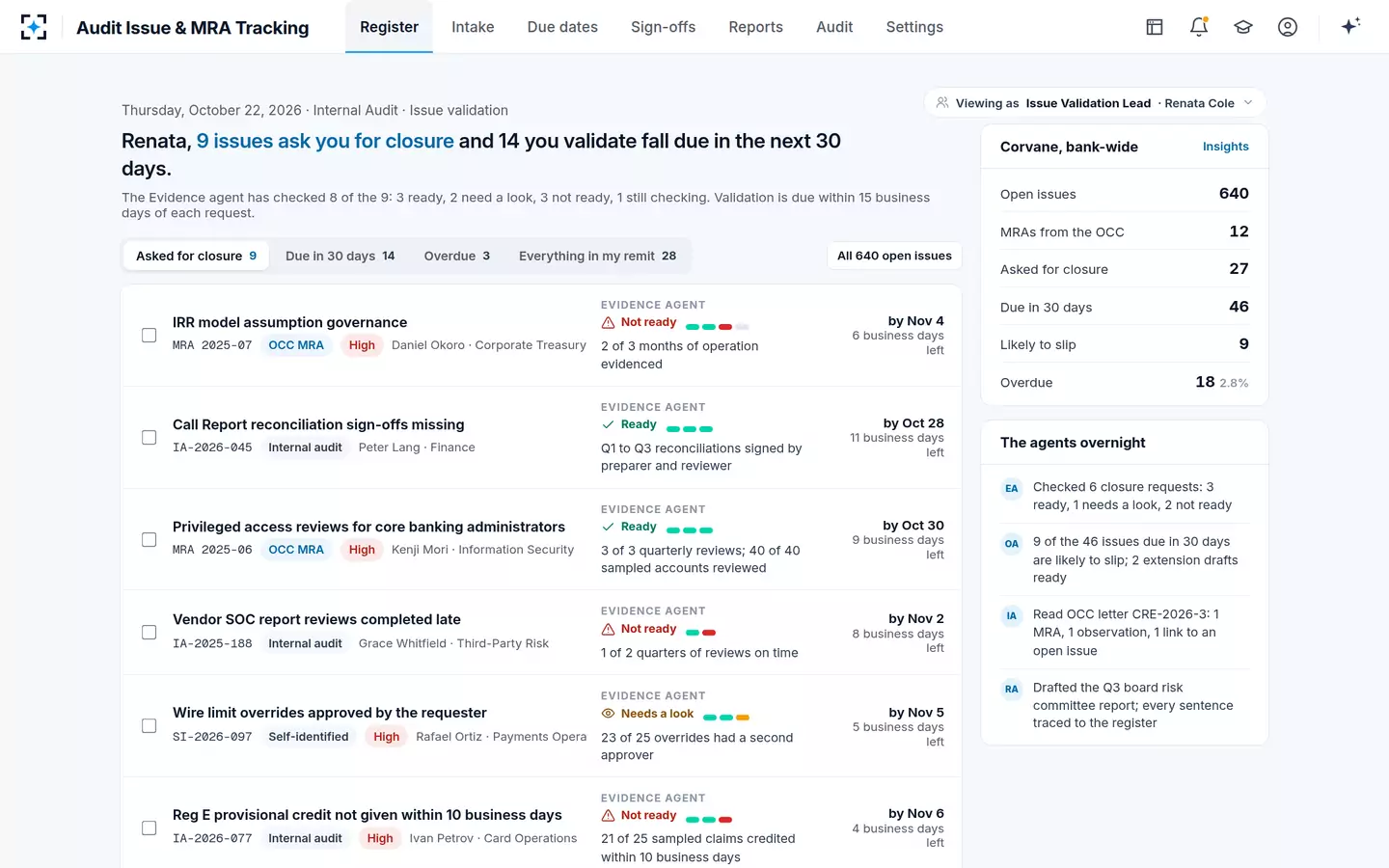

Her day in one sentence
Renata Cole · Issue Validation LeadThe register opens on one line, then a short list. Each closure request shows the Evidence agent's read and its deadline: MRA 2025-07 not ready, 2 of 3 months, validate by Nov 4 with 6 business days left; MRA 2025-06 ready, 40 of 40 sampled accounts. Overnight the agents checked 6 closure requests, flagged 9 likely slips, read OCC letter CRE-2026-3 and drafted the board report.
“Renata, 9 issues ask you for closure and 14 you validate fall due in the next 30 days.”
- 02One click

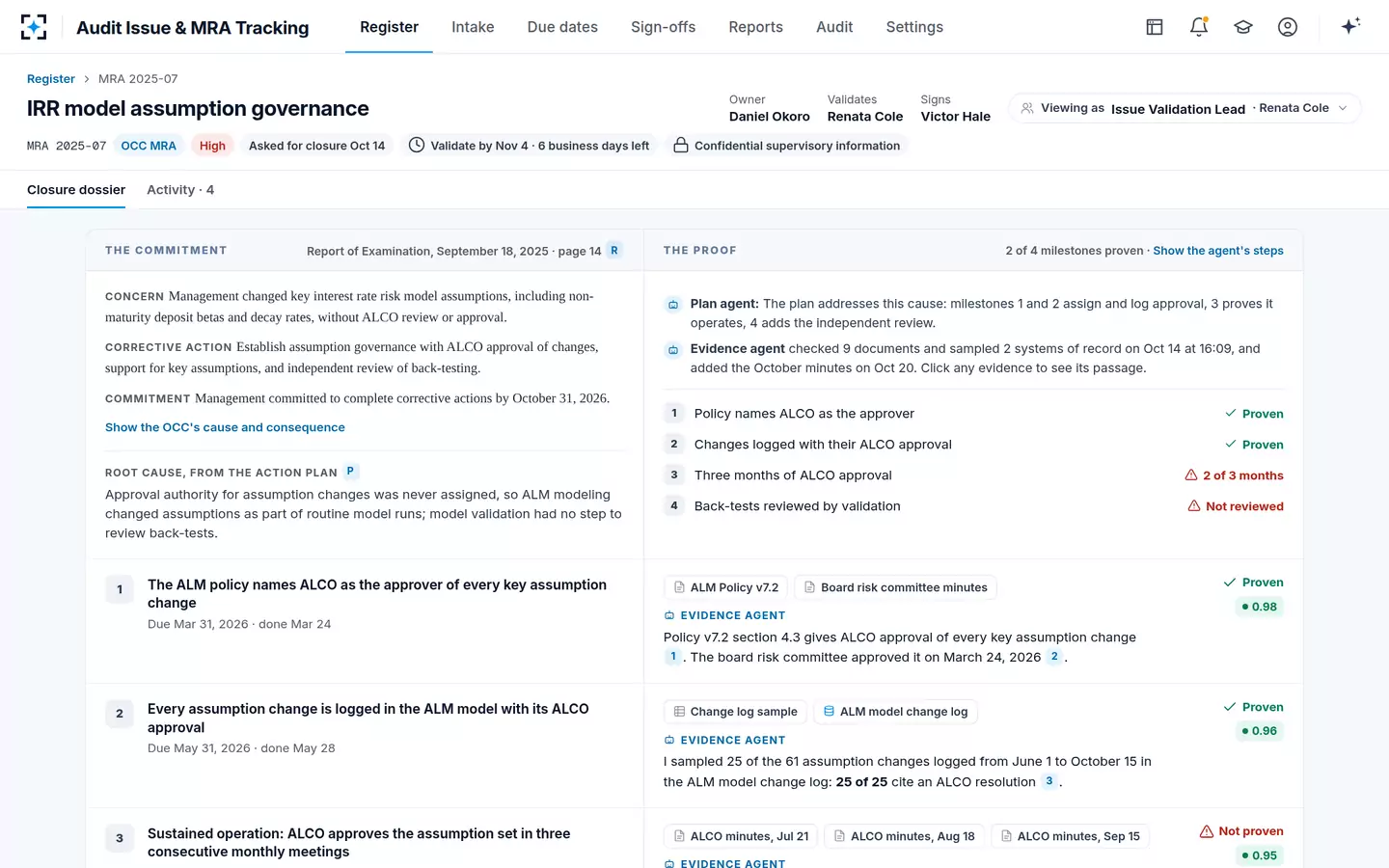

The closure dossier: the commitment beside the proof
Renata Cole · Issue Validation LeadMRA 2025-07 opens in two halves. On the left, the commitment: the OCC's Report of Examination of September 18, 2025, page 14, the root cause from action plan version 3 and four milestones. On the right, the proof for each milestone: 2 of 4 proven. Milestone 1, ALM Policy v7.2 naming ALCO as the approver, cites the board risk committee minutes of March 24, 2026, at confidence 0.98.
The examiner's words: “Management changed key interest rate risk model assumptions, including non-maturity deposit betas and decay rates, without ALCO review or approval.”
- 03Milestone 3

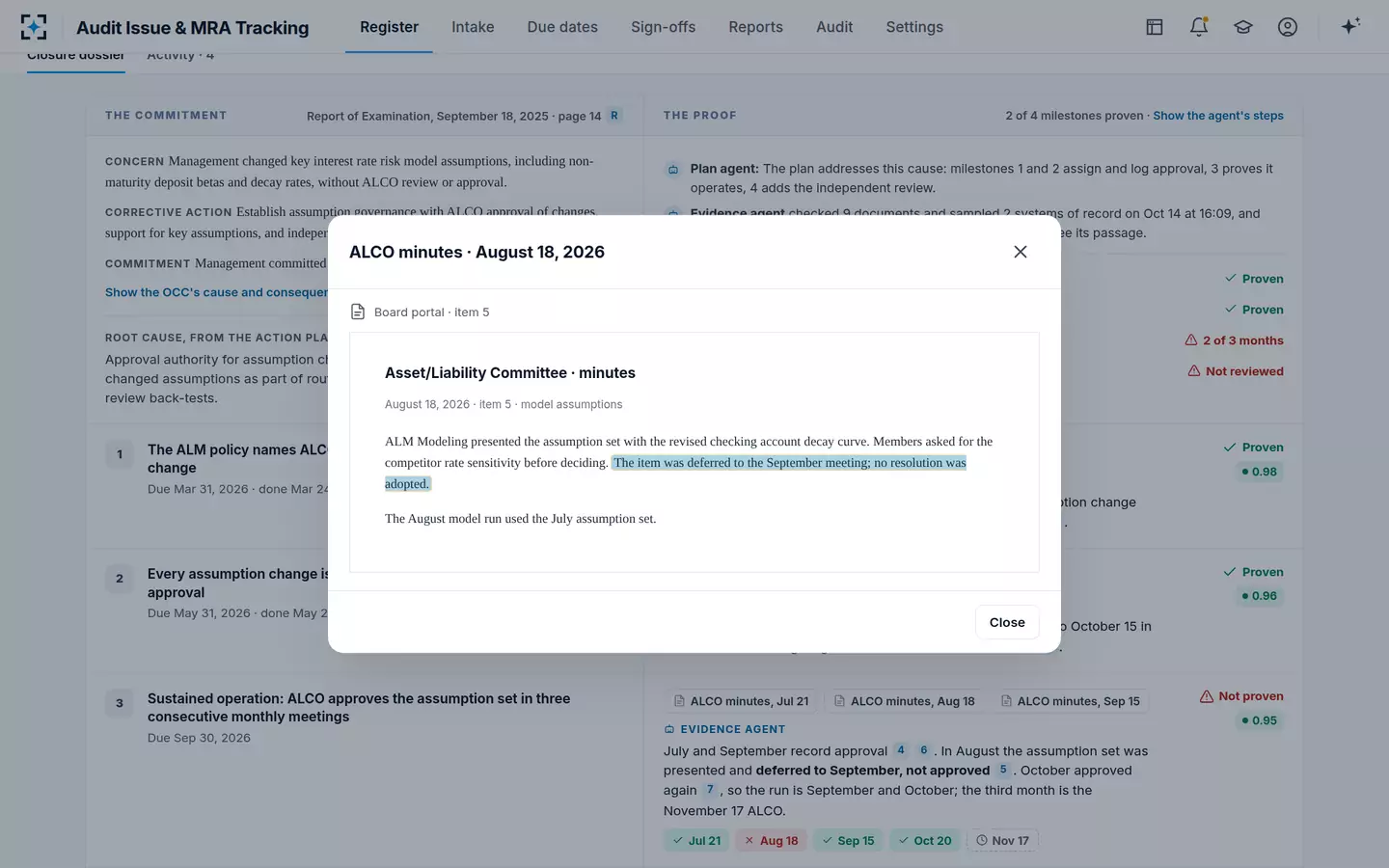

The August minutes show a deferral, not an approval
Evidence agentThe milestone asks for three consecutive months of ALCO approval. The month strip reads July approved, August not, September and October approved, November 17 pending. One click on August opens the ALCO minutes of August 18, 2026, board portal item 5, with the passage highlighted. So the run is September and October, and the third month is the November 17 ALCO.
“The item was deferred to the September meeting; no resolution was adopted.”
- 04Milestones 2 and 4
Sampled in the system of record, then one verdict line

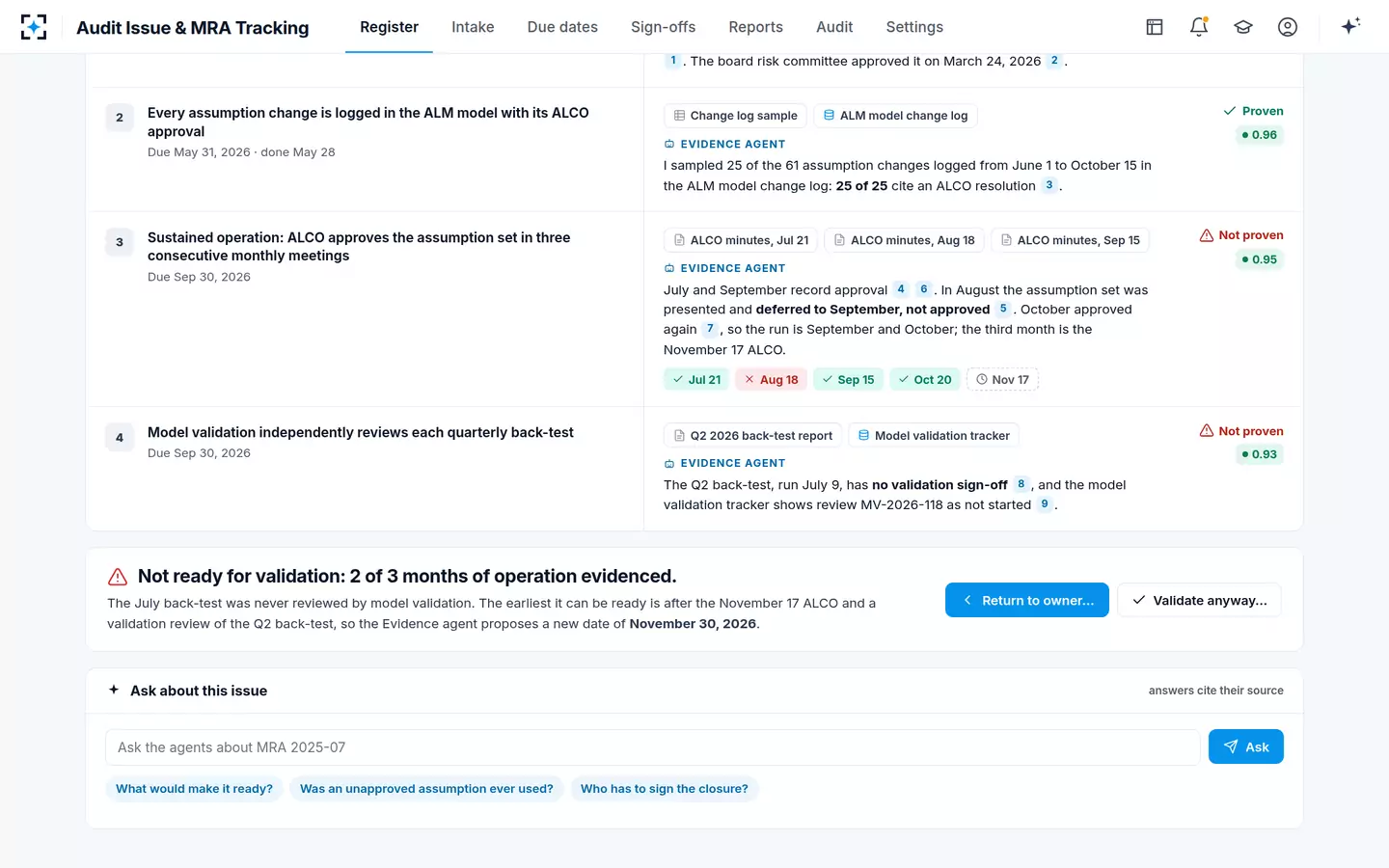

Evidence agentThe agent did not stop at the documents. It drew 25 of the 61 assumption changes logged from June 1 to October 15 in the ALM model change log, seed 7731, and all 25 cite an ALCO resolution (0.96). But the Q2 back-test, run July 9, has no validation sign-off, and review MV-2026-118 is not started (0.93). It proposes the earliest realistic date: November 30, 2026, after the November 17 ALCO and a validation review of the back-test.
“Not ready for validation: 2 of 3 months of operation evidenced.”
- 059:25

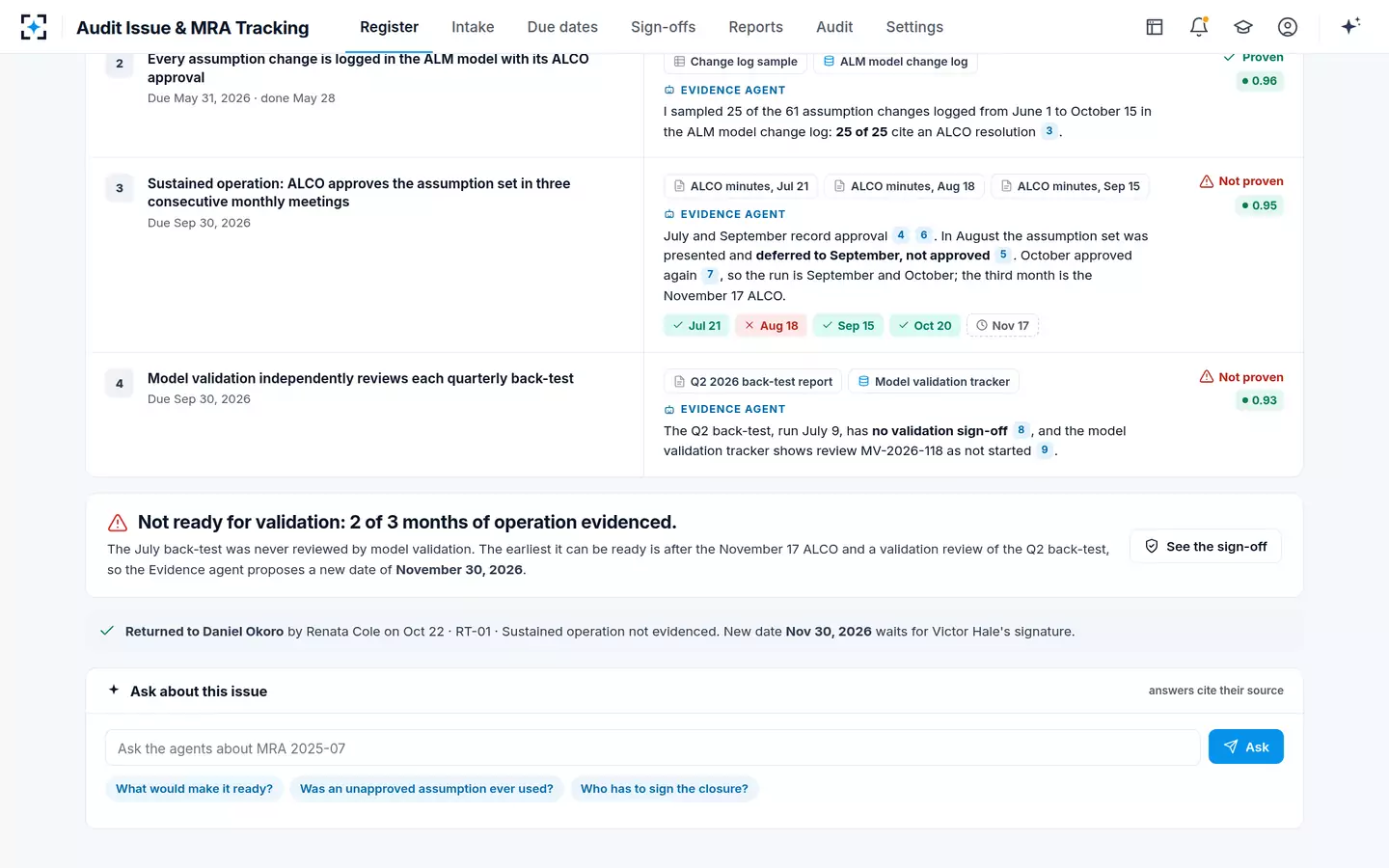

Returned with a reason code and a new date
Renata Cole · Issue Validation LeadRenata opens the August minutes herself and agrees. She returns the request to Daniel Okoro with reason code RT-01, sustained operation not evidenced, and a new date of November 30, 2026; the note to the owner is drafted for her and she can edit it. She is the maker of the date change, so it waits for a checker.
“Returned to Daniel Okoro by Renata Cole on Oct 22 · RT-01 · Sustained operation not evidenced. New date Nov 30, 2026 waits for Victor Hale's signature.”
- 0611:40
A different person signs the new date

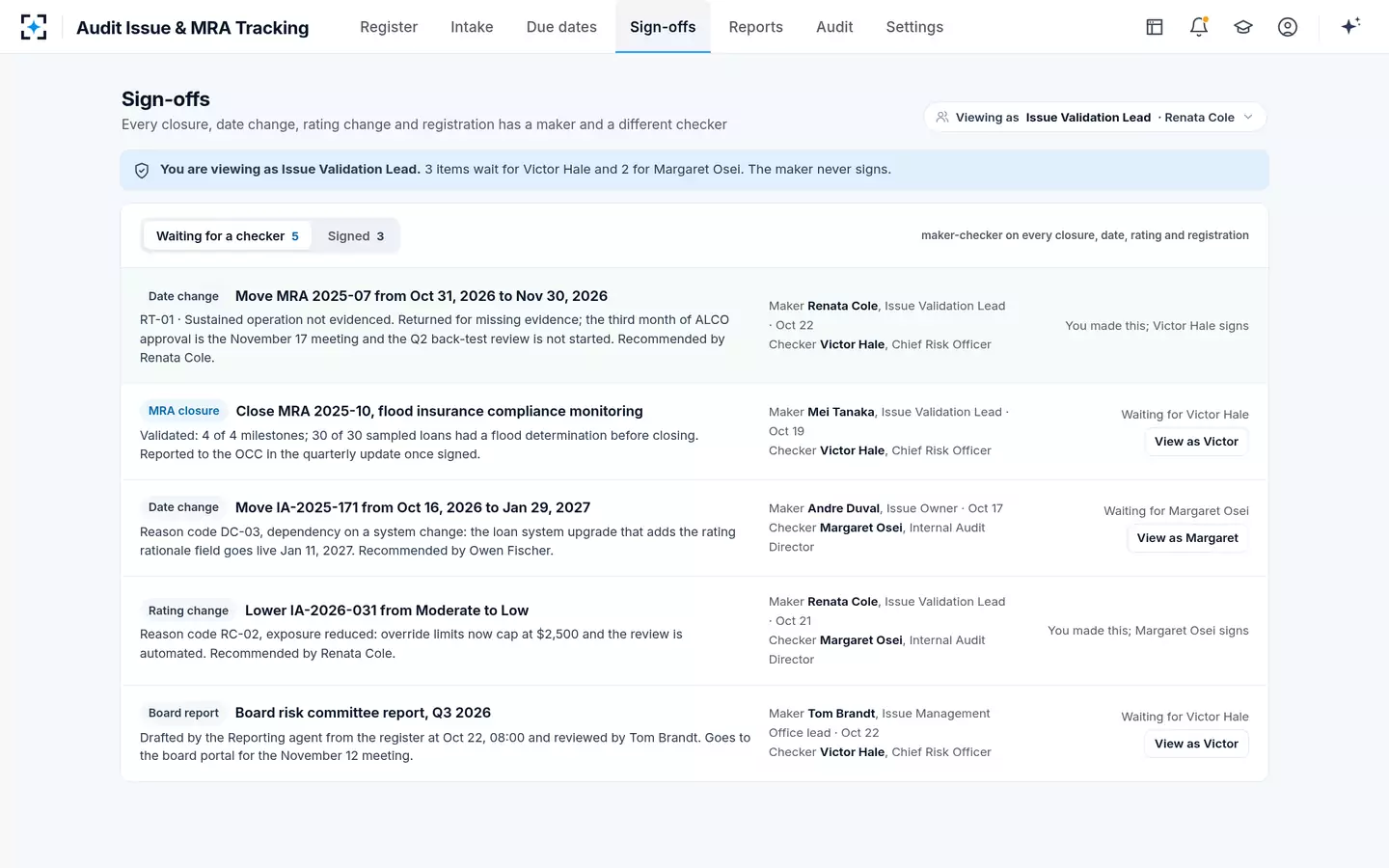

Victor Hale · Chief Risk OfficerSign-offs lists five items waiting for a second person, each with its maker and checker: the MRA 2025-07 date change, the closure of MRA 2025-10 on flood insurance compliance monitoring with 30 of 30 sampled loans, an audit date change and a rating change for the Internal Audit Director, and the Q3 board risk committee report. Renata sees no Sign button on her own request. Victor signs, and the signature records its meaning.
“You made this; Victor Hale signs.”
- 07After the signature

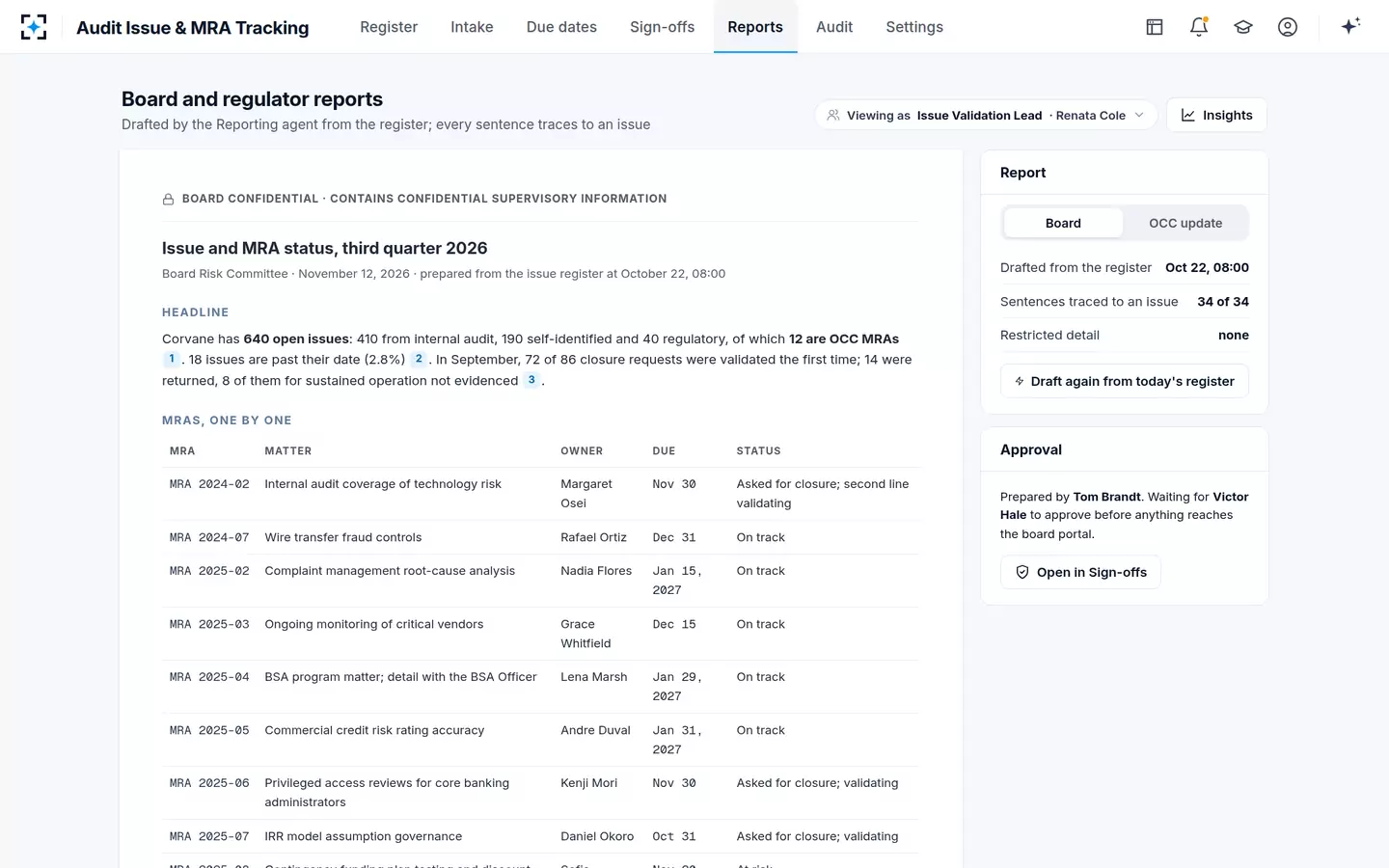

The board and the OCC hear it from the bank first
Reporting agentOnce Victor signs, the OCC quarterly update carries the revised commitment date with the reason, and the board risk committee report for November 12 says why. The Reporting agent drafts both from the register, every sentence traced to an issue (34 of 34 in the Q3 draft), with confidential supervisory information marked. Nothing leaves until the Chief Risk Officer approves.
Drafted Oct 22, 08:00 · 34 of 34 sentences traced · no restricted detail.
- 08On the record
Every step on the audit trail, and a pack for the examiners

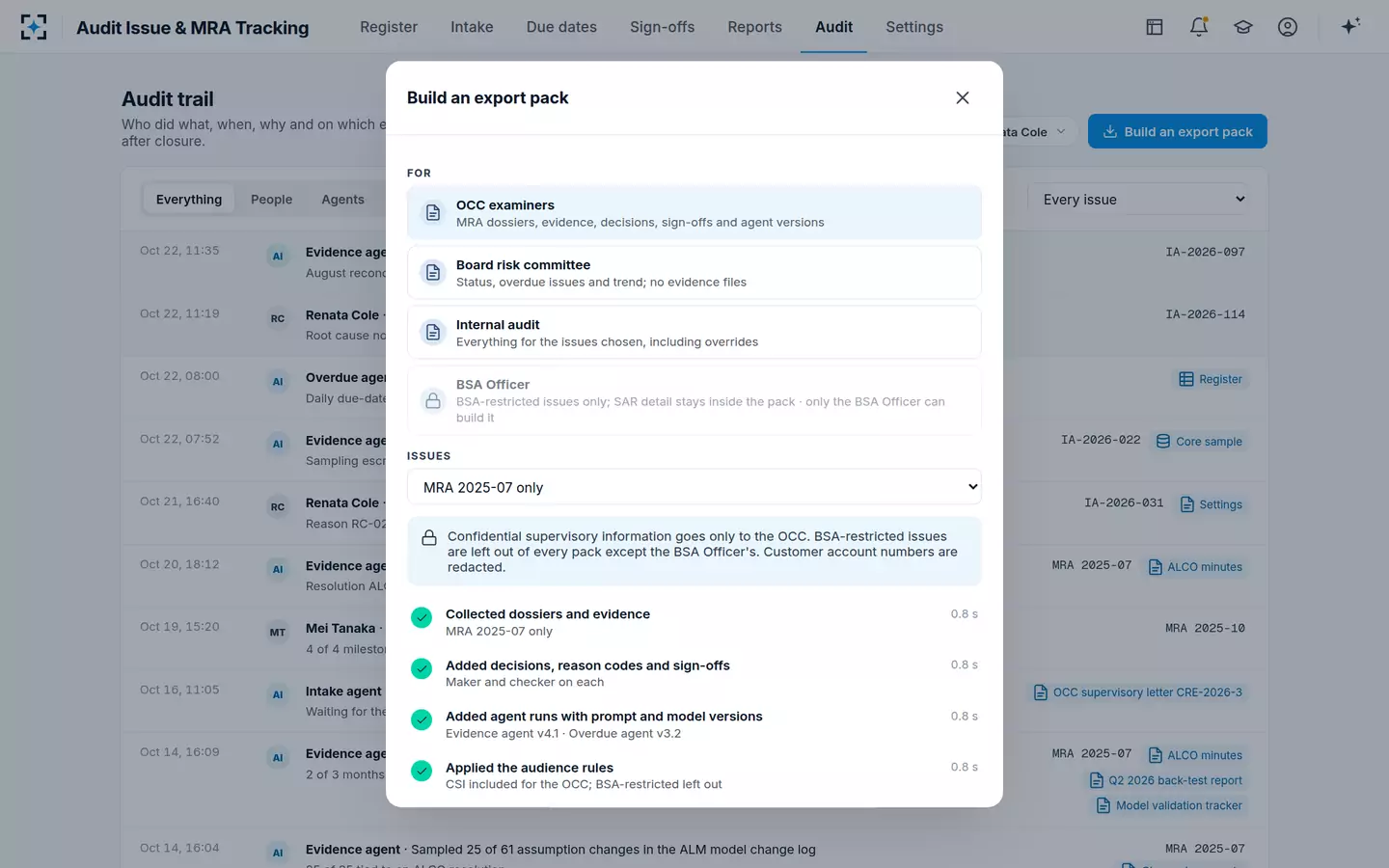

Export agentEvery action by people and agents is on the audit trail with who, what, when, why and the evidence. For the OCC examiners, the Export agent builds a pack for MRA 2025-07 alone: the dossier, 9 evidence files, decisions, sign-offs and the agents' runs with their prompt and model versions, under a SHA-256 manifest. Confidential supervisory information goes only to the OCC, and customer account numbers are redacted.
- 0914:00
A plan that only retrains staff

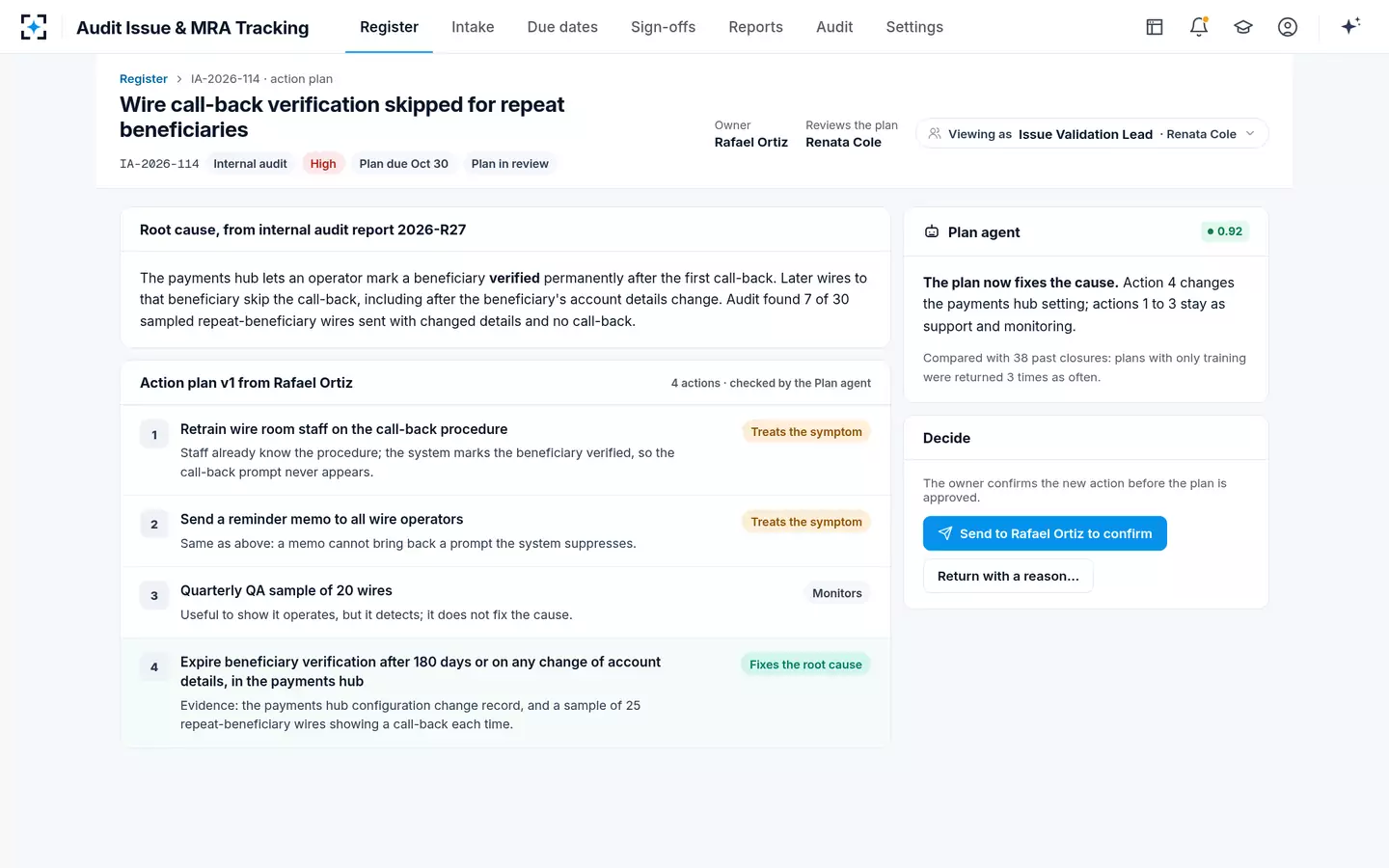

Plan agentOn IA-2026-114, wire call-back verification skipped for repeat beneficiaries, the root cause sits in the payments hub: it keeps a beneficiary verified permanently, and 7 of 30 sampled wires had changed details and no call-back. The agent labels two actions as treating the symptom and one as monitoring, and adds the milestone that fixes the cause: expire verification after 180 days or on any change of account details, proven by the configuration record and a sample of 25 wires.
Plan agent confidence 0.92 · next step: send to Rafael Ortiz, the owner, to confirm.
