Aircraft predictive maintenance on one night: an IDG changed before it fails
The airline flies 300 aircraft from its hub at Denver. Overnight, 268 of them flew and sent 1,240 warnings. One of them, a 777-300ER due to fly to London tomorrow, has a left IDG on the curve of two earlier failures. Here is how the maintenance controller works it with the agents (reads their briefing, asks them questions, checks their evidence and signs) screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:30, the morning briefing
Five things that need the controller, out of a thousand messages
Maintenance controllerThe controller leads the night shift at maintenance control in Denver. The screen opens with the planner agent's briefing: 1,240 warnings condensed to 7 proposed tasks and 24 patterns to watch, two tasks waiting on an engineer, and one feed late: the acquired airline's 22 aircraft were not read after 02:10. Each task carries its decision deadline, the 777's left IDG first, decide by 20:05.
“One matters most: the 777's left IDG is running on the curve of two earlier failures and flies to London tomorrow; it can be changed at Denver tonight.”
- 02The night, condensed
Each warning accounted for, stage by stage
Intake, triage and trend agentsThe overnight stream runs down the left; the agents condense it in the middle. The intake agent folded 612 repeats (same fault, same tail, same flight phase). The triage agent set aside 388 known harmless messages by rules R1–R14 and linked 142 to an open deferral or work order. The trend agent grouped the 98 signals left into 31 patterns: 7 proposed tasks, 24 on the watch list.
612 + 388 + 142 + 98 = 1,240. Nothing is dropped without a rule or a record.
- 03Open a stage
What was set aside, and the rule that set it aside

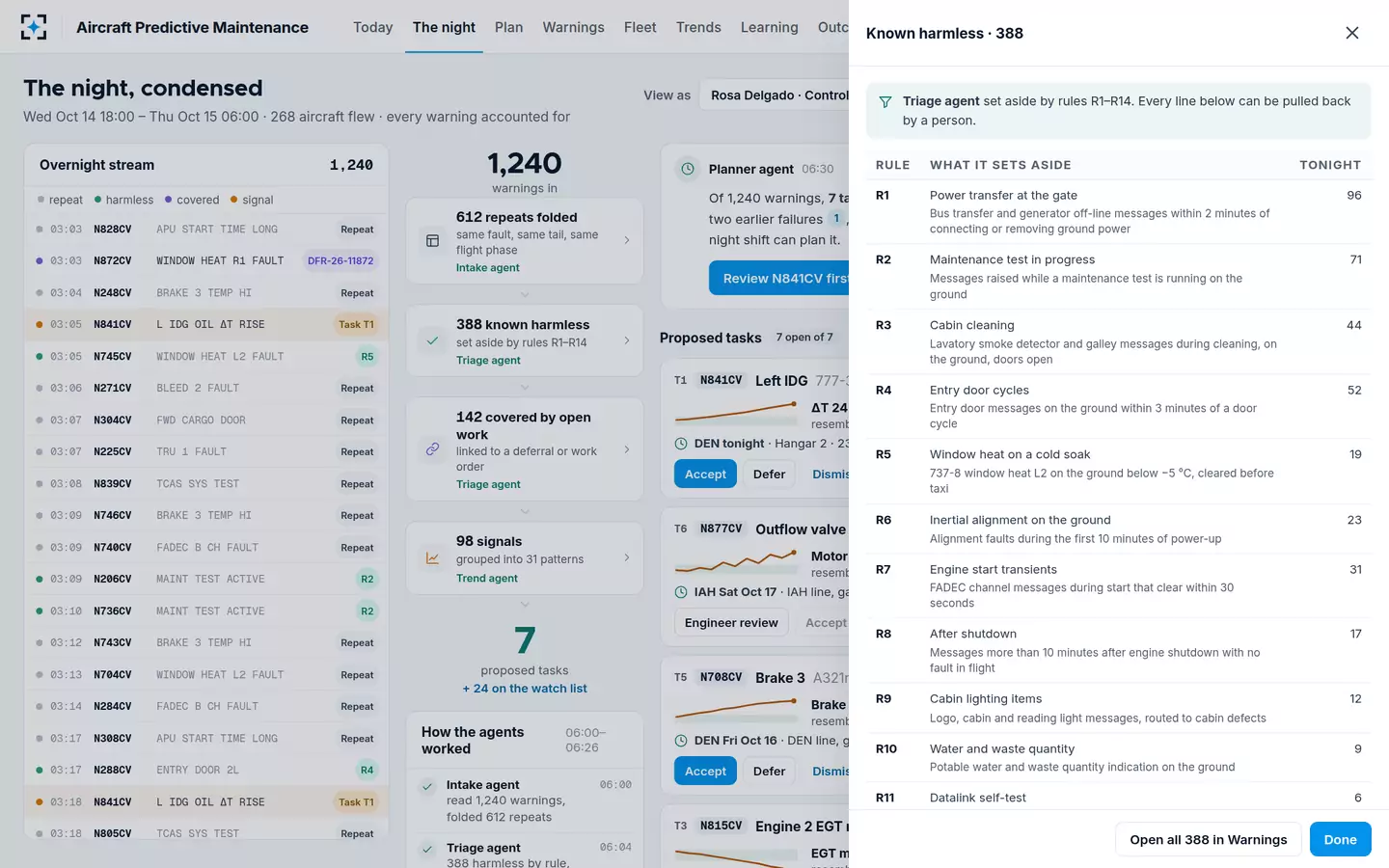

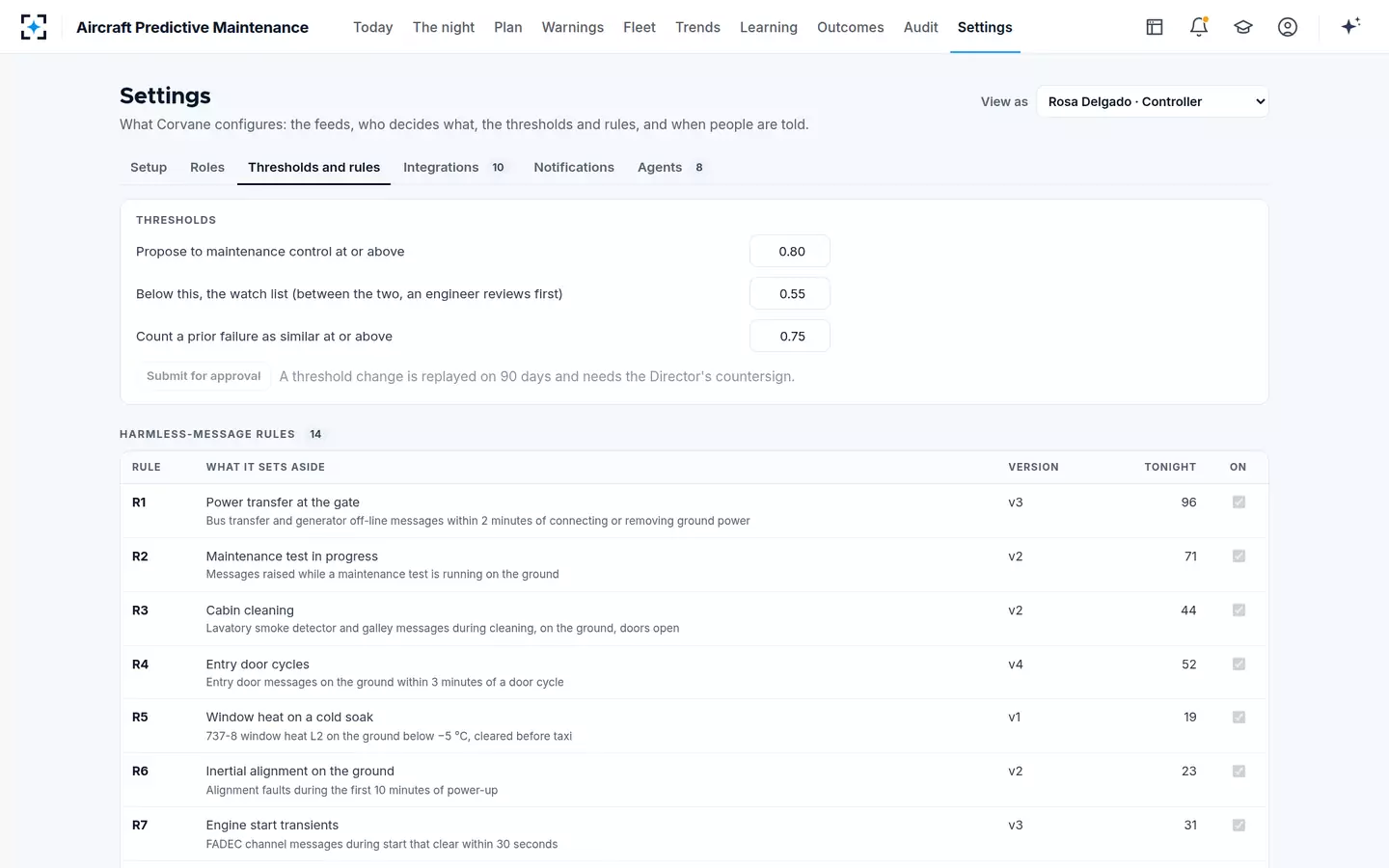

Triage agentThe controller opens “388 known harmless”. Each rule is listed with what it sets aside and how many it caught tonight: R1, power transfer at the gate, 96; R2, maintenance test in progress, 71; R4, entry door cycles, 52. Any line can be pulled back by a person and becomes a signal again: the nuisance alerts are filtered and stay in view.
“Every line below can be pulled back by a person.”
- 04The top task

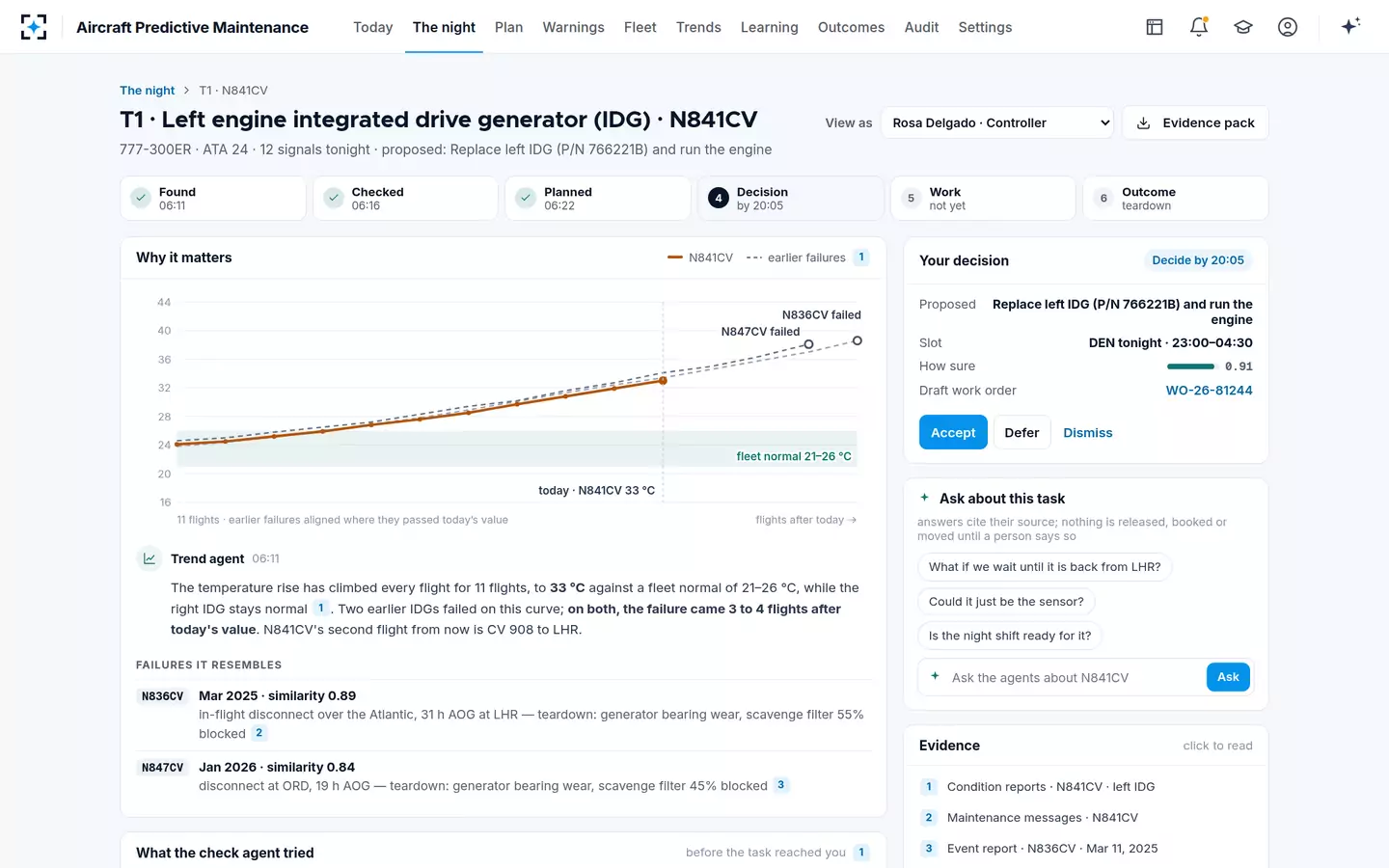

The trend, against the fleet and the earlier failures
Trend agentThe 777's left IDG oil outlet temperature rise has climbed on each of 11 flights, from 24 °C to 33 °C, against a fleet normal of 21–26 °C, while the right IDG stays normal. It matches one earlier failure (similarity 0.89) that disconnected over the Atlantic and sat 31 hours at London, and another (0.84) that sat 19 hours at Chicago. On both, the failure came 3 to 4 flights after today's value.
Both teardowns found generator bearing wear with a partly blocked scavenge filter.
- 05Before it reached the controller
Three harmless explanations, all rejected, and the slot

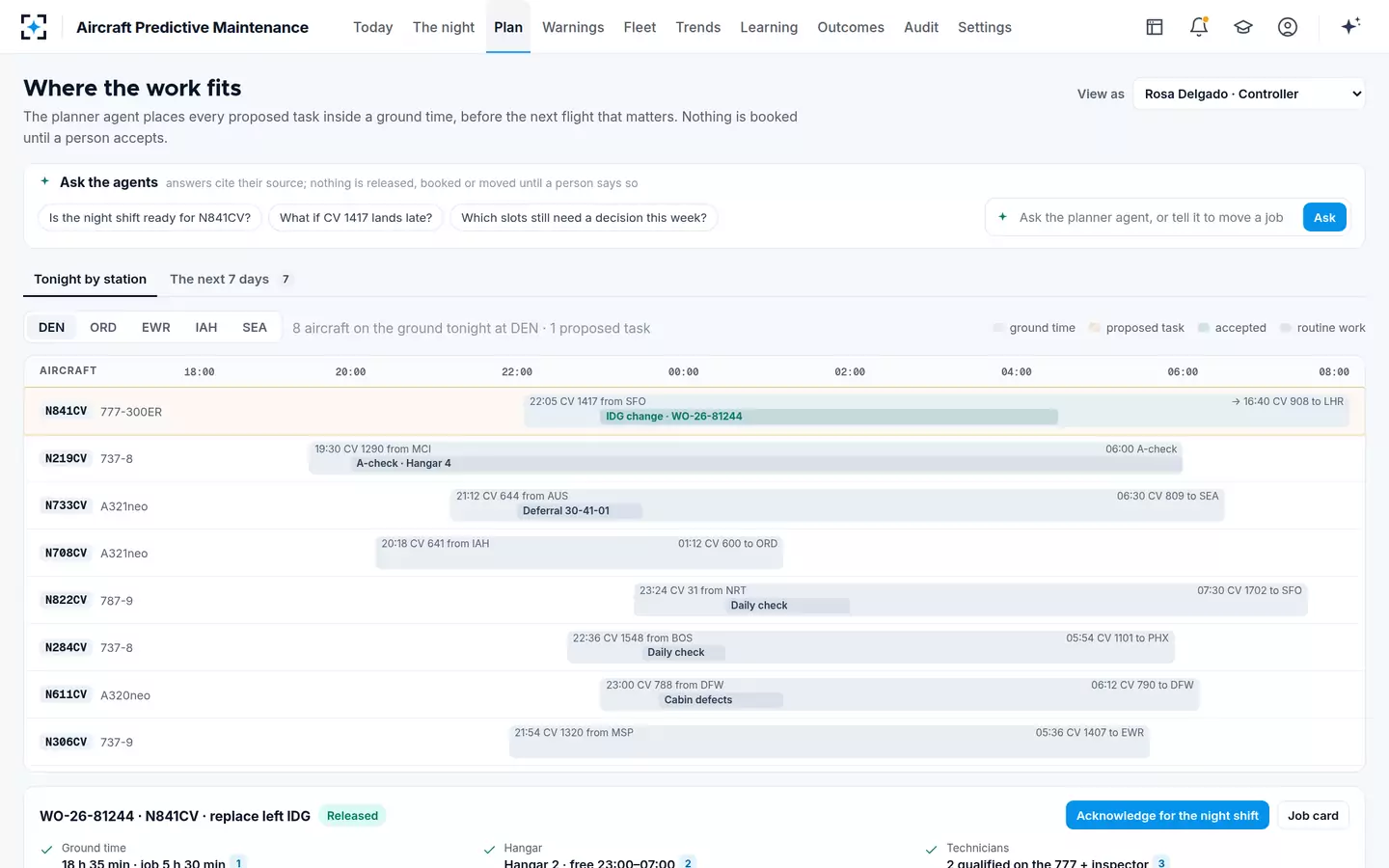

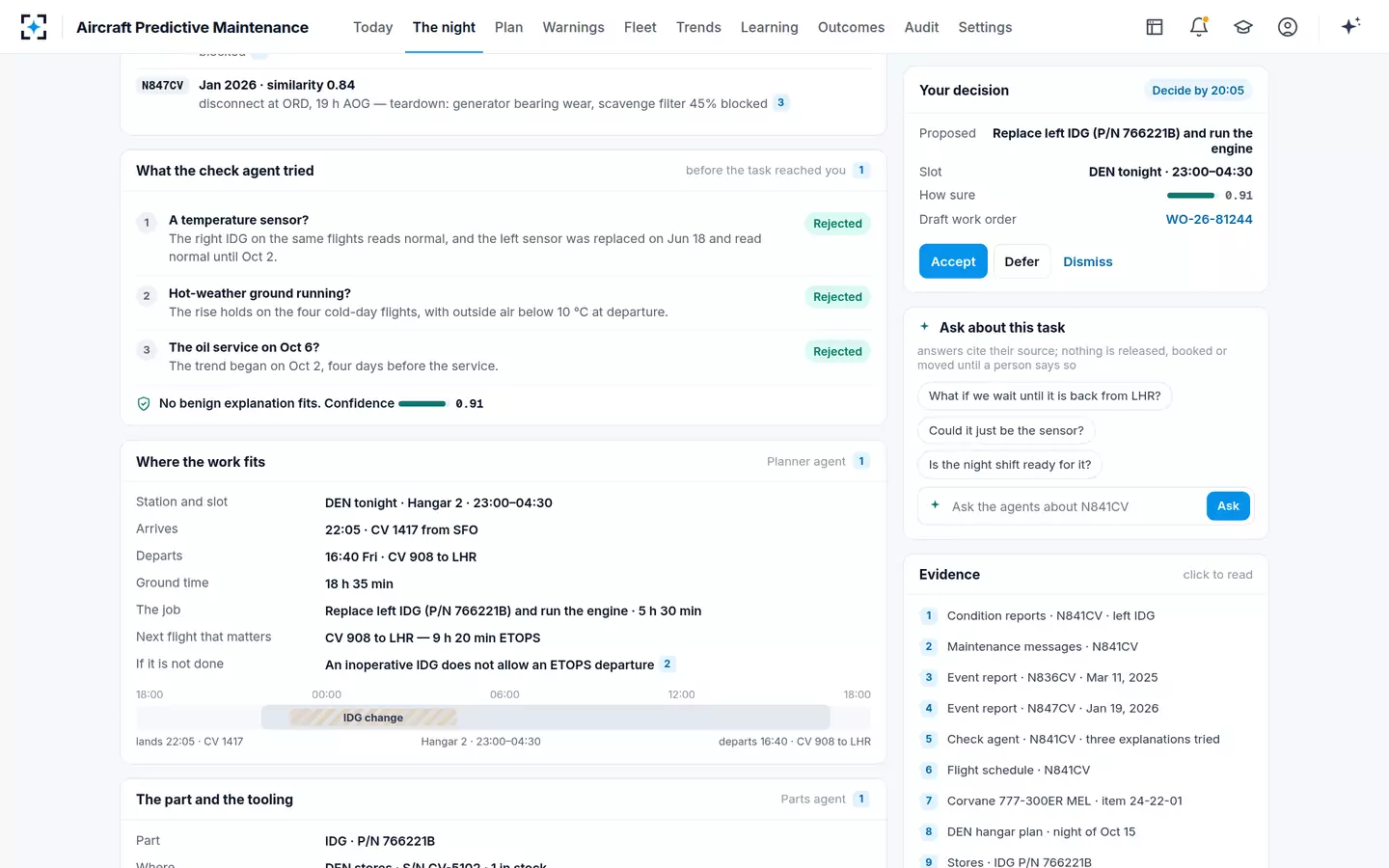

Check agent and planner agentThe check agent tried to explain the trend away: a temperature sensor (the right IDG reads normal on the same flights, and the left sensor was replaced earlier), hot-weather ground running (the rise holds on cold-day flights), and the recent oil service (the trend began before it). None fits, confidence 0.91. The planner agent found the slot: Denver tonight, Hangar 2, 23:00–04:30, in an 18 h 35 min ground time before the London flight, a 9 h 20 min ETOPS flight.
“If it is not done: an inoperative IDG does not allow an ETOPS departure.”
- 06The controller asks
“What if we wait until it is back from London?”
Maintenance controller and the planner agentThe controller asks in plain words. The planner agent answers with its sources: the London flight is the second flight from now, and the earlier failures came 3 to 4 flights after today's value. If the IDG fails at London the return may not dispatch, London holds no spare, and the earlier failure there cost 31 hours on the ground.
“I would not wait.”
- 0706:41, signed
Accepted with a reason code and an e-signature
Maintenance controllerThe controller chooses A1 · Trend confirmed, work fits the plan, and signs. Accepting releases the planner agent's draft work order to the Denver line and tells the line maintenance manager. Until that moment nothing was booked, released or moved.
“I accept this task as the maintenance controller, by e-signature.”
- 08Tonight at Denver
The job arrives planned, with the part and the people
Line maintenance managerOn the station plan the 777 lands at 22:05 from San Francisco, and the IDG change sits inside its ground time beside the night's A-check and daily checks. The work order carries the ground time, Hangar 2 free 23:00–07:00, two technicians qualified on the 777 plus an inspector, a spare IDG in Denver stores and the IDG sling in the tool crib. The parts agent proposes moving one IDG from Chicago to Denver to restore the hub's stock.
The parts agent reserved nothing: it does not order or move a part.
- 09Learning
Dismissals become a rule, proven on 90 days first

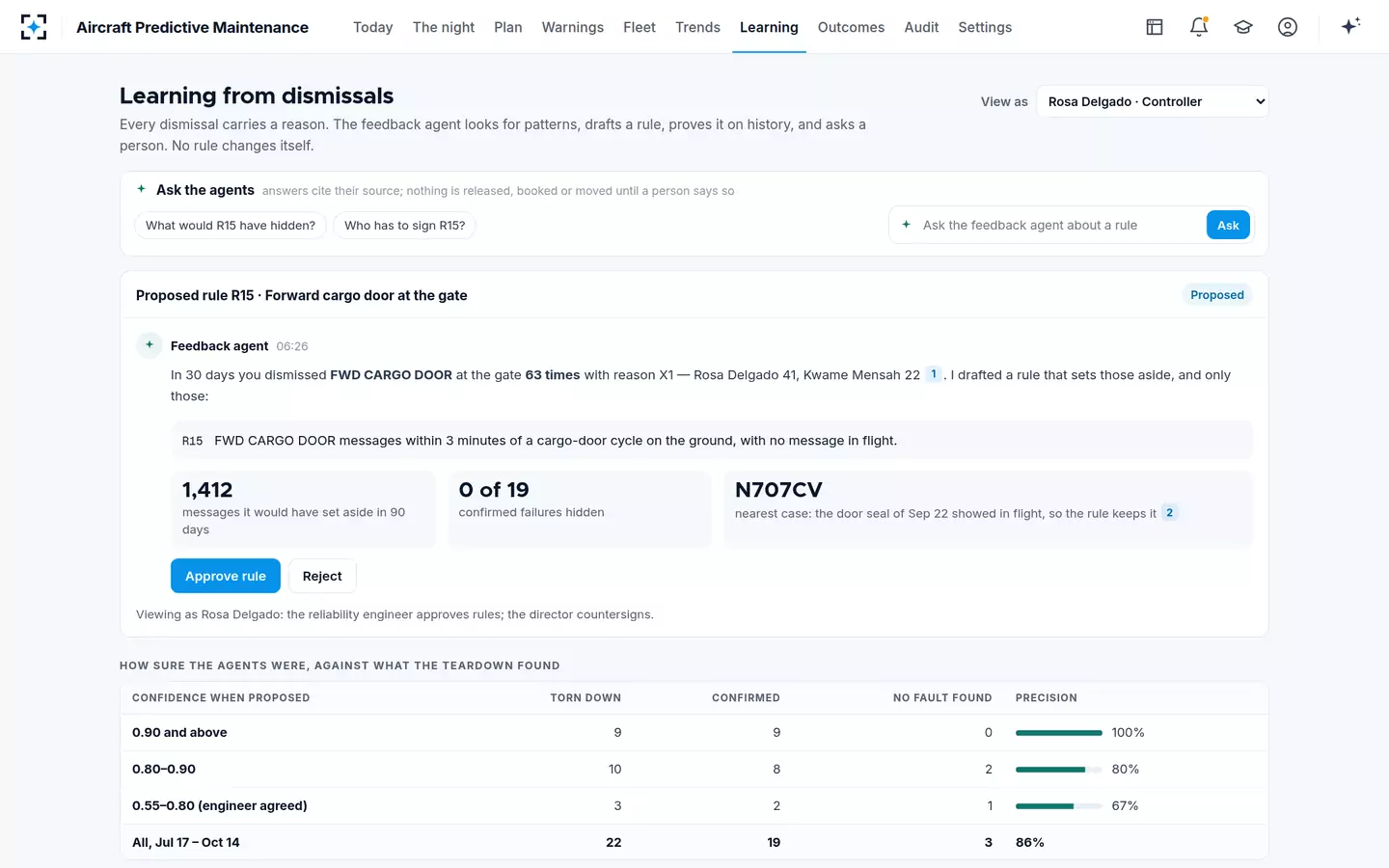

Feedback agent and the reliability engineerIn 30 days maintenance control and the reliability engineer dismissed FWD CARGO DOOR at the gate 63 times as a known harmless message. The feedback agent drafted rule R15 (door messages within 3 minutes of a cargo-door cycle on the ground, with no message in flight) and replayed it: 1,412 messages it would have set aside in 90 days, and 0 of 19 confirmed failures hidden. The reliability engineer approves; the Director countersigns.
“No rule changes itself.”
- 10Days later, the teardown
The prediction confirmed, and the AOG avoided on record
Outcome agentThe shop's teardown of the removed IDG finds generator bearing wear and a 60% blocked scavenge filter. The outcome agent records the prediction as confirmed and writes the avoided AOG record: 31 hours on the ground at London and a canceled return avoided, an estimated $412,000, with its working from the airline's own earlier event.
No avoided AOG is claimed without a finding; dollars are always marked estimated.
