- Before
- Owns the shelves at the hub and the line stations it supplies, and finds out a part is short when maintenance control calls.
- Now
- Starts with what will run short, sees the proposal and its reasons beside the station on the map, asks the agents about any shelf and approves with a reason.
Aircraft spare parts demand forecasting for one hub's 787-9 brakes
A weekday morning at the airline's main hub. Brake wear alerts are rising on the 787-9s the airline bases there. Here is how the agents and the materials planner close the gap, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Start of the shift
The next decision, first
Materials plannerThe agents re-planned each station at 08:12. The planner's Today screen opens on one card: brake assemblies at the hub will run 3 short. Below it, 14 shortfalls ahead at 8 stations, 9 proposals waiting for the planner worth $1.24M, and $38.6M of idle stock with a proposal. A feed shows what each agent found since 06:00.
“The agents propose to borrow 3 from the pool and order 2 at $96,000 each: $203,700. Decide by 16:00 to catch the pool's 48-hour delivery.”

- 02On the stock map
Each station's shelf against its 30-day need
Materials plannerThe stock map shows the brake assembly, a no-go part, at each of the airline's stations: the hub has 4 on the shelf against 9 needed, and four other stations hold 5 / 4, 3 / 2, 2 / 1 and 2 / 2. The component pool has 6 free, and a dashed arc marks the proposed borrow of 3, due before the hub's first short day. Beside the map is the conversation with the agents about the hub.
“Label: on the shelf / needed in 30 days · click a station to talk to the agents about it”
- 03The morning re-plan
The aircraft are saying it, with the source
Fleet Health ReaderEleven brake positions on six hub-based 787-9s fell below 20% wear remaining in 9 days, against 4 in a normal 9 days. The first, brake 3 on one aircraft, is at 17% and reaches its 10% removal limit about the day the hub first runs short. Each number opens its source: here, the brake wear report from aircraft health monitoring.
Confidence 0.93 · 11 alerts read
- 04A minute later
9 needed at the 98% level, likely 7, where history alone said 4
Demand ForecasterThe part forecast shows 90 days of weekly demand at the hub with its range and the first short day. What moved it, each driver cited: the wear alerts add 3, removals history says 4, flying is up 4% with an added long-haul frequency from November, and four more 787-9s join the hub from January, so its stock level rises from 6 to 8. Brakes have no MEL relief, so the plan-to level is 98%.
Confidence 0.91 · range 6 to 10, with 7 the likely number

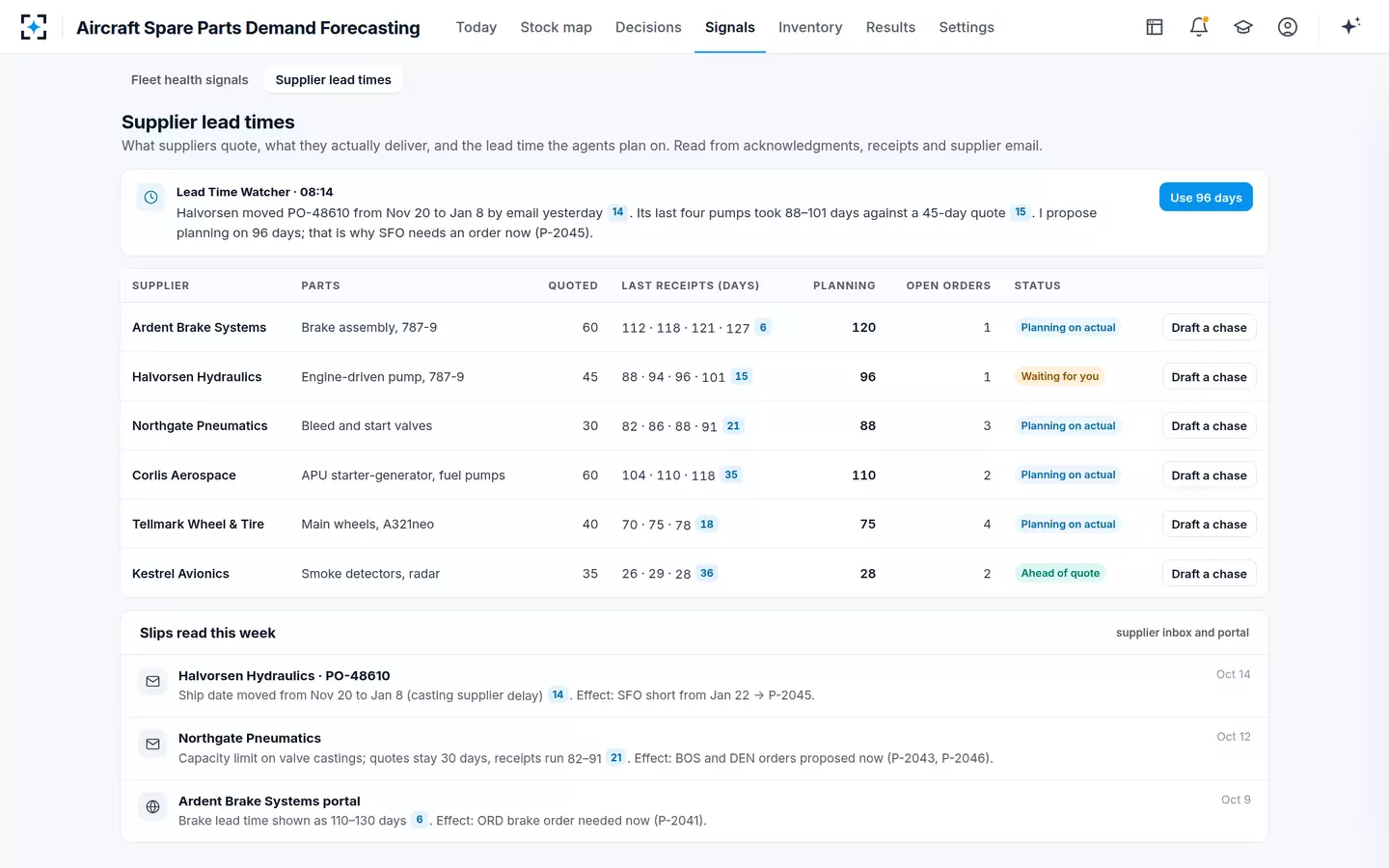

- 05Supplier lead times
The supplier quotes 60 days; its brakes take 120
Lead Time WatcherThe brake supplier quotes 60 days, but its last four brake orders took 112, 118, 121 and 127 days, so the agents plan on 120: an order placed today arrives in February. On Supplier lead times, the watcher also read a hydraulics supplier's email moving an open pump order from November to January, and proposes 96 days for its pumps, waiting for the planner to accept.
“Rule: plan on the 80th percentile when actual exceeds the quote by 25%”
- 06Options side by side
Four ways to close the gap, compared
Sourcing Planner and Proposal CheckerEven with 2 due back from repair, the hub runs 3 short. The Sourcing Planner compares a pool borrow of 3 plus an order of 2 ($203,700, covered first), a transfer from a second hub ($200,450, with a 19% short risk there), waiting for the repairs ($192,000, a 61% chance of a grounding) and an AOG spot buy (about $1.38M). The Proposal Checker re-derives the forecast from raw removals and alerts, and confirms that each pool brake ships with an FAA 8130-3 under clause 4.2 of the pool agreement and that $203,700 is inside the planner's $250,000 limit.
Confidence 0.91 · Proposal Checker: “Agrees · independent check”
- 07The planner's instruction
The planner asks to use the second hub's spare first
Materials plannerThe planner tells the agents what to try. The Sourcing Planner re-plans: move 1 from the second hub by road, arriving the next day for $650, borrow 2 and order 2, for $200,450 in all, $3,250 less. The Proposal Checker answers in the same thread: The second hub would then hold 2 for its own 2 expected changes, with nothing spare until early November, and its chance of a short day rises from 2% to 19%.
Proposal Checker: “I would keep the pool borrow.” · Switch to this plan · Keep the original
- 08Approved
The original plan, approved with a reason

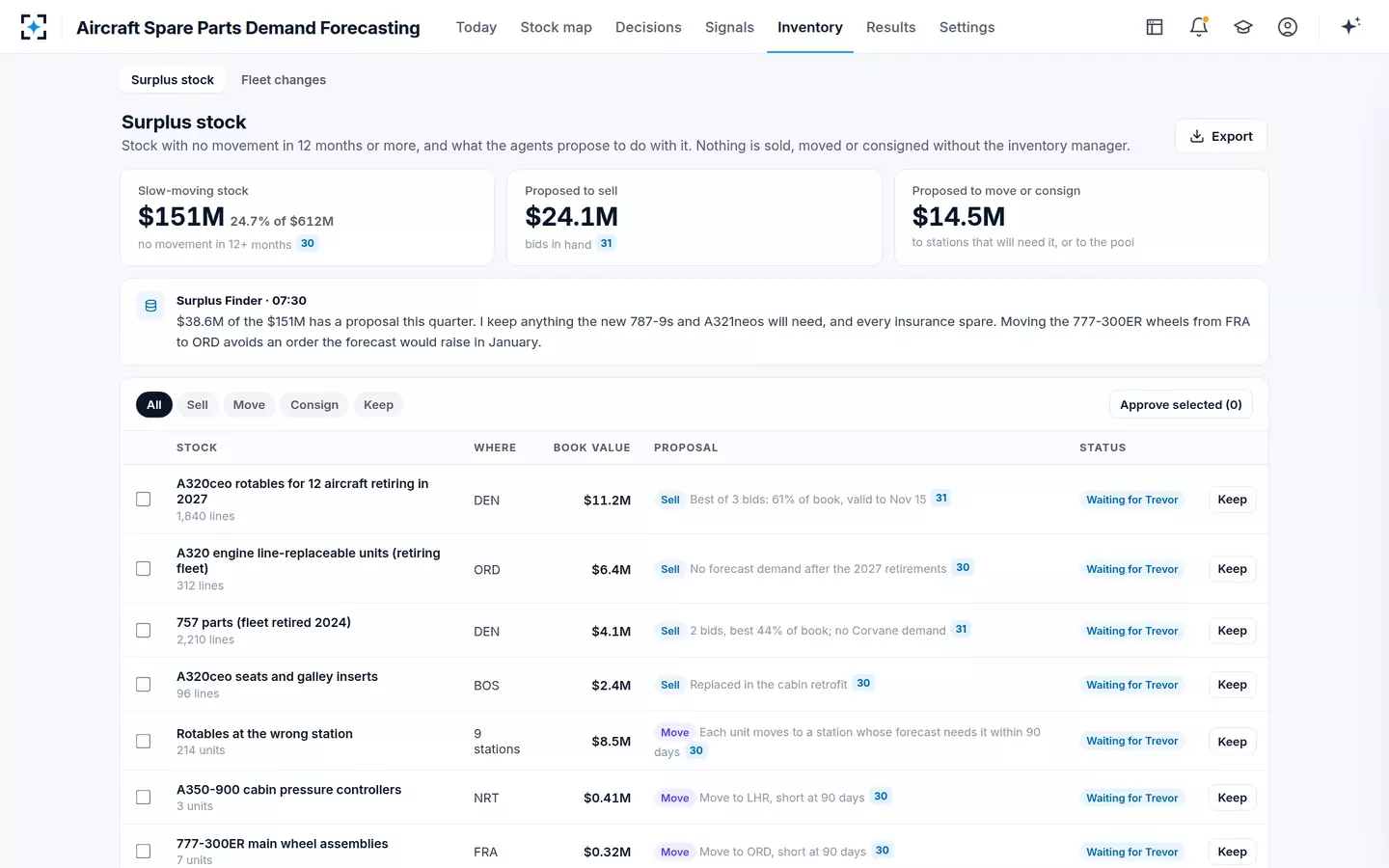

Materials plannerThe planner keeps the original and approves it with the reason “Forecast agreed”. Only then does the Sourcing Planner send the loan request to the component pool, which acknowledges it, and put the purchase order into purchasing for release. The hub turns from short to covered on the map, and each step is on the audit trail.
“Hub covered · logged”
- 09The rest of the morning
Nine proposals, each with a clock

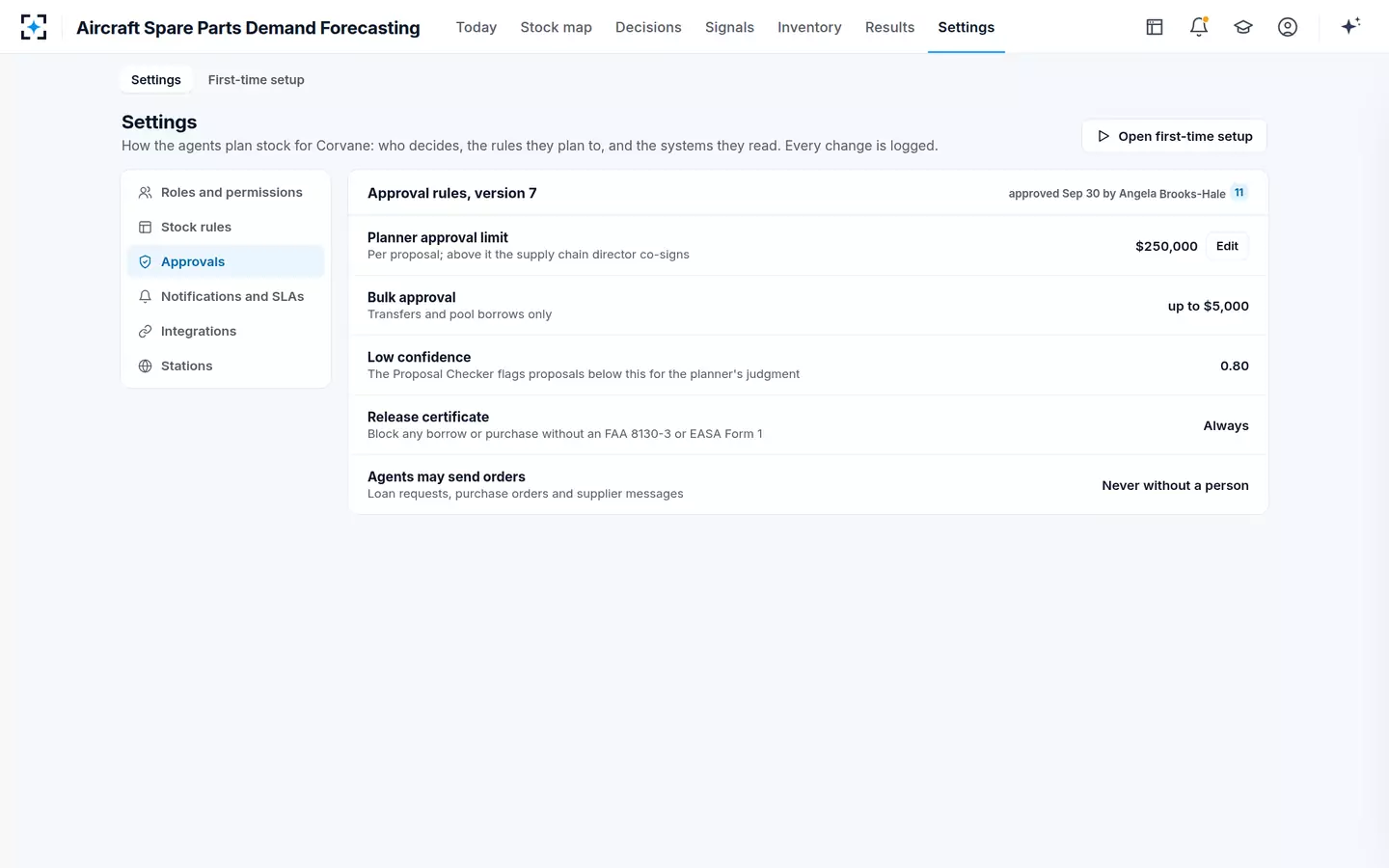

Proposal CheckerDecisions lists each borrow, transfer and order the agents propose, sorted by when it must be decided. The Proposal Checker re-derived all nine from raw data: one, bleed air valves for the acquired airline's A220s at its former base, is below 0.80 confidence, and another, $284,000 of engine-driven pumps for another station, is over the limit, so the supply chain director co-signs. Three are under $5,000 and can be approved together.
“Every borrow, transfer and order the agents propose. Nothing is sent until a person approves it.”

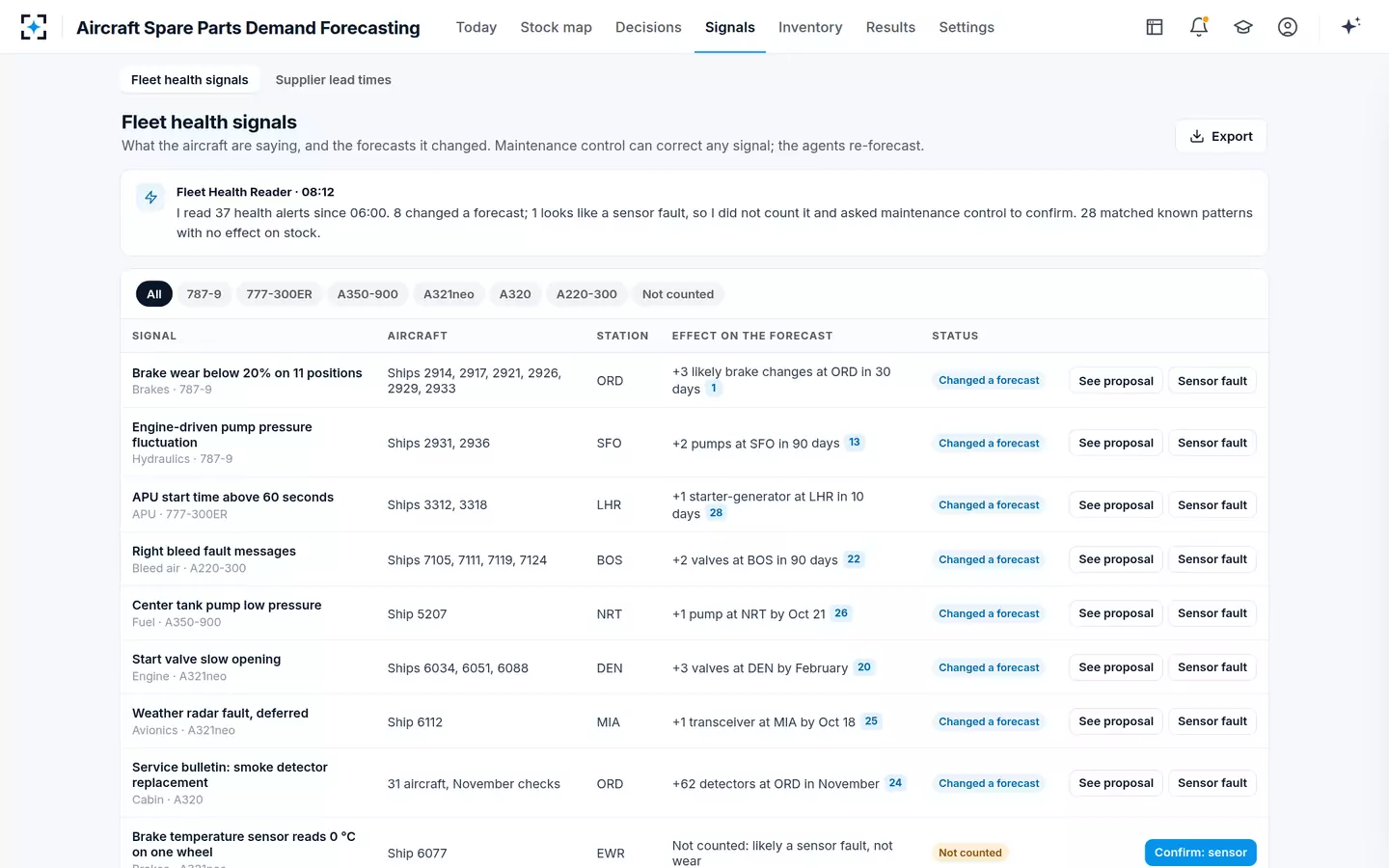

- 10In maintenance control
A false alert does not buy a part
Maintenance control managerFleet health signals lists the 37 alerts read since 06:00 and the forecast each changed. Eight changed a forecast. One, a brake temperature sensor reading 0 °C on one wheel of an aircraft at a line station, looks like a sensor fault, so the Fleet Health Reader did not count it and asked maintenance control to confirm. Maintenance control can correct any signal, and the agents re-forecast.
“Not counted: likely a sensor fault, not wear”
