- Before
- Runs a validation plan that needs 34,600 hours with a team that has 22,400, and hears about drift at the next annual validation.
- Now
- Sees each model’s control chart every month, decides the 14 borderline entries, and signs validations drafted from the evidence.
A drifting commercial real estate model, the SR 26-2 re-scope and a signed validation
A sample bank with $41.3 billion in assets, 412 inventory entries and the Model Risk Committee in eight days. Here is one Monday, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0108:52

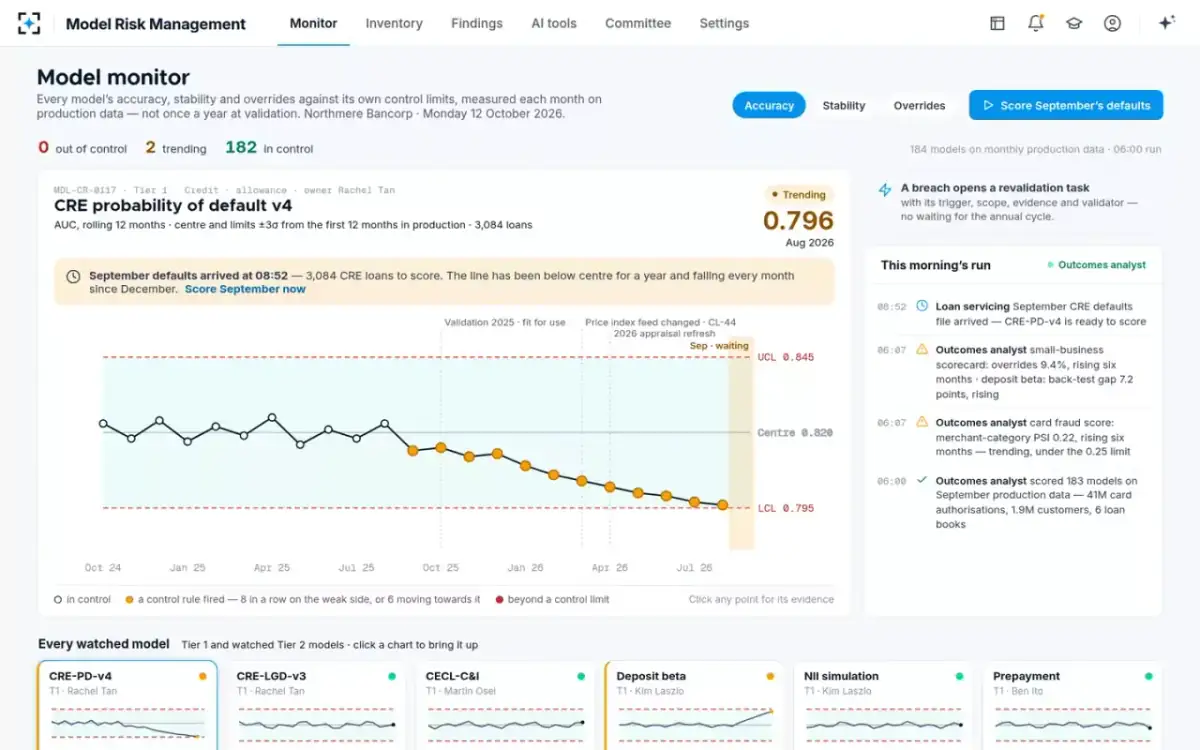

Each model on its own control chart

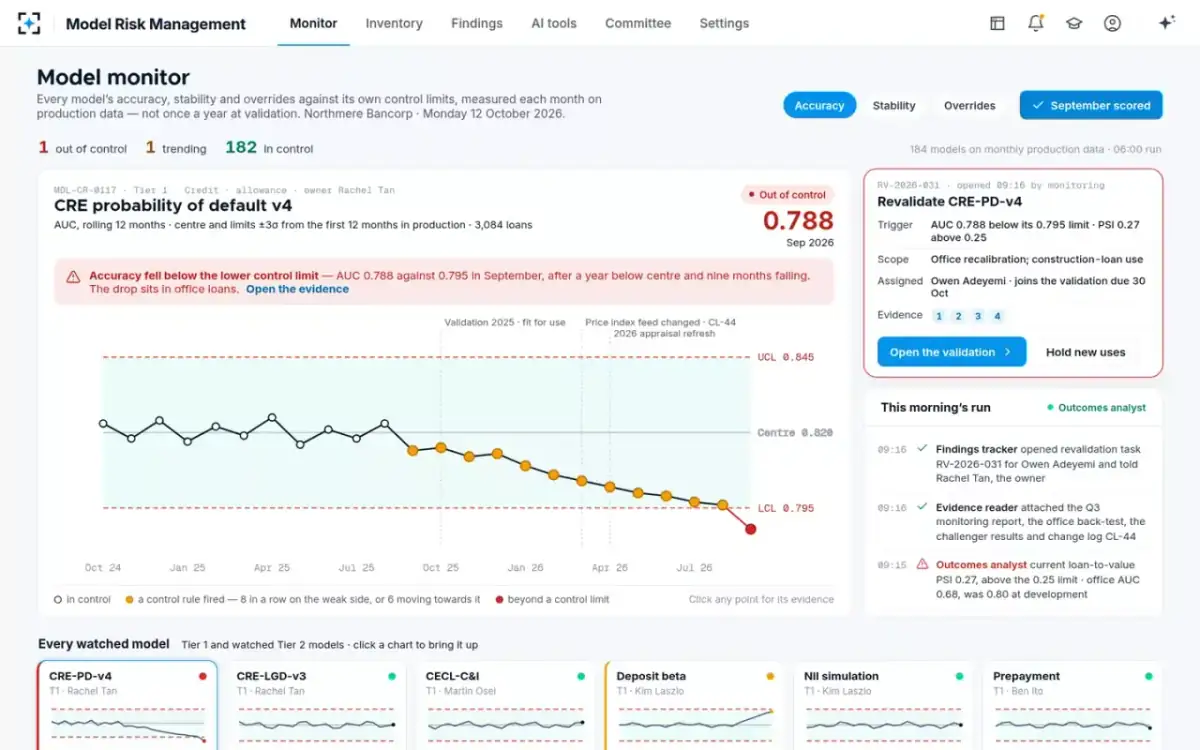

Head of model risk managementAfter the 06:00 run, the monitor shows 184 models scored on monthly production data. None is out of control, 2 are trending and 182 are in control. The commercial real estate (CRE) default model is trending. Its AUC, a score of how well it ranks loans by risk, is 0.796 over 12 months. The center line is 0.820 and the lower control limit is 0.795. Then the month’s CRE defaults file arrives.
“3,084 CRE loans to score. The line has been below center for a year and falling each month since December.”
- 0209:15
Out of control, and a revalidation task opens
Outcomes analystThe new point lands at 0.788, below the lower control limit. The PSI for current loan-to-value, a measure of how far the loan mix has moved, reaches 0.27 against a 0.25 limit. A revalidation task opens on its own. It carries the trigger and the scope: office recalibration and construction-loan use. It also names the lead validator, links the annual validation due later this month and attaches four pieces of evidence.
“AUC 0.788 against a 0.795 limit, after a year below center and nine months falling.”
- 03One click

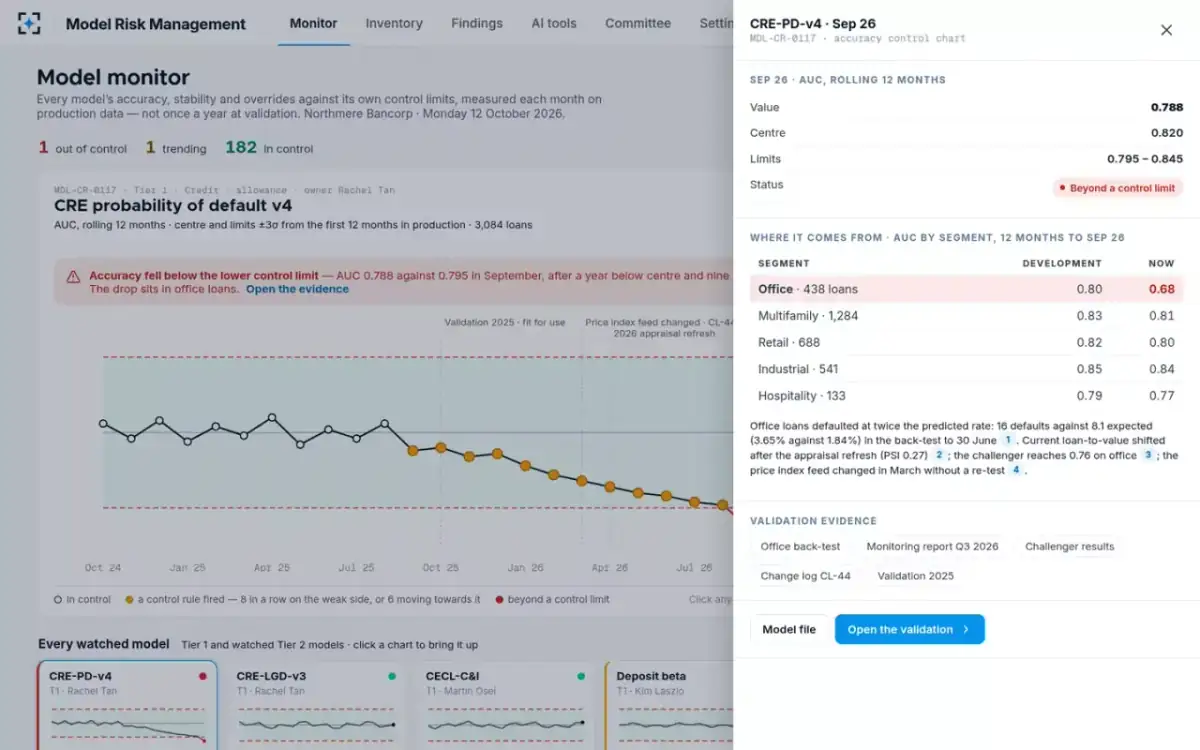

The drift point opens its evidence
Head of model risk managementThe month’s point shows where the drop comes from. Office loans have fallen to an AUC of 0.68, down from 0.80 at development. Multifamily, retail, industrial and hospitality loans hold steady. Office loans defaulted at twice the predicted rate: 16 defaults against 8.1 expected. The office back-test, the latest quarterly monitoring report, the challenger results and the change log are one click away.
- 044 min 10 s

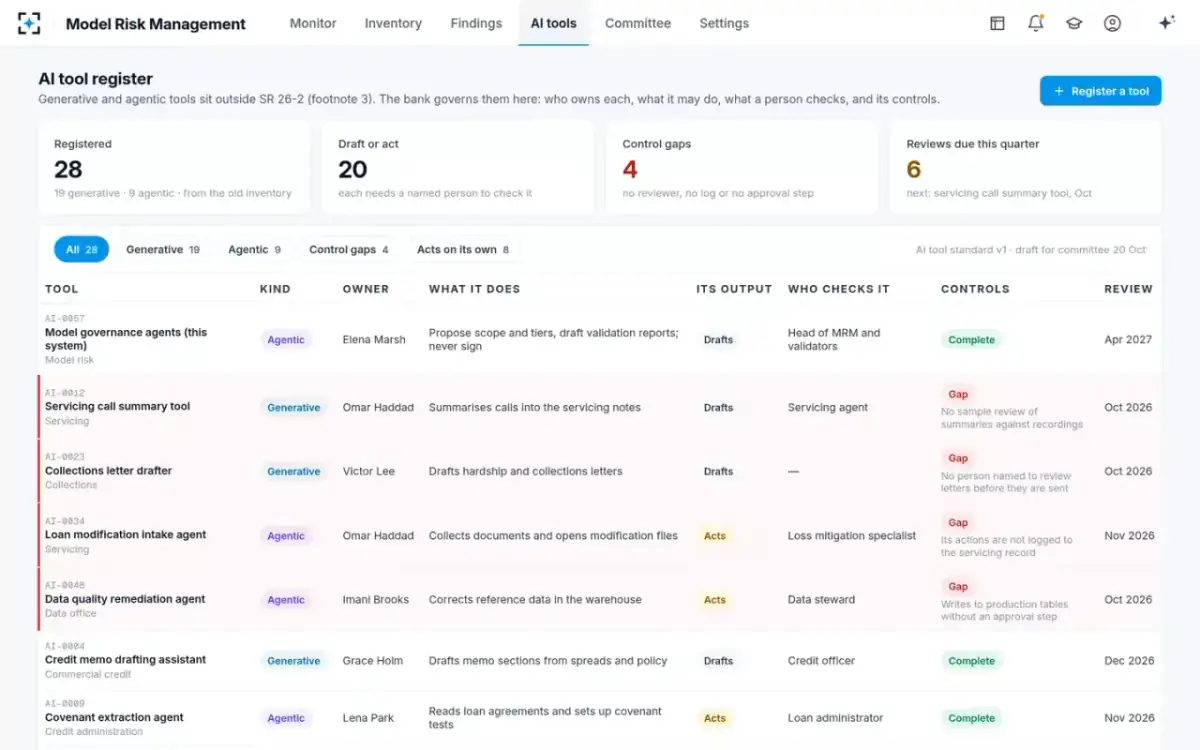

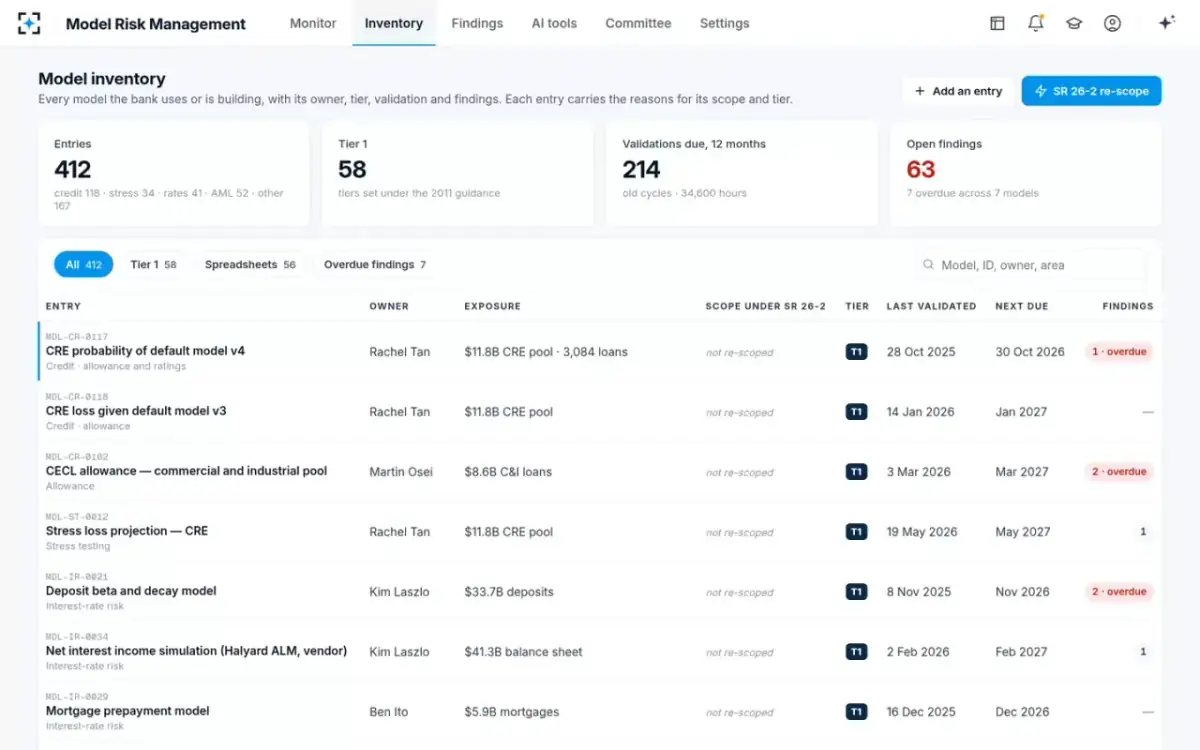

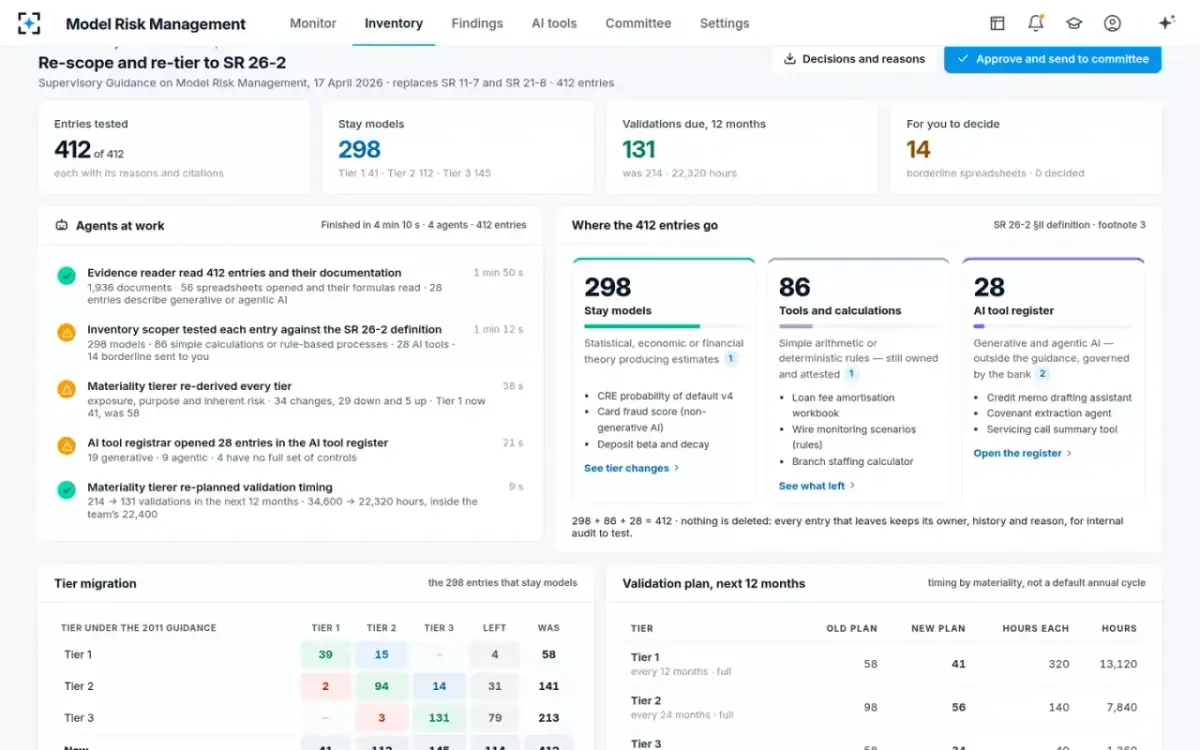

The whole inventory, re-scoped to SR 26-2

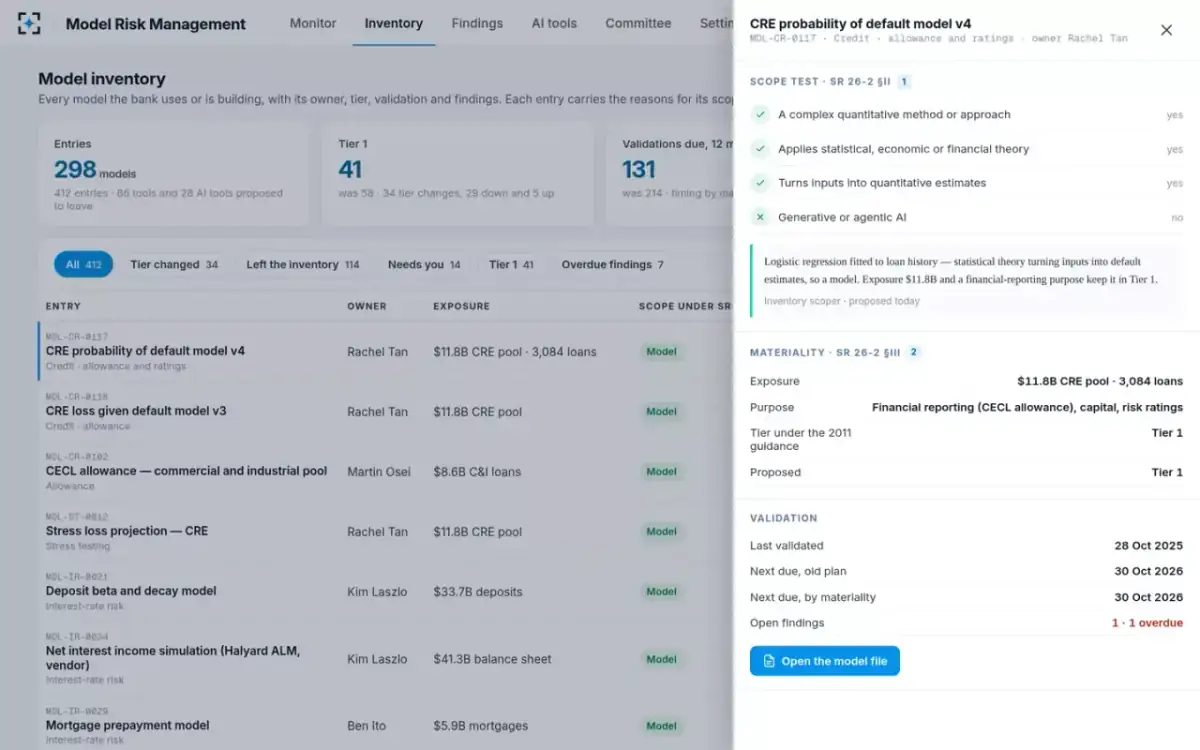

Inventory scoper · Materiality tiererThe CRE model is not the only item due before the committee. Four agents test all 412 entries against the new SR 26-2 definition of a model. Of those, 298 stay models and 86 move to the tools and calculations register. Another 28 go to the AI tool register. The last 14 are borderline spreadsheets, which go to the head of model risk to decide. Re-tiered by materiality, the 12-month plan falls from 214 validations to 131. Hours fall from 34,600 to 22,320, inside the team’s 22,400.
“298 + 86 + 28 = 412 · nothing is deleted: each entry that leaves keeps its owner, history and reason.”
- 05Each entry

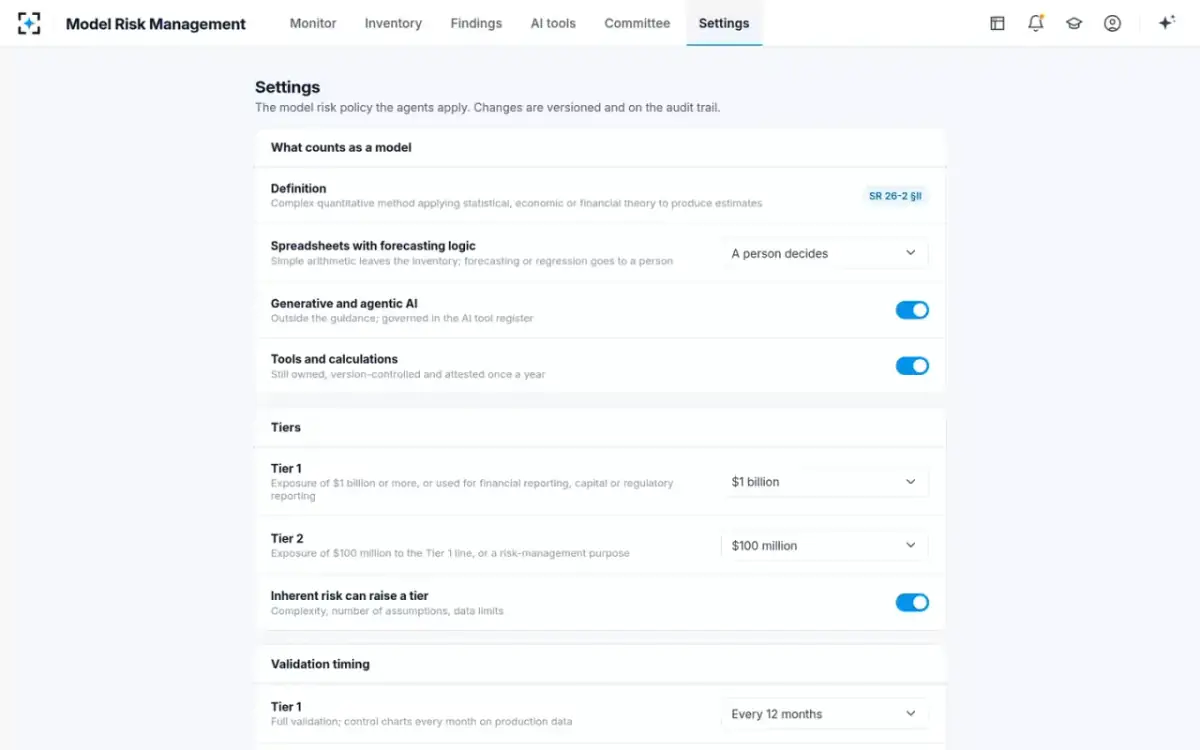

Model or not, with the reason written down
Inventory scoperEach entry carries its scope test against SR 26-2 §II and its materiality against §III. The CRE default model uses a complex quantitative method built on statistical theory. It produces quantitative estimates and is not generative AI, so it is a model. Its exposure of $11.8 billion and its use in financial reporting keep it in Tier 1.
“Logistic regression fitted to loan history: statistical theory turning inputs into default estimates, so a model.”
- 062 min 59 s

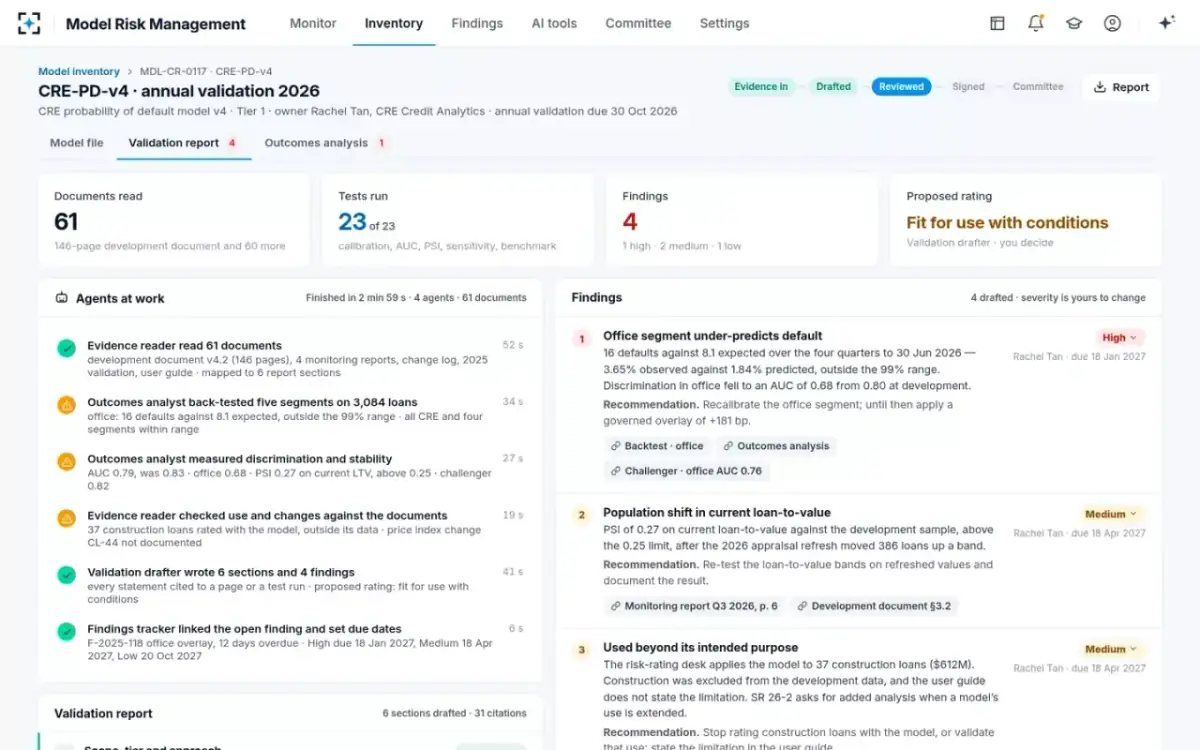

The annual validation, drafted from 61 documents
Evidence reader · Validation drafterThe lead validator starts from the evidence instead of a blank template. The agents read the 146-page development document, four monitoring reports, the change log, last year’s validation and the user guide. They ran 23 of 23 tests. They drafted six report sections with 31 citations and four findings: one high, two medium and one low. The proposed rating is fit for use with conditions. The validator can change any severity.
- 07Next

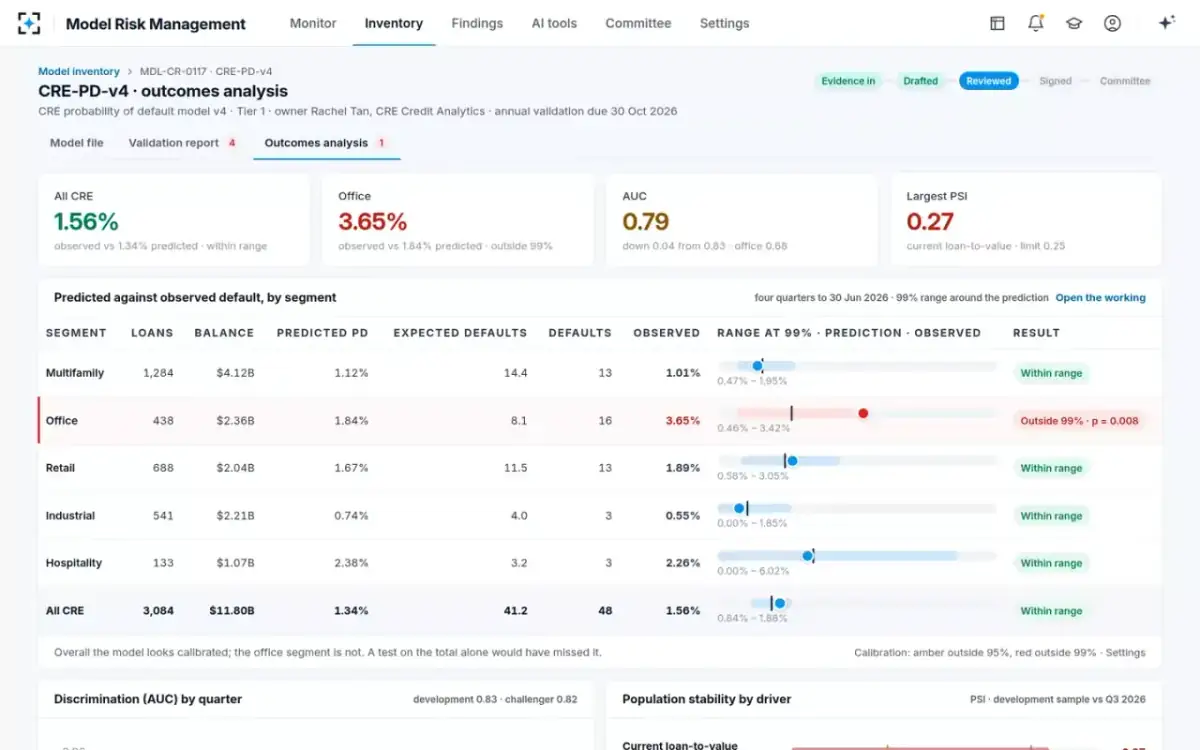

The back-test a portfolio total would have missed
Outcomes analystAcross all CRE loans, there were 48 defaults on 3,084 loans. That is 1.56% observed against 1.34% predicted, which sits inside the range. Office loans do not. They show 3.65% observed against 1.84% predicted, outside the 99% range, with p = 0.008. The draft asks for a governed overlay of +181 bp until the office group is recalibrated. That adds about $13.7 million to the CRE allowance.
“Overall the model looks calibrated; the office segment is not. A test on the total alone would have missed it.”

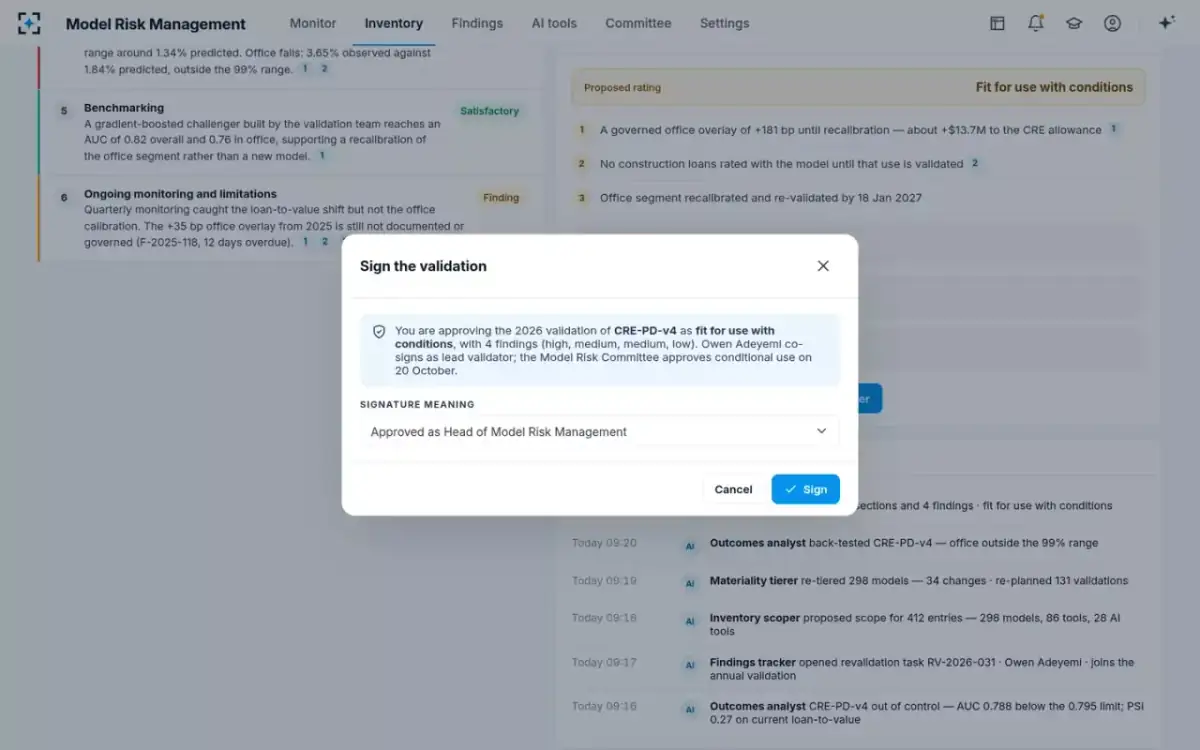

- 08Signed
Two signatures, and conditions the committee approves
Head of model risk managementThe head of model risk approves this year’s validation of the CRE default model as fit for use, with three conditions. A governed overlay covers the office loans. No construction loans are rated with the model until that use is validated. The office group must be recalibrated and validated again within 90 days of the committee. The signature records what it means, and the lead validator co-signs.
- 09Chased

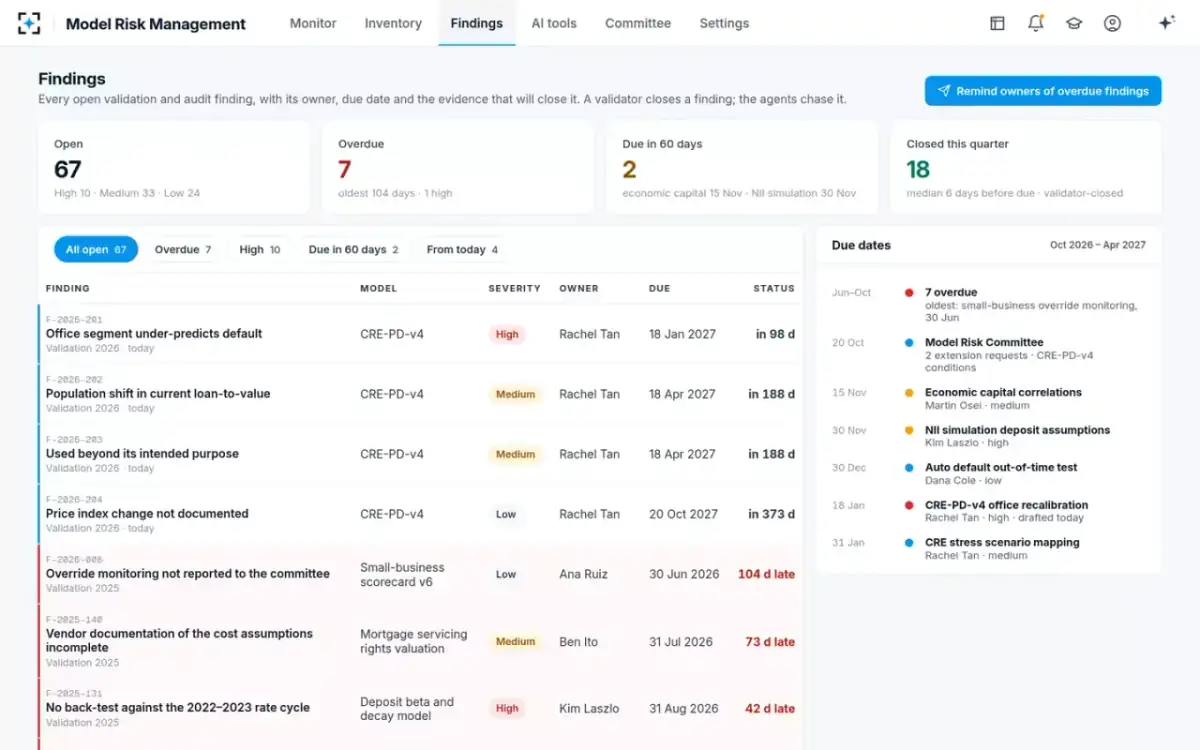

Each finding to an owner and a date
Findings trackerThe four new findings join the tracker. Due dates follow severity, counted from the committee date: High in 90 days, Medium in 180, Low in 365. Open findings rise from 63 to 67. Reminders go out on the 7 overdue findings, the oldest 104 days late. The tracker also drafts the two extension requests.
The findings tracker never closes a finding. A validator does.

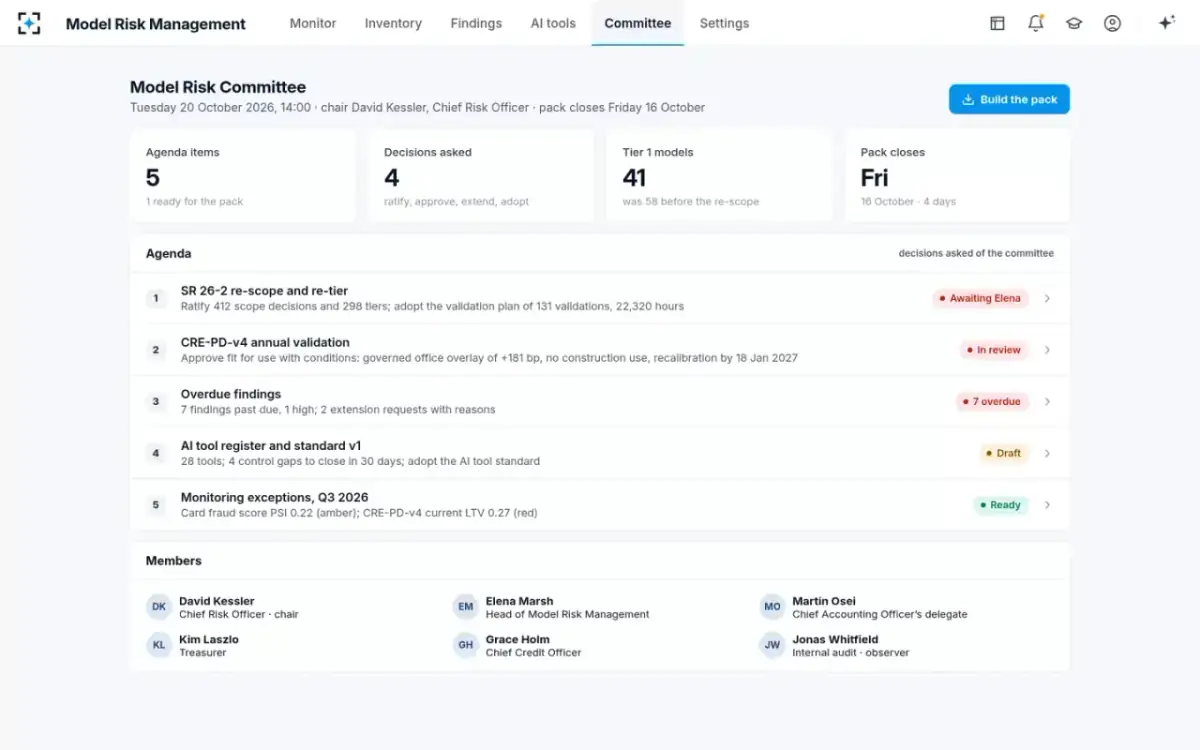

- 10Committee day
The committee decides what only it can
Chief risk officerThe pack closes the Friday before, with five agenda items and four decisions. First, ratify the 412 scope decisions and 298 tiers, and adopt the 131-validation plan. Second, approve the CRE default model with conditions. Third, rule on 7 overdue findings and 2 extension requests. Fourth, adopt version 1 of the AI tool standard, with 4 control gaps to close in 30 days.
