- Before
- Signs a population built from one extract with one method, where each customer it missed becomes a second finding and a second program.
- Now
- Approves the population only when two blind builds agree, with each difference explained and cited, and sees each program's next decision on one waterfall.
A customer remediation program where two counts must become one
The bank, a large US regional bank, has eight remediation programs open. In one, a $5.00 savings transfer fee kept being charged for months after it was removed from the fee schedule. The bank reported it to the CFPB in a commitment letter, with a completion report due by a set date. Here is one Thursday, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Thursday morning

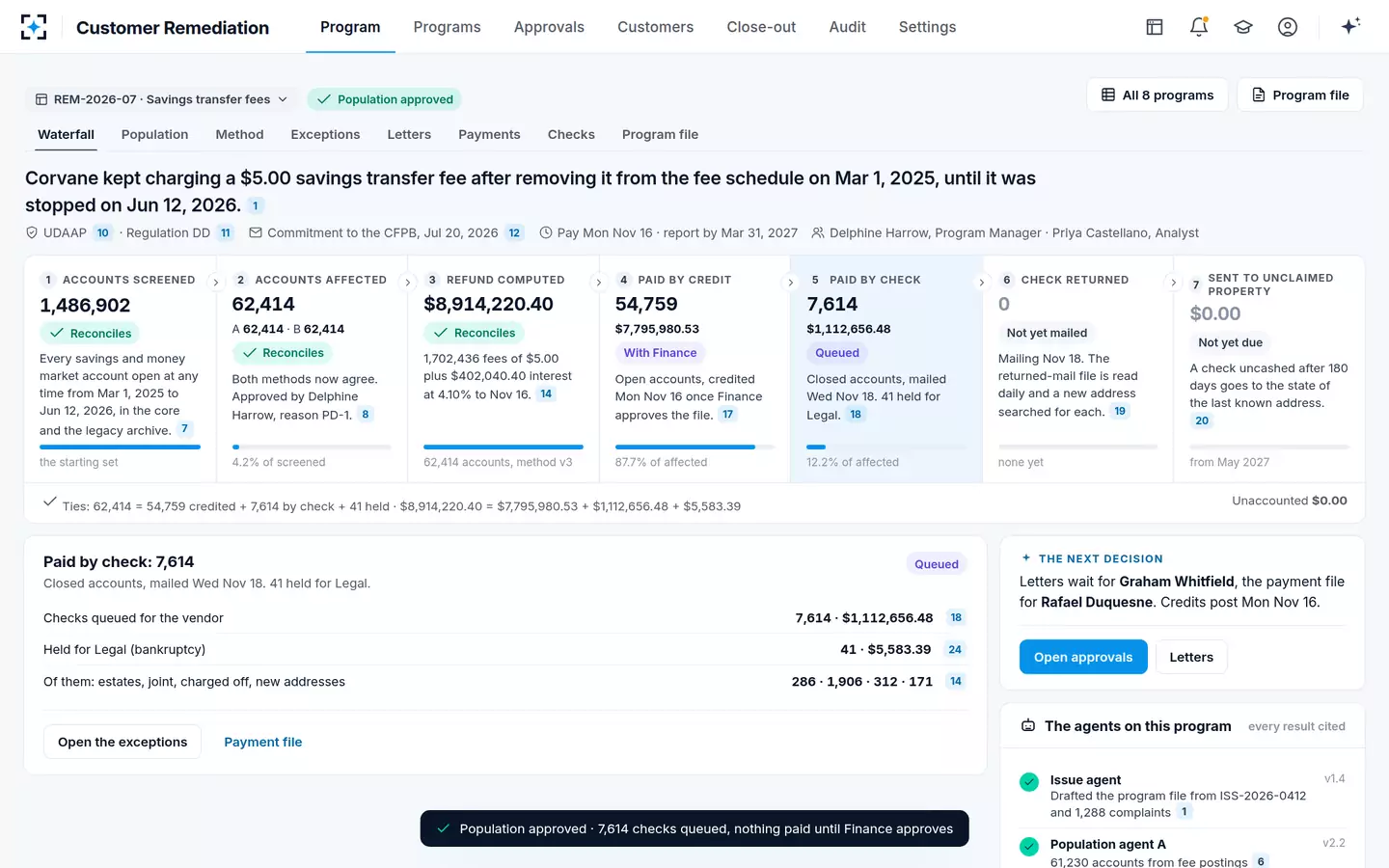

The whole remediation program as one waterfall

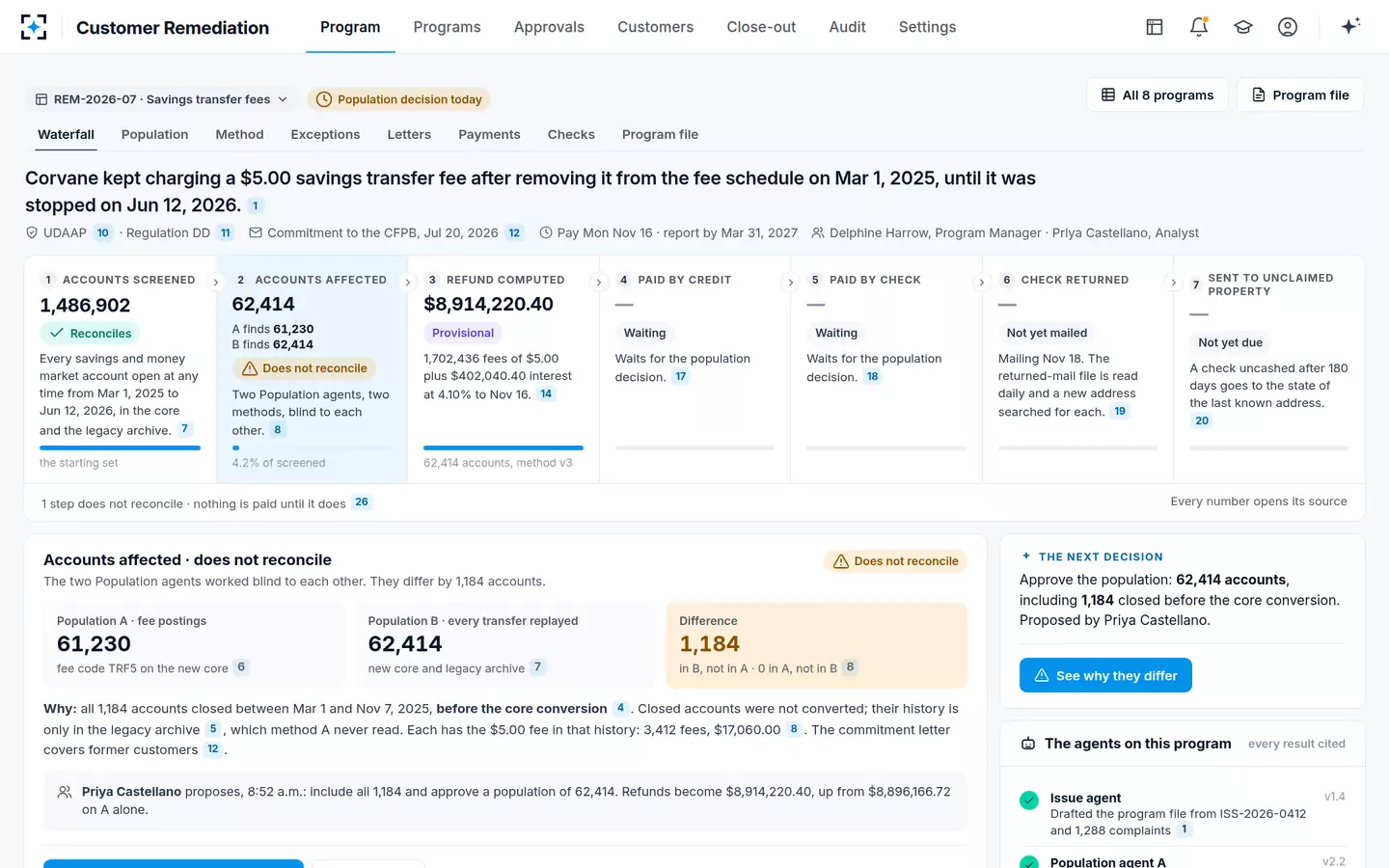

Remediation program managerThe issue sits on top in one sentence. Below it, seven plain counts read left to right: 1,486,902 accounts screened, 62,414 affected, $8,914,220.40 refund computed, then paid by credit, paid by check, check returned and sent to unclaimed property. Each count has one sentence saying how it was found, with its source. Accounts affected says "Does not reconcile", and the next decision on the right belongs to the program manager: approve the population.
"The bank kept charging a $5.00 savings transfer fee after it was removed from the fee schedule."
- 028:29 and 8:31 AM
Two population builds, blind to each other

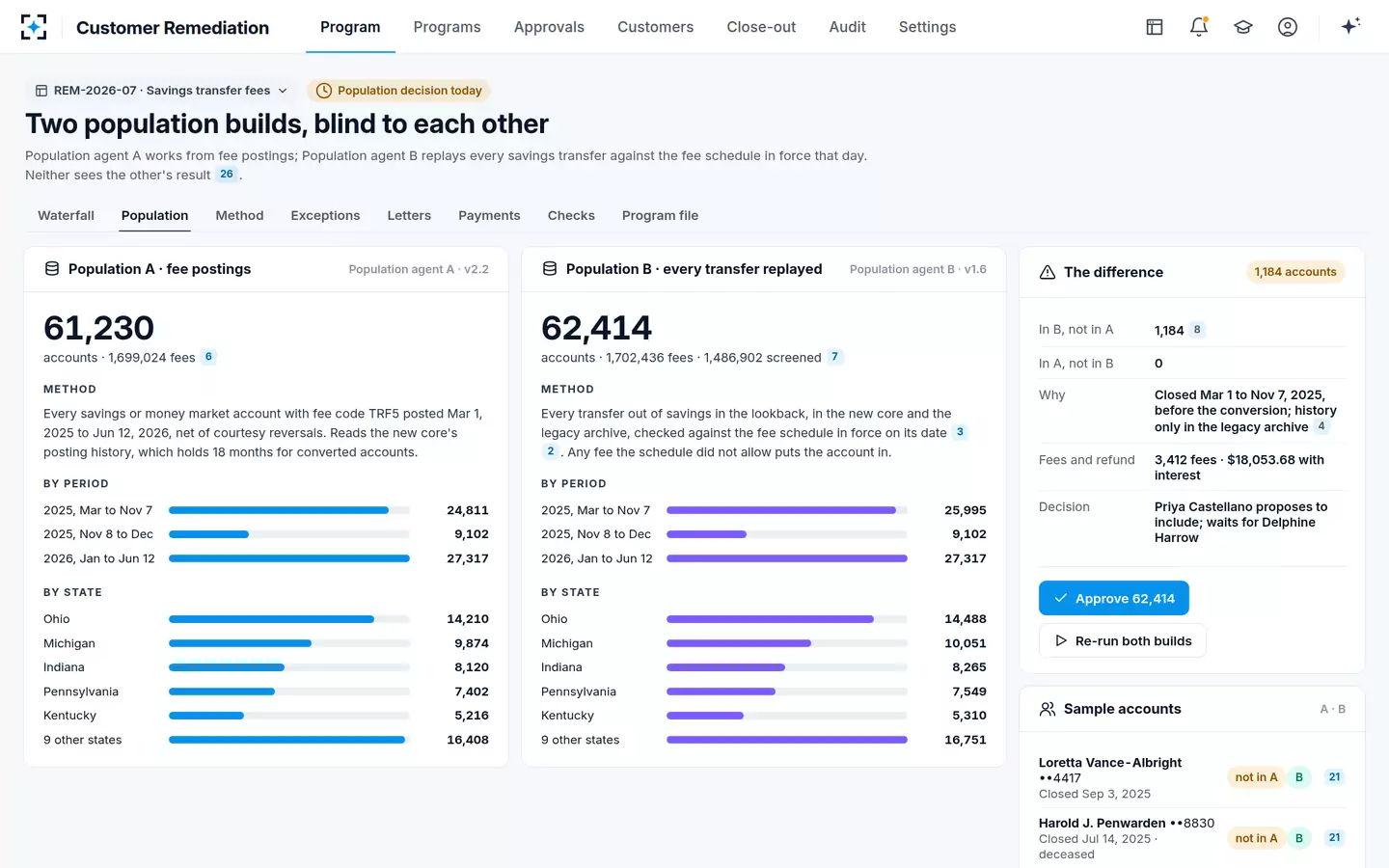

Population agents A and BPopulation agent A reads the fee's postings on the new core: 61,230 accounts and 1,699,024 fees. Population agent B replays each transfer out of savings against the fee schedule in force on its date, in the new core and the legacy archive: 62,414 accounts and 1,702,436 fees. Neither sees the other's result, and the program cannot pay until they agree.
Population A's run log: "Did not read: legacy archive."
- 038:33 AM

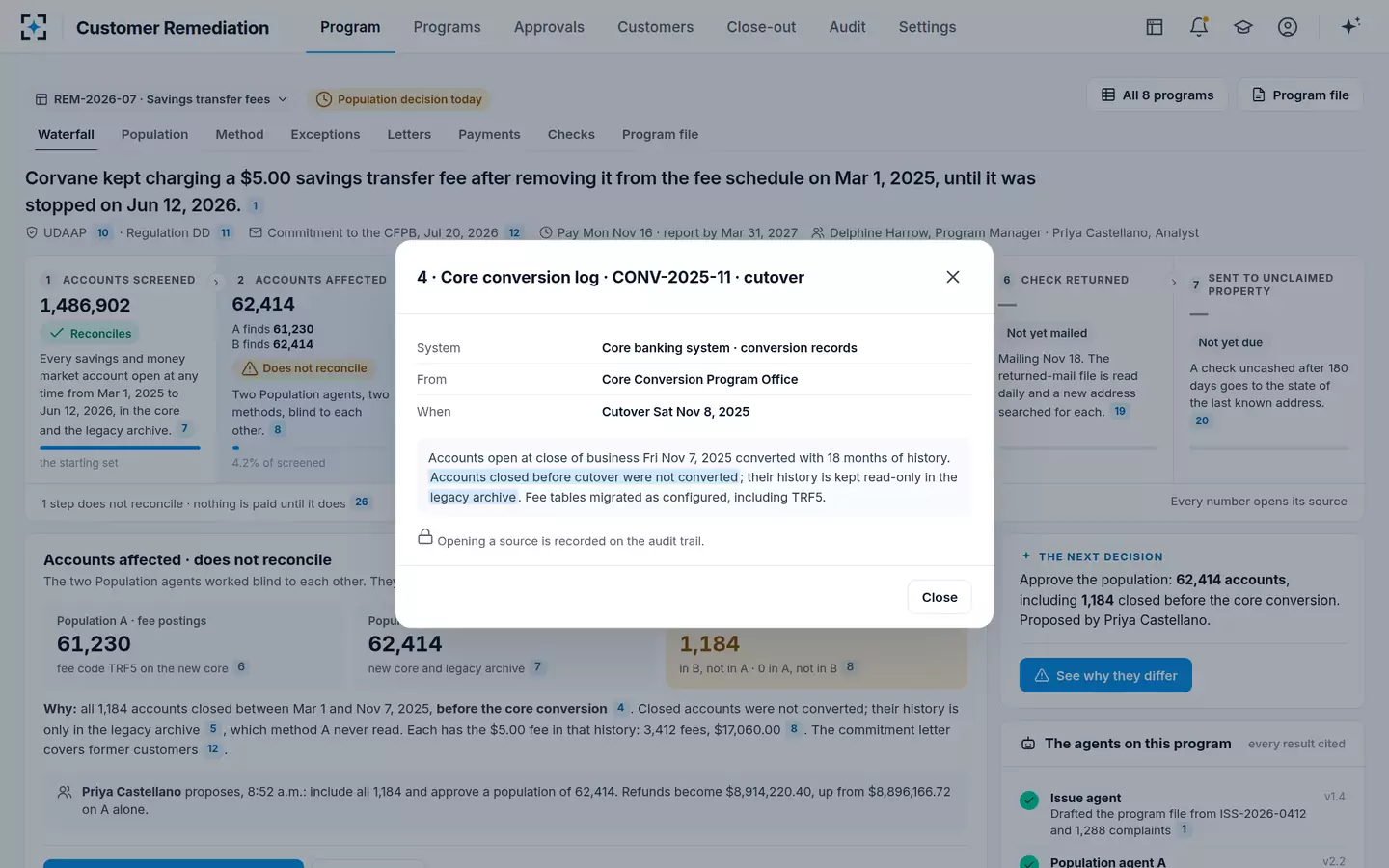

The 1,184 explained, with the record that proves it
Population agent BAll 1,184 accounts in B and not in A closed in the months before the core conversion. They were charged 3,412 fees, $17,060.00, plus $993.68 interest, and each one has the fee in the legacy archive's posting history. One click opens the core conversion log.
"Accounts closed before cutover were not converted; their history is kept read-only in the legacy archive."
- 049:14 AM
The population approved on the analyst's proposal

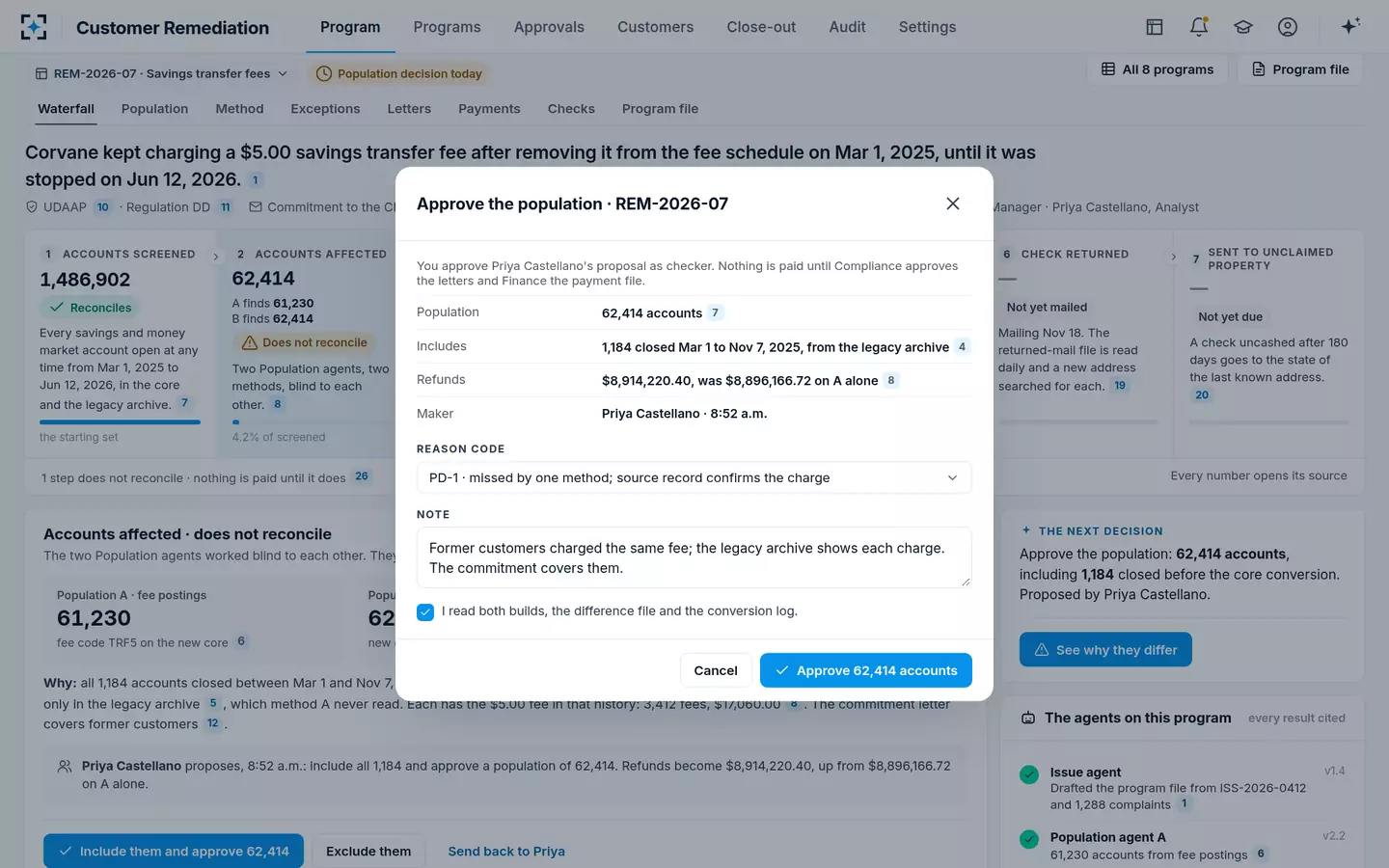

Remediation program managerAt 8:52 AM the remediation analyst proposed including all 1,184 former customers. The program manager approves as checker: the approval names the maker, requires a reason code and a note, and asks for confirmation that both builds, the difference file and the conversion log were read. The population is 62,414 accounts, and refunds become $8,914,220.40, up from $8,896,166.72 on population A alone.
Reason code: "missed by one method; source record confirms the charge"
- 05After the approval
Each step reconciles
Calculation and Payment agentsBoth population agents agree on 62,414 accounts. The Calculation agent recomputes 1,702,436 fees of $5.00 plus $402,040.40 interest at 4.10% to the payment date under method v3. The Payment agent splits 54,759 credits ($7,795,980.53) from 7,614 checks ($1,112,656.48) for closed accounts, with 41 accounts ($5,583.39) held for Legal, and the footer shows $0.00 unaccounted.
The Calculation agent's limit: "Only an approved method pays."
- 06Any account
One refund, traced fee by fee

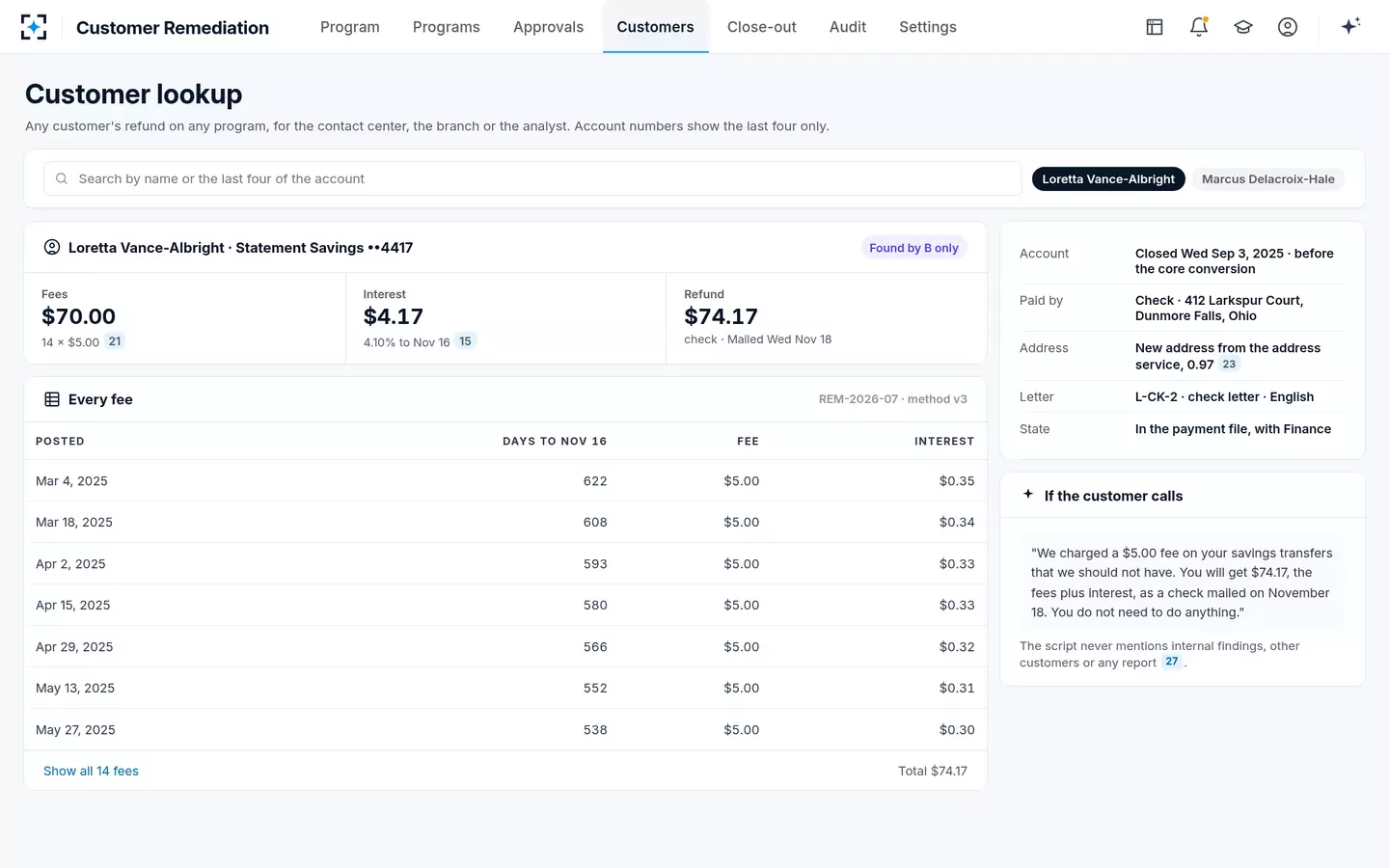

Calculation agentOne former customer's statement savings account closed before the conversion and was found by Population B only. Each of its 14 fees shows its posting date, the days to the payment date and its interest: $70.00 in fees plus $4.17 interest, a refund of $74.17. The Payment agent found the customer's new address through the address service at a 0.97 match, and the page says what to tell the customer who calls.
Method v3: "Interest per fee: fee × 4.10% × days from posting to payment ÷ 365, rounded to the cent."
- 07The exceptions
Seven groups, each paid the right way

Remediation analystThe agents set aside the accounts that need a person, each group with a proposed way to pay: 286 deceased owners (check to the estate), 41 in bankruptcy (held for Legal), 312 charged off (paid by check), 1,906 joint closed accounts (one check to all owners), 219 with no usable address (171 found), 1,288 who complained about the fee and 4,980 letters in Spanish. The analyst decides a whole group in one step with a reason code, or assigns groups to a second analyst in bulk.
Method v3, rule 6: "Never set off against any debt."
- 08Next

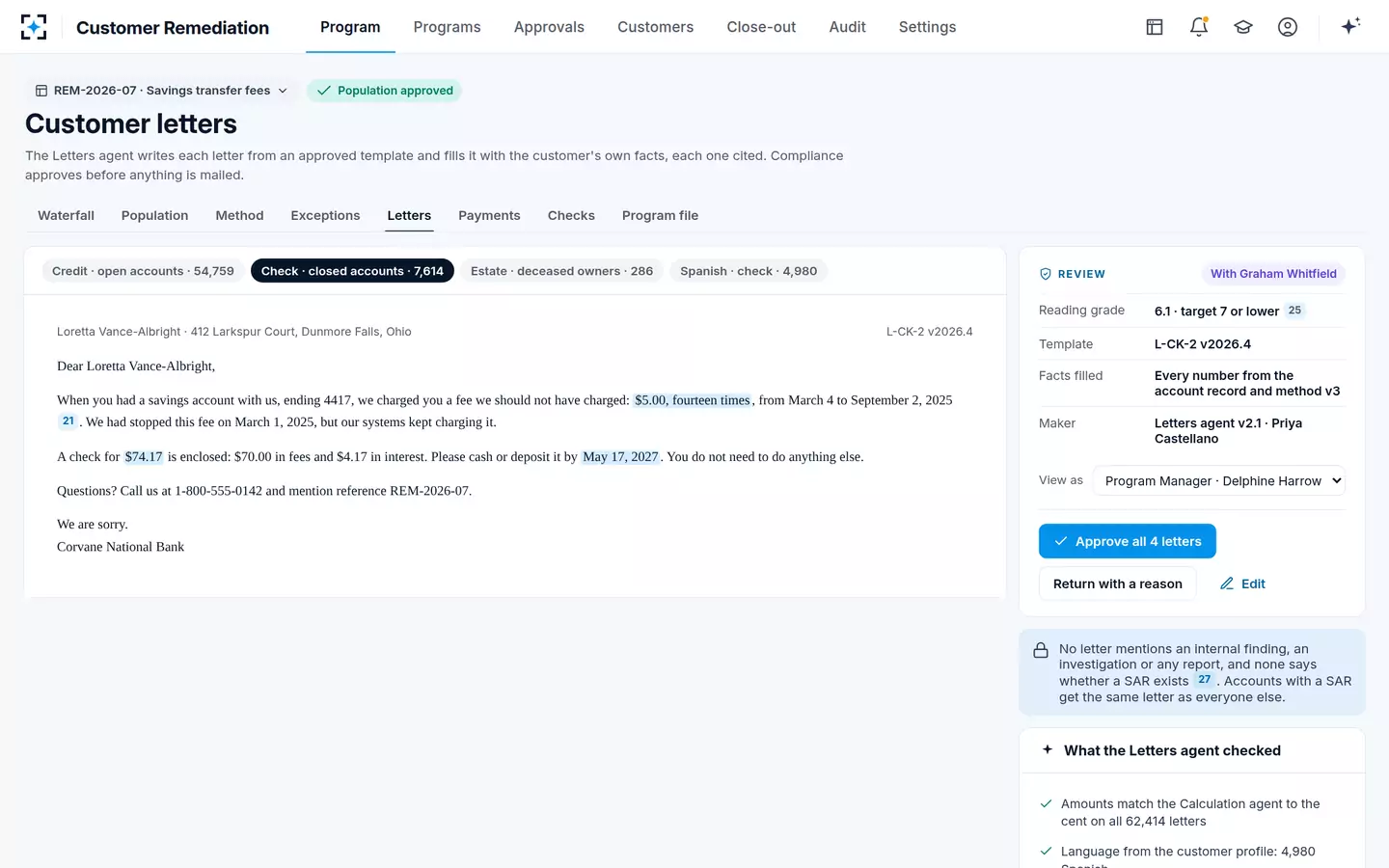

Letters in plain words, approved only by Compliance
Consumer compliance officerThe Letters agent drafts four letters from the approved templates: credit to 54,759 open accounts, check to 7,614 closed accounts, estate to 286, and Spanish to 4,980. The former customer's check letter reads at grade 6.1: we charged you $5.00 fourteen times, a check for $74.17 is enclosed, please cash it by the date shown. Each fact cites the account record, and only the compliance officer approves the letters or returns them with a reason code.
The templates' rule: "No reference to any internal finding, investigation or report."
- 09Then

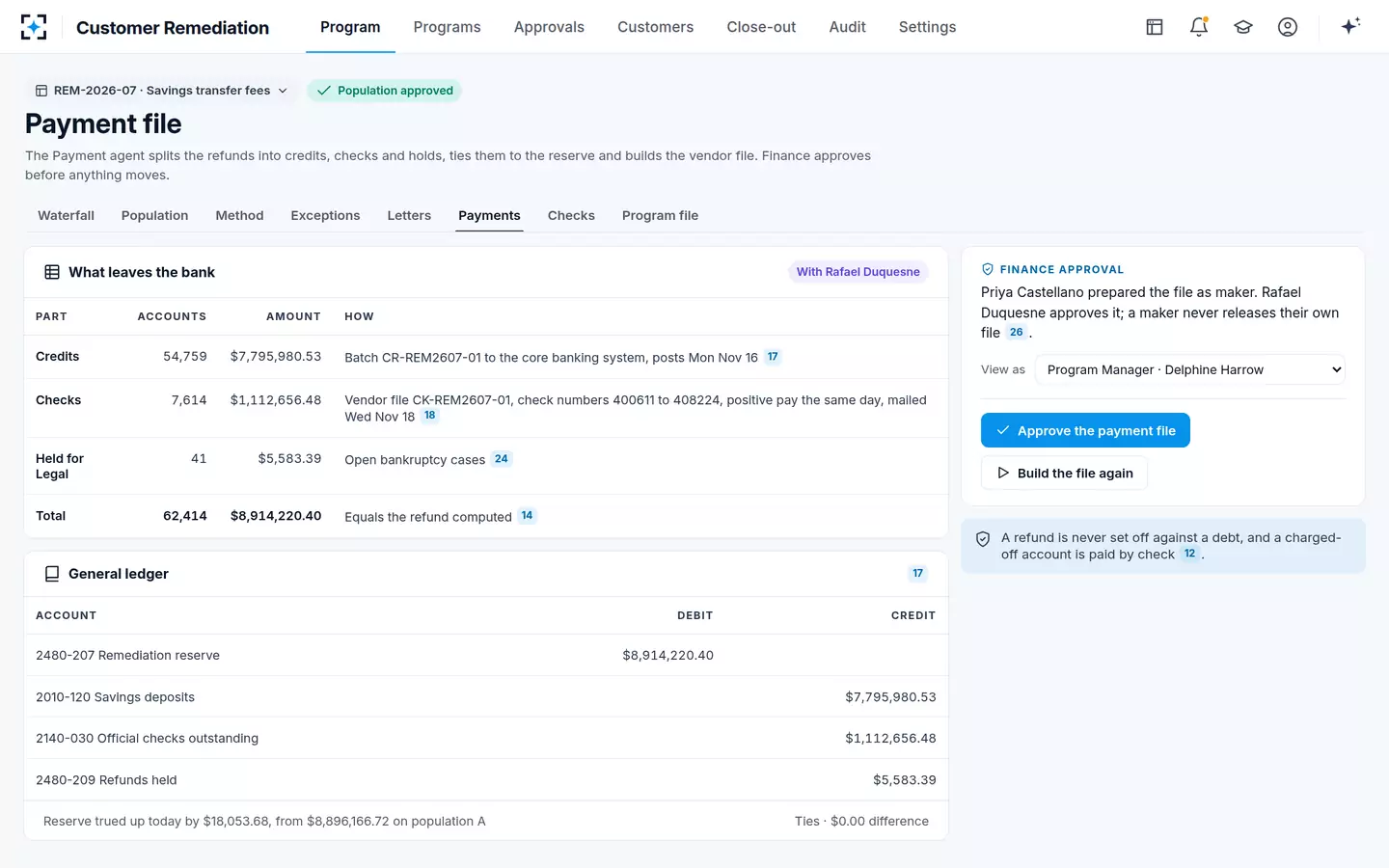

A payment file tied to the general ledger

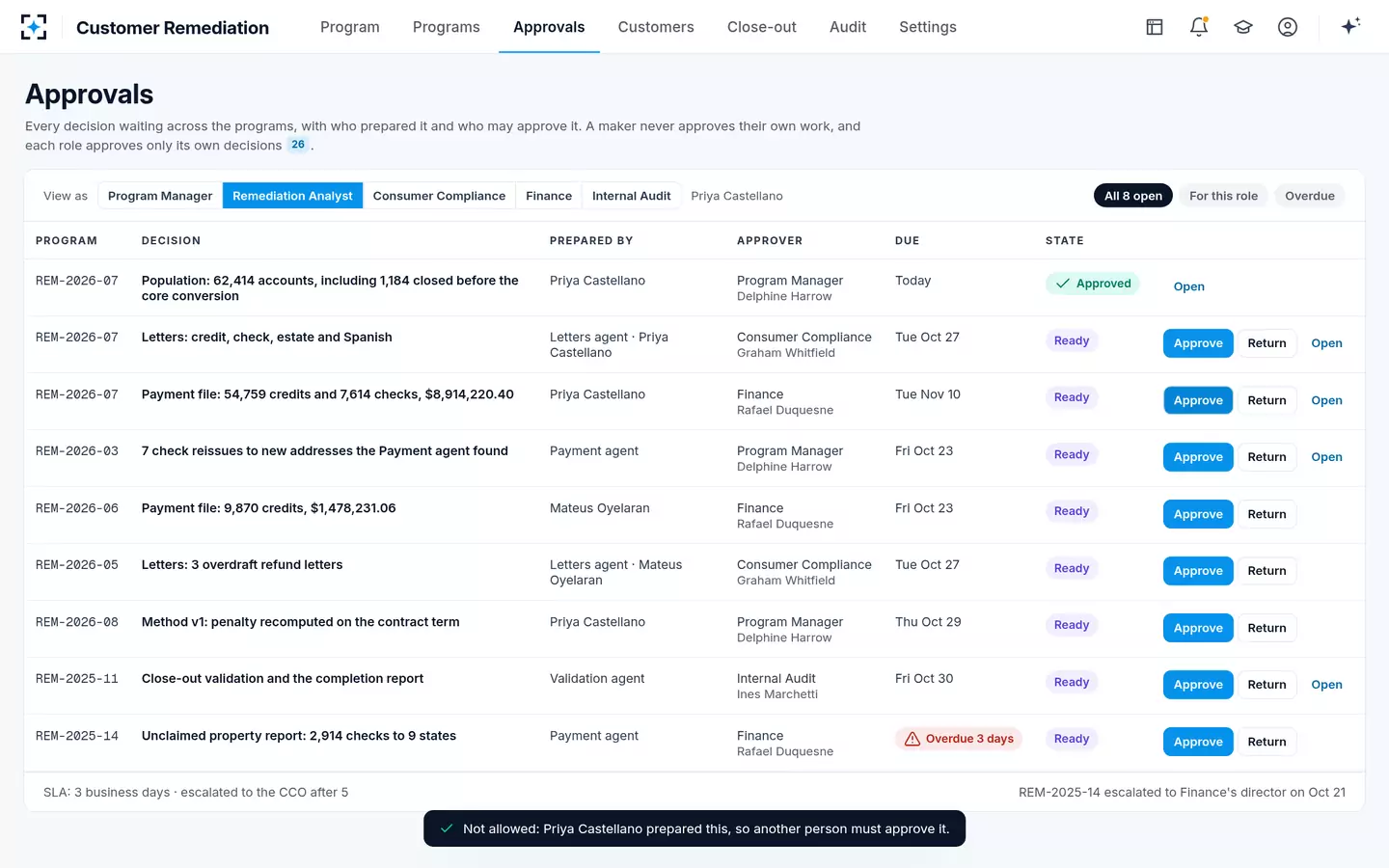

Remediation finance controllerWhat leaves the bank: 54,759 credits posting on the payment date, 7,614 checks mailed two days later, and 41 refunds held for Legal, totaling $8,914,220.40. The ledger entries debit the remediation reserve, trued up by $18,053.68 for the 1,184. The analyst prepared the file, and when the analyst tries to approve it too, the screen stops them.
"Not allowed: you prepared this, so another person must approve it."
- 10Close-out
Close-out validated from the evidence itself

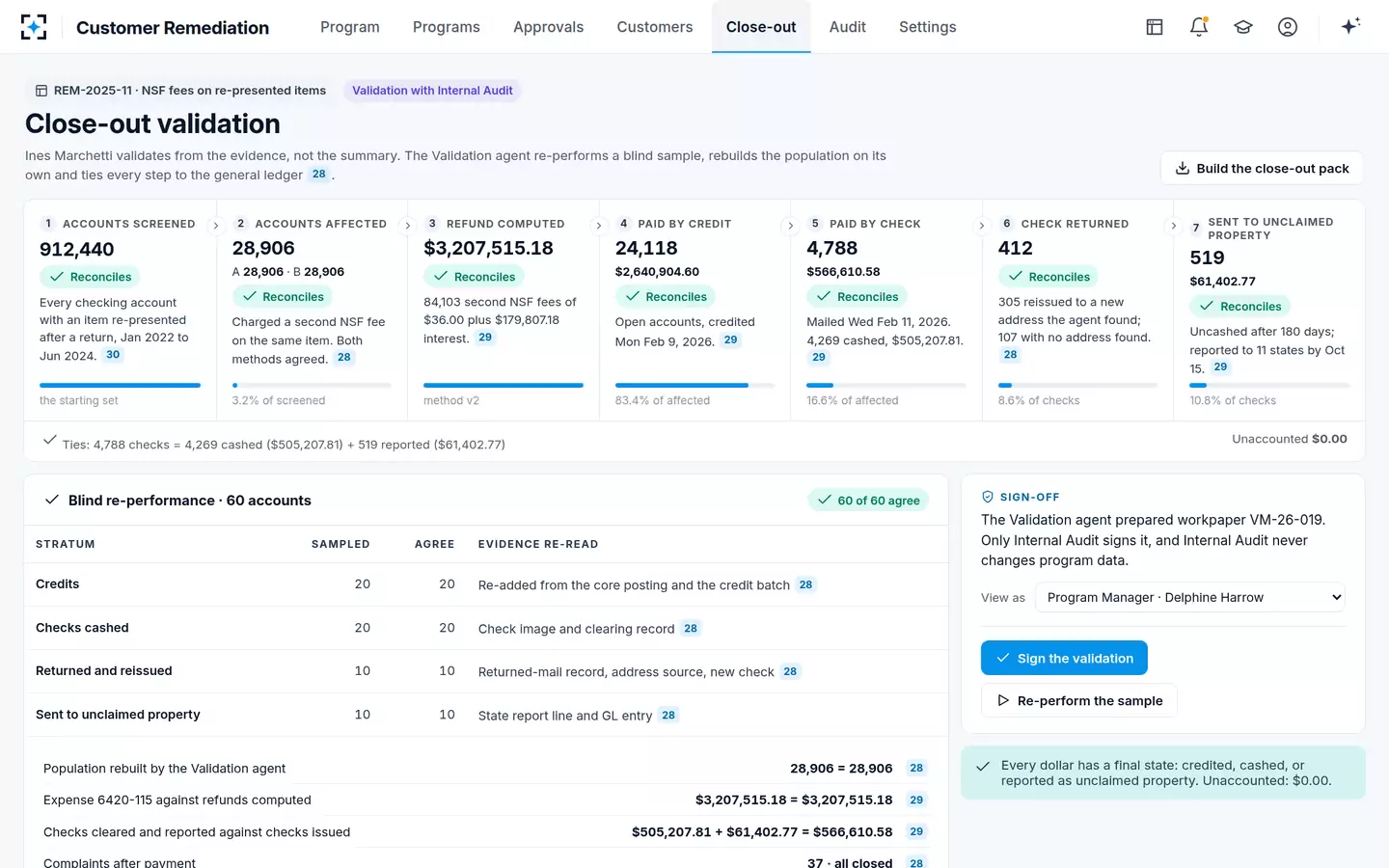

Internal audit validation leadThe same waterfall closes an earlier program, for NSF fees charged again on re-presented items: 28,906 accounts, $3,207,515.18 refunded and 519 checks ($61,402.77) sent to unclaimed property, each step reconciling with $0.00 unaccounted. The Validation agent re-performed a blind sample of 60 accounts in four strata, all 60 agreeing, rebuilt the population (28,906 = 28,906) and tied the checks to the general ledger. Only the validation lead signs before the completion report goes to the OCC.
The Validation agent's limit: read only, with no edits to program data.
