- Before
- Cannot read half a million rows, so samples what time allows. A late-night reintegration can reach release before anyone reads the rows.
- Now
- Sees the person and the hour that matter, with the rows behind each flag, then decides each finding and signs each period on schedule.
A week of audit trails across nine systems, screened and signed
A drug maker runs nine GxP systems across three sites and one clinical study. GxP is the set of good-practice rules for making, testing and trialling drugs, and these systems hold the data those rules cover. It is Wednesday, and last week is due for review. Here is what happens next in the working solution, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Wednesday morning

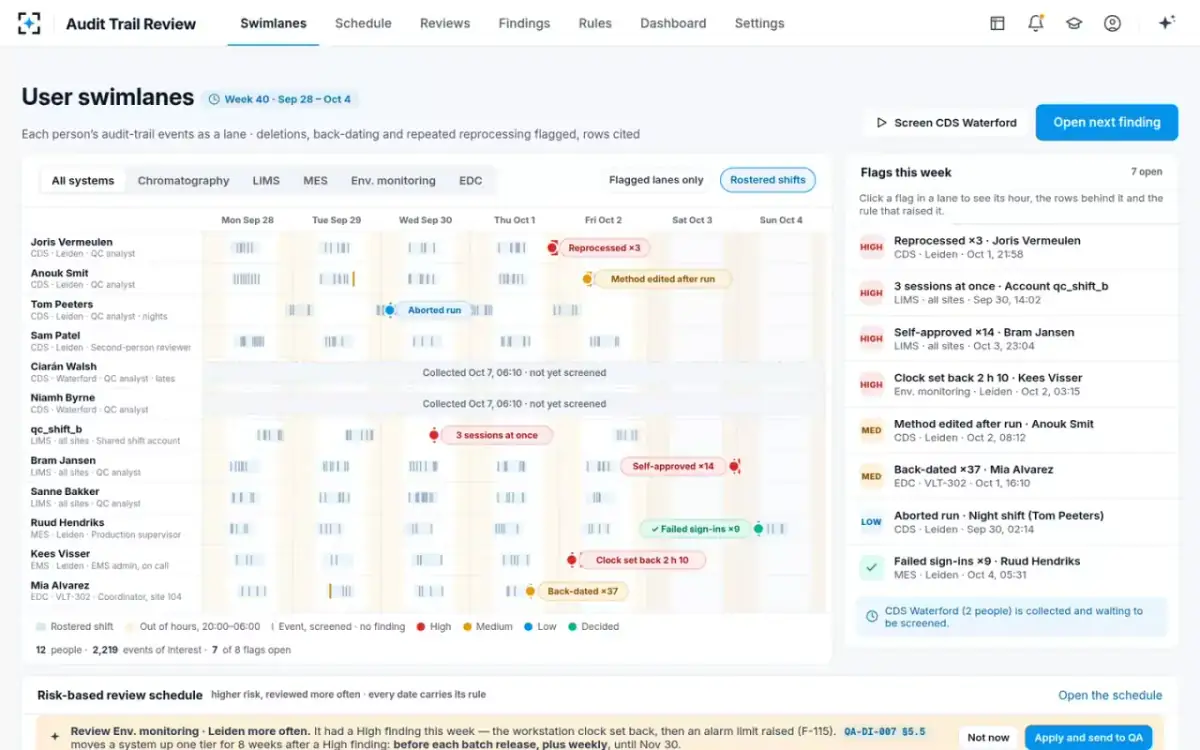

The week laid out as one lane per person
Data integrity leadThe data integrity lead opens User swimlanes. It shows 12 people and accounts across seven days, with rostered shifts as bands. The hours from 20:00 to 06:00 are shaded as out of hours. Each screened event is a tick, with 2,219 events of interest in all. Seven of the 8 flags are still open. Among them are “Reprocessed ×3”, “3 sessions at once”, “Self-approved ×14”, “Clock set back 2 h 10” and “Back-dated ×37”. One site's chromatography data system was collected at 06:10 and is waiting to be screened.
“Click a flag in a lane to see its hour, the rows behind it and the rule that raised it.”
- 02Thursday, 21:58

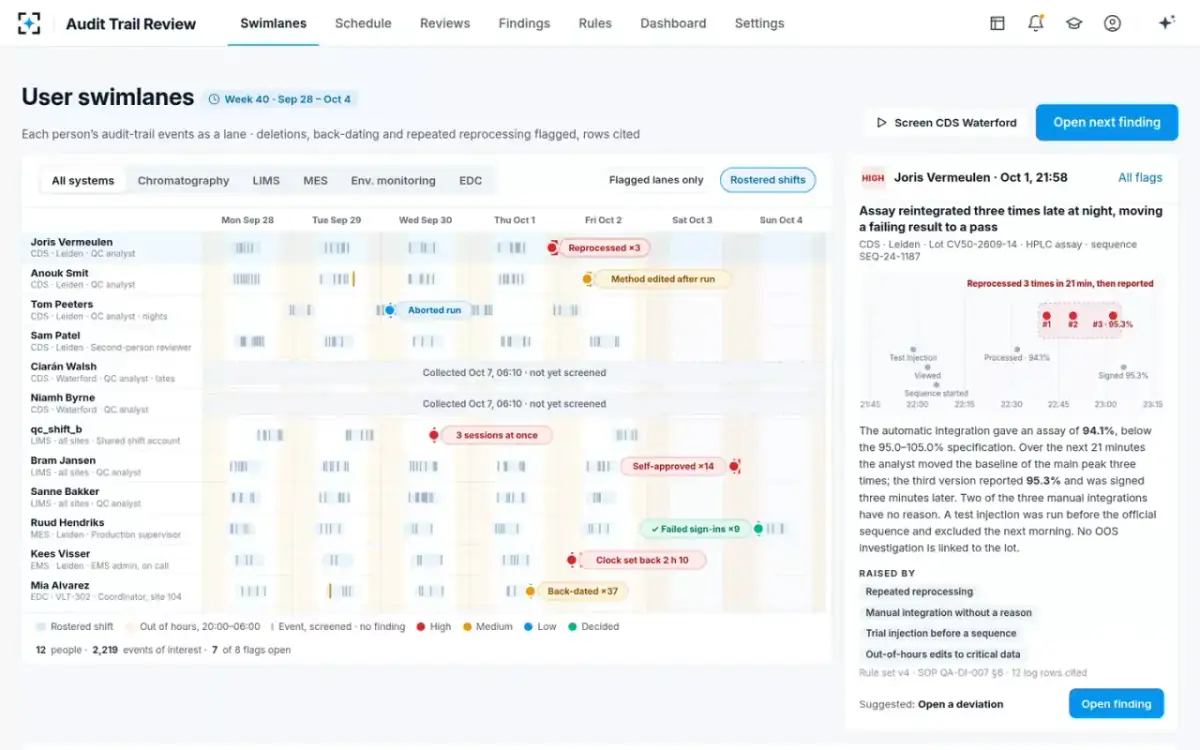

One analyst's Thursday night, zoomed to the hour
Pattern finder and Rule screenerA QC analyst rostered from 07:00 to 15:30 is flagged on Thursday night. First came a test injection, then the sequence, then processing at 94.1%. Then came three manual integrations, and the third was reported at 95.3%. Four checks raised the flag, for repeated reprocessing, manual integration without a reason, a trial injection before a sequence, and out-of-hours edits to critical data.
“Reprocessed 3 times in 21 min, then reported.”

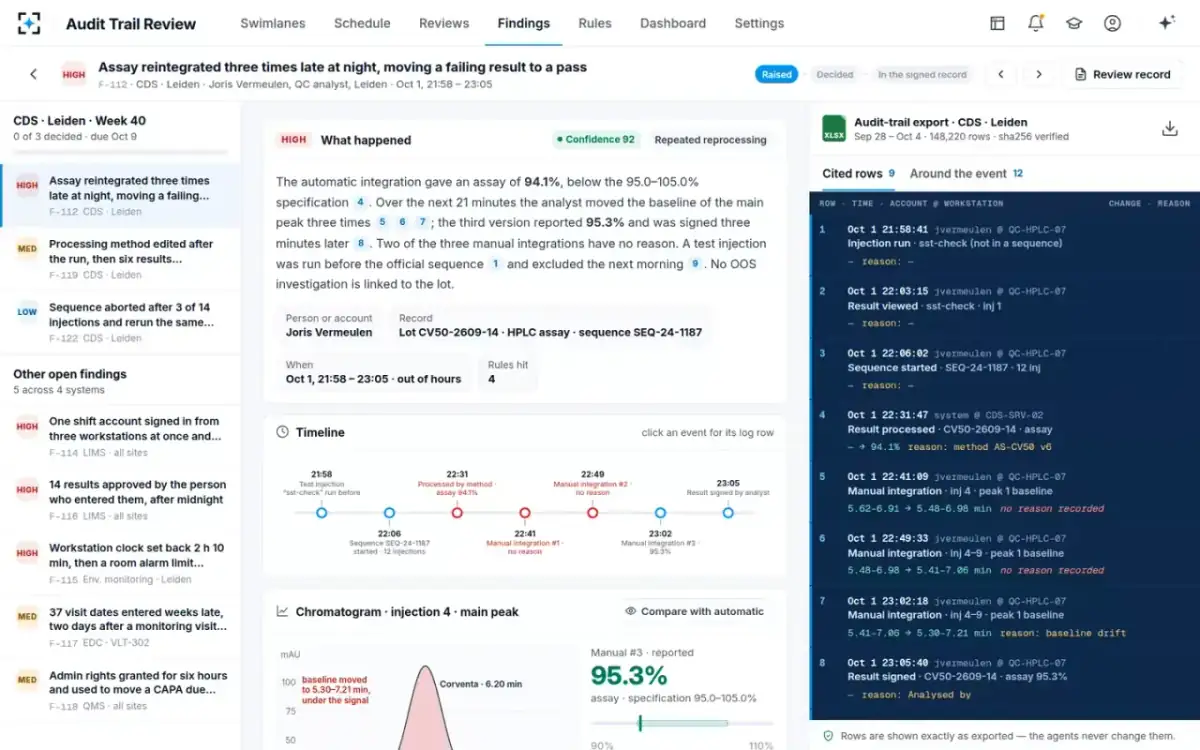

- 03Open finding
Each sentence of the finding cites its log row
Finding writerThe automatic integration gave an assay of 94.1%. The lot's specification is 95.0 to 105.0%, so that result fails. Over the next 21 minutes the main-peak baseline was moved by hand three times. The third version reported 95.3% and was signed three minutes later. Two of the three manual integrations have no reason. The “sst-check” test injection was excluded the next morning. No out-of-specification (OOS) investigation is linked to the lot. The suggestion is to open a deviation, with confidence 92.
“Rows are shown exactly as exported. The agents never change them.”

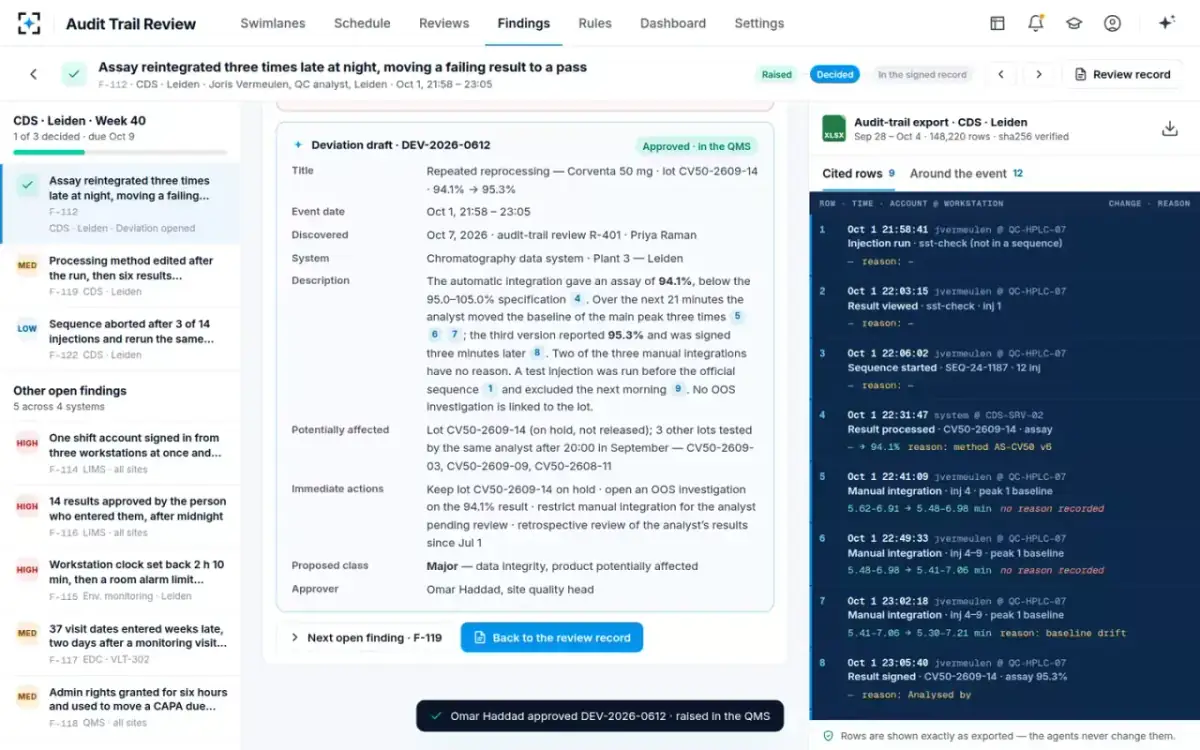

- 04The lead's decision
A deviation, drafted on evidence and approved by QA
Data integrity lead and site quality headThe lead chooses “Open a deviation” and notes a possible OOS result that was not investigated. A deviation is the formal quality record of something that went wrong. The deviation drafter writes it from 9 cited rows. The draft covers the lot, which is on hold and not released, and three other lots the analyst tested after 20:00 that month. Its actions are an OOS investigation on the 94.1% result and restrictions on manual integration until the review is done. It proposes the class Major. The site quality head approves it, and it is raised in the quality management system (QMS).
The deviation drafter never raises a deviation in the QMS on its own. QA approves first.
- 05The schedule
A bad week means more frequent reviews

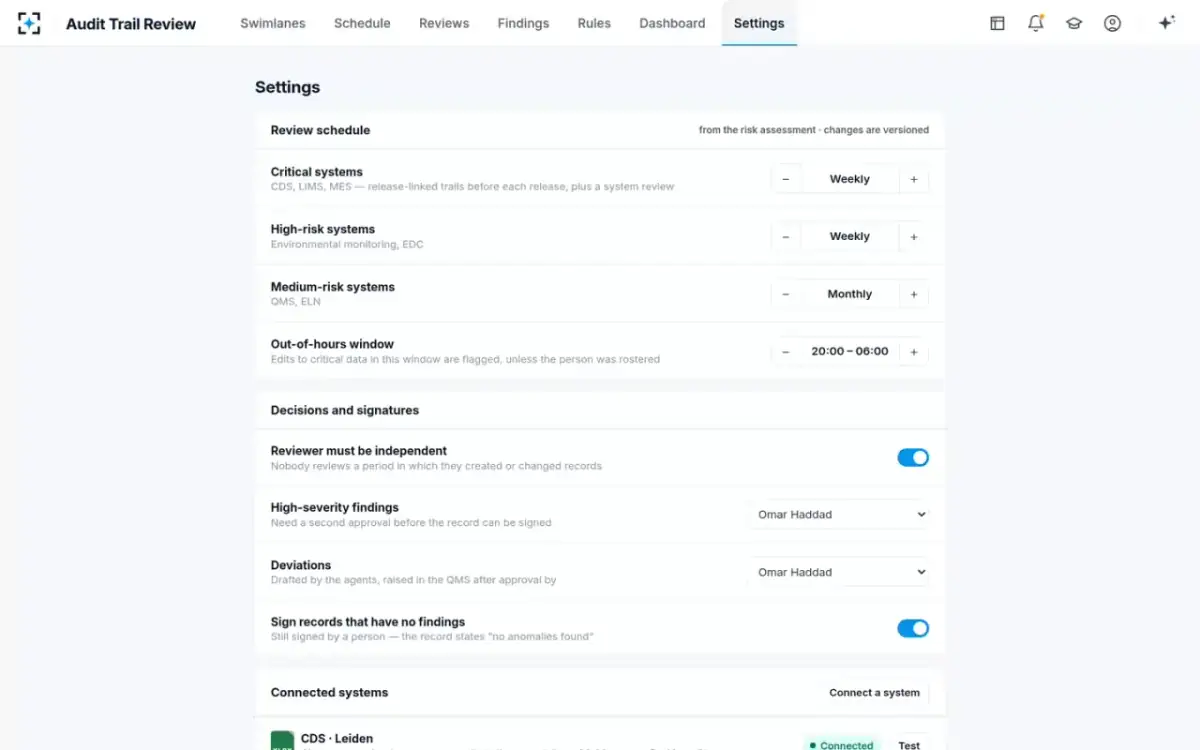

The agents, citing the review SOPEnvironmental monitoring at one site had a High finding this week. Its workstation clock was set back 2 h 10 min. Then the particle alert limit for a Grade B room was raised from 2,000 to 3,500 per m³. The schedule proposes moving the system up one tier. It cites the section of the review SOP that says so.
“§5.5 of the review SOP moves a system up one tier for 8 weeks after a High finding: before each batch release, plus weekly.”
- 06Applied

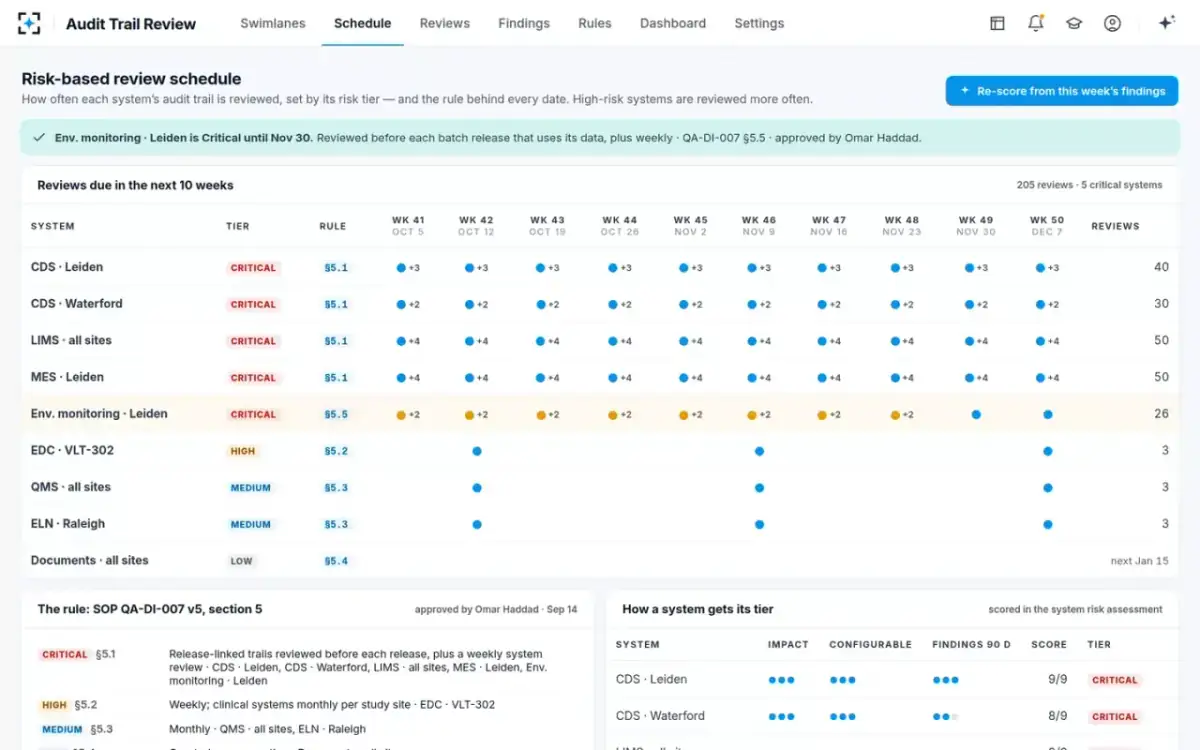

Ten weeks re-planned, with the rule behind each date
Data integrity lead and site quality headThe lead applies the change and sends it to QA, and the site quality head approves. Environmental monitoring is Critical for the next 8 weeks. Its reviews over the next ten weeks rise from 10 to 26. The plan now holds 205 reviews across 5 critical systems.
- 07Review records
One record per system and period, with its due clock

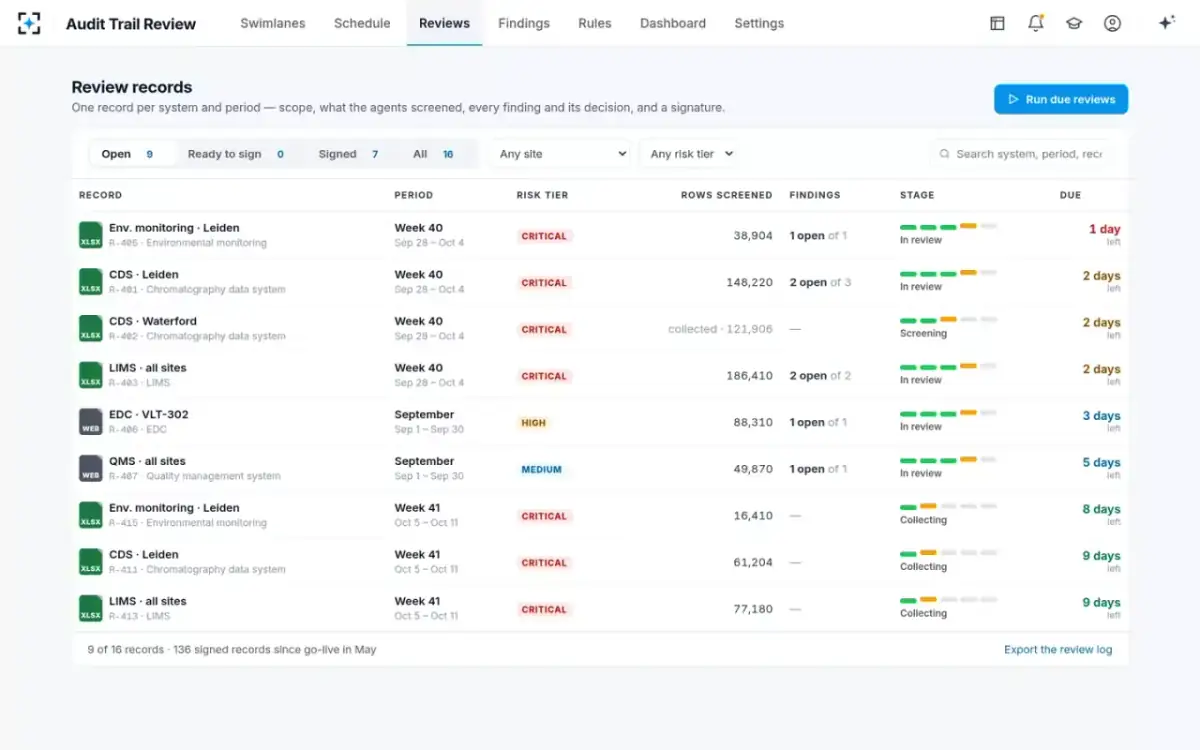

Data integrity leadNine records are open. Environmental monitoring is due tomorrow. One site's chromatography data system is due in two days, with 148,220 rows and 3 findings. So is the LIMS, with 186,410 rows and 2 findings. A second site's chromatography data system is still at Screening, with 121,906 rows collected. Since go-live, 136 records have been signed.
- 08Run the review
The second chromatography system, screened as the lead watches

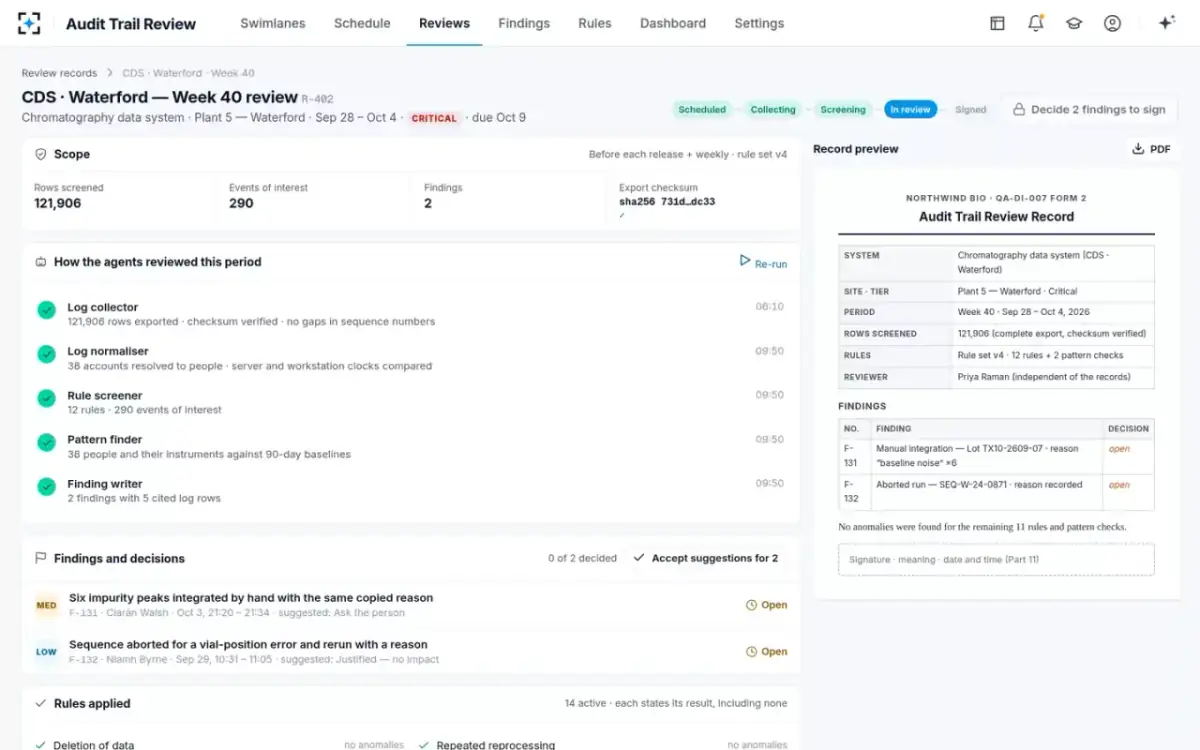

Log collector to Finding writerThe export has 121,906 rows, its checksum is verified and no sequence numbers are missing. The 38 accounts are resolved to people, and server and workstation clocks are compared. Twelve rules raise 290 events of interest. The pattern finder compares each person and their instruments with their own last 90 days. Two findings come out, citing 5 log rows. In one, six impurity peaks were integrated by hand with the same copied reason. The other is an aborted run that has a reason recorded.
The record preview fills in as the agents work. It shows the scope, rule set v4, each finding and its decision.

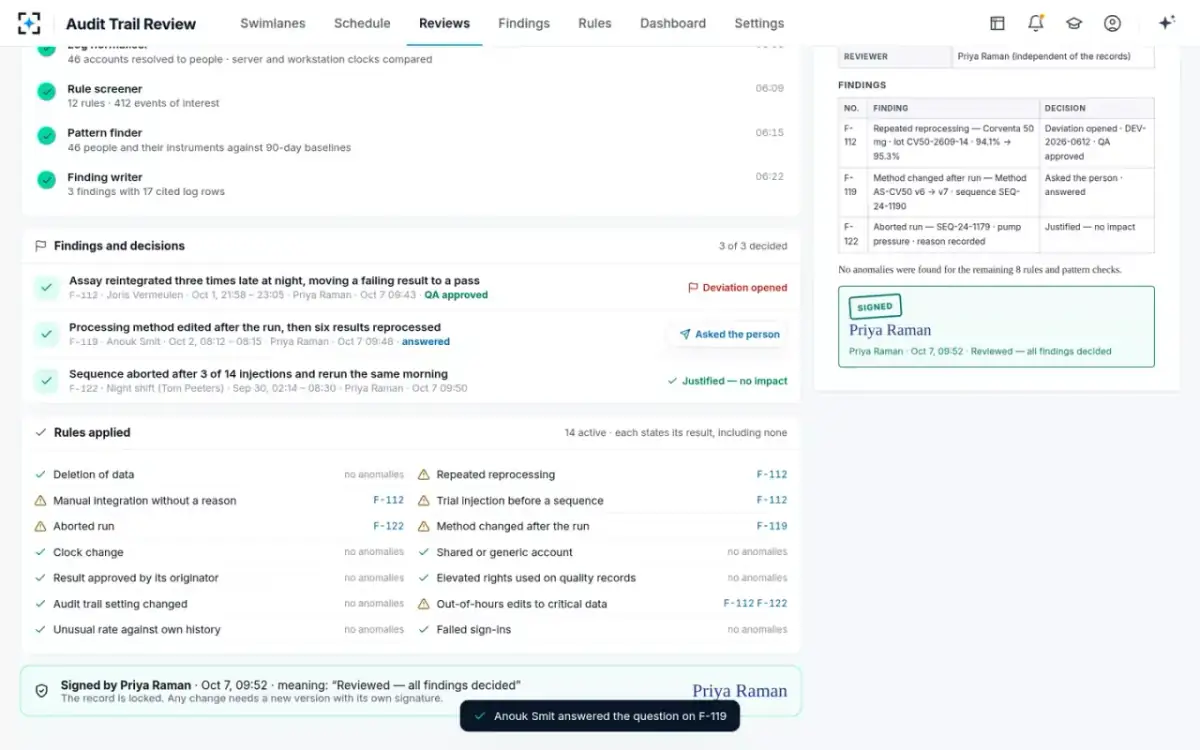

- 09Signed
Each finding decided, then the record signed and locked
Data integrity leadOn the first chromatography system's record for the week, the reintegration finding is now a deviation QA has approved. The lead accepts the suggestions for the medium and low findings. The analyst will be asked why a method version was used before it took effect. The aborted run is justified. The lead signs with the meaning “Reviewed: all findings decided”. Each rule states its result. For the 8 rules and pattern checks that found nothing, “no anomalies” is written down.
“The record is locked. Any change needs a new version with its own signature.”
