- Before
- Owns the statement's controls and the relationship with the assurer, and hears about the weak figures in fieldwork, two weeks before publication.
- Now
- Sees the likely findings before the assurer does: opens each weak figure's layers, decides the findings, assigns fixes and approves them once the agents verify.
Scope 2 location-based, weak at the source, fixed before fieldwork
The group's sustainability statement for the year is in draft. The assurer starts limited-assurance fieldwork in 21 days, applying ISSA 5000 early as agreed in the engagement letter. Here is one working day, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

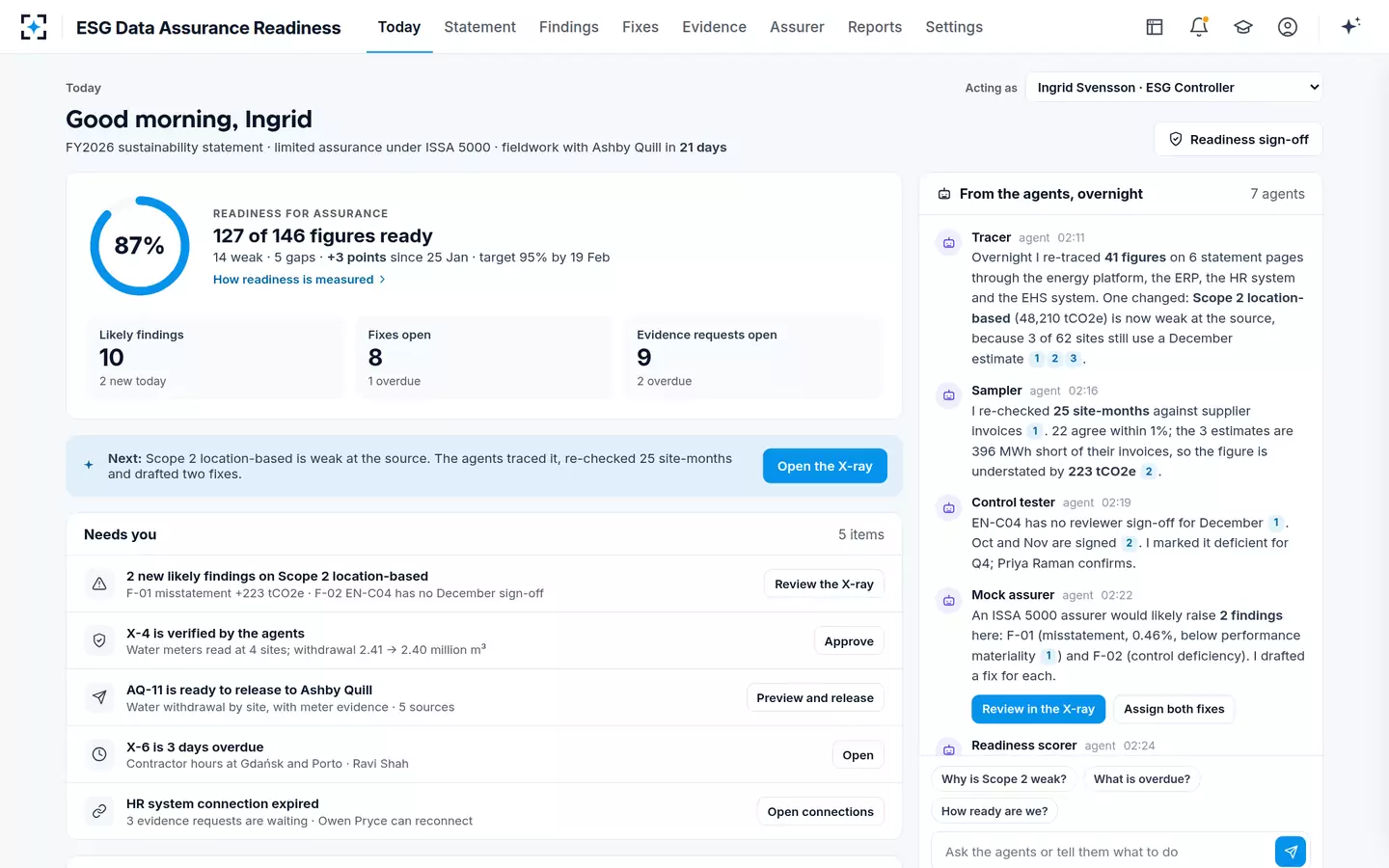

- 01Morning
The agents worked overnight, and the controller reads what they found
ESG controllerReadiness is 87%: 127 of 146 figures ready, 14 weak, 5 gaps, up 3 points in a week against a target of 95%. In the overnight thread the Tracer reports that it re-traced 41 figures on 6 statement pages and one changed: Scope 2 location-based, 48,210 tCO2e, is now weak at the source. Five items need the controller, from two new likely findings to an expired HR system connection.
“Next: Scope 2 location-based is weak at the source. The agents traced it, re-checked 25 site-months and drafted two fixes.”
- 02One click

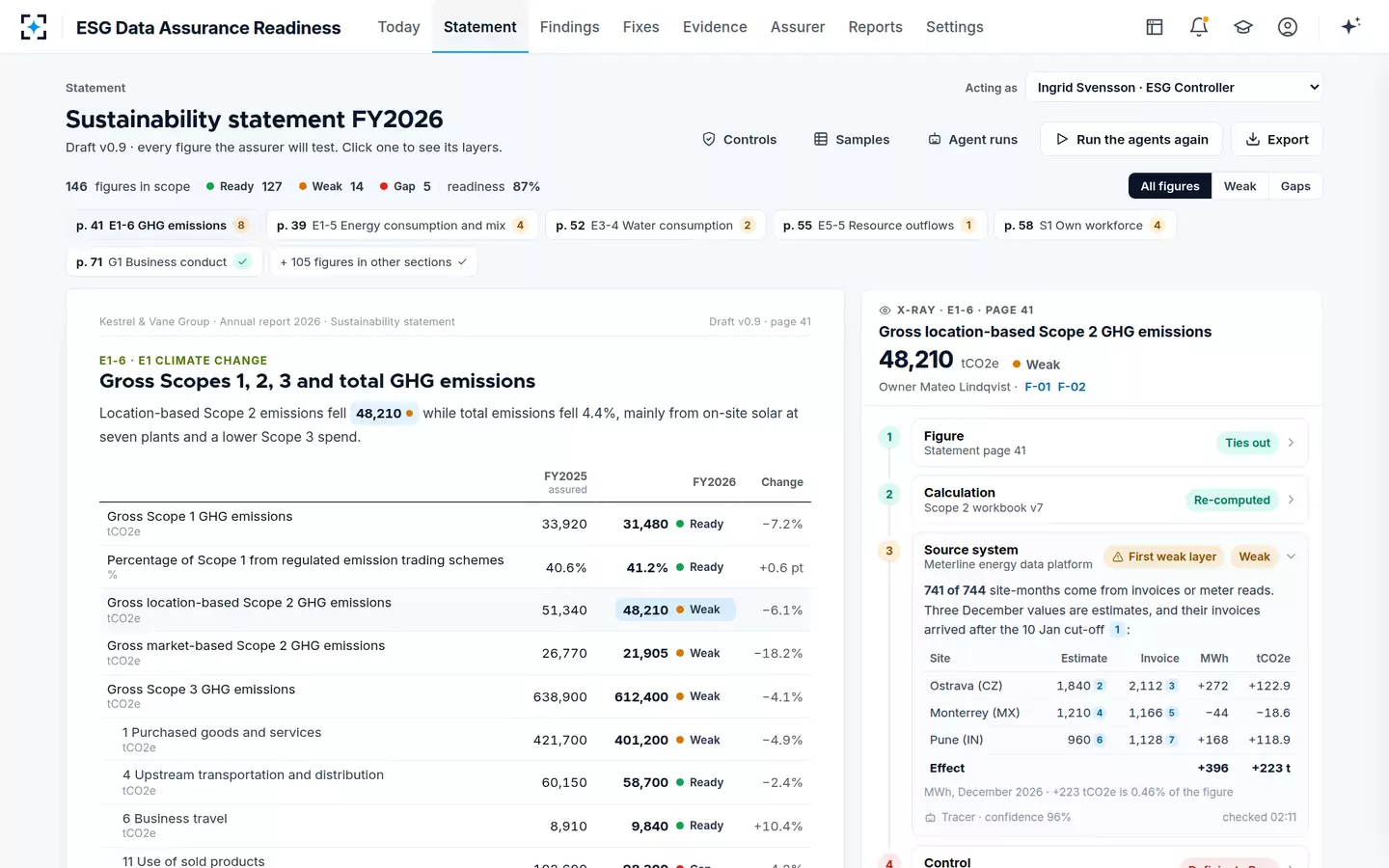

The statement page, with the figure's X-ray beside it
ESG controllerThe controller works from page 41 as it will be published, E1-6 Gross Scopes 1, 2, 3 and total GHG emissions, with each figure marked Ready, Weak or Gap. Clicking 48,210 opens its five layers: the figure ties out, the Scope 2 workbook re-computes, and the source system is the first weak layer. 741 of 744 site-months come from invoices or meter reads; three December values are estimates whose invoices arrived after the data cut-off.
Tracer · confidence 96%. Read-only on each system, it does not change a reported figure.
- 03A plain question
Which sites are estimated, answered with the sources
ESG controller and the TracerThe controller asks under the figure, in plain words. The Tracer answers with the three sites and their numbers: a plant at 1,840 MWh against an invoice of 2,112, a distribution center at 1,210 against 1,166, a service center at 960 against 1,128. Each value carries a numbered citation that opens the passage it was read from. Above it, the Mock assurer's two proposed fixes wait for a decision.
“All three invoices arrived after the data cut-off.”
- 04Overnight

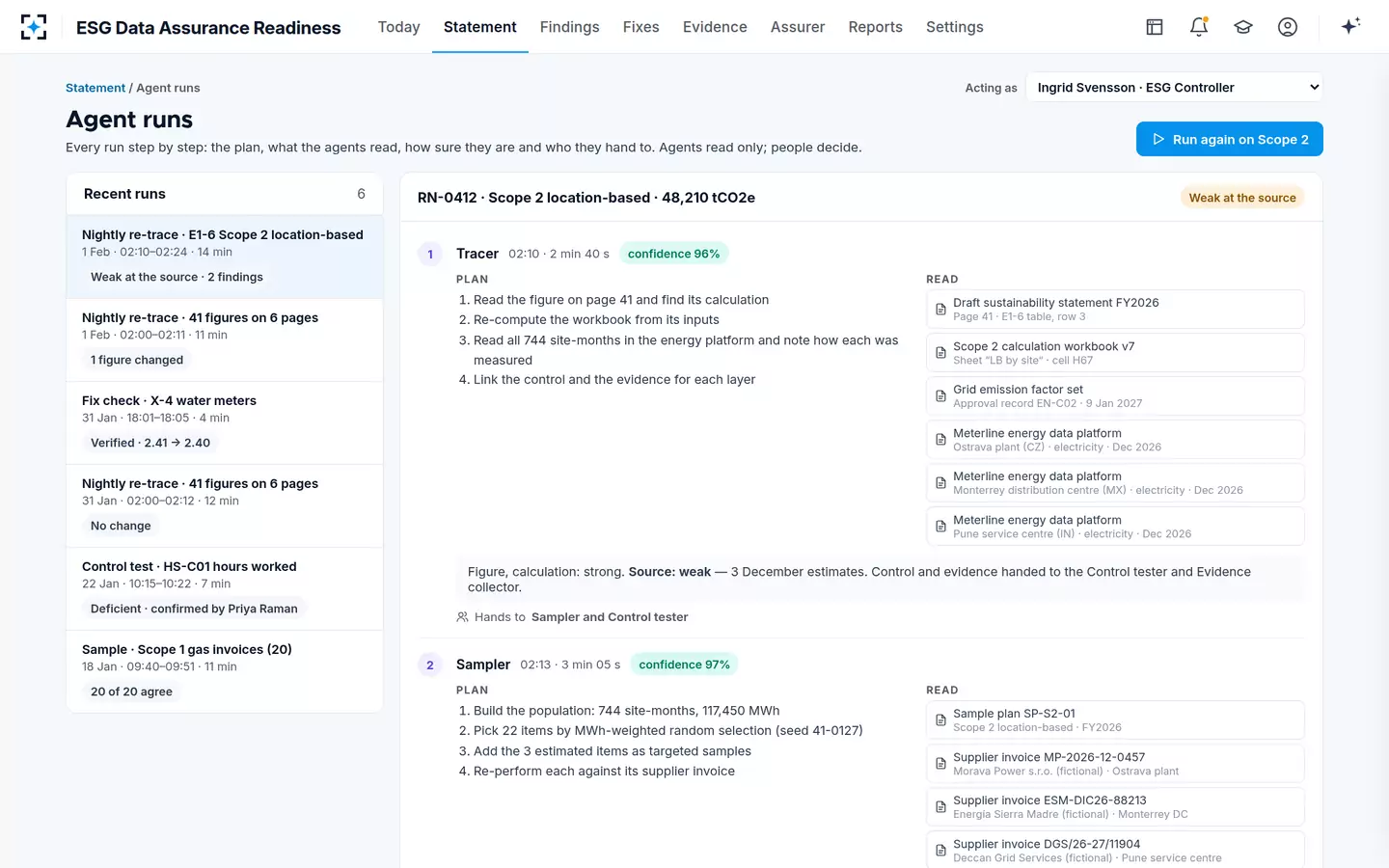

The overnight run, step by step
The agentsThe run took 14 minutes. Each agent shows its plan, what it read, how sure it is and who it handed to. The Tracer read the statement, the workbook, the grid factor set and the three sites' energy records in 2 min 40 s, then handed the control and evidence layers to the Sampler and the Control tester.
“Agents read only; people decide.”
- 05During the run

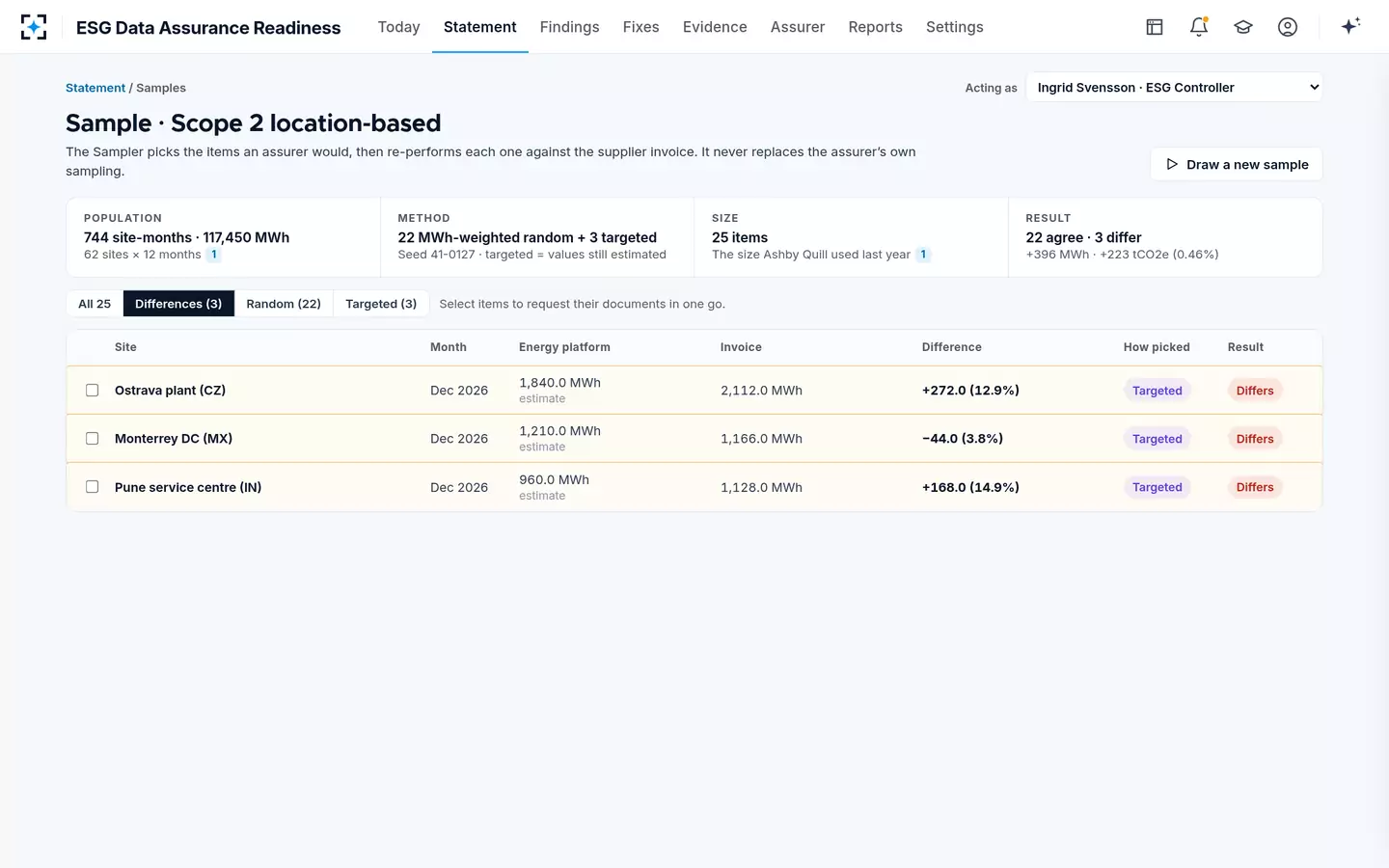

25 site-months re-performed against supplier invoices
SamplerFrom a population of 744 site-months and 117,450 MWh, the Sampler picked 22 items by MWh-weighted random selection and added the 3 estimates as targeted items, the sample size the assurer used last year. The 22 agree within 1%. The 3 targeted items differ by +272, −44 and +168 MWh: +396 MWh, or +223 tCO2e, 0.46% of the figure.
It reports each difference, however small, and does not replace the assurer's own sampling.
- 06During the run

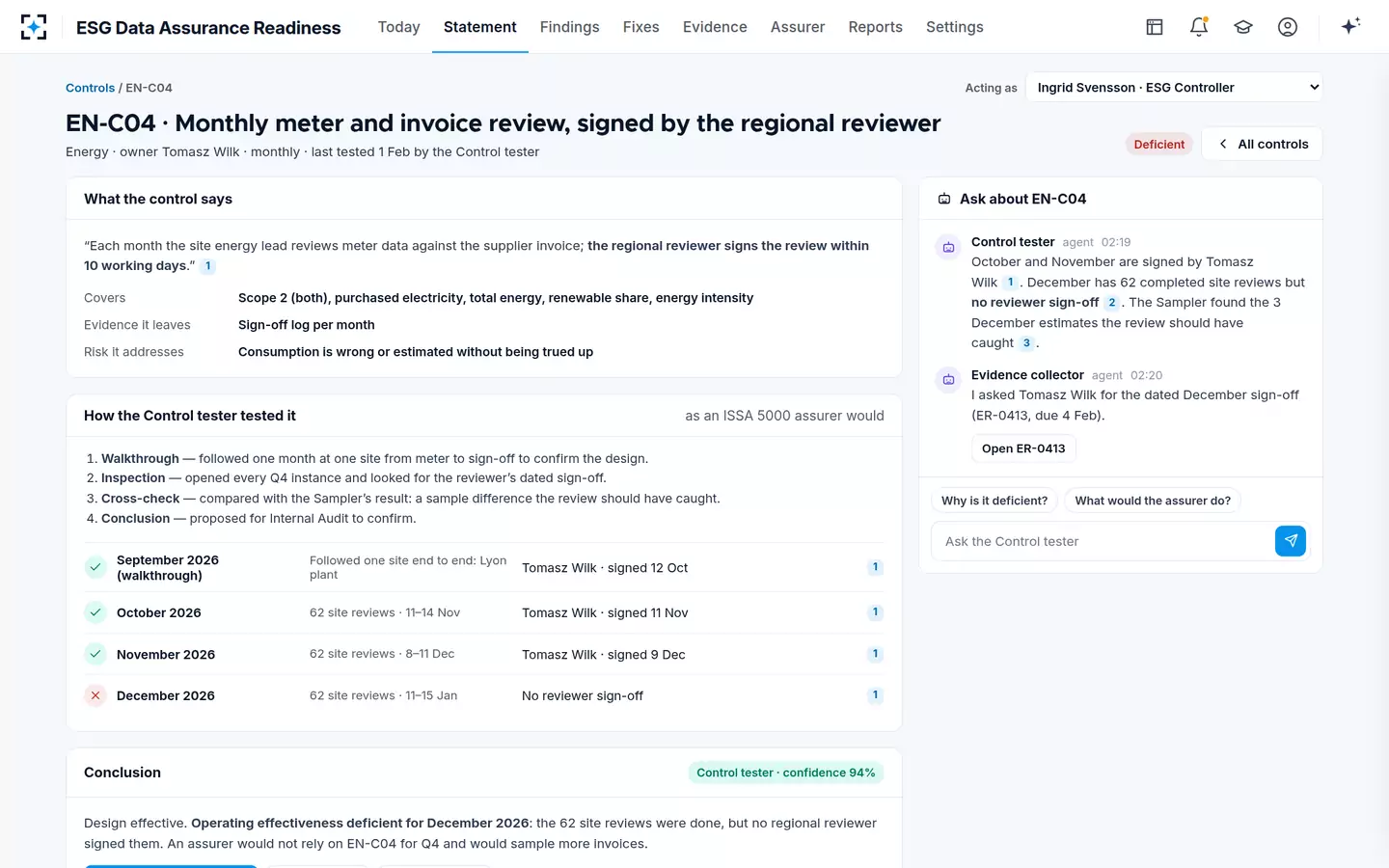

The monthly review control: designed well, unsigned in December
Control testerThe control says the regional reviewer signs each monthly meter and invoice review within 10 working days. The Control tester followed one site through the whole review, then inspected each Q4 instance: October and November are signed by the reviewer. For December the 62 site reviews were done, but no reviewer sign-off is recorded. Design effective; operating effectiveness deficient for December.
Control tester · confidence 94%. It proposes the conclusion; Internal Audit confirms it.
- 07End of the run

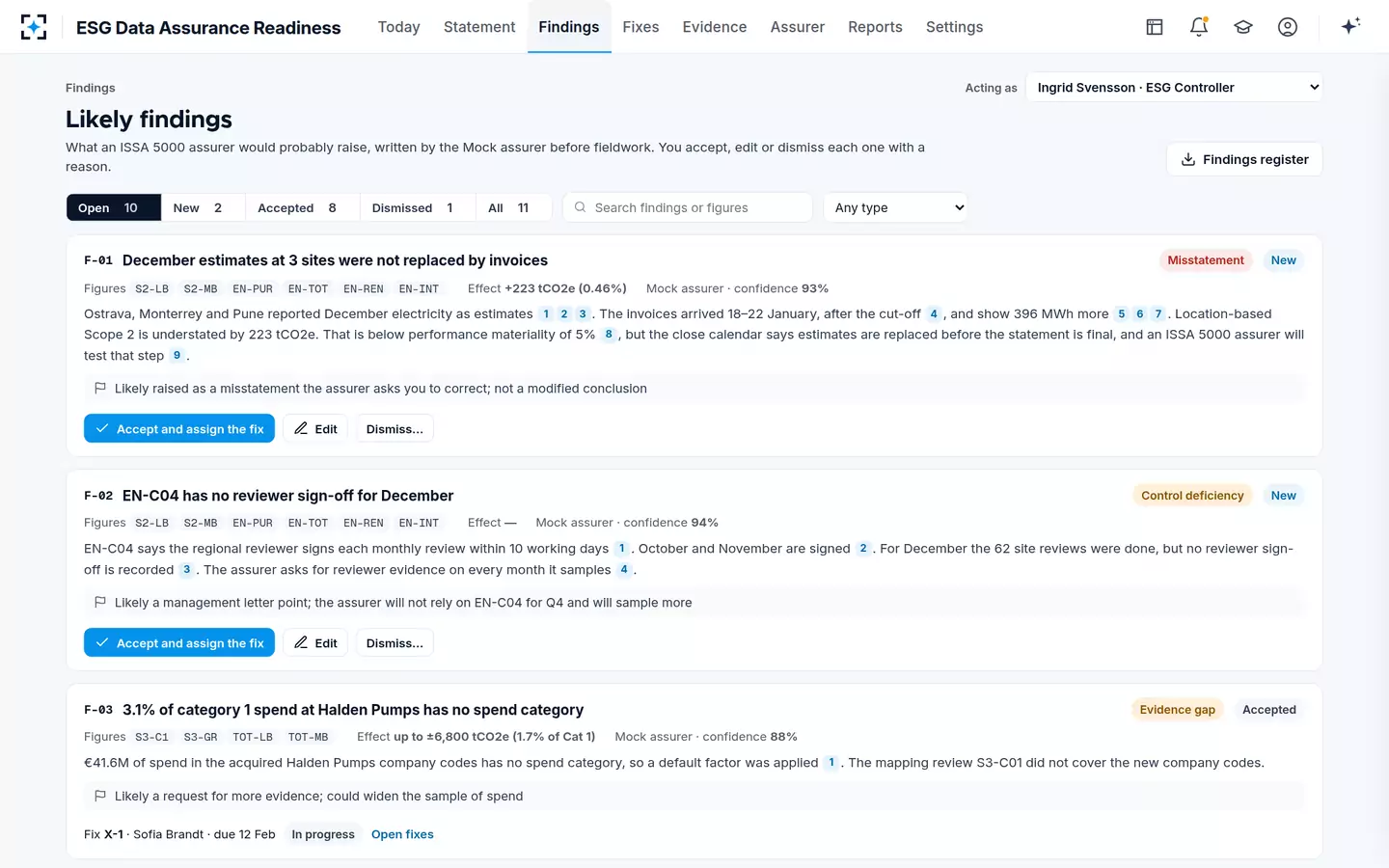

The findings an ISSA 5000 assurer would likely raise
Mock assurerThe first, a misstatement: December estimates at 3 sites were not replaced by invoices, +223 tCO2e, below performance materiality of 5% but a step the assurer will test. The second, a control deficiency: the monthly review has no reviewer sign-off for December. Each carries its basis, the figures it touches, its confidence and the likely outcome. The controller can accept, edit or dismiss each one with a reason.
On the misstatement: “Likely raised as a misstatement the assurer asks you to correct; not a modified conclusion.”

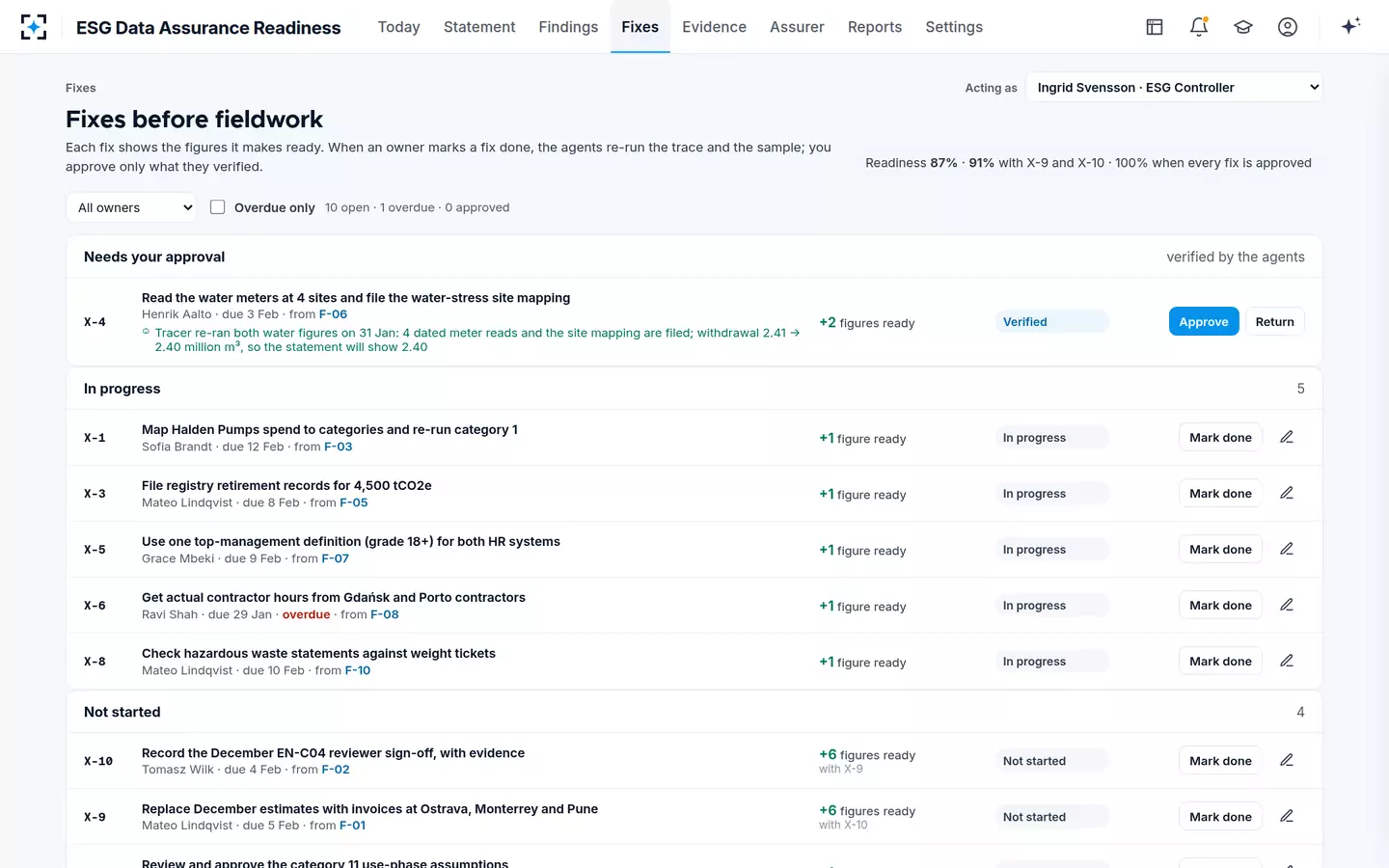

- 08Mid-morning

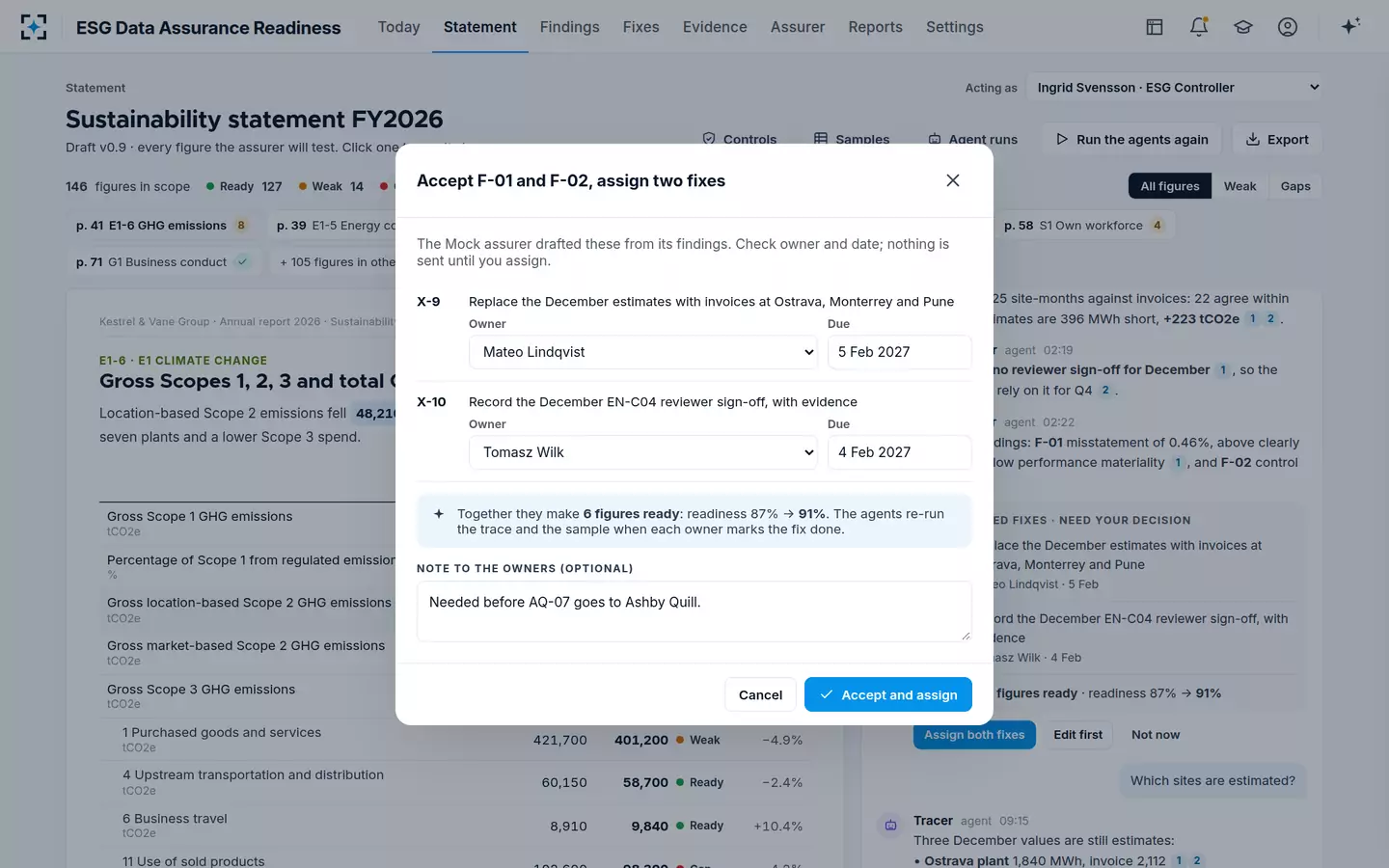

Both findings accepted, and two fixes assigned
ESG controllerOne fix, replacing the December estimates with invoices at the three sites, goes to the sustainability data owner with a due date. The other, recording the December reviewer sign-off with evidence, goes to the regional reviewer. Before confirming, the controller sees what they are worth: 6 figures ready, readiness 87% → 91%. The Evidence collector notifies both owners.
“The agents re-run the trace and the sample when each owner marks the fix done.”
- 09Nothing unseen

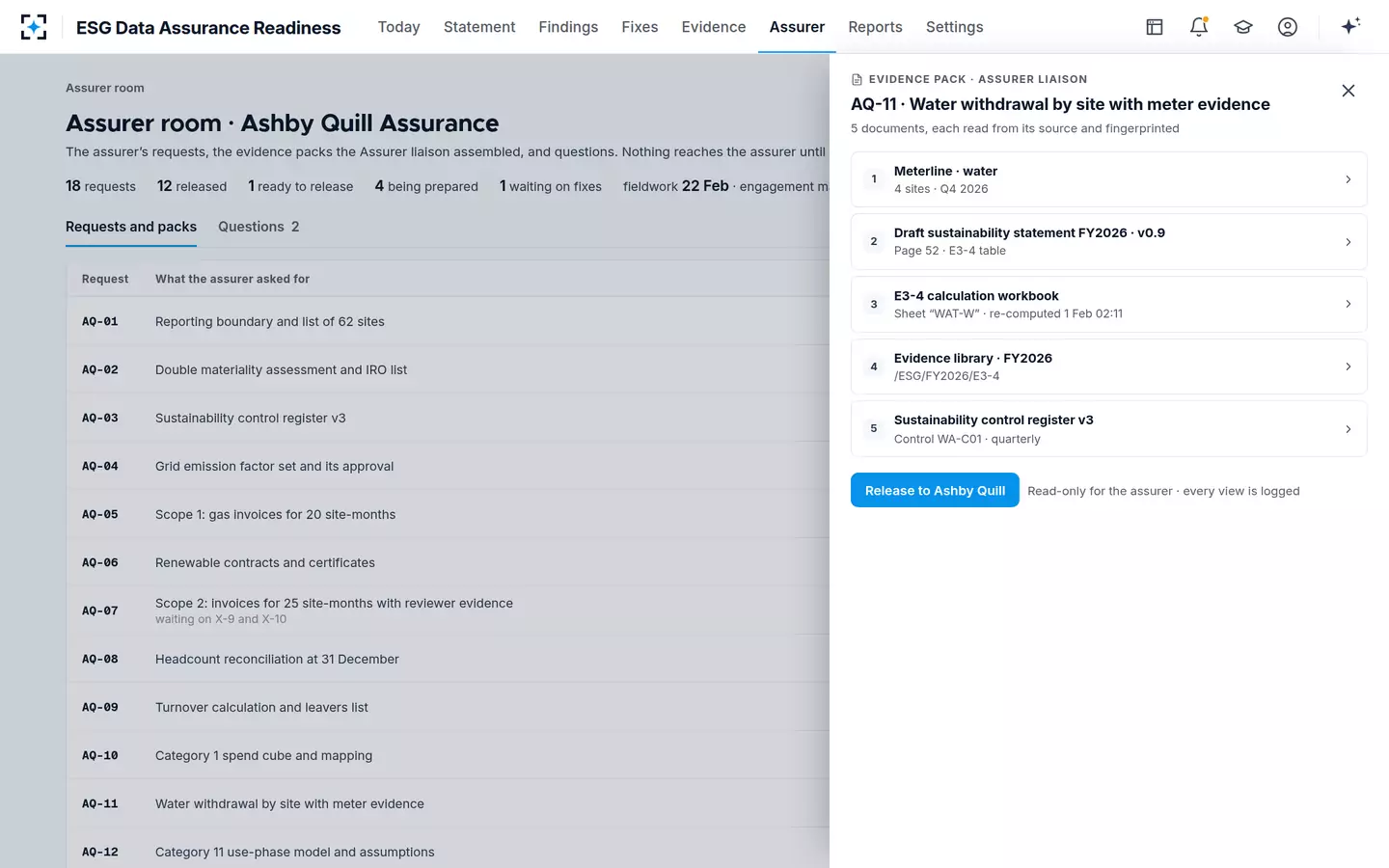

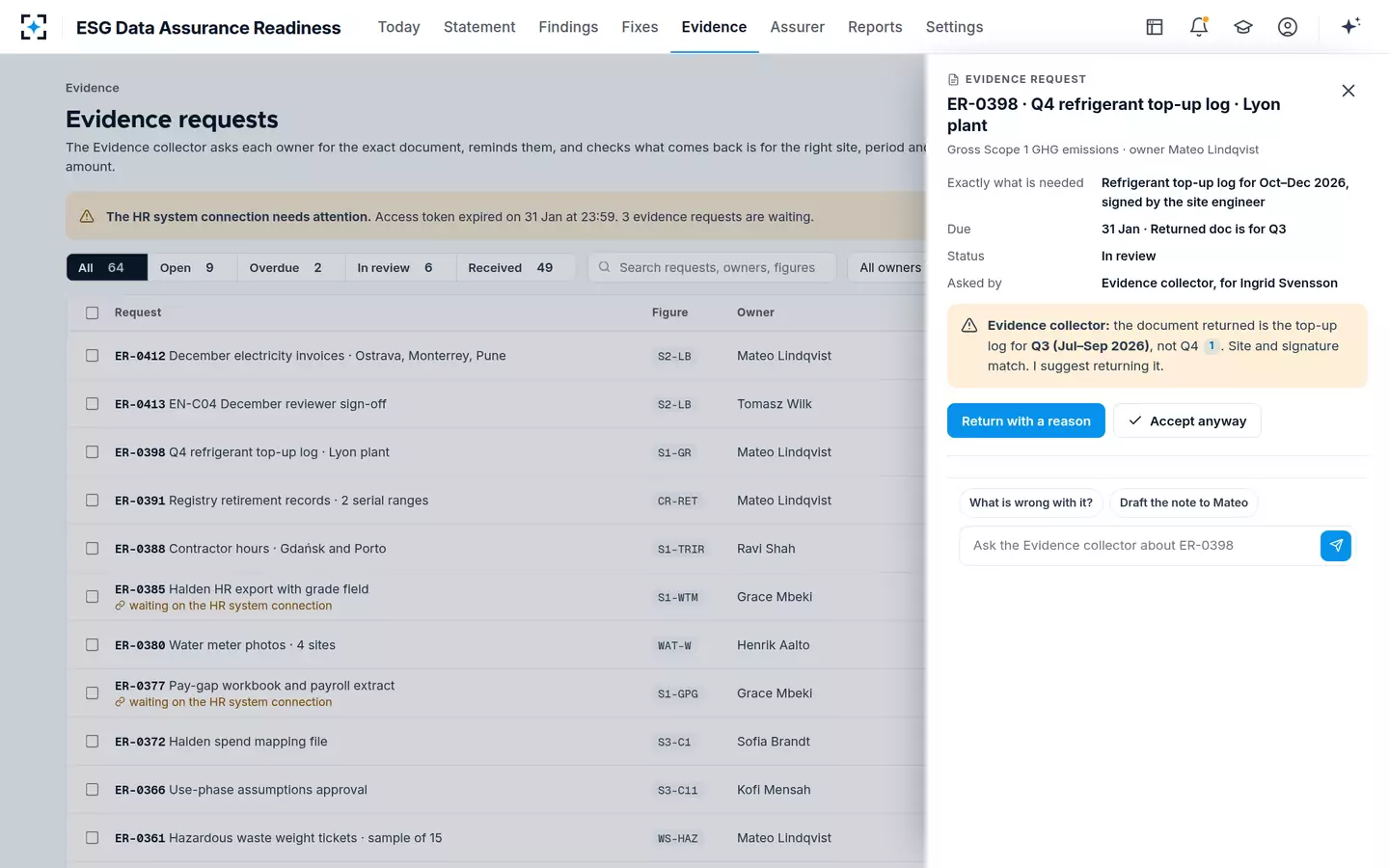

Evidence goes to the assurer only once it is released
ESG controller and the Assurer liaisonIn the assurer room the Assurer liaison has assembled a pack for each of the assurer's 18 requests: 12 released, one waiting on the two fixes. The controller previews the request for water withdrawal by site with meter evidence: five documents, each read from its source and fingerprinted, and releases it to the assurer read-only.
“Read-only for the assurer · each view is logged.”

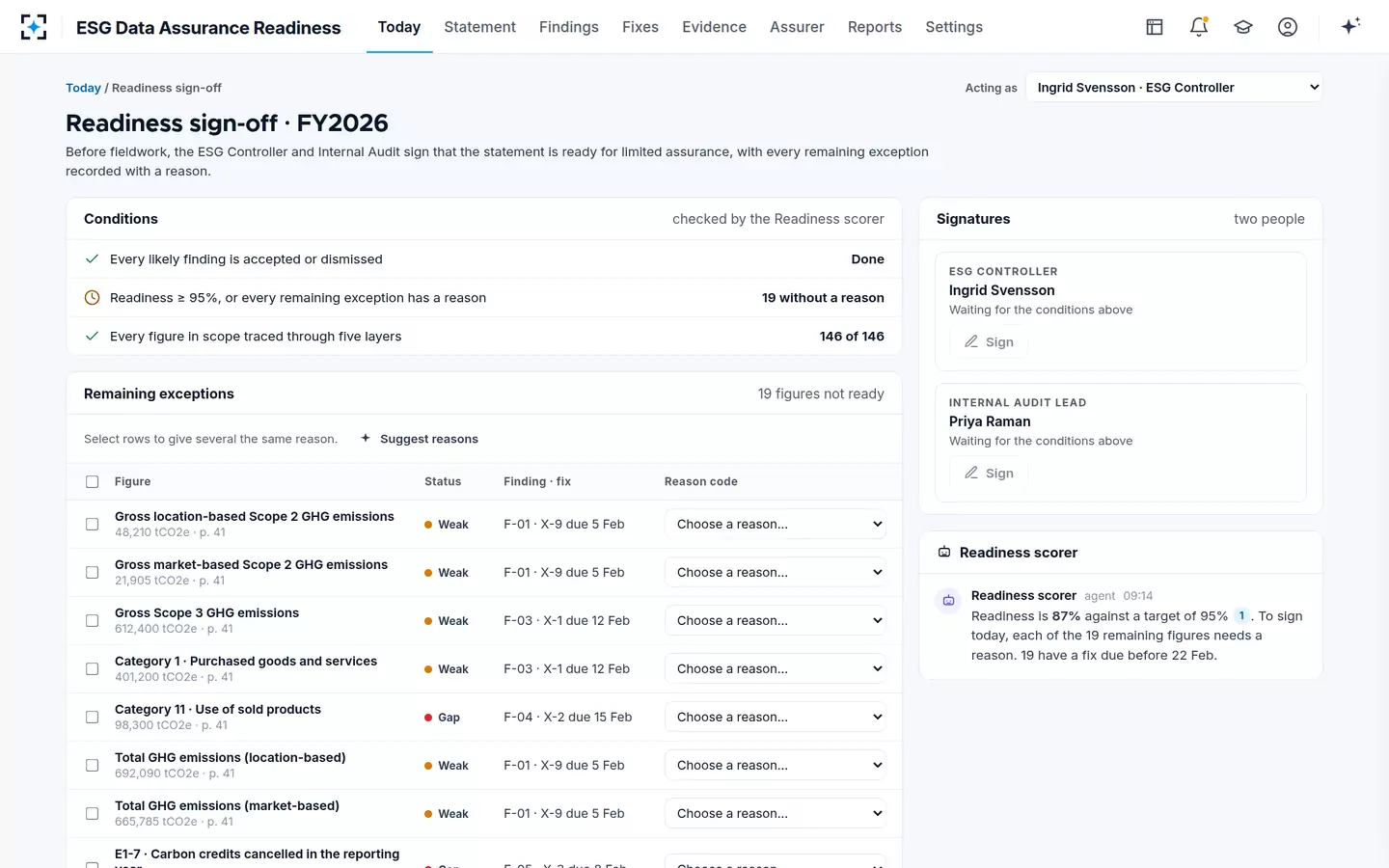

- 10Before fieldwork
Two people sign readiness, with each exception on record
ESG controller and internal audit leadThe Readiness scorer checks the conditions: each likely finding accepted or dismissed, each figure in scope traced through five layers, and readiness at 95% or a reason code on each remaining exception. Nineteen figures are not yet ready, each with its finding and a fix due before fieldwork. Once each has a reason code, the ESG controller and the internal audit lead sign.
Signature meaning: “Ready for limited assurance fieldwork, exceptions recorded.”
