- Before
- Wants to know which market runs out first, and the email that says so. Today finds out from four systems and a mailbox, usually after the fact.
- Now
- Opens the radar to markets ranked by weeks to stock-out, each driver one click from its record. Confirms or dismisses, and signs the plan.
A CMO delay notice moves one market from watch to stock-out risk
A drug maker tracks seven critical medicines in 48 product-markets. A product-market is one product in one country. At 09:18 one morning, the contract manufacturer that fills its pens emails a delay notice. The late lot fills one biologic's 40 mg pen for Germany. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning
The shortage radar, with one notice not read yet
Supply continuity lead, Europe and InternationalEach sector of the radar is a product, and each dot is a market. The distance from the center shows the weeks until the projected stock-out. The 05:42 sweep has scored all 48 product-markets. The 40 mg pen in Germany is already an open alert at risk 61. It drops below safety stock in the coming weeks, with lowest cover of 0.6 weeks, but no stock-out is projected. Above the radar, a delay notice for one lot has arrived from the contract fill-finisher. It is marked not read yet.
Drivers, ranked by weeks of cover lost. One lot on QA hold −1.7 wk · one shipment quarantined −1.1 wk · a regional tender adds 18% demand −0.8 wk.
- 02The next 16 weeks

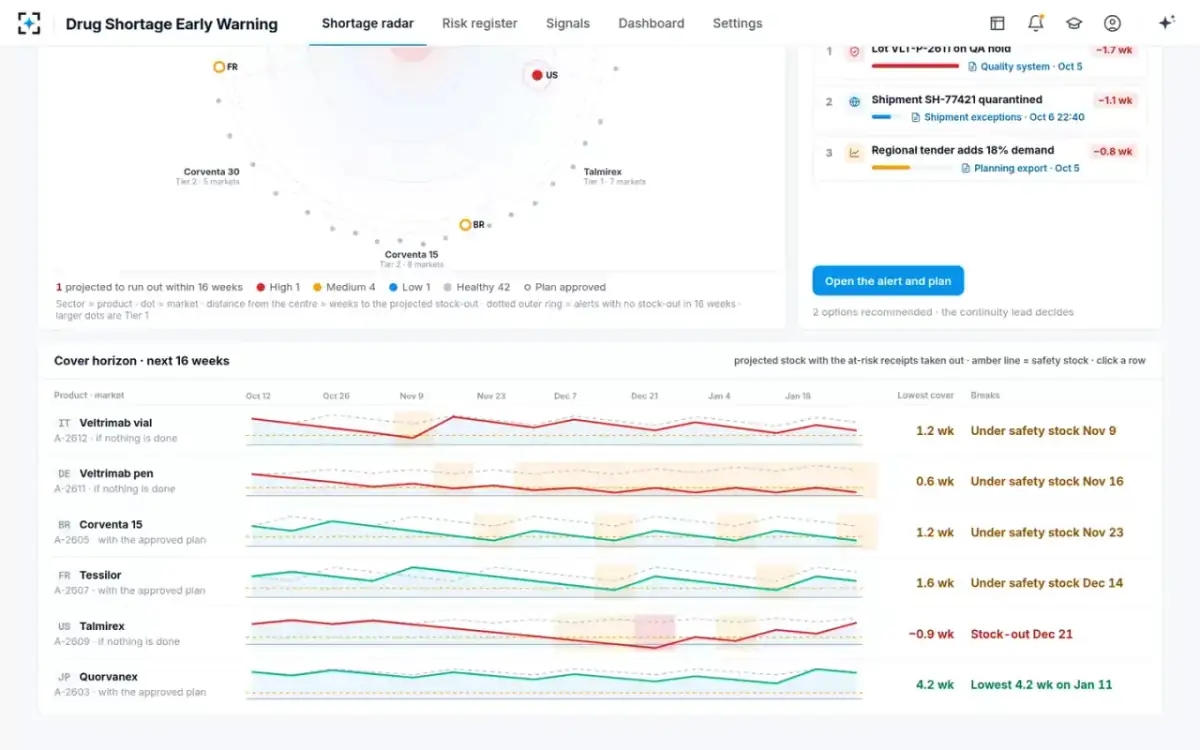

The open alerts on one cover horizon
Supply continuity leadBelow the radar, each alert's projected stock runs week by week, with the at-risk deliveries taken out. Safety stock is the amber line. The same biologic's 80 mg vial in Italy falls below safety stock. A 100 mg/10 mL vial in the US runs out if nothing is done. Three more products, in Brazil, France and Japan, are shown with their approved plans.
- 0309:24 · one click
“Read it now”: the notice is read and the dot moves
Supplier & CMO notice readerThe notice reader reads the email on screen. It pulls out the lot, the dates and the quantity. The lot's fill date has moved, so 6,000 pens ship three weeks late. The reader matches the lot to the German pack, and the risk scorer rebuilds the projection. Germany rises from risk 61 to 86. Its dot moves inward to the 8-week ring and turns red.
“Runs out in 54 days · 7.7 weeks if nothing is done.”
- 04The source

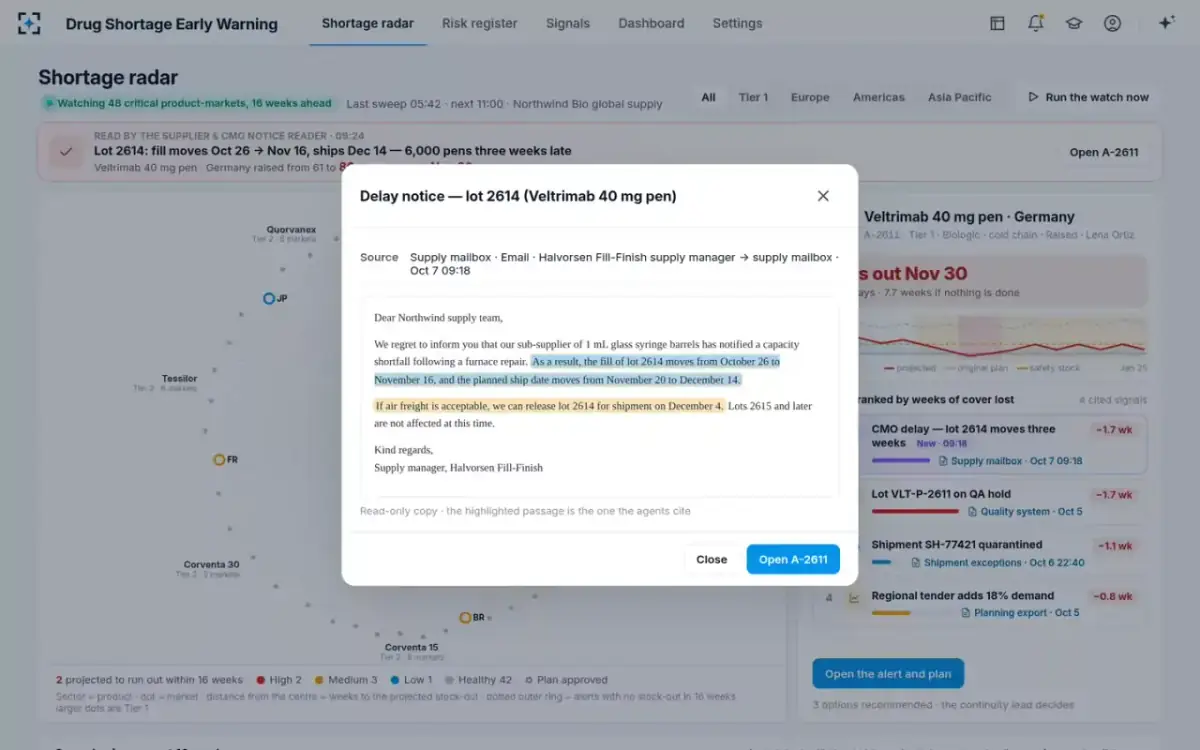

The CMO's own words, highlighted
Supply continuity leadThe CMO delay is now driver 1, with a citation to the supply mailbox at 09:18. Opening it shows the email, with the passage the agents cite highlighted. The cause is a shortfall of syringe barrels at the CMO's own supplier, after a furnace repair. A second passage offers a way out. The lot can ship sooner if air freight is acceptable.
“Read-only copy · the highlighted passage is the one the agents cite.”
- 05The alert
Three supply events and a tender on the same six weeks
Risk scorerThe alert ranks four drivers, each with its record. The CMO delay costs 1.7 weeks of cover. So does a second lot of 6,000 pens, held by QA for visible particles found at AQL inspection, a standard sampling check. A shipment was quarantined after its temperature logger read 9.4 °C for 47 minutes, which costs 1.1 weeks. The health-insurer tender adds 560 pens a week of demand. The projected stock-out is 54 days away, with lowest cover at −0.5 weeks.
“Agents raise alerts. A person confirms or dismisses.”
- 06Trying options
Six options, three recommended, each with its effect on cover
Mitigation planner and notice writerThe planner drafts options from the network. Each has an owner, a cost and the weeks of cover it buys. One option moves 4,200 pens from the Netherlands and Austria (+1.2 wk). Another gives QA priority to the deviation, the open quality investigation, so 5,400 pens release sooner (+1.5 wk). A third sends the delayed lot by air freight (+1.7 wk). With the recommended set, the projected stock-out goes away. Lowest cover rises from −0.5 to 1.8 weeks.
“Moves 24% of Austria’s buffer. The head of supply-chain risk approves.”
- 07Signed

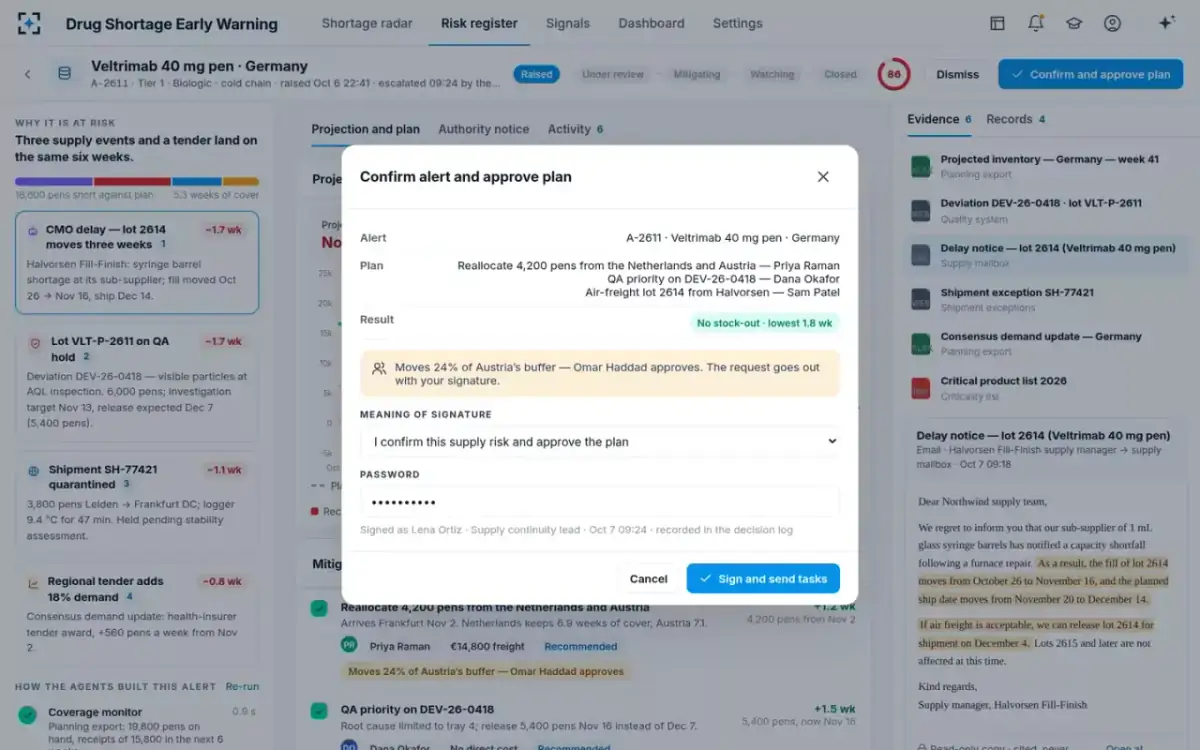

The continuity lead confirms the risk and approves the plan
Supply continuity leadThe confirmation shows the alert, the three options with their owners and the result: no stock-out, and lowest cover of 1.8 weeks. The continuity lead signs with a password and the meaning “I confirm this supply risk and approve the plan”. Austria gives more than a fifth of its buffer. So a request for a second approval from the head of supply-chain risk goes out with the signature.
“Signed by the supply continuity lead · 09:24 · recorded in the decision log.”
- 08Plan in motion
Tasks go to their owners, and no authority notice is needed
Mitigation planner and notice writerThe decision is recorded, and tasks go out. The reallocation goes to its named owner. QA priority goes to the QA release lead, and air freight to the global supply planner. A second approval waits with the head of supply-chain risk. No stock-out is projected, so no authority notice is needed, and the reason is recorded. The alert moves to Mitigating until cover stays above safety stock for four weeks.
- 09Meanwhile in the US
A US vial on the 506C clock, two business days left
Global supply planner, AmericasThe API supplier, the maker of the active ingredient, sends a force majeure notice. A reactor has shut down, and three API lots will be about six weeks late. That puts a 100 mg/10 mL vial in the US on course to run out. The authority notice tab counts the business days left. The notice writer drafts the 506C fields from the cited records, down to the reason, the expected duration and the contact.
“The notice writer drafts from the alert and its records. Regulatory affairs files.”

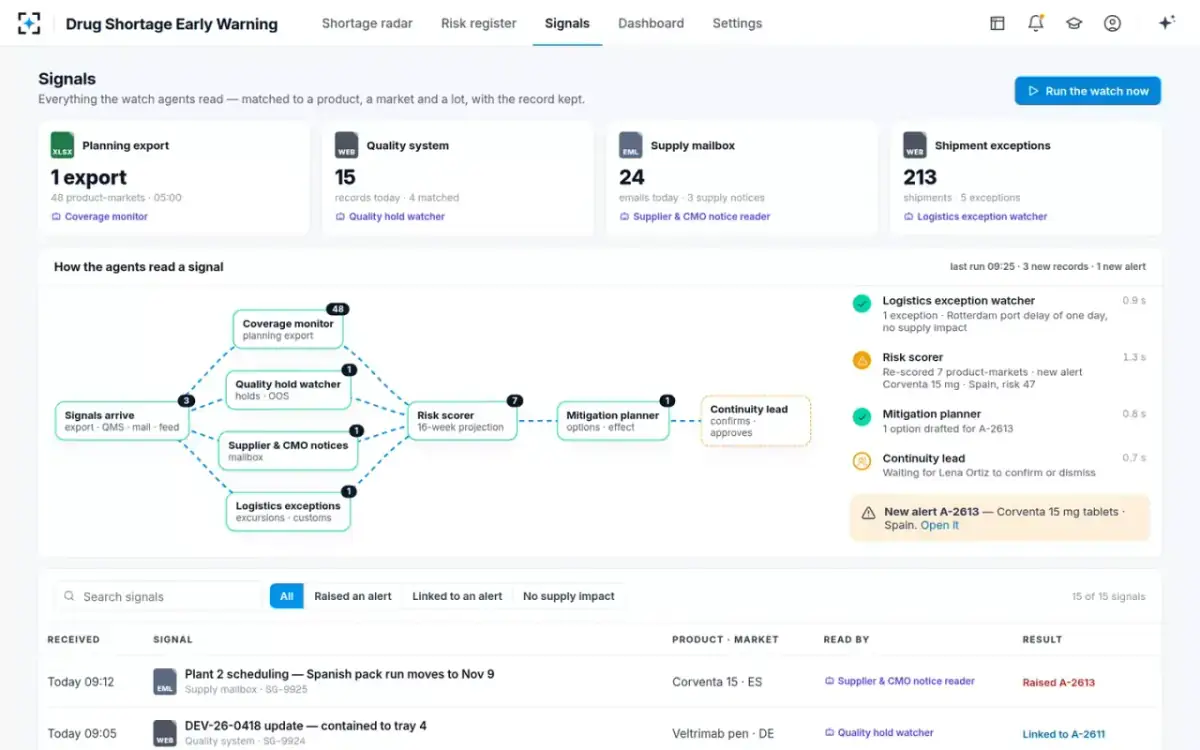

- 1009:25 · Run the watch
Three new records, one new alert
The watch agentsRunning the watch reads the latest signals in parallel. A one-day port delay has no effect on supply. An update on the deviation says it is contained to tray 4, and links it to the German alert. A schedule change at one plant moves the Spanish pack run of a 15 mg product. That raises a new alert at risk 47. The planner drafts one option, and the alert waits for the continuity lead to confirm or dismiss.
