- Before
- Chases owners from a spreadsheet of expiry dates for 1,412 contracts. Finds out about a notice period when it has already passed.
- Now
- Starts each morning from a ladder ordered by days left to give notice, with the agents' recommendation and the stage on each rung.
Contract renewal management on a BI platform with 19 days left for notice
The company has 1,412 contracts, and 638 renew themselves. Its business intelligence (BI) platform renews on the first of the month unless notice arrives 30 days before. Here is what happens on one morning, 19 days before notice is due, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0108:40
Each contract, ordered by days left to give notice

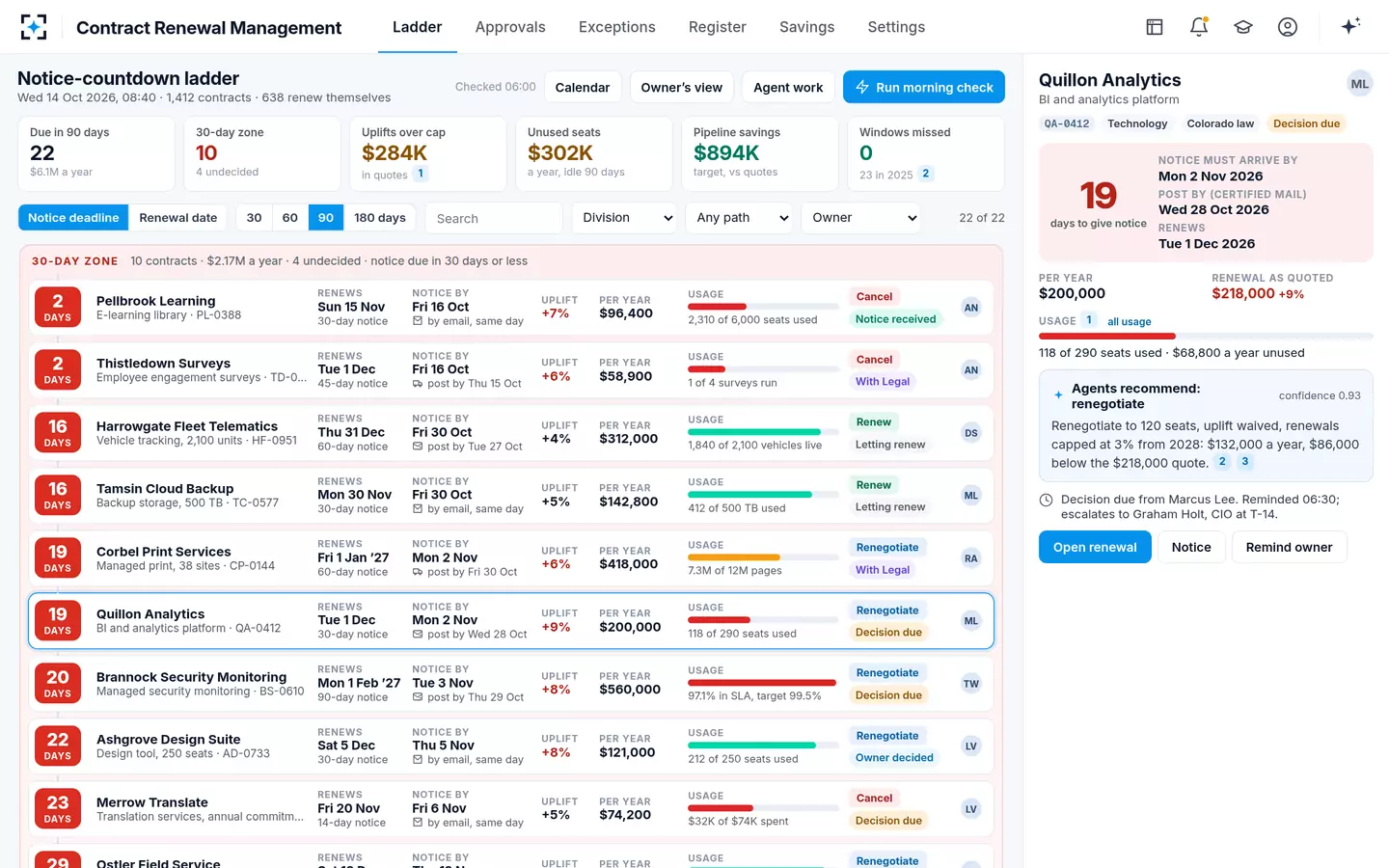

Procurement manager, renewalsThe procurement manager's home screen is a notice-countdown ladder. It lists 22 contracts due in 90 days and 10 in the red 30-day zone, 4 of them undecided. Above it sit three totals. Quotes carry $284K of uplifts over the cap, and $302K a year of seats have been idle for 90 days. No notice windows have been missed, against 23 last year. The BI platform sits at 19 days. Notice must arrive by a Monday, so the letter must be posted by the Wednesday before.
- 02One toggle
What a renewal-date tracker would have missed

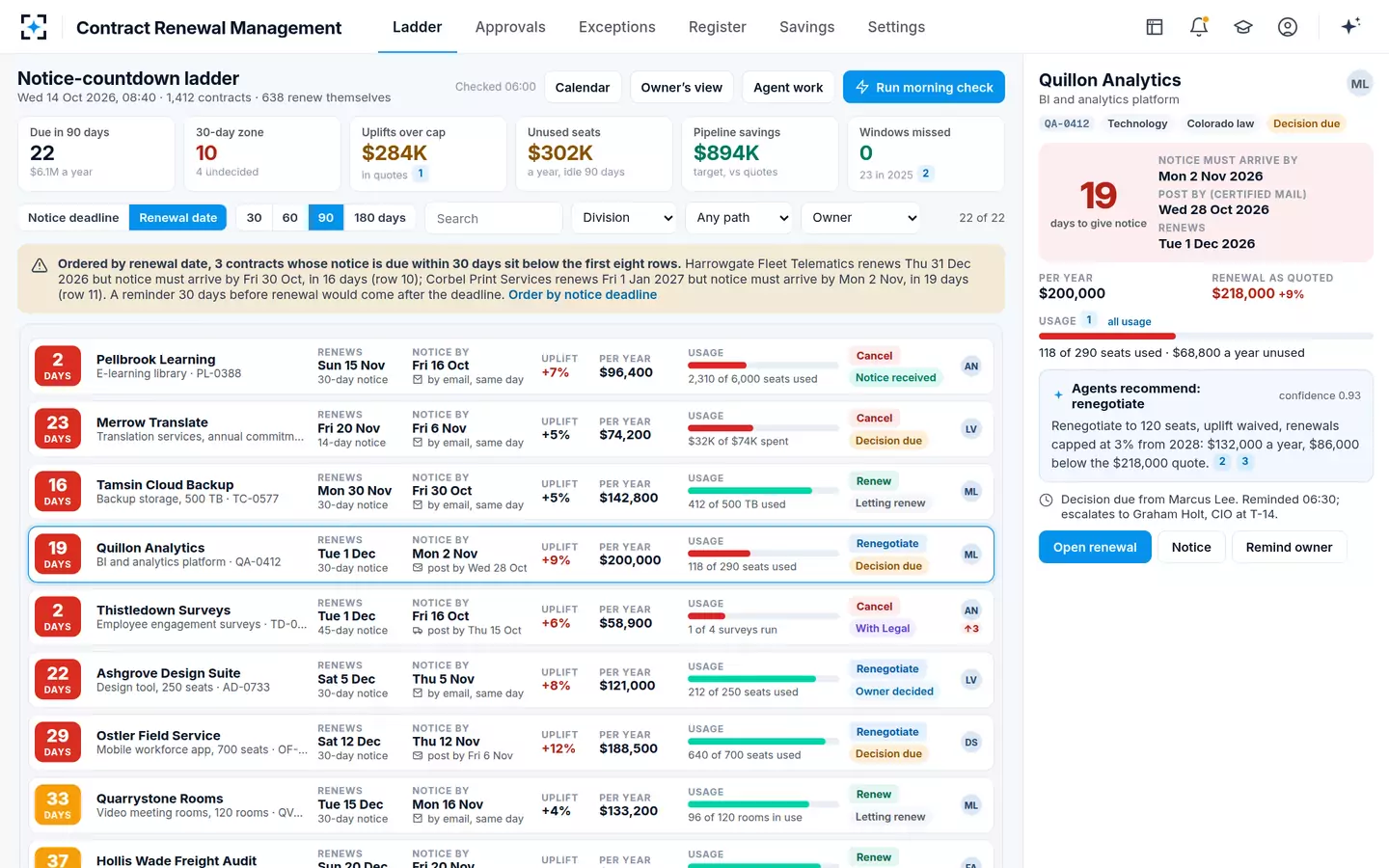

Procurement manager, renewalsOrdered by renewal date instead, the ladder shows the trap. Three contracts whose notice is due within 30 days sit below the first eight rows. A fleet telematics contract renews at the end of December, but its 60-day notice must arrive in 16 days. Rungs that move up when ordered by notice deadline are marked.
“A reminder 30 days before renewal would come after the deadline.”
- 0306:12, before anyone arrived

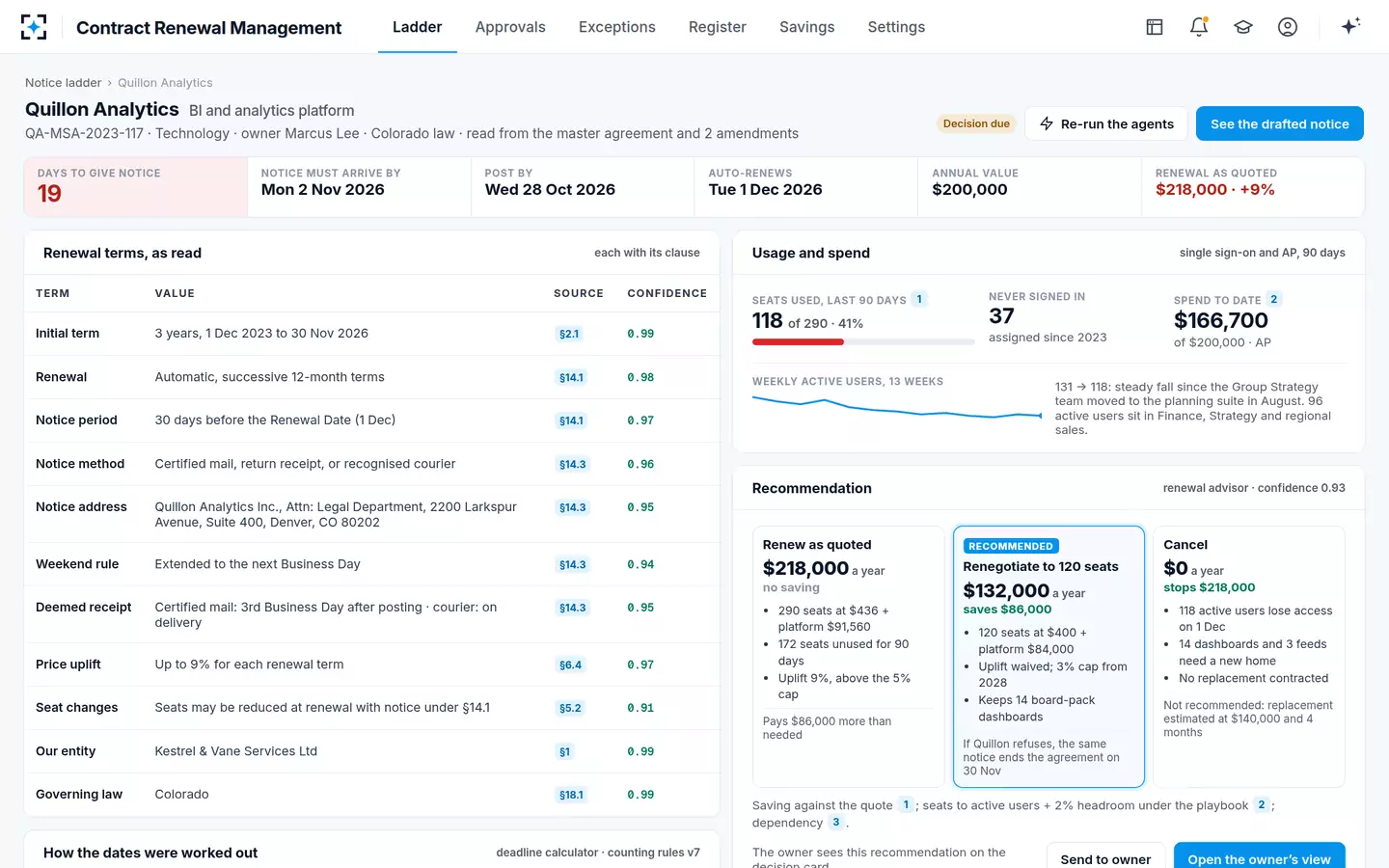

Eleven renewal terms, each with its clause
Renewal clause readerThe reader agent read the master subscription agreement and its two amendments. Renewals are automatic, for 12 months, under §14.1. Under §14.3, notice must arrive 30 days before the renewal date. It must go by certified mail with return receipt, or by recognized courier, to the vendor's legal department. Under §6.4, the price may rise by up to 9%. Each term shows its clause and a confidence score. The lowest is 0.91, on seat changes.
The reader does not guess a missing term. Below 85% confidence it raises an exception.
- 0406:13

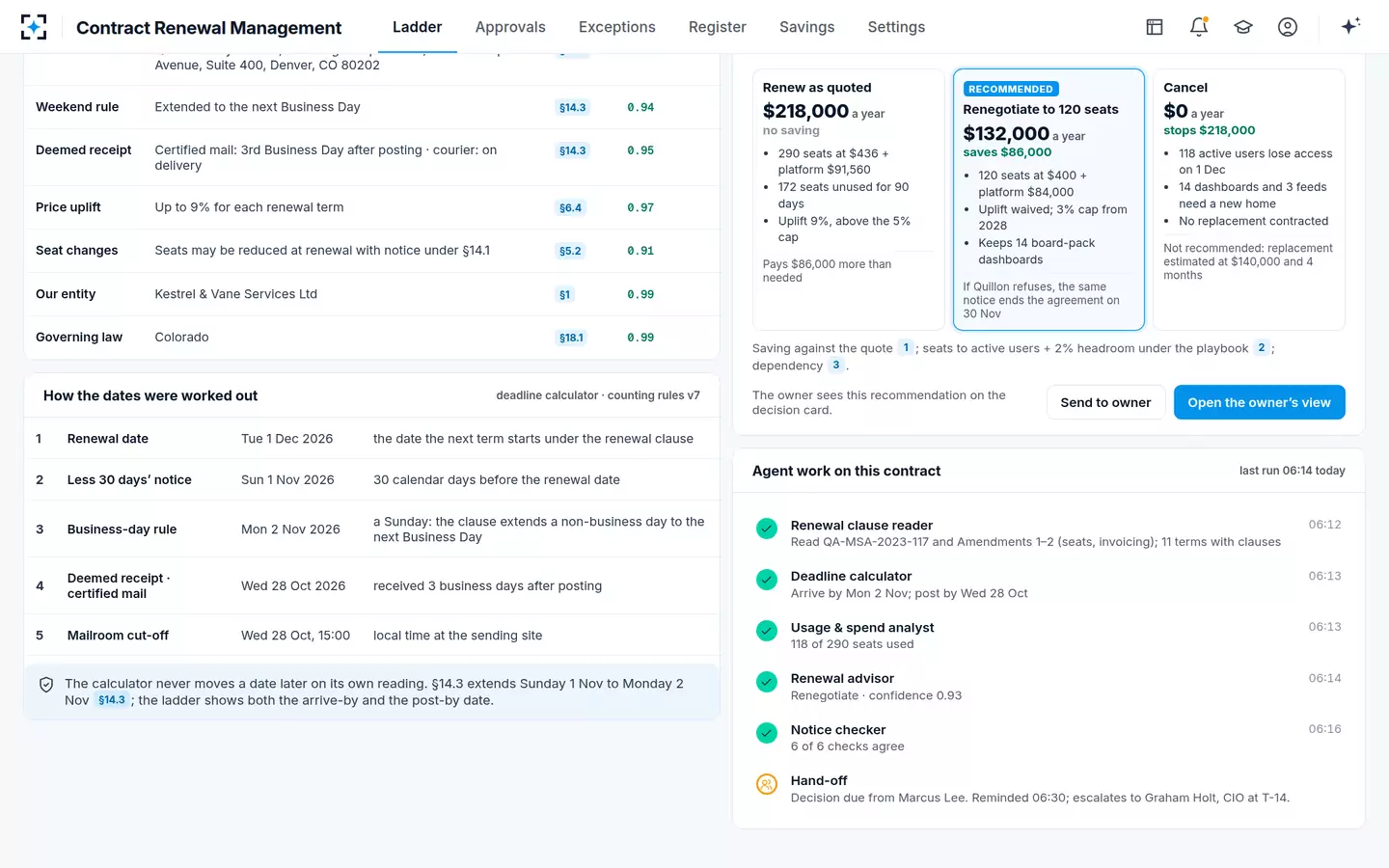

Two dates, worked out step by step
Deadline calculatorThe renewal date, less 30 days' notice, falls on a Sunday. Clause §14.3 moves a non-business day to the next business day, so notice must arrive by the Monday. Certified mail counts as received on the third business day after posting. So the letter must be posted by the Wednesday before, ahead of the 15:00 mailroom cut-off.
“The calculator does not move a date later on its own reading.”
- 0506:14

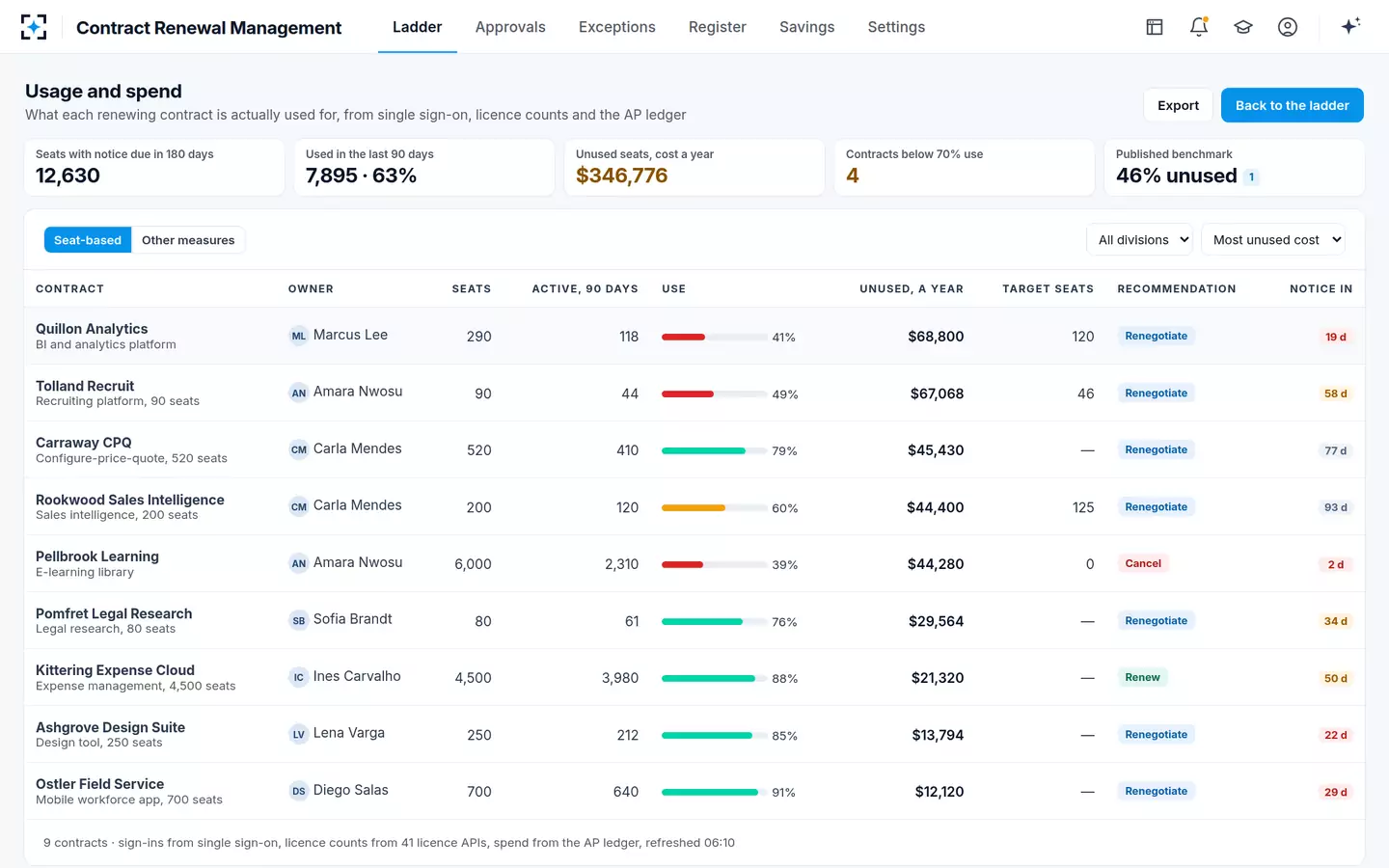

118 of 290 seats used, so renegotiate to 120
Usage & spend analyst and Renewal advisorSingle sign-on shows 118 of 290 seats active in 90 days, and 37 people never signed in. Spend to date is $166,700 of $200,000. The quote applies the full 9%, for $218,000. The advisor recommends renegotiating to 120 seats, with the uplift waived and a 3% cap on later renewals. That costs $132,000 a year, $86,000 below the quote, with confidence 0.93. Canceling is not recommended, because 14 board-pack dashboards and 3 data feeds read from the platform.
- 0606:16

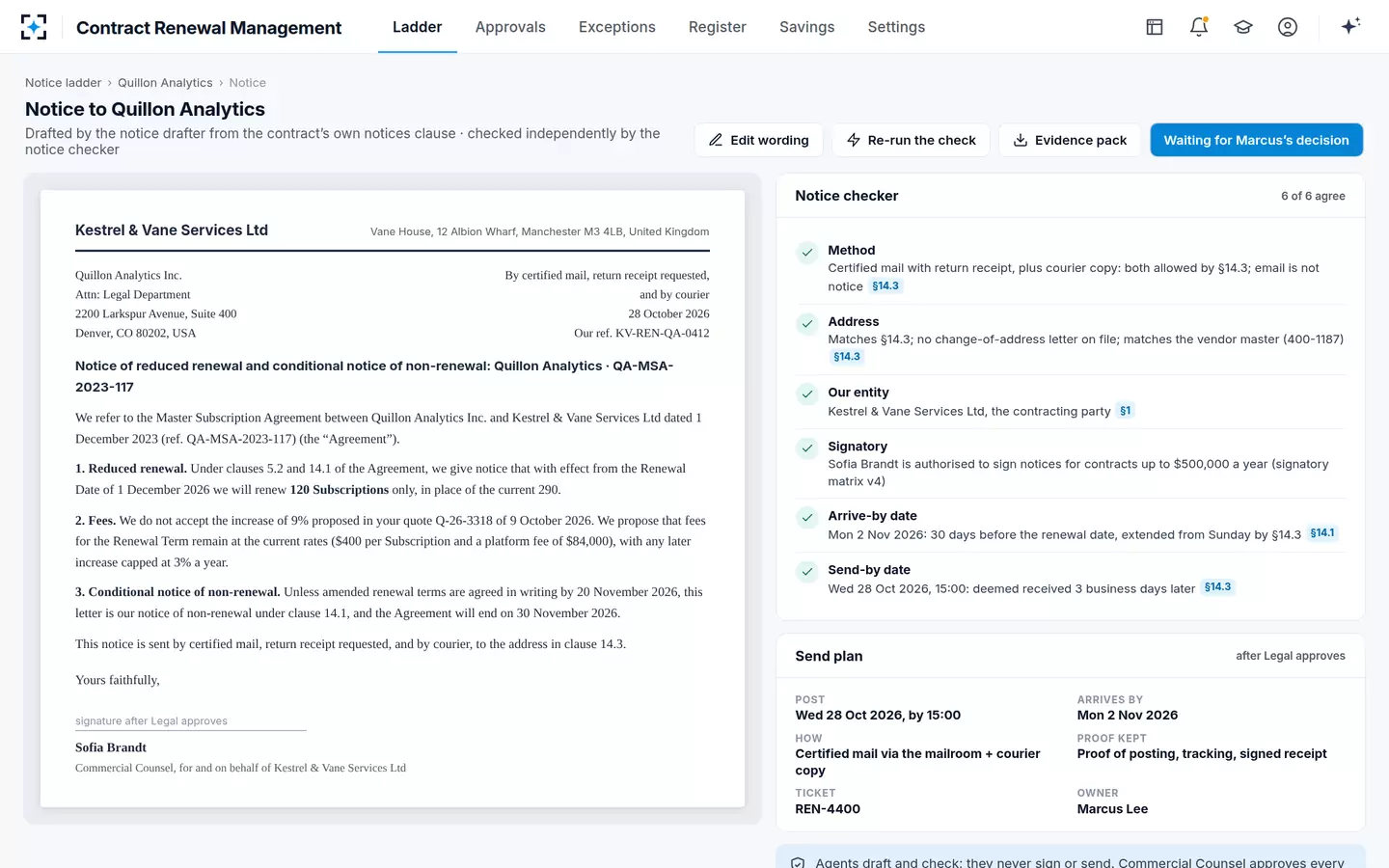

A notice in the clause's own form, checked by a second agent
Notice drafter and Notice checkerThe drafter writes a notice of reduced renewal and conditional non-renewal. It renews 120 subscriptions from the renewal date and refuses the 9% increase in the vendor's quote. The agreement ends at the end of the current term unless new terms are agreed ten days before it. The checker re-reads the contract on its own. It agrees on all six checks: method, address, entity, signatory, arrive-by date and send-by date.
“Agents draft and check; they do not sign or send.”
- 0709:12

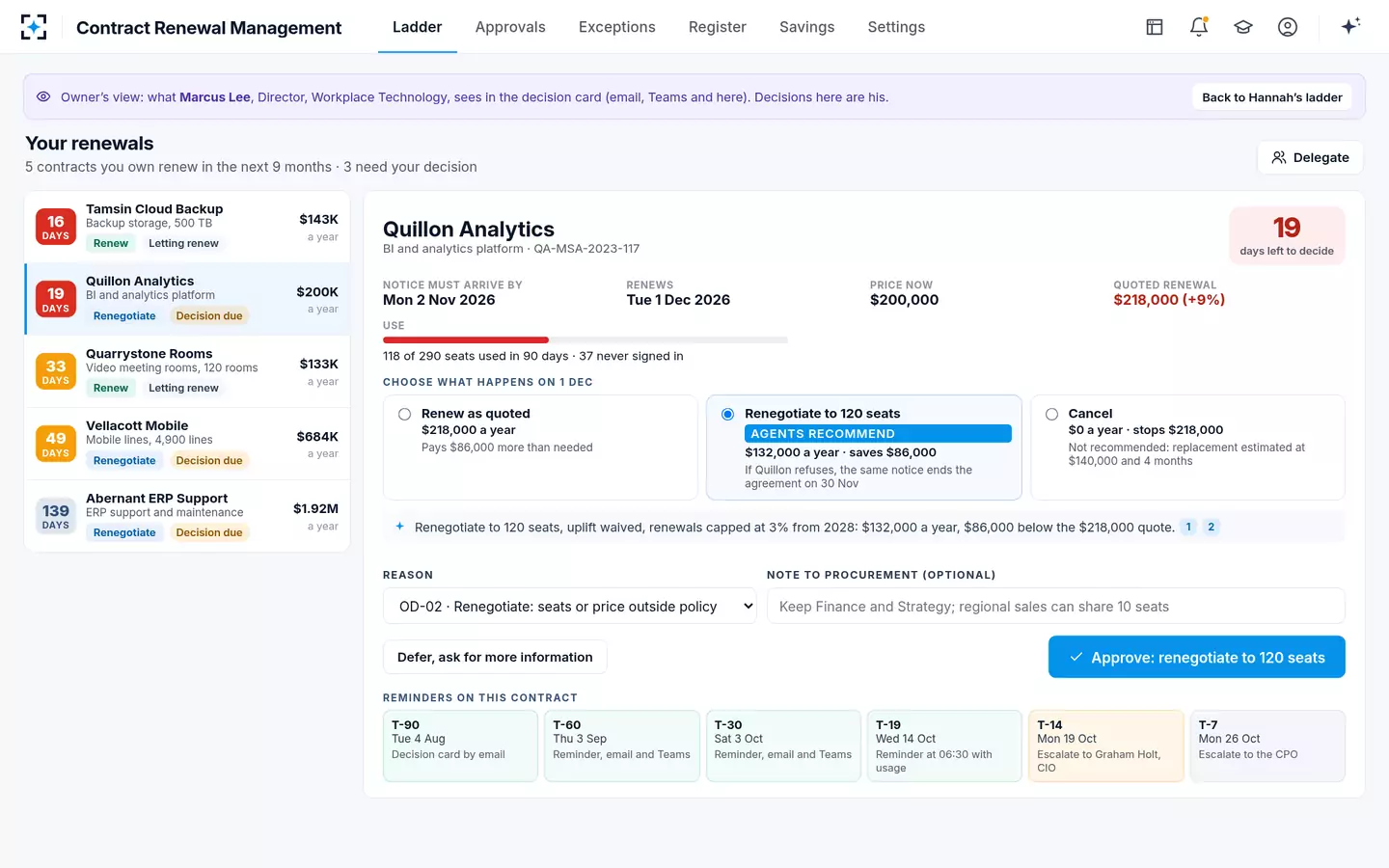

The owner decides, with usage and price on screen
IT business ownerThe director of workplace technology gets the decision by email, in Teams or in the product. It shows the dates, the price now and quoted, the usage and the three paths. The director approves “renegotiate to 120 seats” with a reason code. Had the owner not decided, the reminders would have gone to the CIO 14 days before the deadline and the CPO 7 days before.
- 0809:31

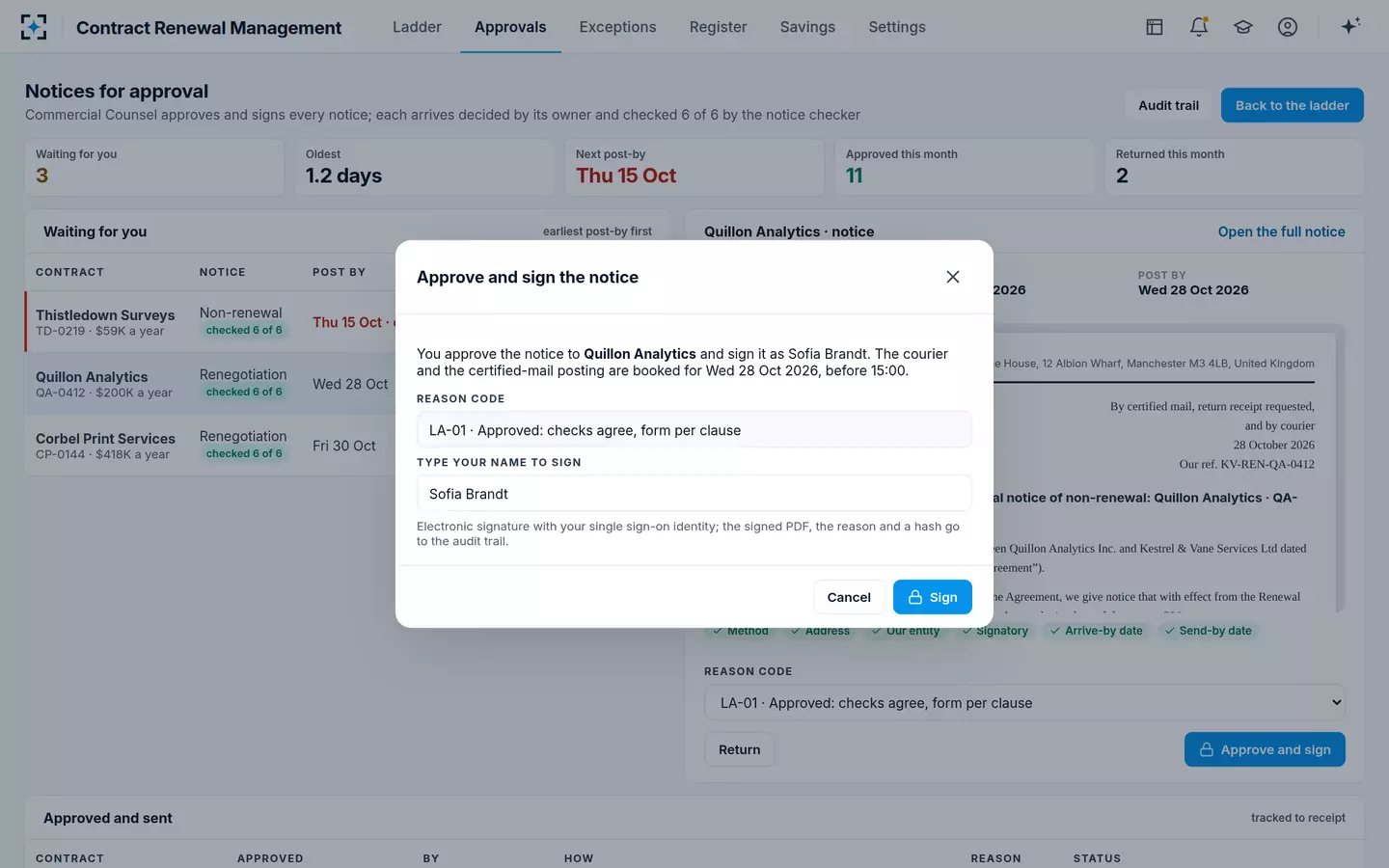

Counsel approves and signs, and the courier is booked
Commercial counselThe notice reaches counsel's approval queue already decided by its owner and checked 6 of 6. Counsel approves with a reason code and signs by typing a name. The certified-mail posting and the courier are booked for the post-by date, before 15:00. Both are tracked to a signed receipt.
“Electronic signature with your single sign-on identity; the signed PDF, the reason and a hash go to the audit trail.”
- 0906:20

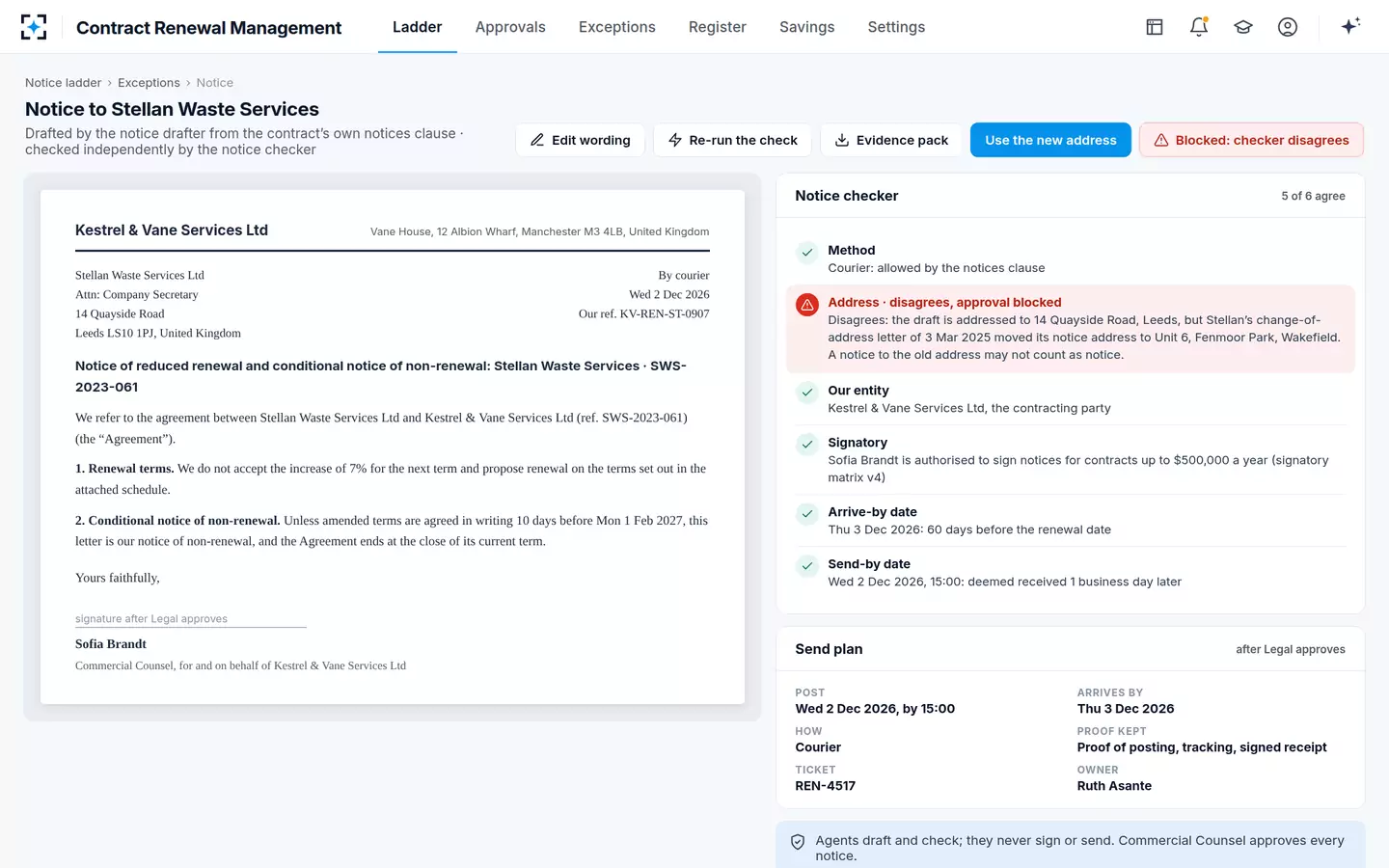

A notice to an old address is stopped
Notice checkerThe same morning, the checker disagreed with a draft to a waste services supplier. The draft used the supplier's old street address. A change-of-address letter had moved its notice address to a new business park. With 5 of 6 checks agreed, approval is blocked. It stays blocked until the procurement manager accepts the new address and the checker agrees again.
A notice to the wrong address on the right day is still a missed notice.
- 1006:04

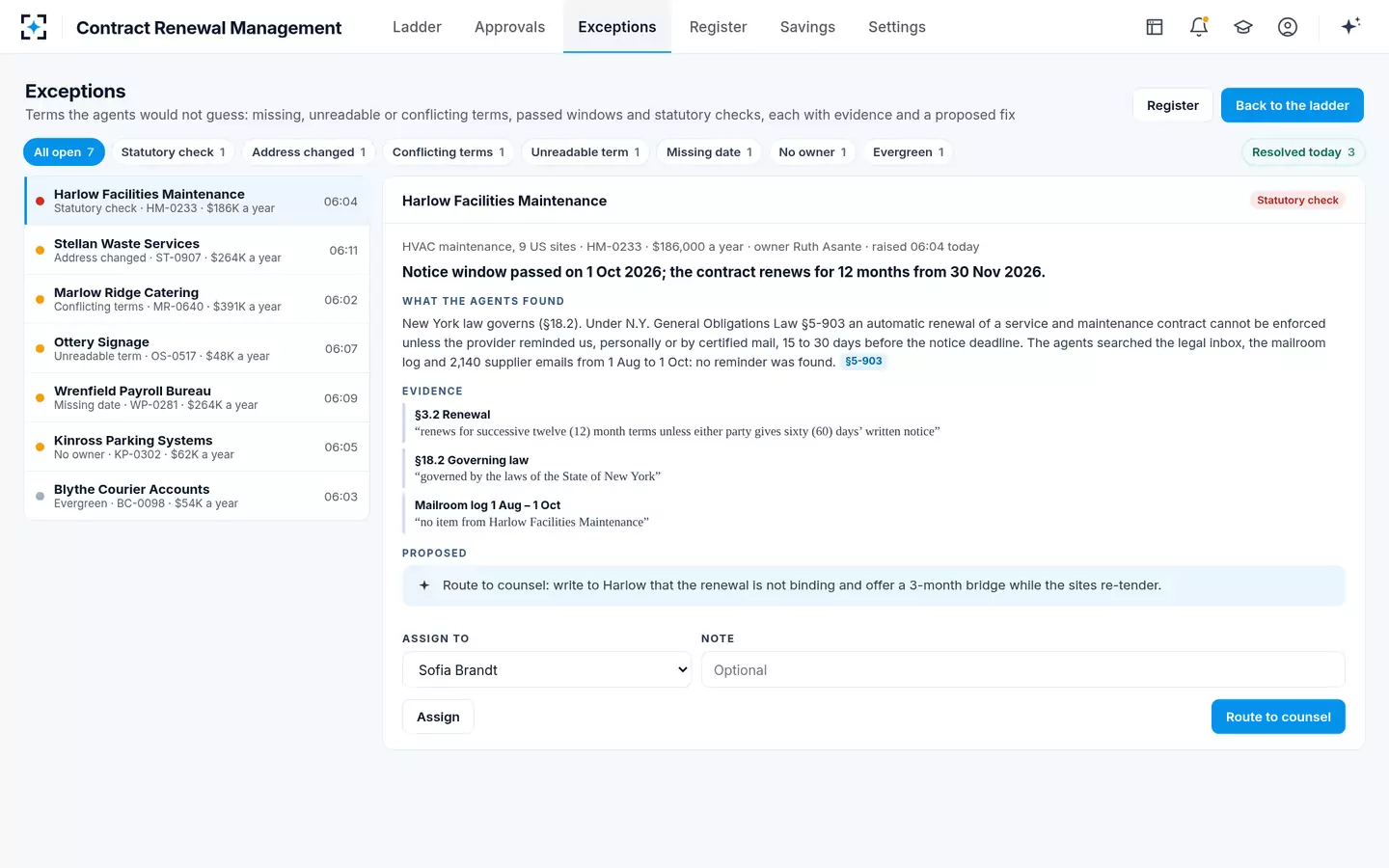

A passed window, and the law that may still help
Renewal advisorA facilities maintenance contract's notice window passed two weeks earlier. But New York law governs the contract. Under N.Y. General Obligations Law §5-903, the provider must remind the customer 15 to 30 days before the notice deadline. Without that reminder, an automatic renewal of a service and maintenance contract cannot be enforced. The agents searched the legal inbox, the mailroom log and 2,140 supplier emails and found no reminder. So the case goes to counsel with the evidence.
Proposed: write to the supplier that the renewal is not binding, and offer a 3-month bridge while the sites re-tender.
