- Before
- Owns 2,846 supplier contracts in nine repositories, and finds notice dates one PDF at a time.
- Now
- Opens one timeline with each renewal, termination and change-of-control window. Checks only the fields the agents are unsure of.
Seven days left to give notice on a supplier contract
A drug company pays $1,462,000 a year for an analytics subscription with 400 seats. It renews for another 12 months unless written notice reaches the supplier within 7 days. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:05

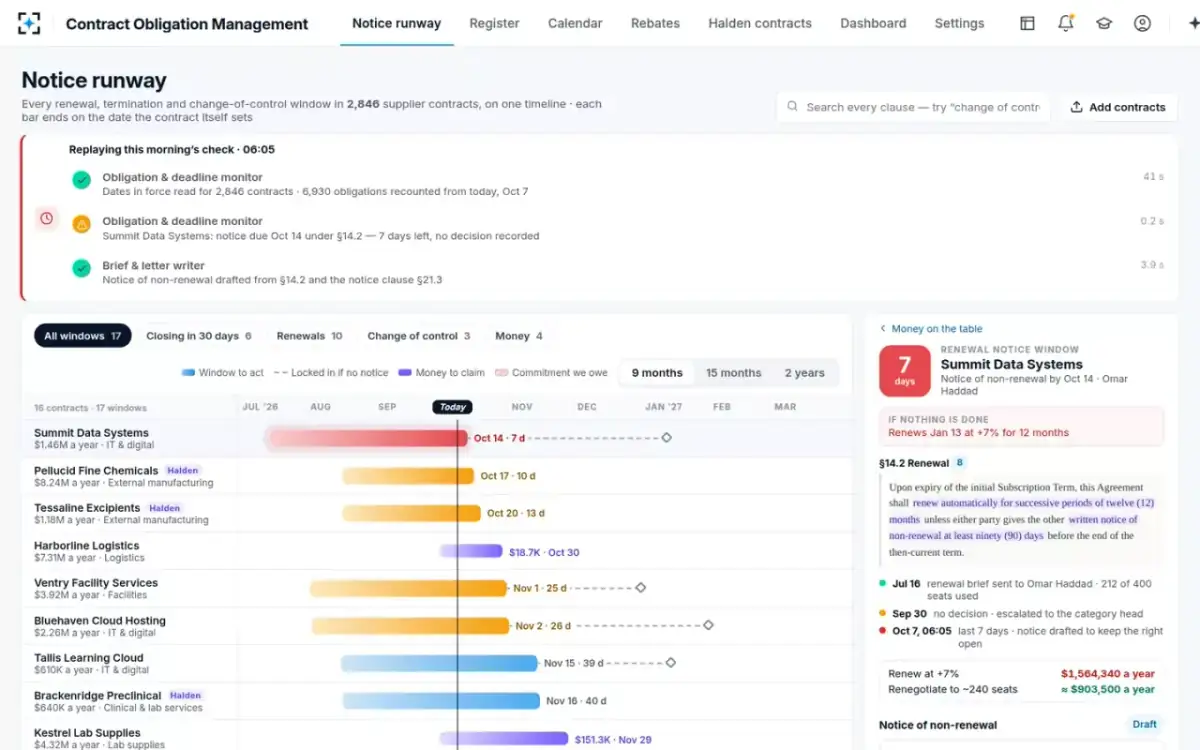

The morning check finds 7 days left and no decision

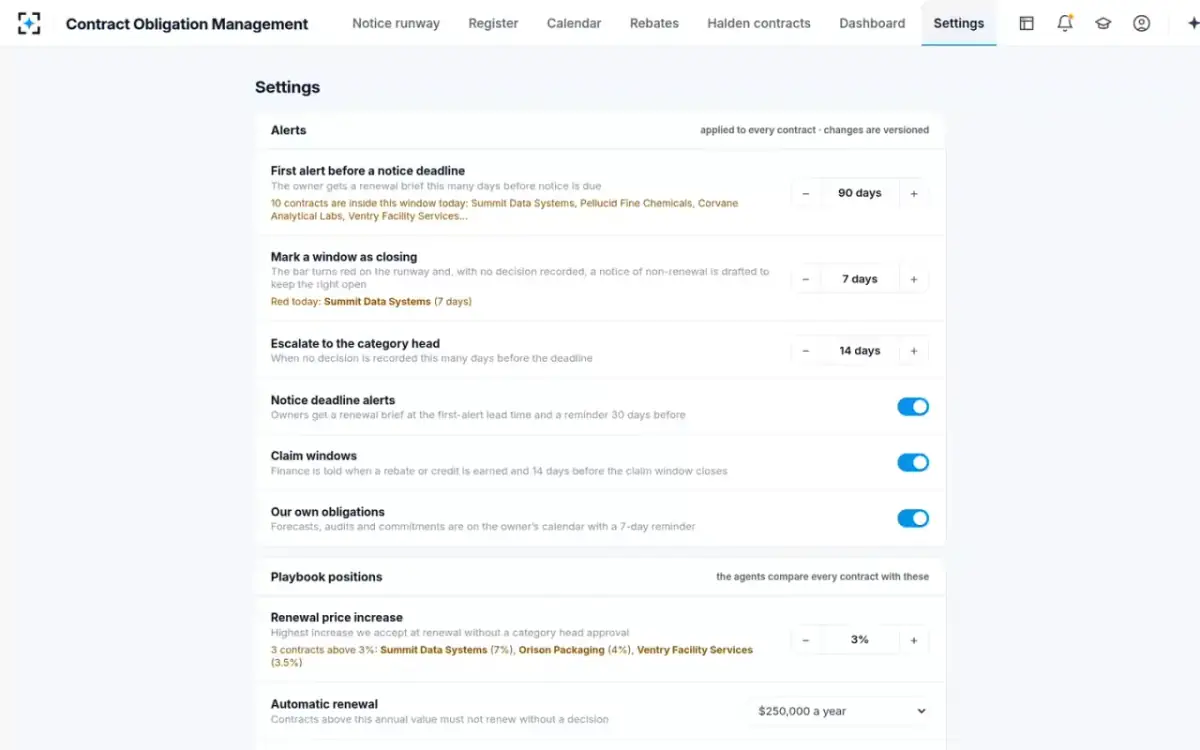

Obligation & deadline monitorThe deadline monitor reads the dates in force for 2,846 contracts. It recounts 6,930 obligations from today. The analytics supplier is due notice under §14.2, with 7 days left and no decision recorded. So the brief & letter writer drafts a notice of non-renewal. It works from §14.2 and the notice clause, §21.3. The notice keeps open the company's right to stop the renewal.
“The analytics subscription entered its last 7 days with no renewal decision recorded, so a notice of non-renewal was drafted to keep the right open.”
- 02Morning
All the notice windows on one timeline

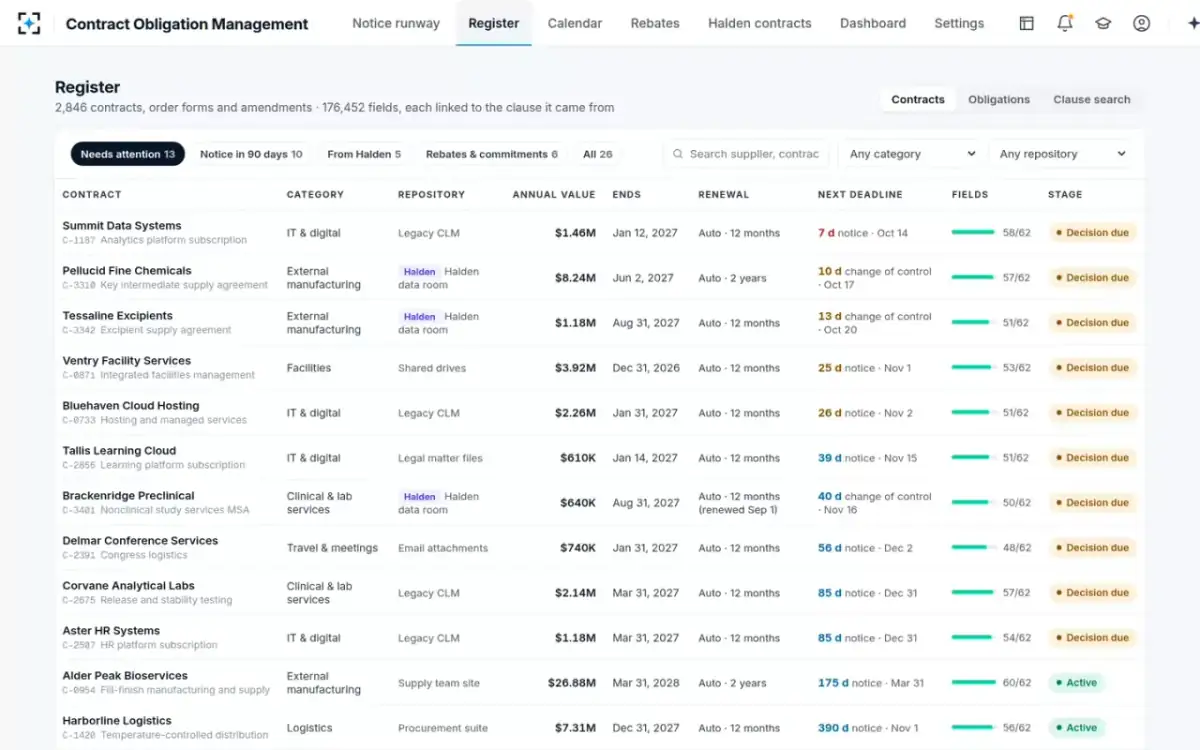

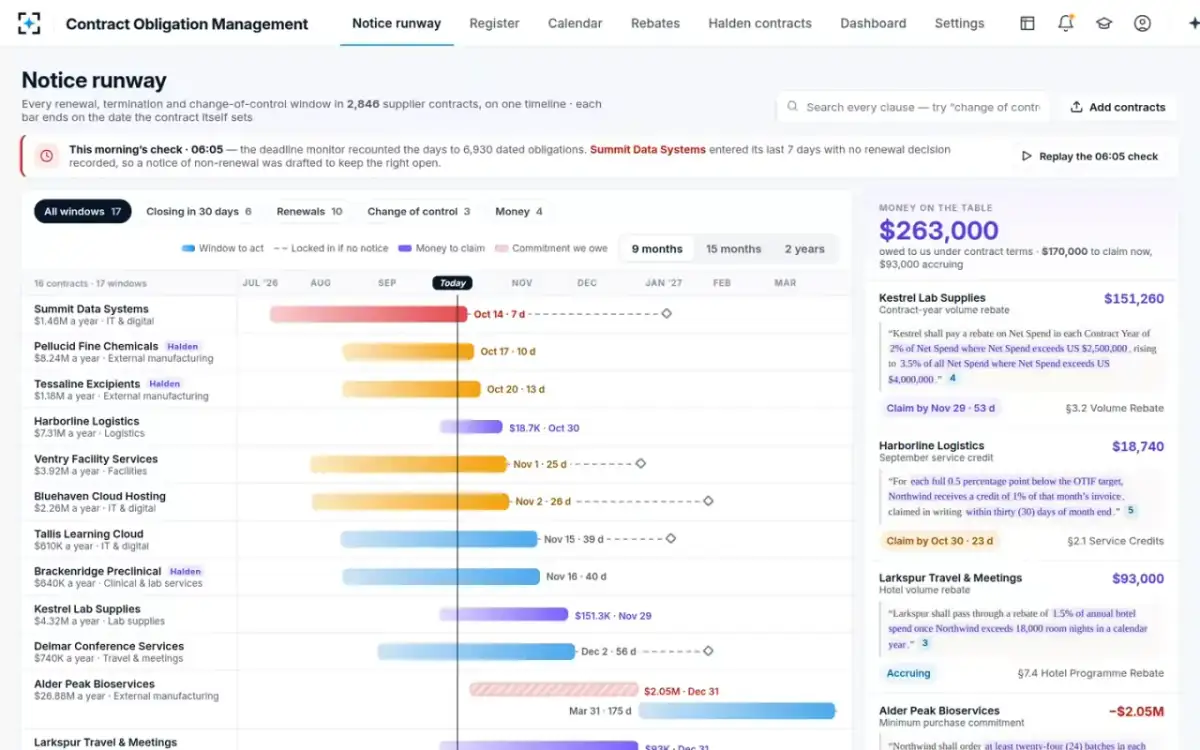

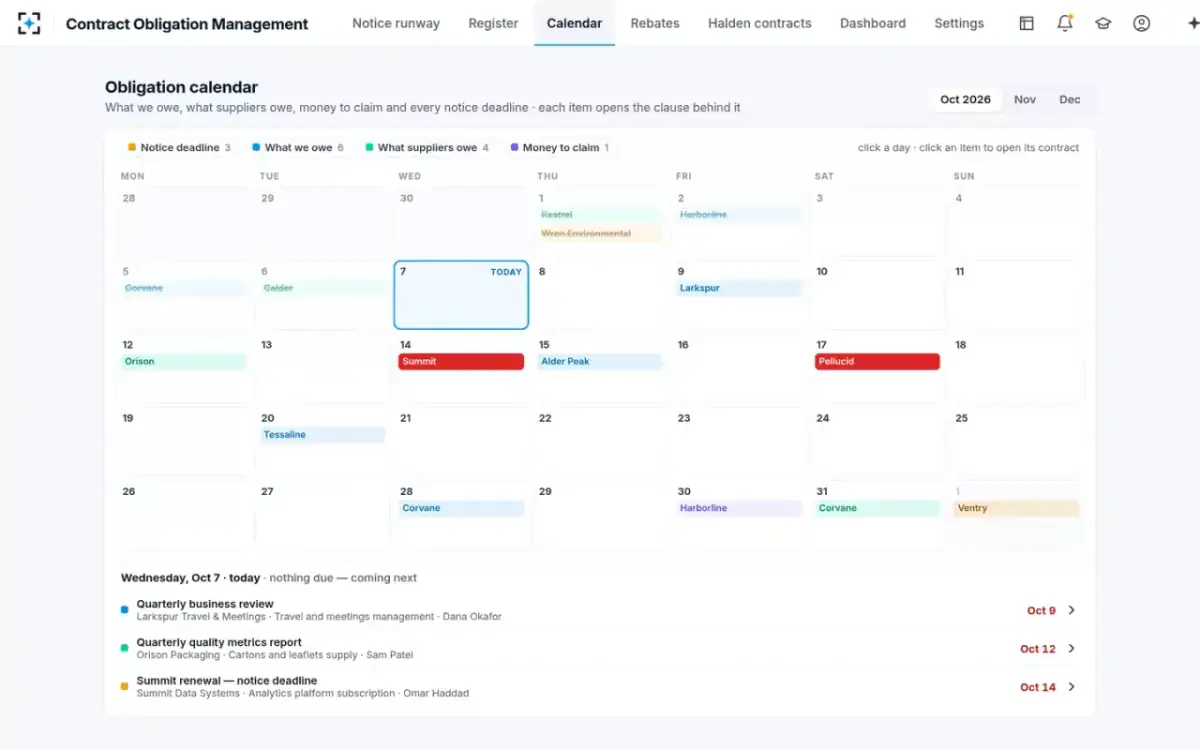

Contract managerThe contract manager owns 2,846 supplier contracts from nine repositories. The notice runway is a timeline of 17 windows over 16 contracts, nine months ahead. Each bar ends on the date the contract itself sets. The subscription is red at 7 days. Two contracts inherited in a recent acquisition close within the next two weeks. They are with a fine-chemicals supplier and an excipient supplier, which makes an inactive ingredient. Beside the timeline is money on the table: $263,000 owed to the company under contract terms.
A dashed line runs from each notice date to the renewal: “Locked in if no notice”.
- 03One click on the bar

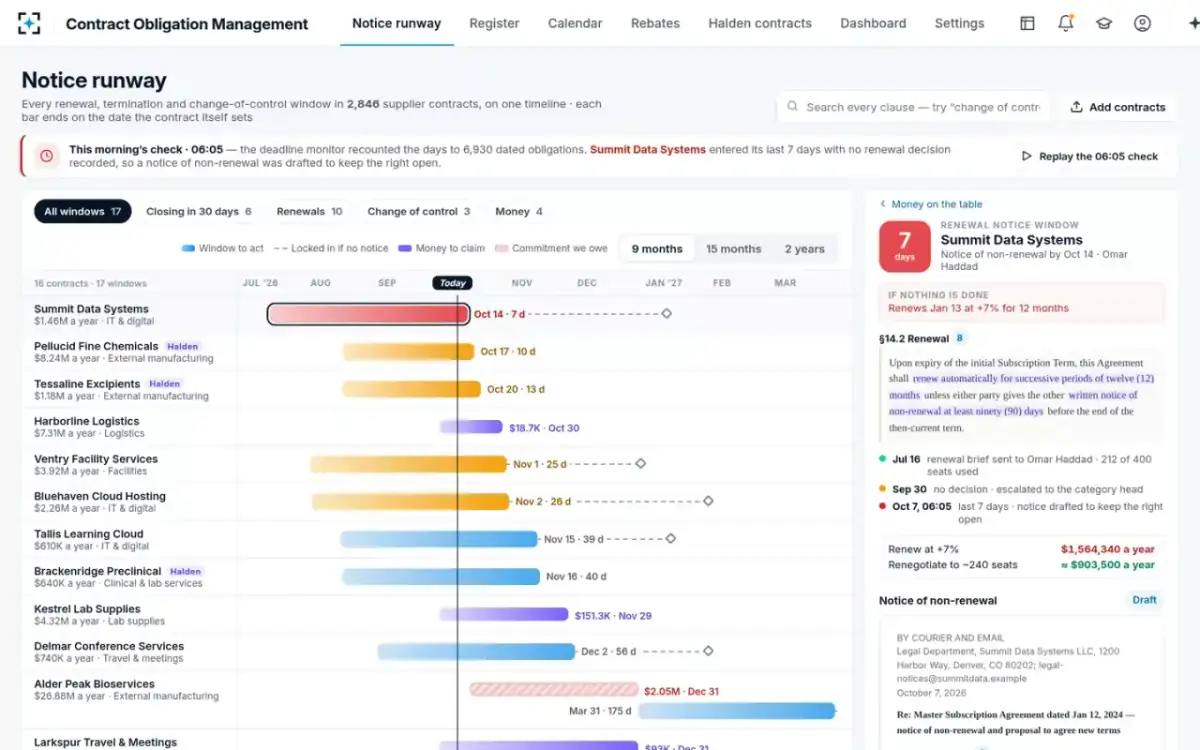

What happens if nothing is done
Contract managerThe window opens beside the timeline: “Renews at +7% for 12 months”. §14.2 is quoted, with the key words highlighted. Its history is there too. The renewal brief went to the category manager months ago, with no decision. It was escalated to the category head a week ago, and it turned red at 06:05 today. Renewing at +7% costs $1,564,340 a year. Renegotiating to about 240 seats costs about $903,500.
The draft notice is already in the panel. It is addressed to the supplier's legal department, by courier and email.
- 04The brief
Terms in force, seat use and three options

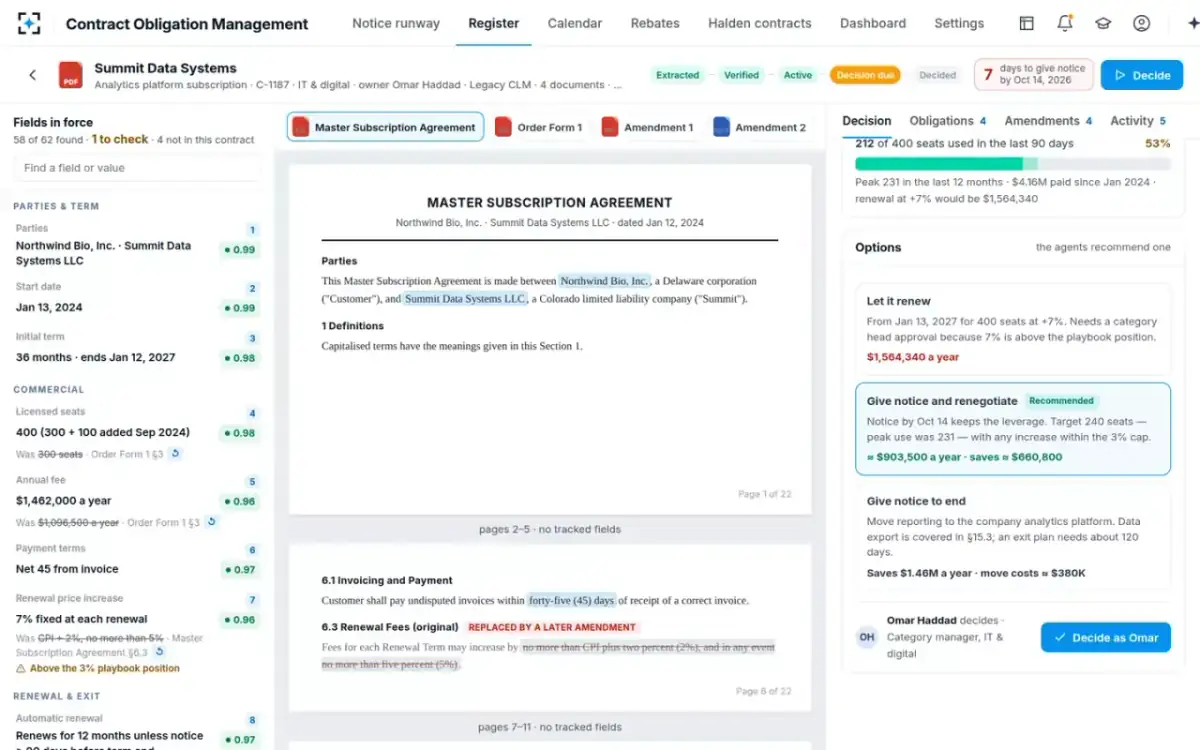

Brief & letter writerThe amendment reconciler finds that Amendment 2 §3 replaced the 5% renewal cap with a fixed 7%. That is above 3%, the position in the company's playbook of standard terms. Sign-in data shows 212 of 400 seats used in the last 90 days, with a peak of 231 in the last 12 months. The brief prices three options. The first is to let it renew, at $1,564,340 a year. The second is to give notice and renegotiate to 240 seats. That costs about $903,500, saving about $660,800. The third is to give notice and end it. That saves $1.46M a year, and the move costs about $380K.
“Give notice and renegotiate” is recommended. The category manager decides.
- 05Decided
The category manager chooses notice and renegotiation

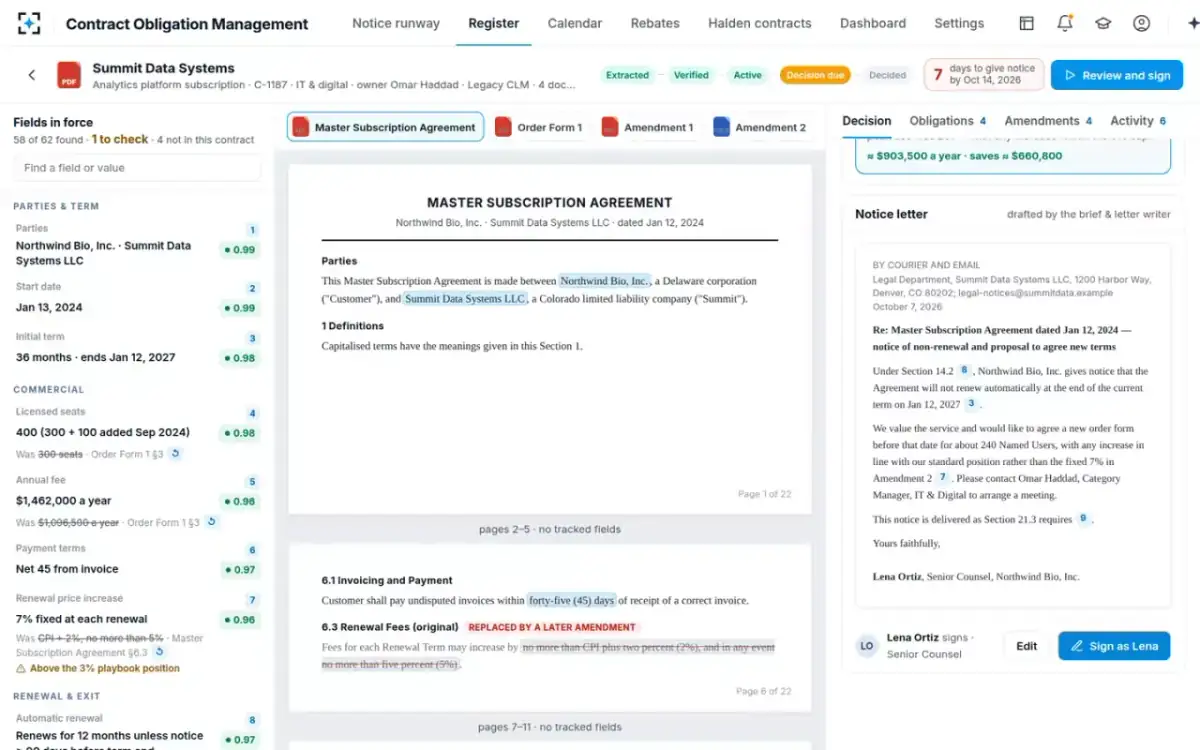

Category manager · IT & digitalThe category manager picks the recommended option. The notice letter is drafted from the contract. It gives notice under Section 14.2 that the agreement will not renew automatically when the current term ends. It also proposes a new order form for about 240 named users, with any increase in line with the company's standard position. The letter states that it is delivered as Section 21.3 requires. Each clause it relies on is cited.
The brief & letter writer does not send. A person signs each letter.
- 06Signed

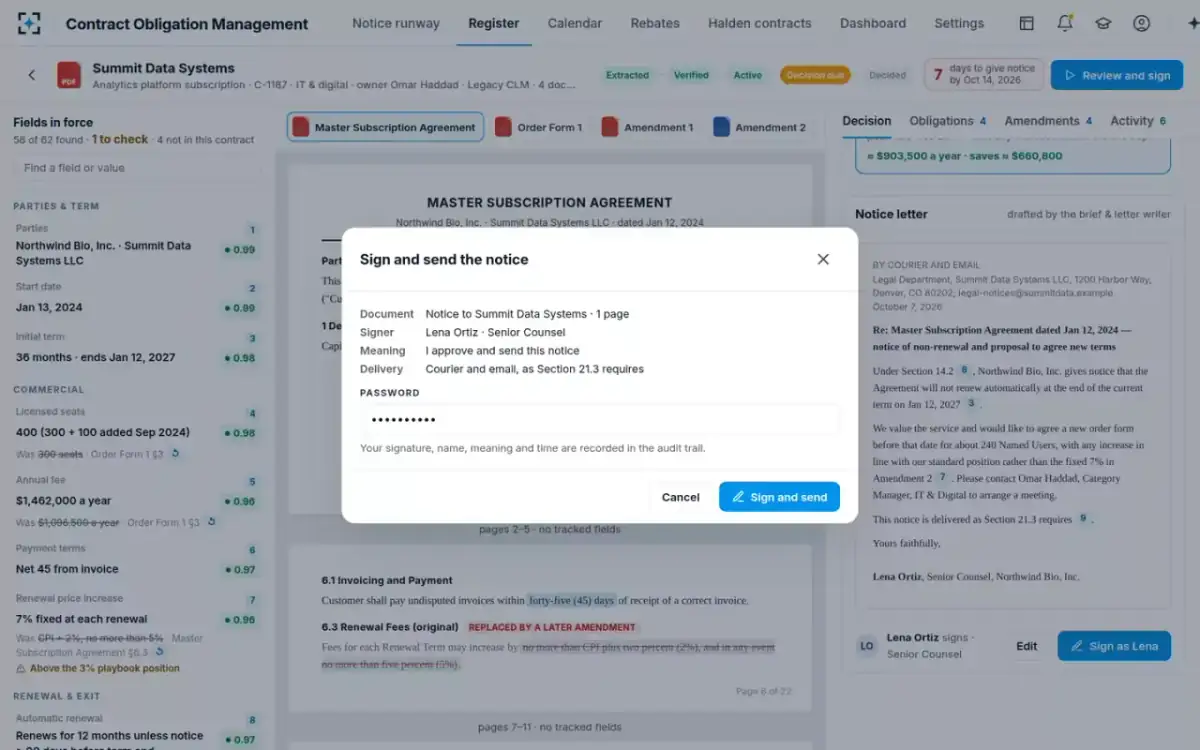

Legal signs, with the meaning of the signature
Senior counselSenior counsel reviews the notice and signs it. The record holds the document, the signer and the meaning: “I approve and send this notice”. It also holds the delivery method, courier and email, as Section 21.3 requires.
“Your signature, name, meaning and time are recorded in the audit trail.”
- 07Sent the same day
Notice sent, the right kept, the meeting booked

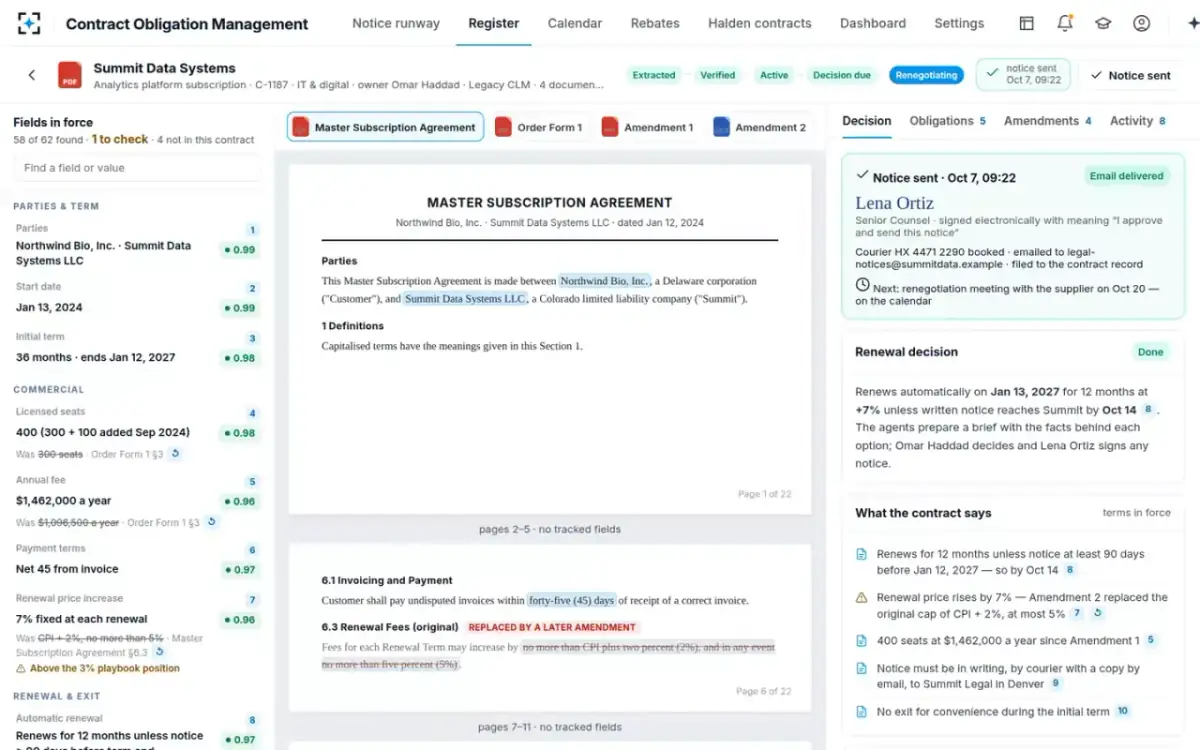

Senior counsel and category managerThe notice goes by courier and email to the supplier's address for legal notices. It is filed to the contract record. The contract moves to Renegotiating, and a meeting with the supplier goes on the calendar.
“Next: renegotiation meeting with the supplier, on the calendar.”
- 08Same morning

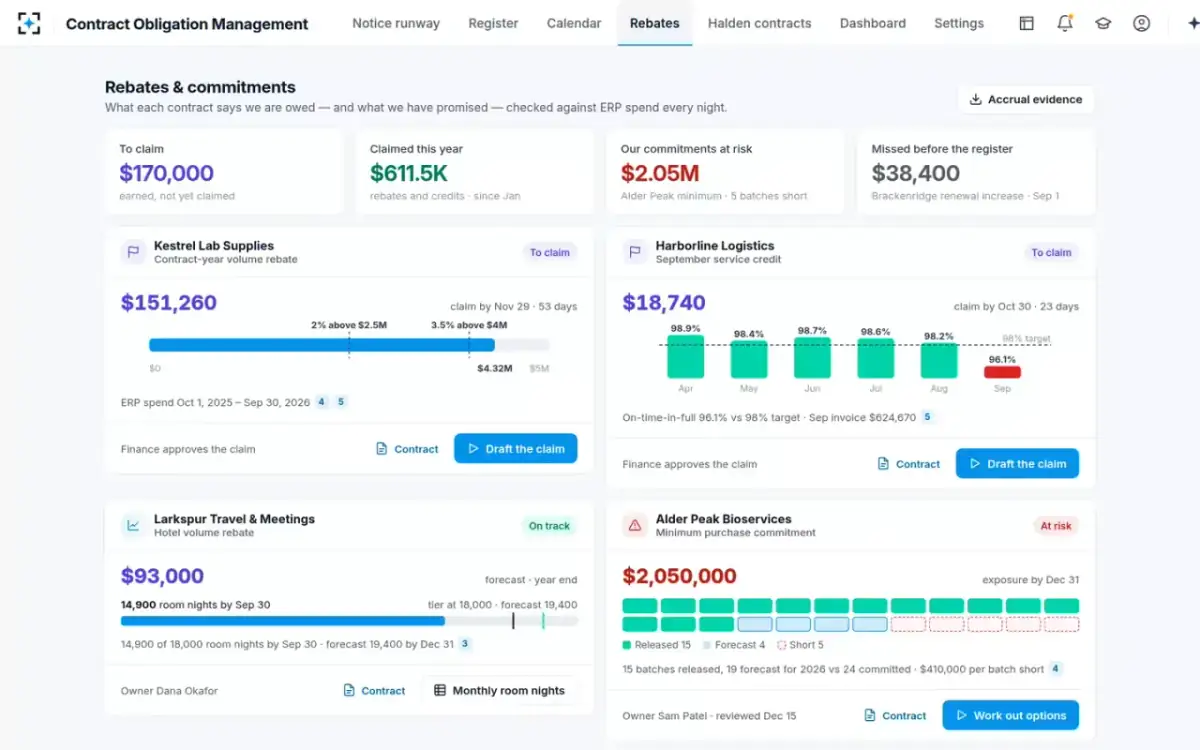

A $151,260 rebate, with the clause and the invoices

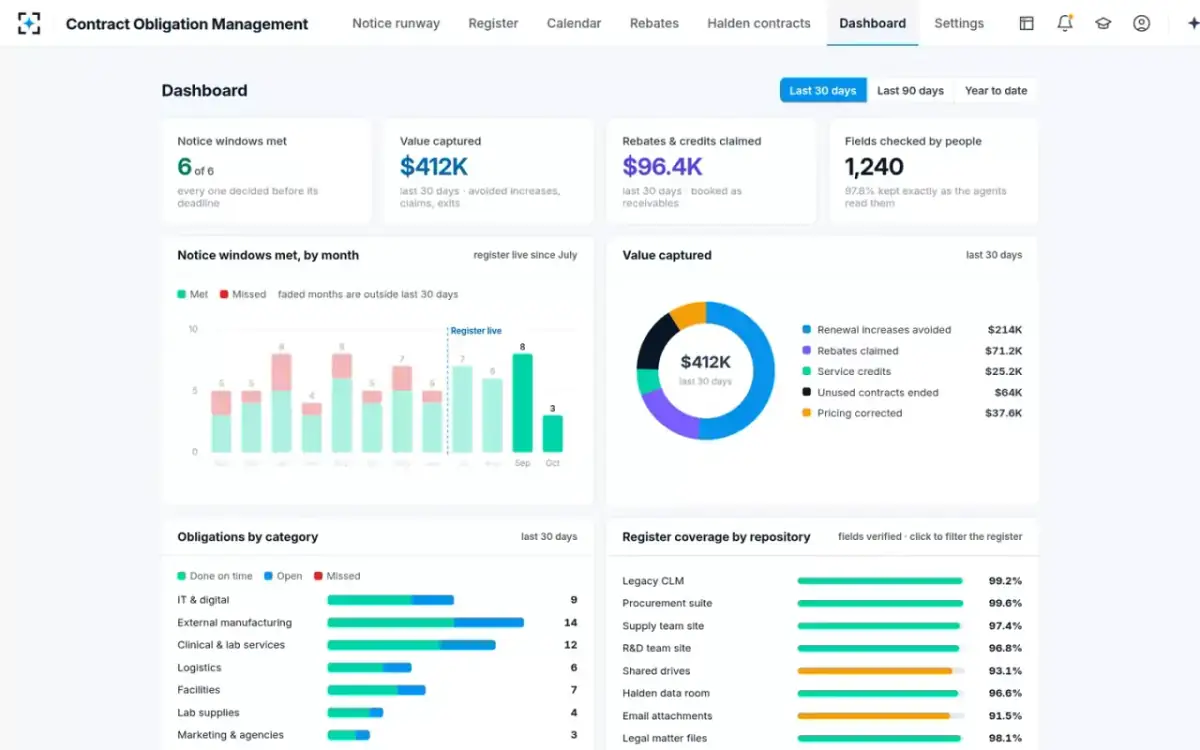

Spend & rebate linkerFrom 1,284 ERP invoice lines, a lab supplies vendor's net spend for the contract year comes to $4,321,714. That passes the $4.0M tier, so a 3.5% rebate applies to all of it: $151,260. It must be claimed in writing before the contract's claim date. A logistics provider delivered on time and in full 96.1% of the time last month, against a 98% target. So it owes an $18,740 service credit, claimable within its window. The finance lead approves each claim.
The company owes something too. It has a minimum commitment with one fill-finish manufacturer and is 5 batches short. That is $2.05M if nothing changes.
- 09Day 50 after closing

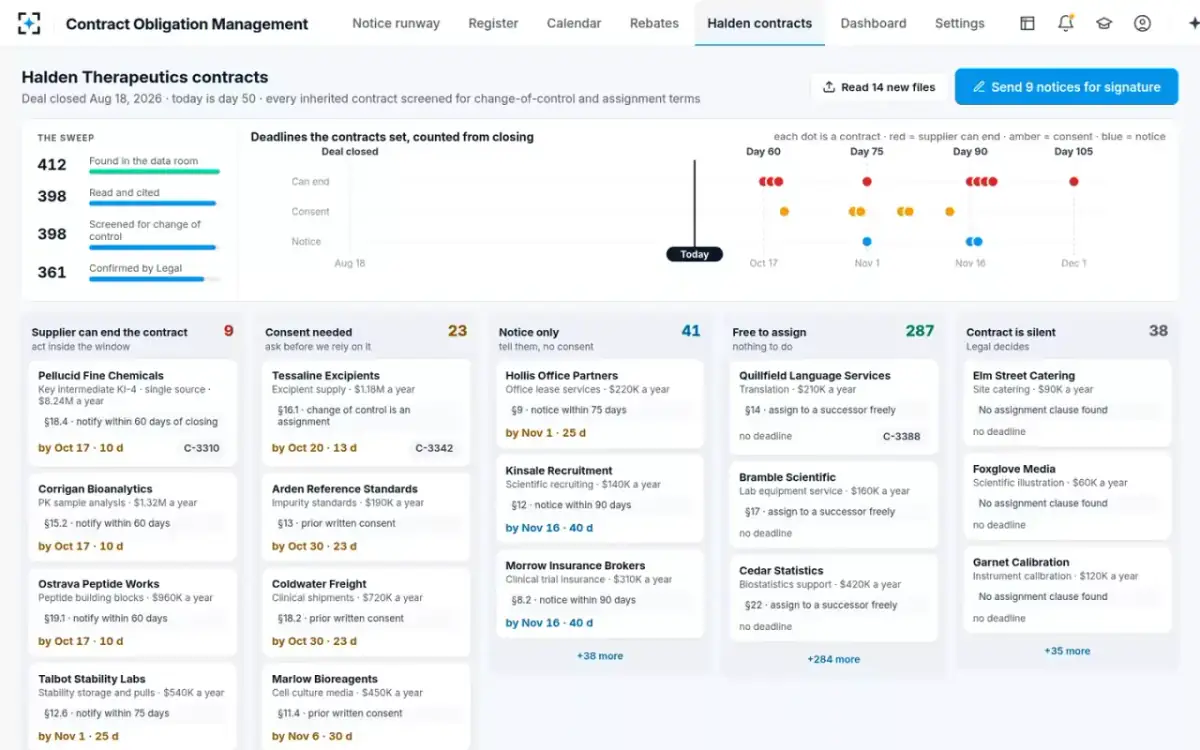

Who can walk away after the acquisition
Change-of-control screenerThe acquired company's data room holds 412 files. Of these, 398 are read, cited and screened, and Legal has confirmed 361. Nine let the supplier end the contract, 23 need consent and 41 need notice only. Another 287 are free to assign, and 38 say nothing on the point. First on the board is the fine-chemicals supplier, the single source of a key intermediate. It must be notified within 60 days of closing. Elsewhere in the sample data, an acquired CRO contract had already renewed at +6%, losing $38,400. Its notice date passed before it reached the register.
Legal confirms every result, and single-source suppliers are flagged first.
