- Before
- Brings complaint categories to the monthly executive review, where causes are argued from opinion. Knows what customers complain about, but cannot prove why or put the cause on someone's desk.
- Now
- Follows the thickest band to a cause proved with system data, priced in contacts, credits and truck rolls, and accepts it with an owner, an outcome and a date.
Reconnection complaints traced to an overnight batch job, priced and owned
A utility that supplies electricity and water received 2,318 complaints in four weeks. The largest challenge, reconnection delayed after payment, holds 412 of them, each closed on its own. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Monday morning

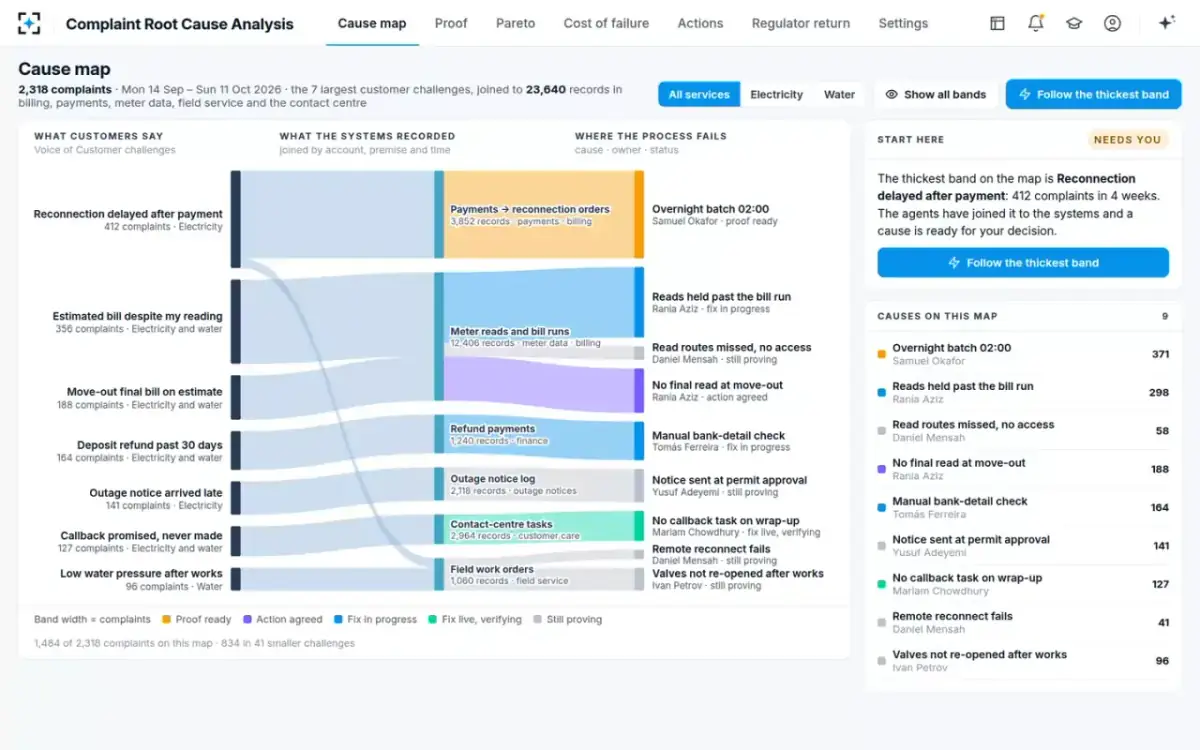

The cause map opens on what customers say
Head of Customer ExperienceThe Head of CX owns the complaint return to the regulator. The home screen is a flow: the 7 largest Voice of Customer challenges on the left, the 23,640 records they were joined to in the middle (payments, meter reads and bill runs, refunds, outage notices, contact-center tasks, field work orders) and the 9 process steps that fail on the right, each with an owner and a status. Band width is complaints.

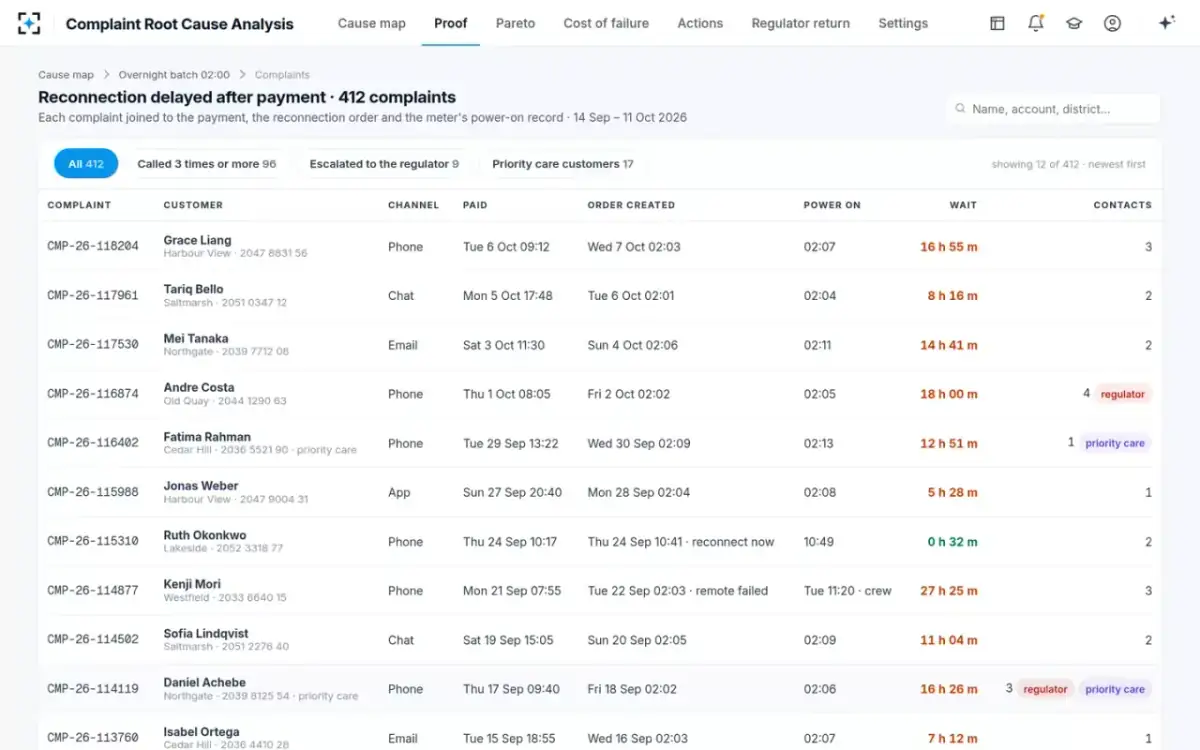

“The thickest band on the map is Reconnection delayed after payment: 412 complaints in 4 weeks. … a cause is ready for your decision.”
- 02One complaint of the 412

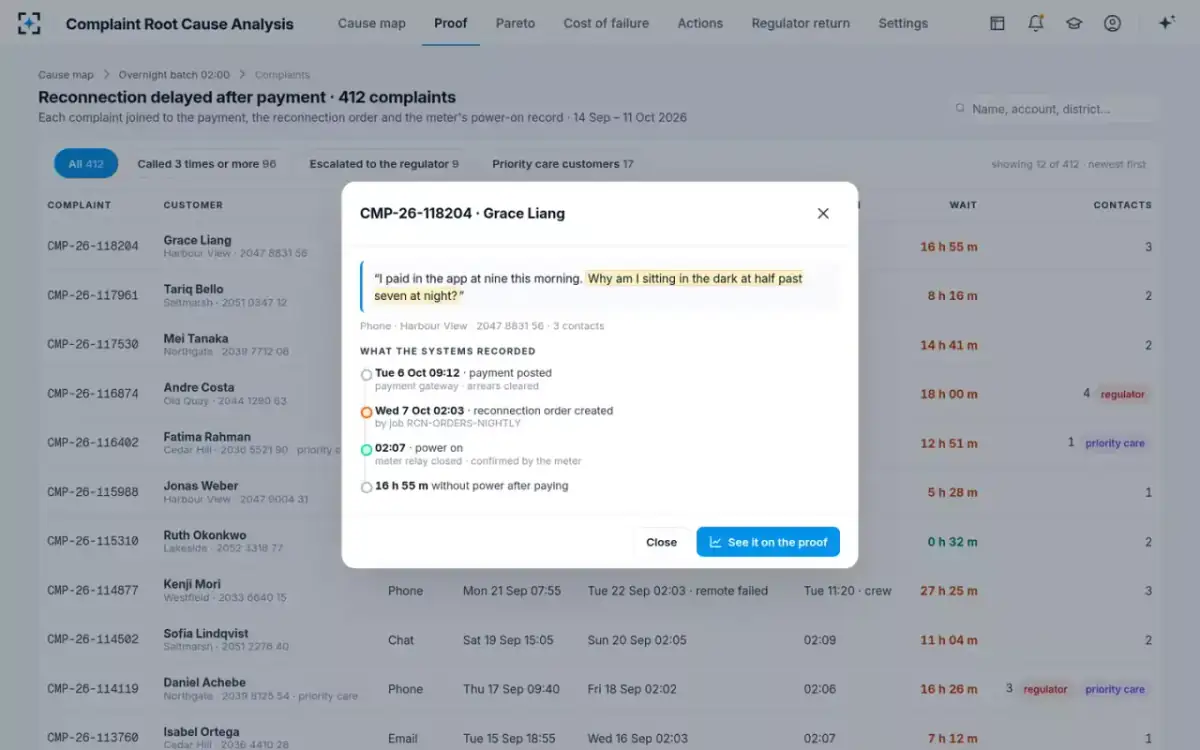

Paid at 09:12, power on at 02:07
CustomerOne customer cleared arrears of $386.40 in the utility's app at 09:12. The systems recorded the reconnection order at 02:03 the next morning and the meter relay closing at 02:07: 16 h 55 m without power after paying. The customer called three times that day, and the complaint is one of the 412.
“I paid in the app at nine this morning. Why am I sitting in the dark at half past seven at night?”
- 03One click
Following the thickest band

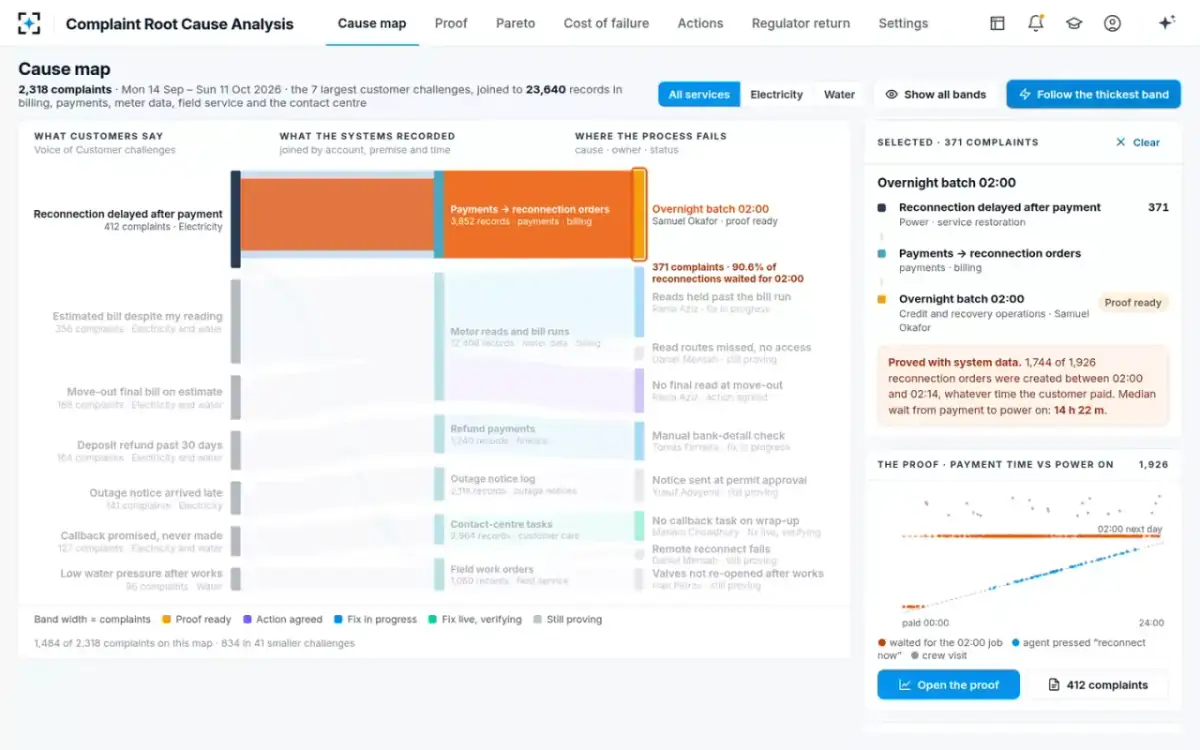

Record linkerThe Head of CX clicks Follow the thickest band. The band runs from the challenge through Payments → reconnection orders (3,852 records from payments and billing) and thickens into one cause: Overnight batch 02:00, owned by the credit and recovery operations manager. 371 of the 412 complaints land there; 41 go to a separate cause, remote reconnects that fail.
“Proved with system data. 1,744 of 1,926 reconnection orders were created between 02:00 and 02:14, whatever time the customer paid.”
- 04The proof

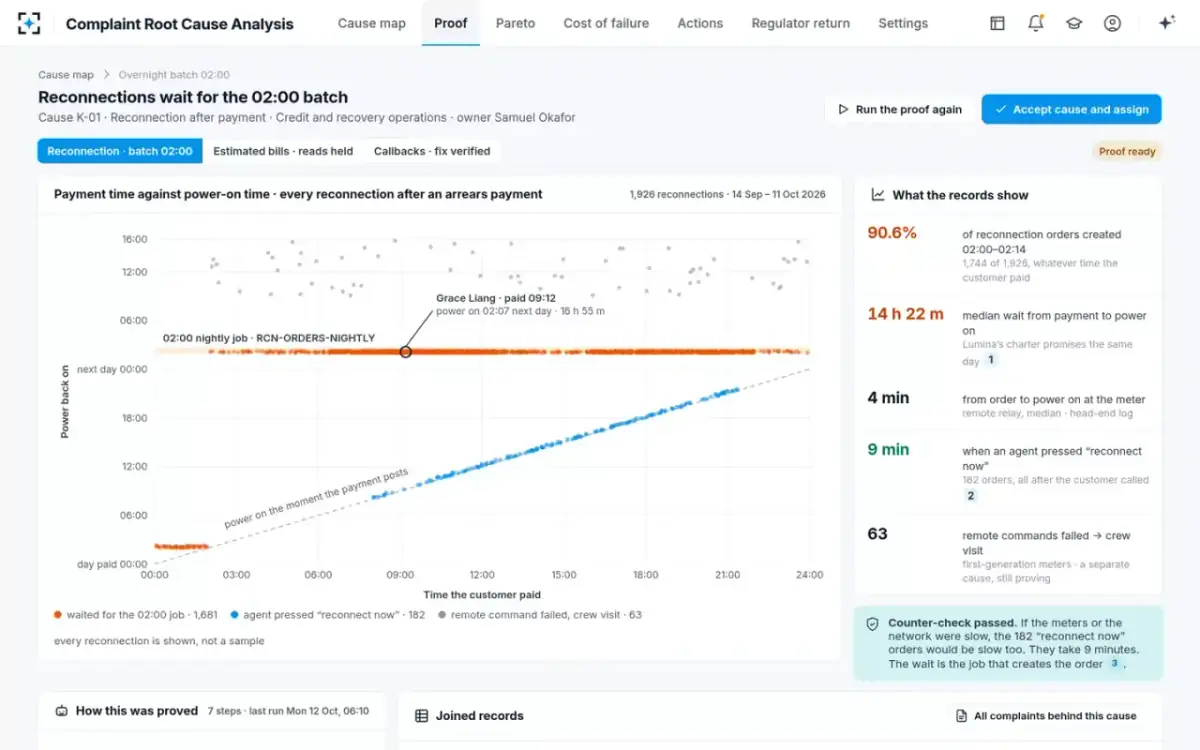

Each reconnection, payment time against power-on time
Timing analyst and Process tracerThe proof plots all 1,926 reconnections after an arrears payment, not a sample. Whatever time people paid, the dots stack on one line at 2 am: 90.6 % of orders were created 02:00–02:14, and the median wait was 14 h 22 m, against a customer charter that promises the same day. At the meter, power came on 4 minutes after the order. The process tracer found the step: “Create reconnection order” runs only in the nightly order job, daily at 02:00.
Counter-check passed: “If the meters or the network were slow, the 182 ‘reconnect now’ orders would be slow too. They take 9 minutes. The wait is the job that creates the order.”

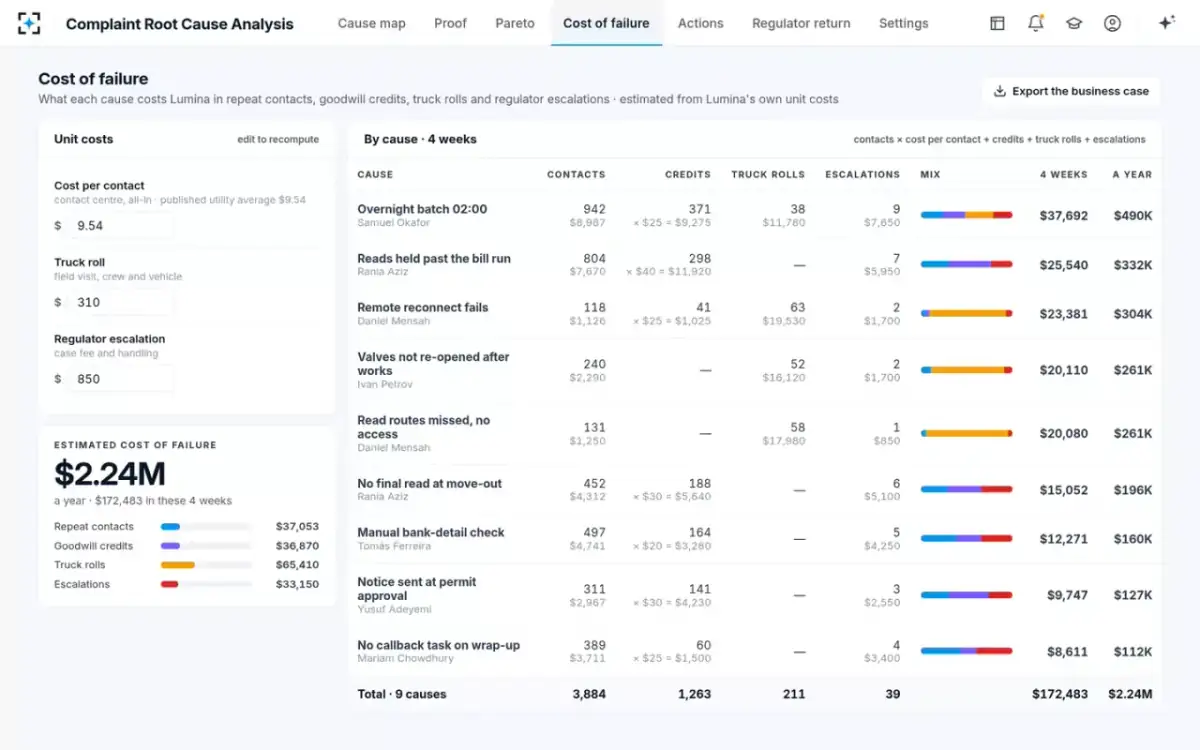

- 05Priced
$490K a year from one batch job

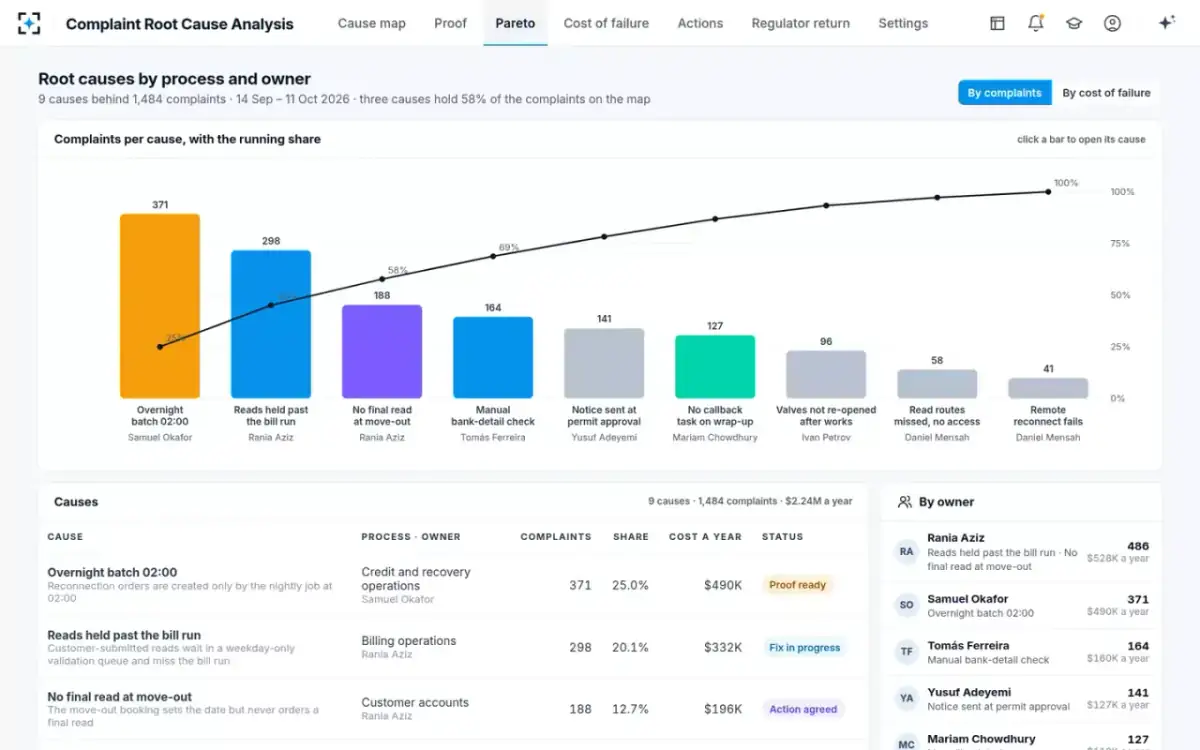

Cost of failure estimatorIn 4 weeks the batch cost the utility 942 repeat contacts at $9.54, 371 goodwill credits at $25, 38 truck rolls at $310 and 9 escalations to the regulator at $850: $37,692, about $490K a year. Across all 9 causes the estimated cost of failure is $172,483 in 4 weeks, $2.24M a year. Each unit cost can be edited, and the figures recompute.
Each figure is labeled estimated, with its inputs shown.

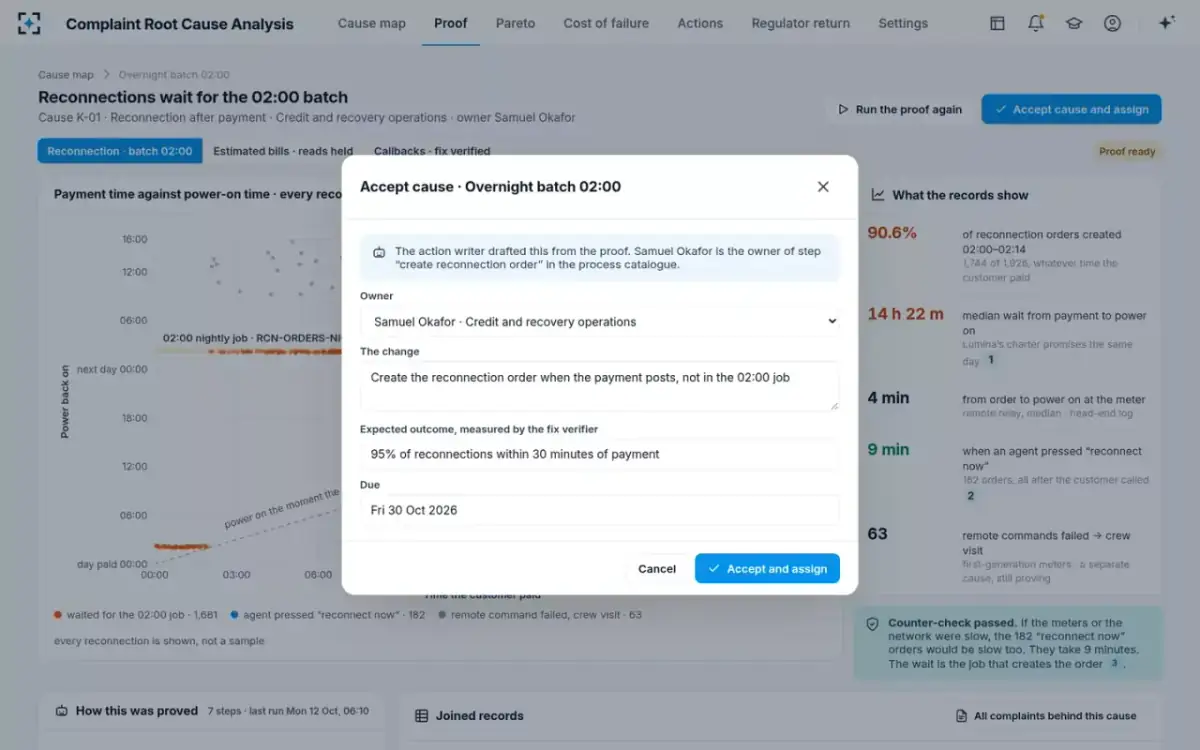

- 06Decided
The Head of CX accepts the cause and assigns it
Head of Customer ExperienceThe action writer has drafted the fix from the proof, with the credit and recovery operations manager as owner of the step in the utility's process catalog. The change: create the reconnection order when the payment posts, instead of waiting for the 02:00 job. The expected outcome, which the fix verifier will measure: 95 % of reconnections within 30 minutes of payment, by a set due date.
A cause stays a candidate until the Head of CX accepts it; the action is assigned only when its owner accepts it.
- 07Assigned

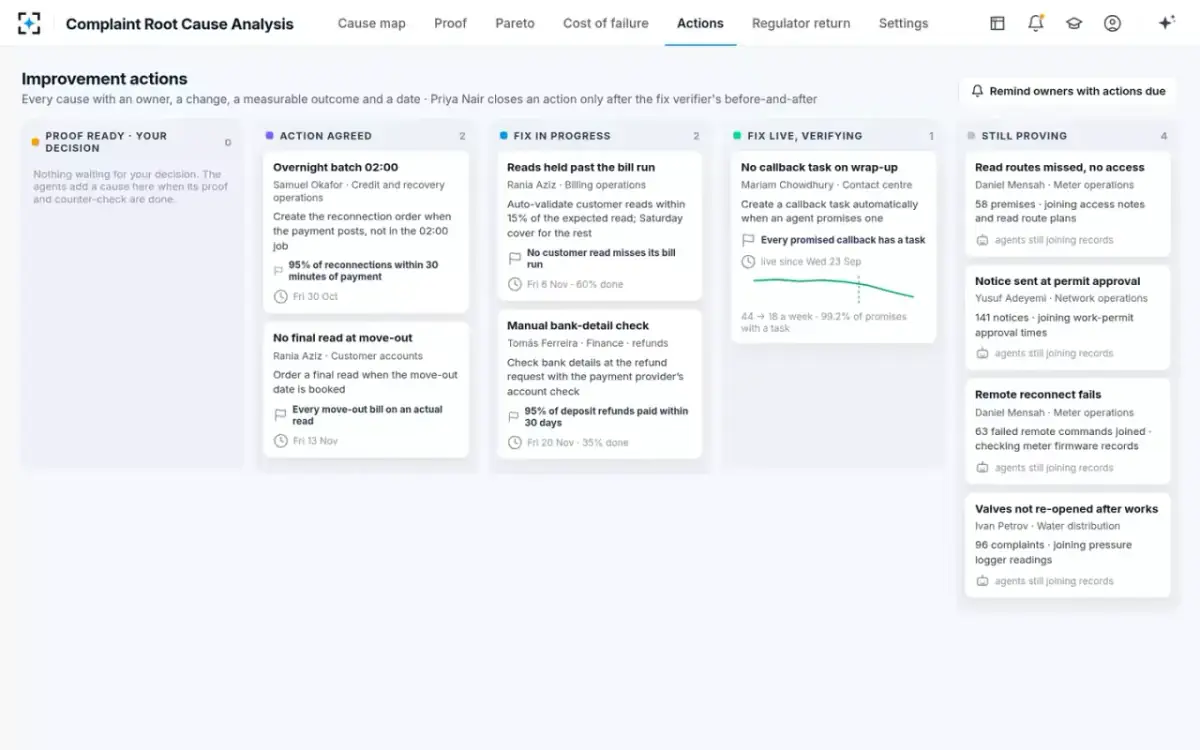

Each cause on one board, with an owner and a date
Credit and recovery operationsThe overnight batch moves to Action agreed, next to No final read at move-out, owned by billing operations. In progress: auto-validating customer reads (60 % done) and checking bank details at the refund request, each with its own due date. Four causes are still proving, with the agents joining access notes, permit approval times, meter firmware records and pressure logger readings.
An action closes only after the fix verifier's before-and-after, and only the continuous improvement lead closes it.
- 08The same method

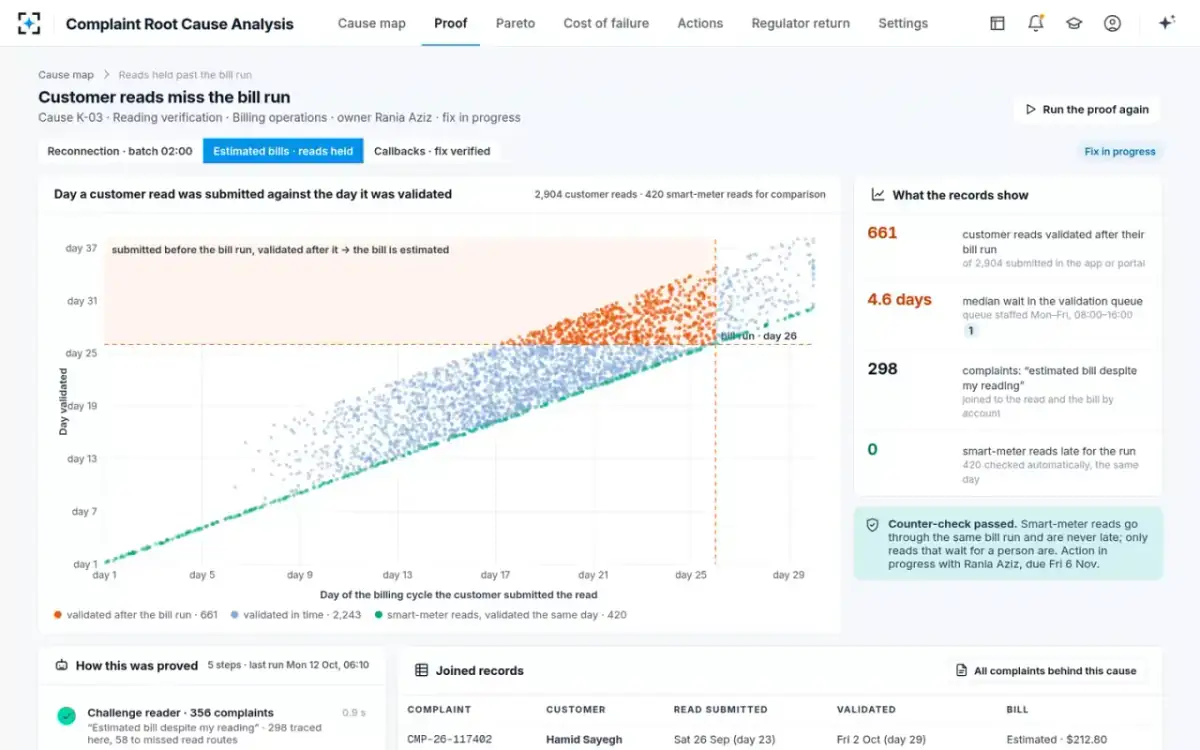

Customer reads that miss the bill run
Billing operationsThe second proof explains “Estimated bill despite my reading”. Of 2,904 customer-submitted reads, 661 were validated after their bill run on day 26: the validation queue is staffed Mon–Fri, 08:00–16:00, with a median hold of 4.6 days. The counter-check: the 420 smart-meter reads in the same runs were never late. 298 complaints trace here; the billing manager's fix auto-validates reads within 15 % of the expected read, with Saturday cover for the rest.
“Smart-meter reads go through the same bill run and are never late; only reads that wait for a person are.”
- 09Verified

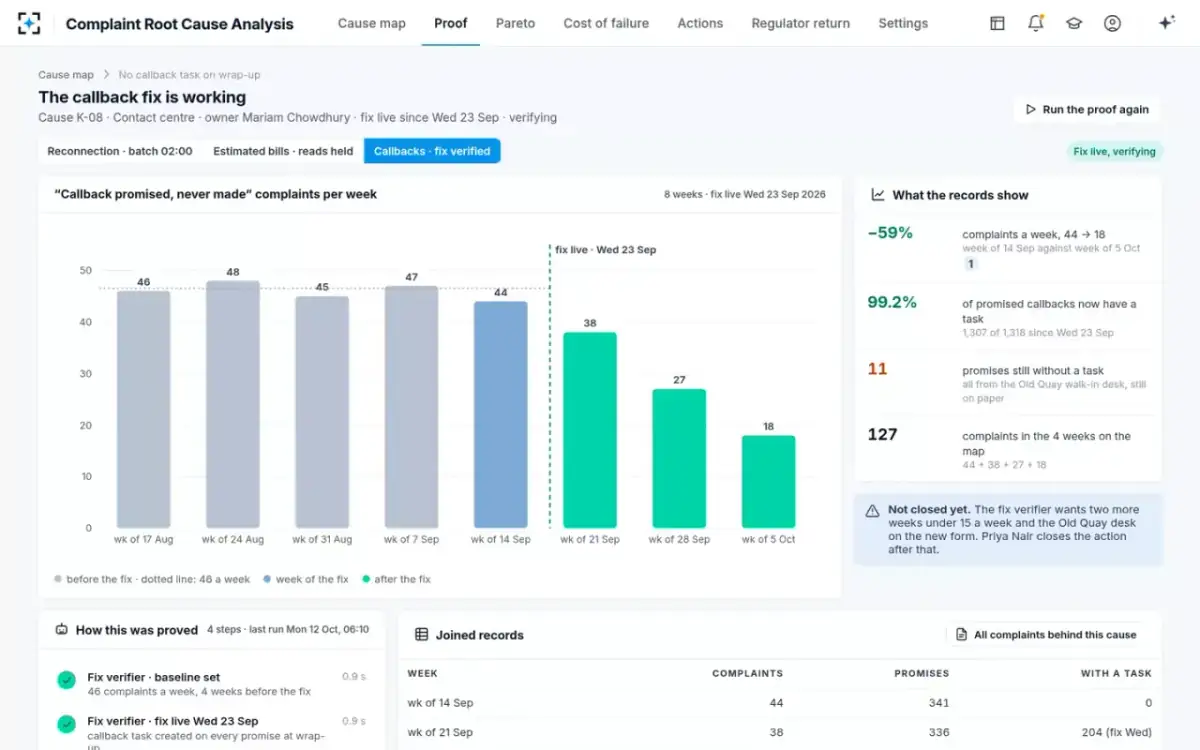

The callback fix, measured week by week
Fix verifierWhen a call was wrapped as resolved, the promised callback did not become a task. Once the fix went live, complaints of a missed callback fell from 44 a week to 18, and 1,307 of 1,318 promises since then have a task. The 11 misses all come from one walk-in desk that is still on paper.
“Not closed yet. The fix verifier wants two more weeks under 15 a week and the walk-in desk on the new form. The CI lead closes the action after that.”

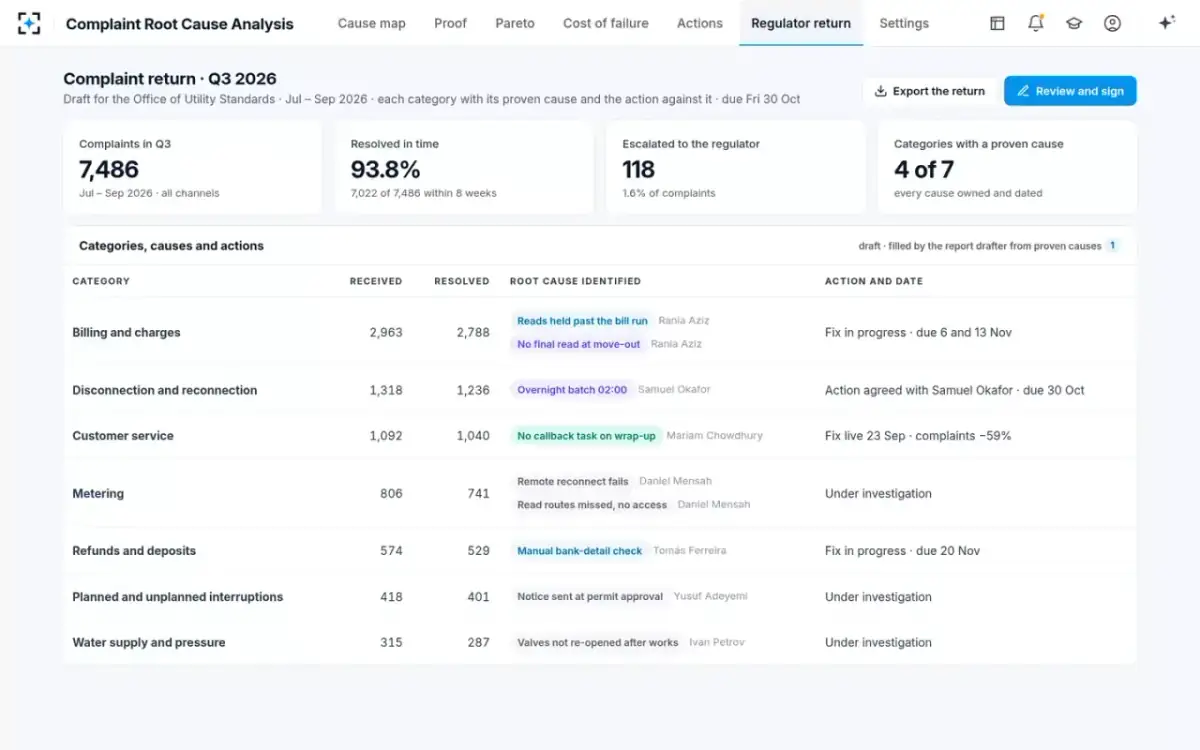

- 10Before the return is due
The quarterly return, with a cause and an action per category
Head of Customer ExperienceThe Q3 complaint return to the regulator is drafted from the proven causes: 7,486 complaints, 93.8 % resolved within 8 weeks, 118 escalated to the regulator, 4 of 7 categories with a proven cause. Disconnection and reconnection now reads Action agreed, with the credit and recovery operations manager and a due date; the three categories still being traced are labeled under investigation.
The Head of CX signs only after confirming that counts reconcile with the complaint log and each stated cause has a proof and an accepted owner.
